Project Details
Land Number
1168
Region
The Area 22, El Sadat City
HOMEi Price
5,600.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
| 2 |
|
- | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 25% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
175 m²
Delivery
Unit Delivery Date
July 2026
Average Unit Price
803,250 EGP
Project Location
Map View
The Area 22, El Sadat City
HOMEi Timeline
License office contract
July 15, 2024

Building permit
July 18, 2024

Excavation permit
July 20, 2024
Mining permit
July 21, 2024
Construction contract in progress
July 22, 2024
Construction contract signed
July 23, 2024

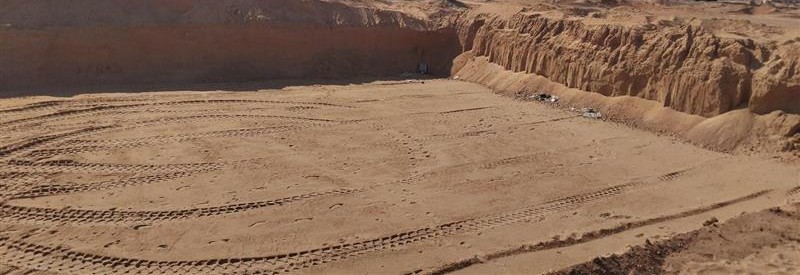

Excavation
August 1, 2024

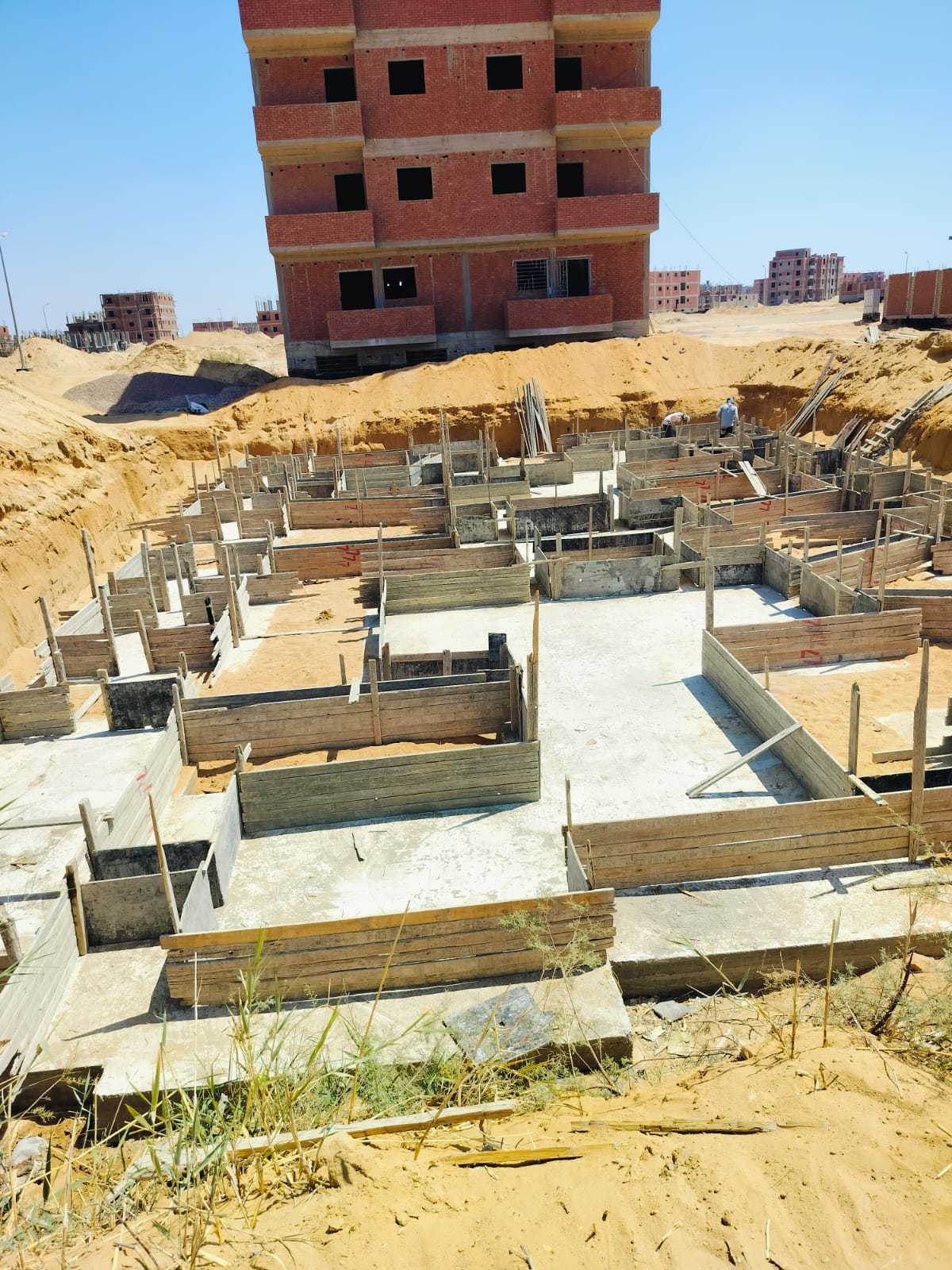

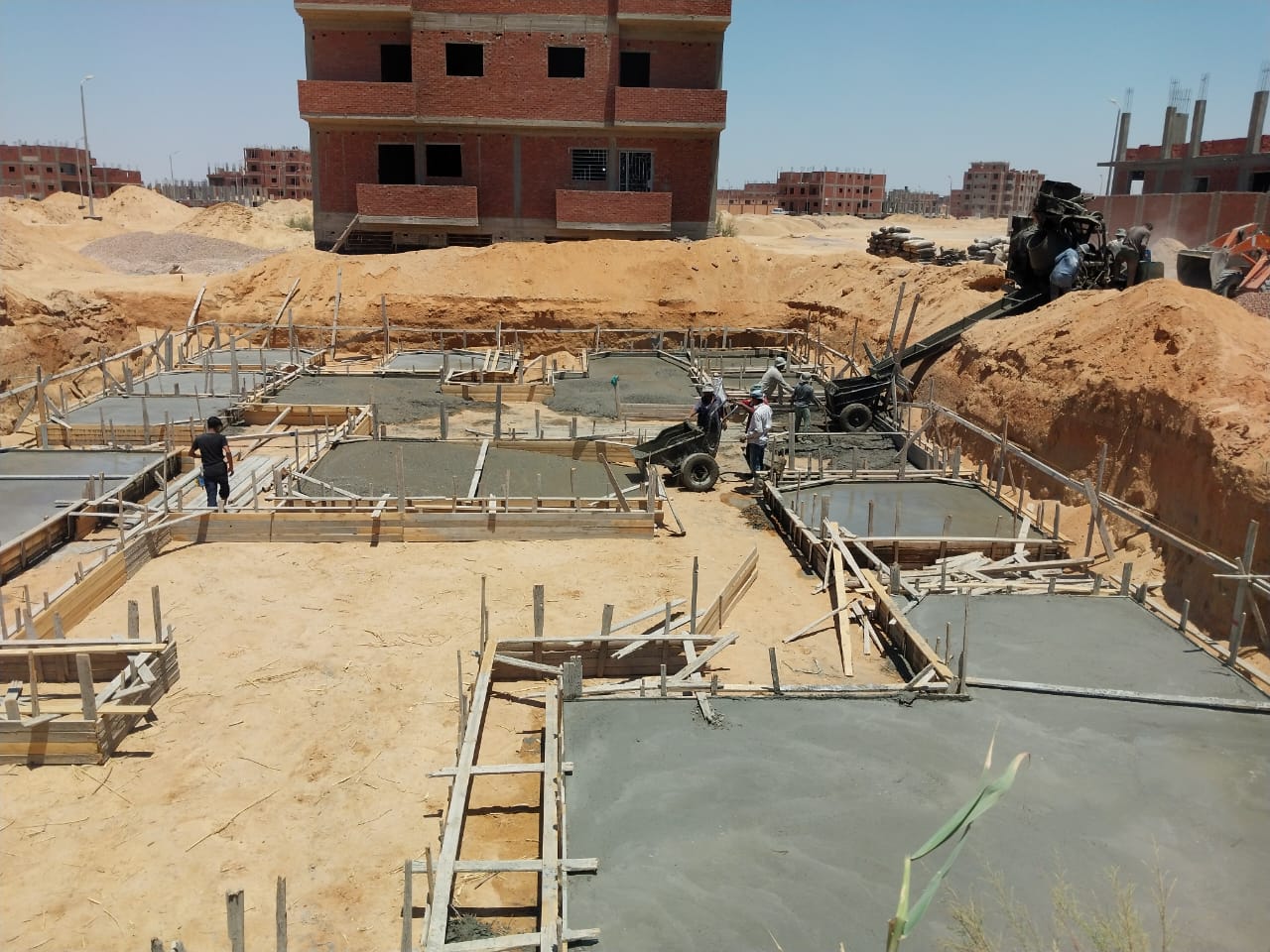

Plain concrete
August 10, 2024

Reinforced concrete
August 15, 2024

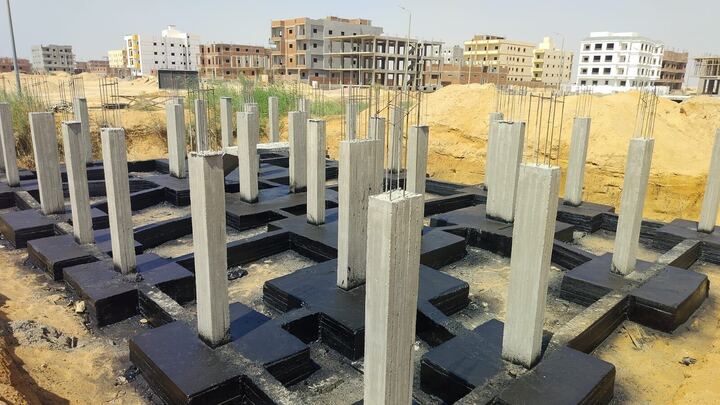

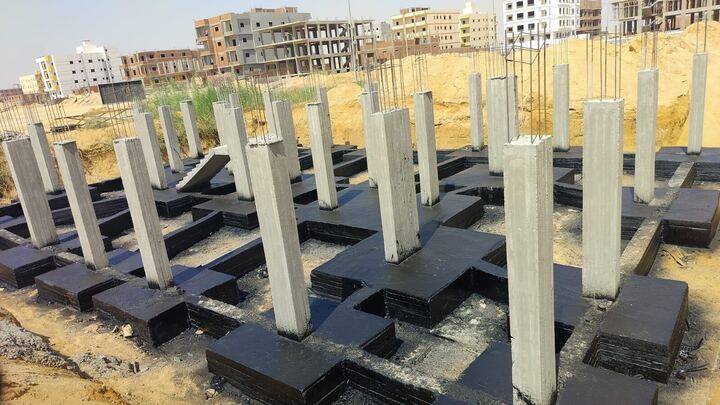

Footings insulation
August 20, 2024

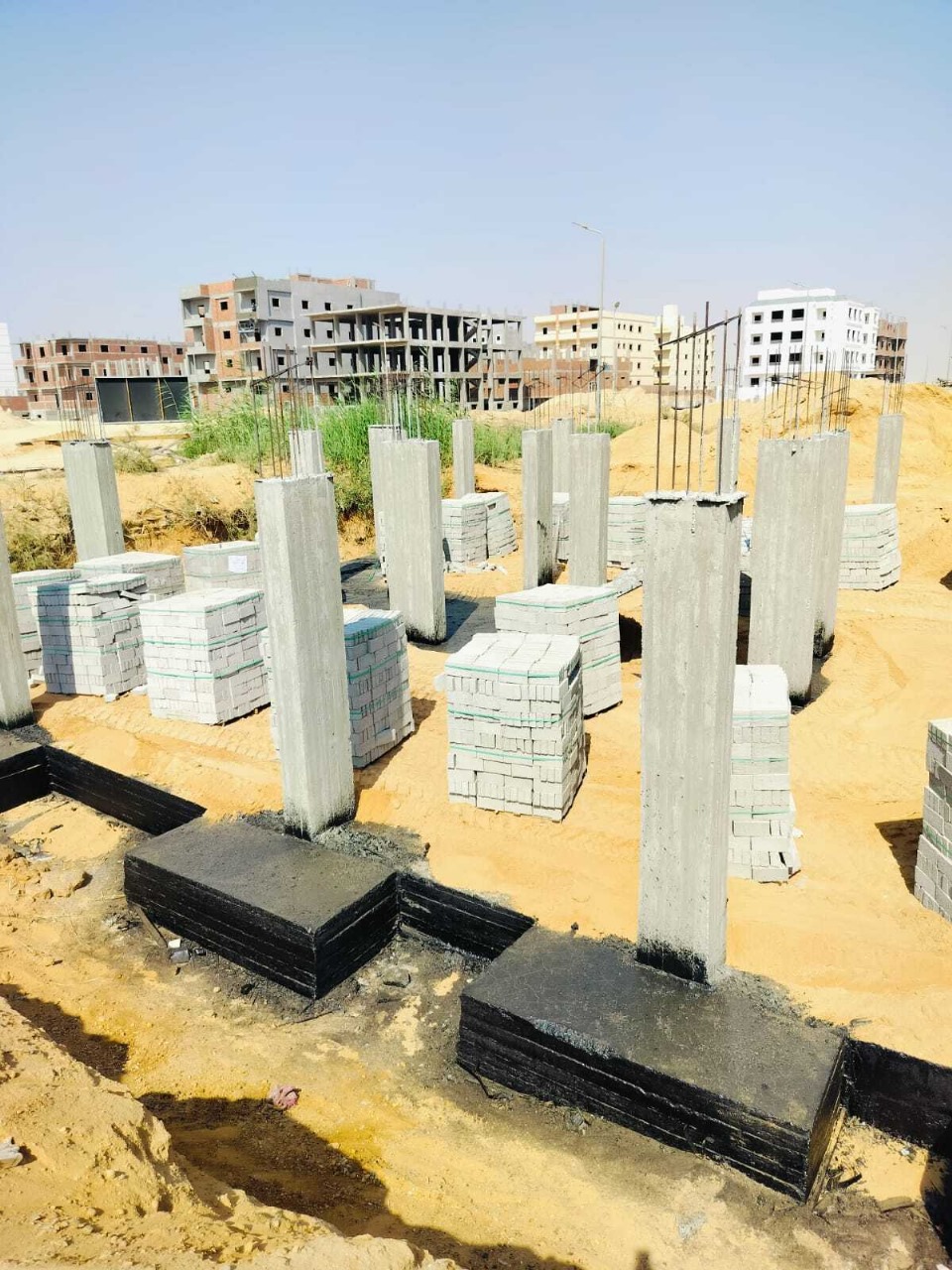

Backfilling around foundations
September 2, 2024

Basement columns
September 3, 2024

Basement slab
September 4, 2024

Basement walls
September 5, 2024

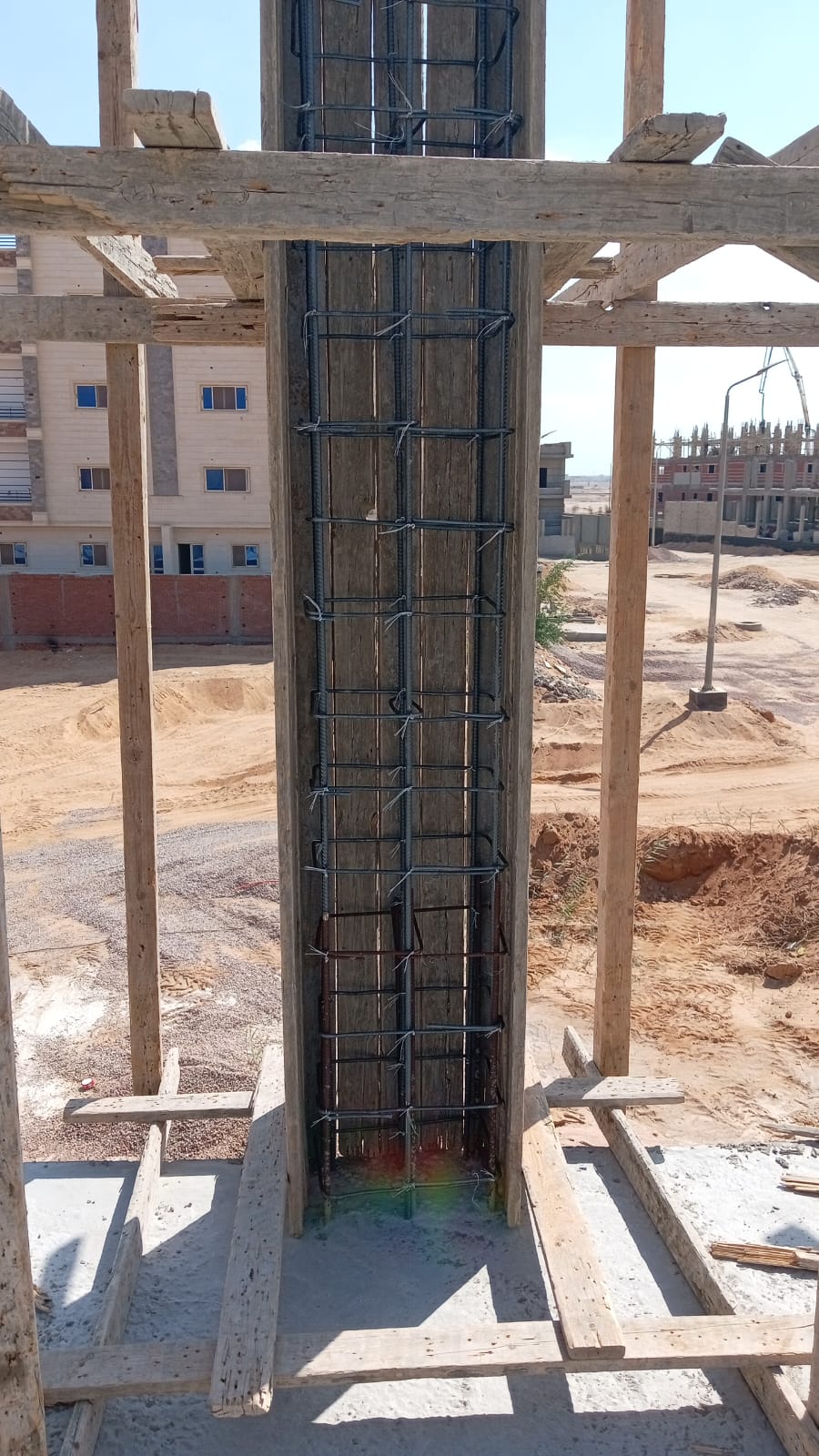

Ground floor columns
September 22, 2024

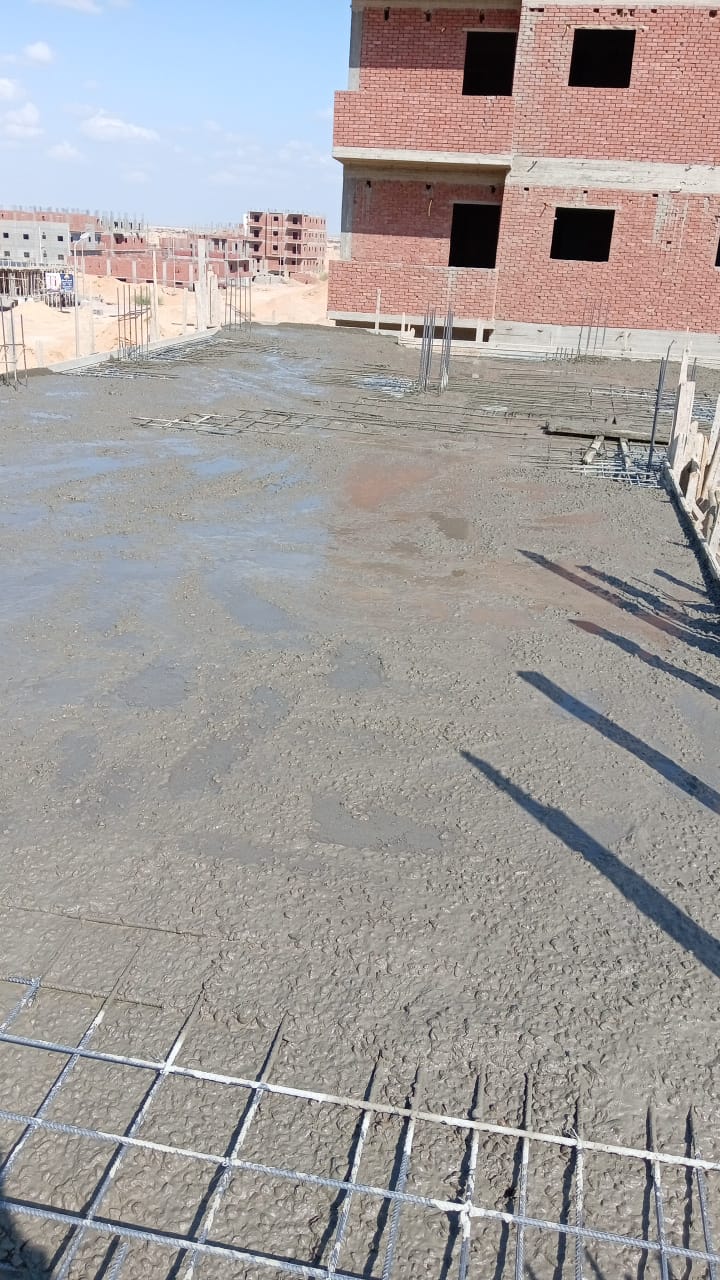

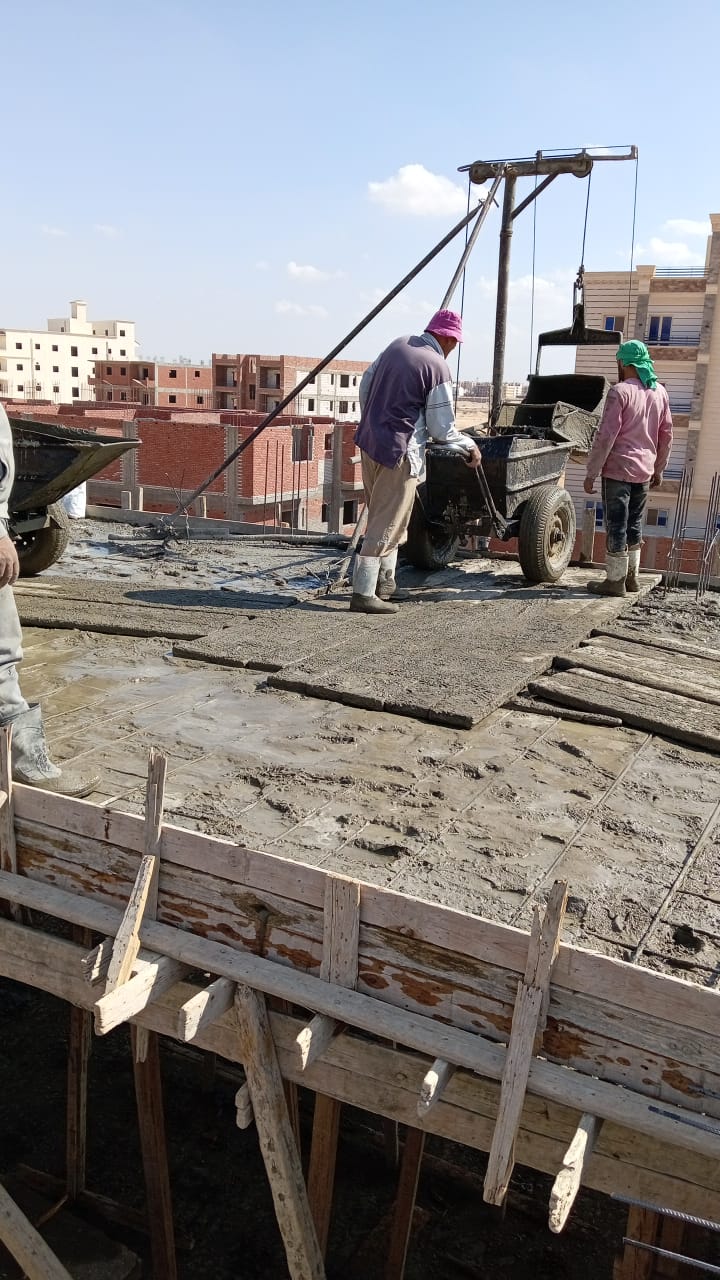

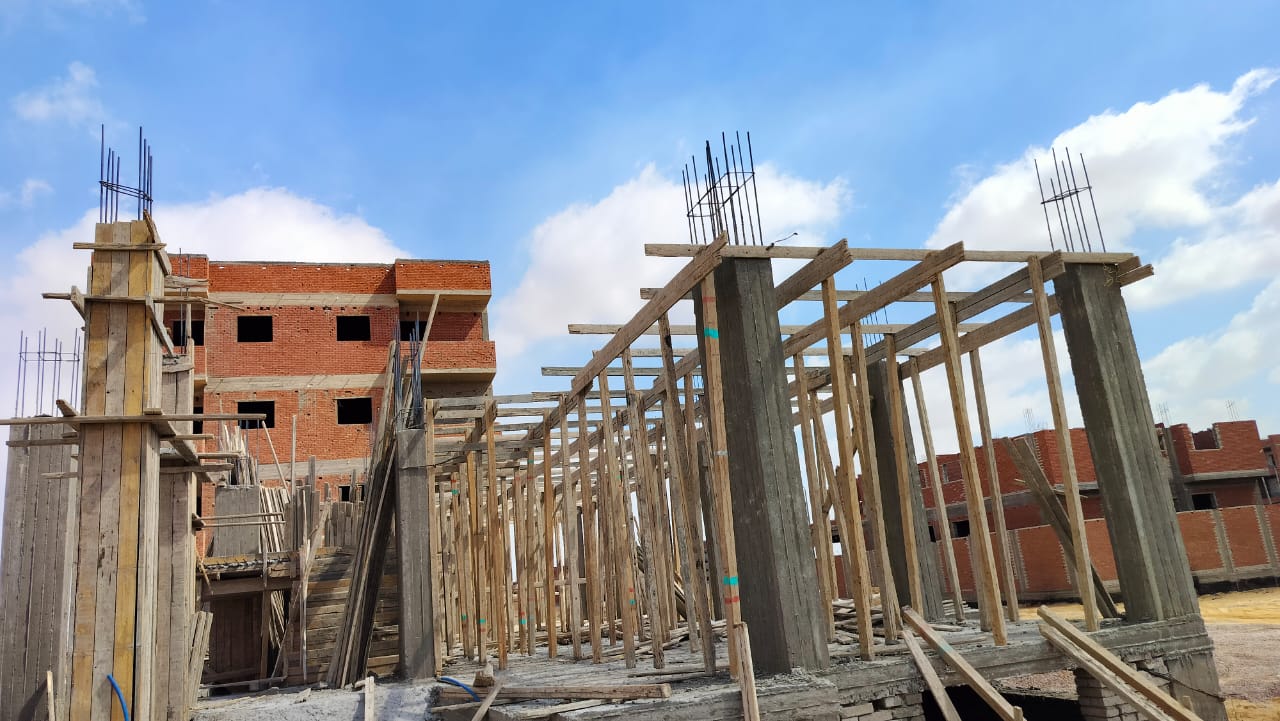

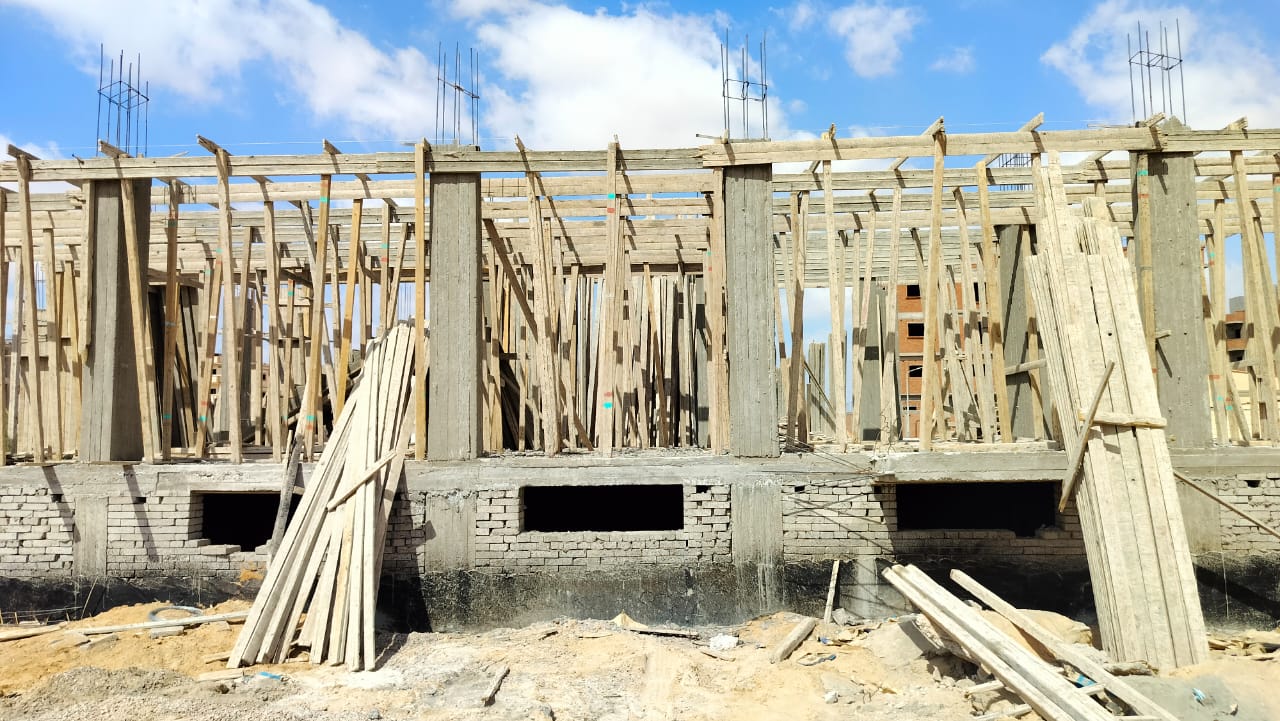

Ground floor slab
October 2, 2024

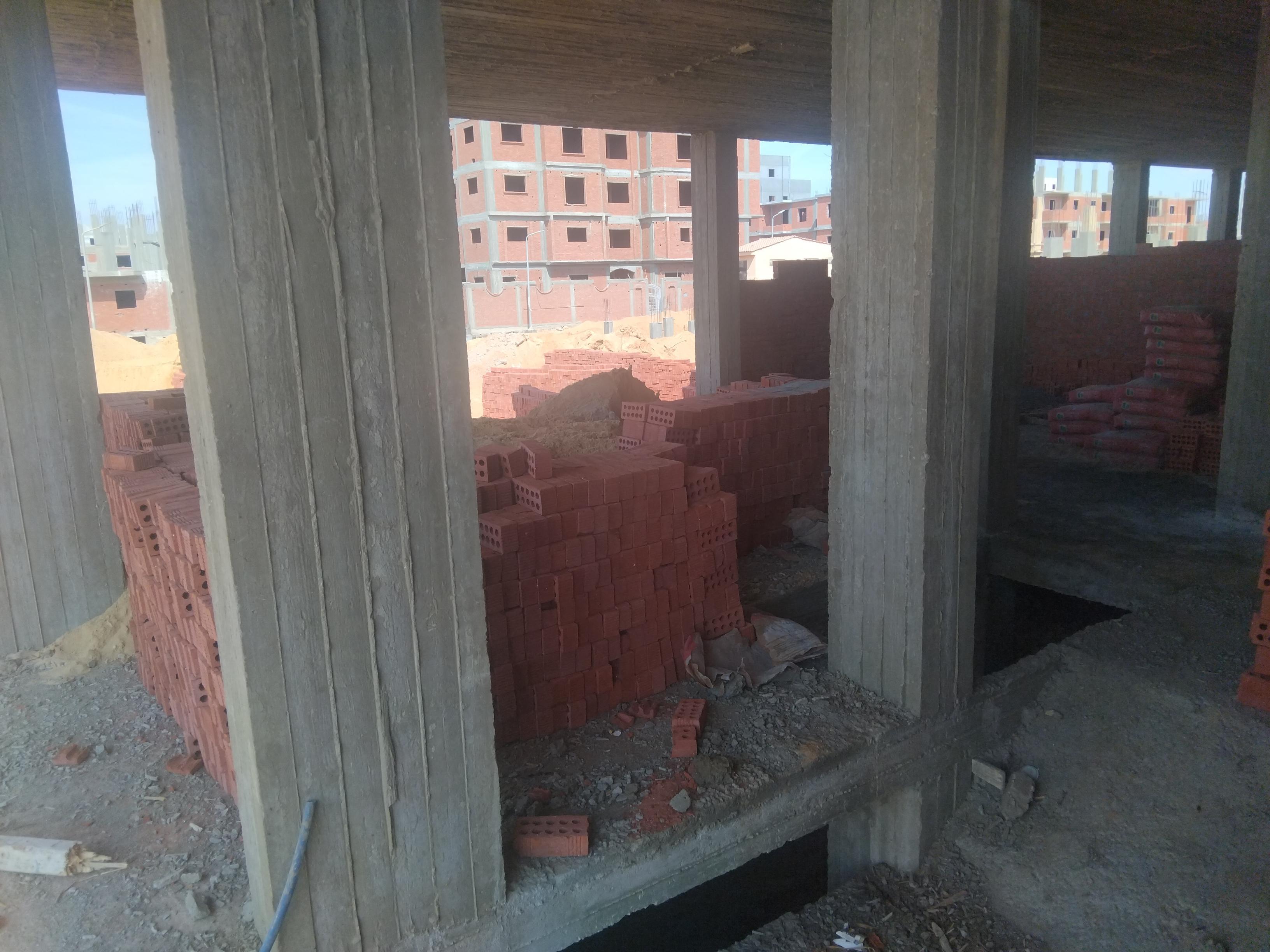

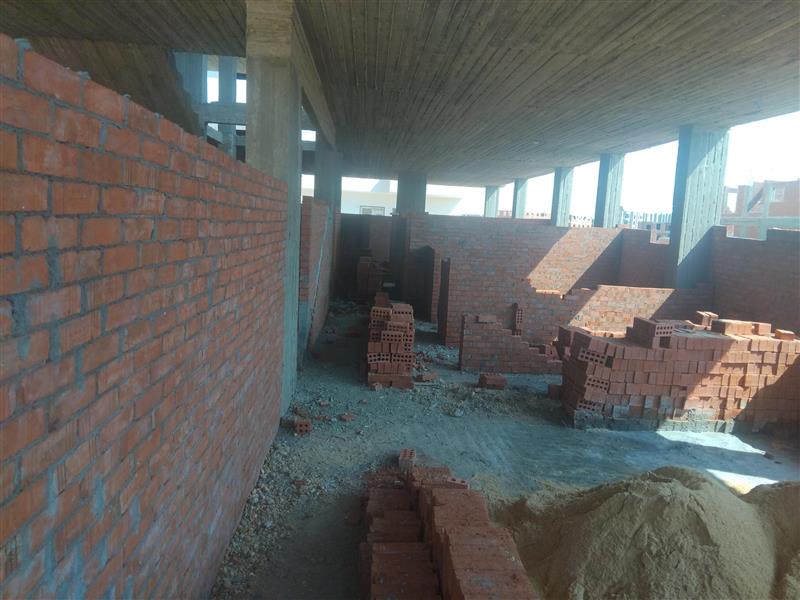

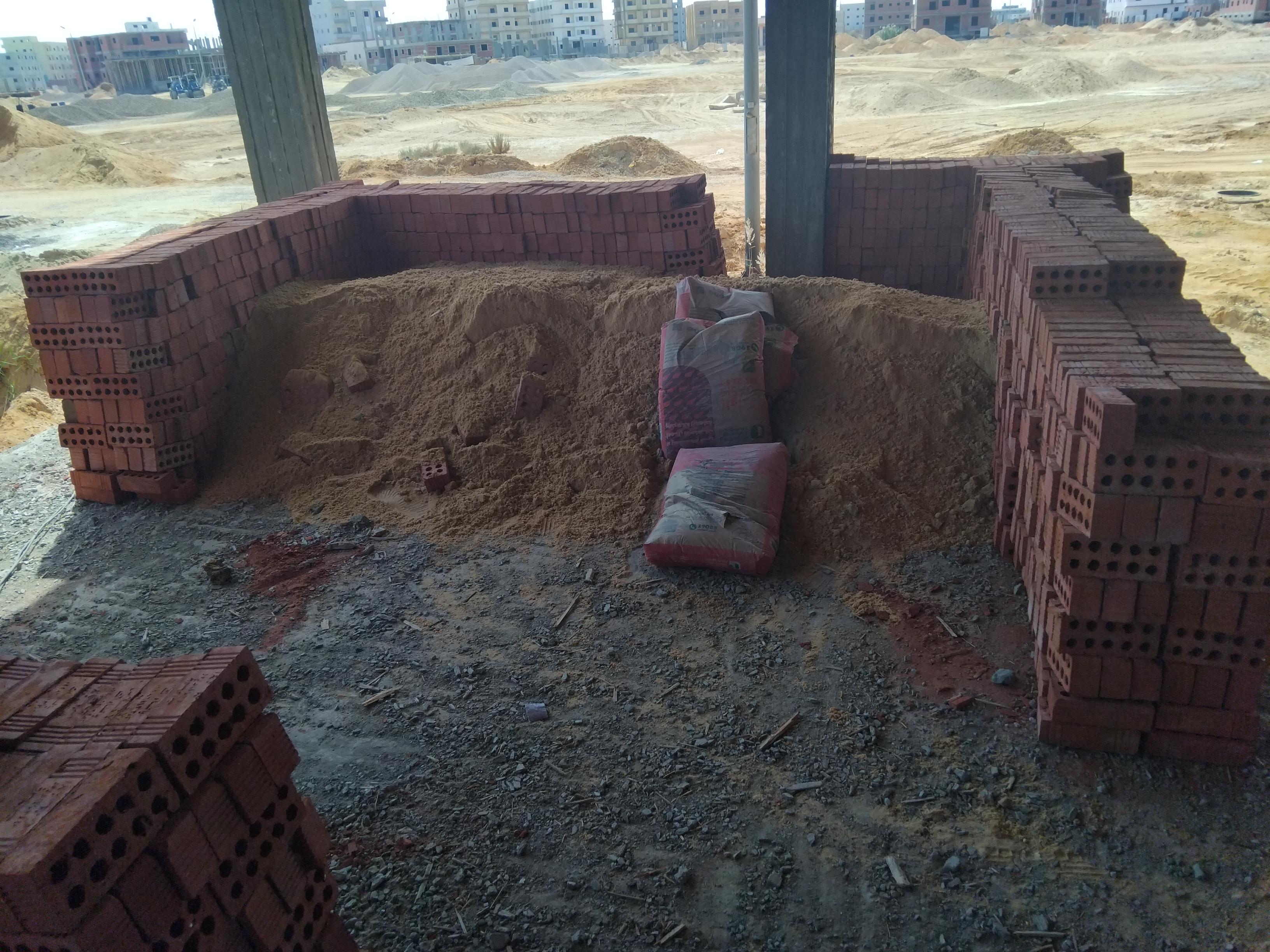

Ground floor walls
October 2, 2024

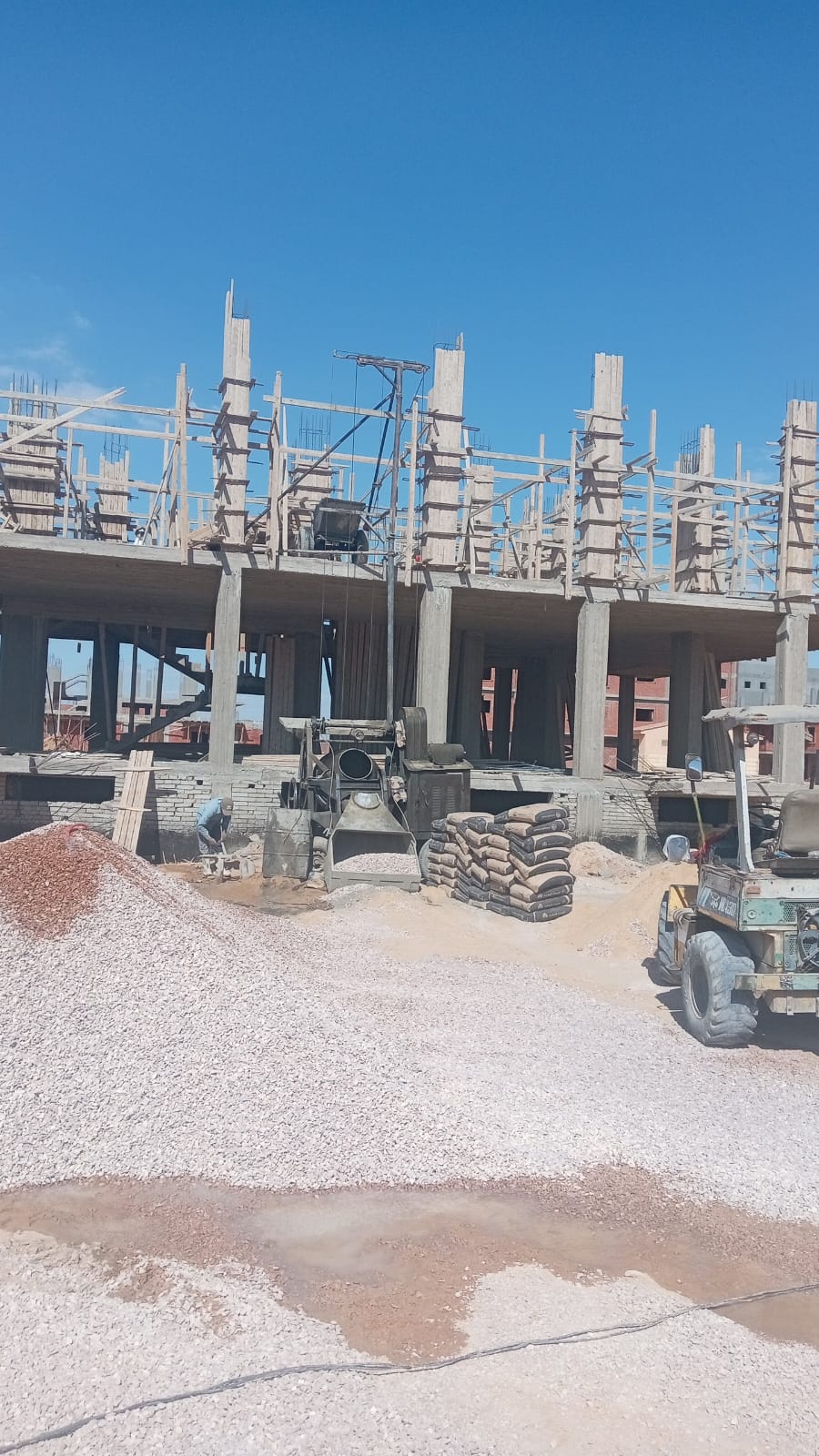

First floor columns
October 22, 2024
High-quality execution of first-floor columns, with precise reinforcement detailing and concrete casting in accordance with engineering standards.

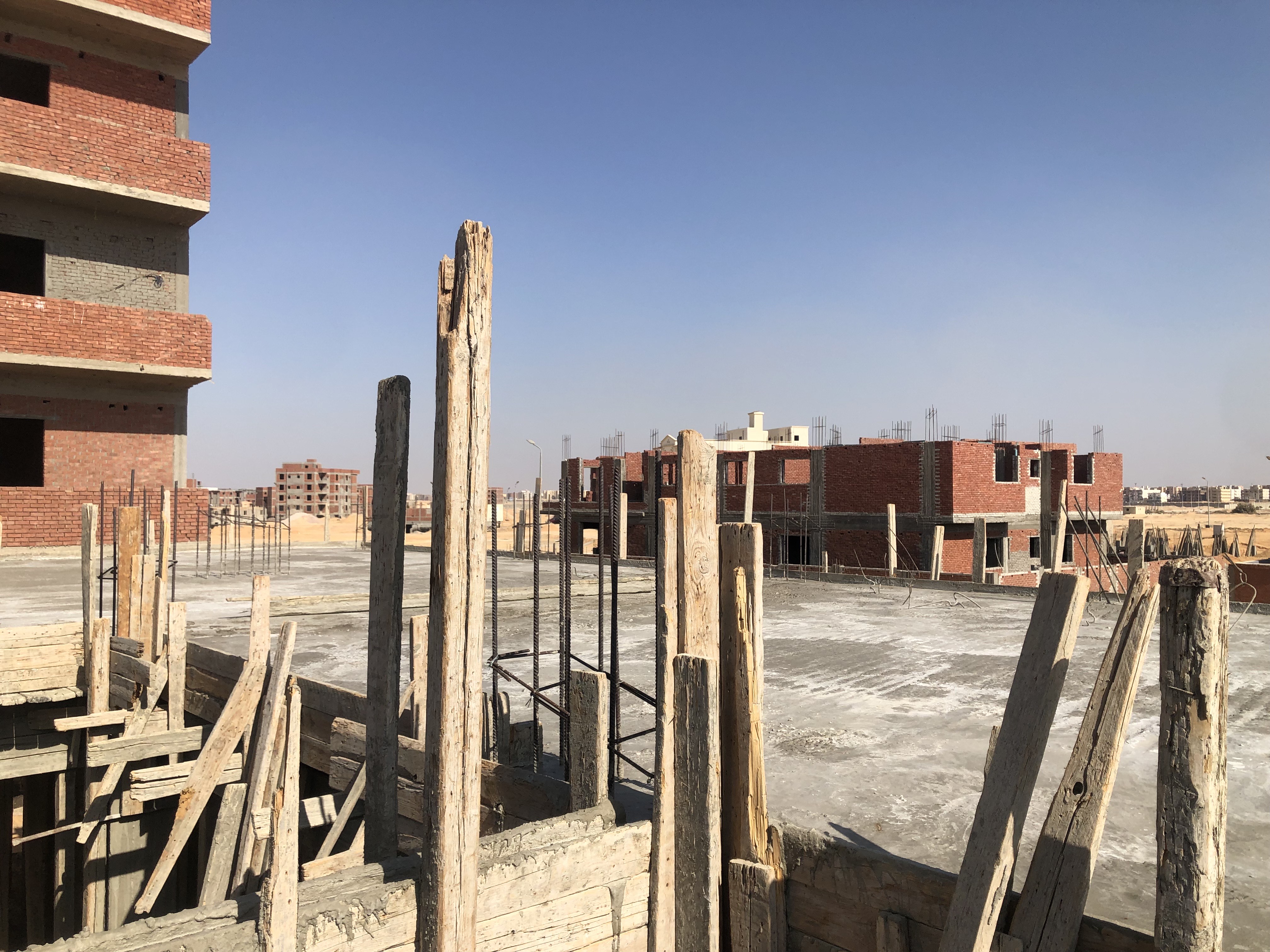

First floor slab
November 2, 2024

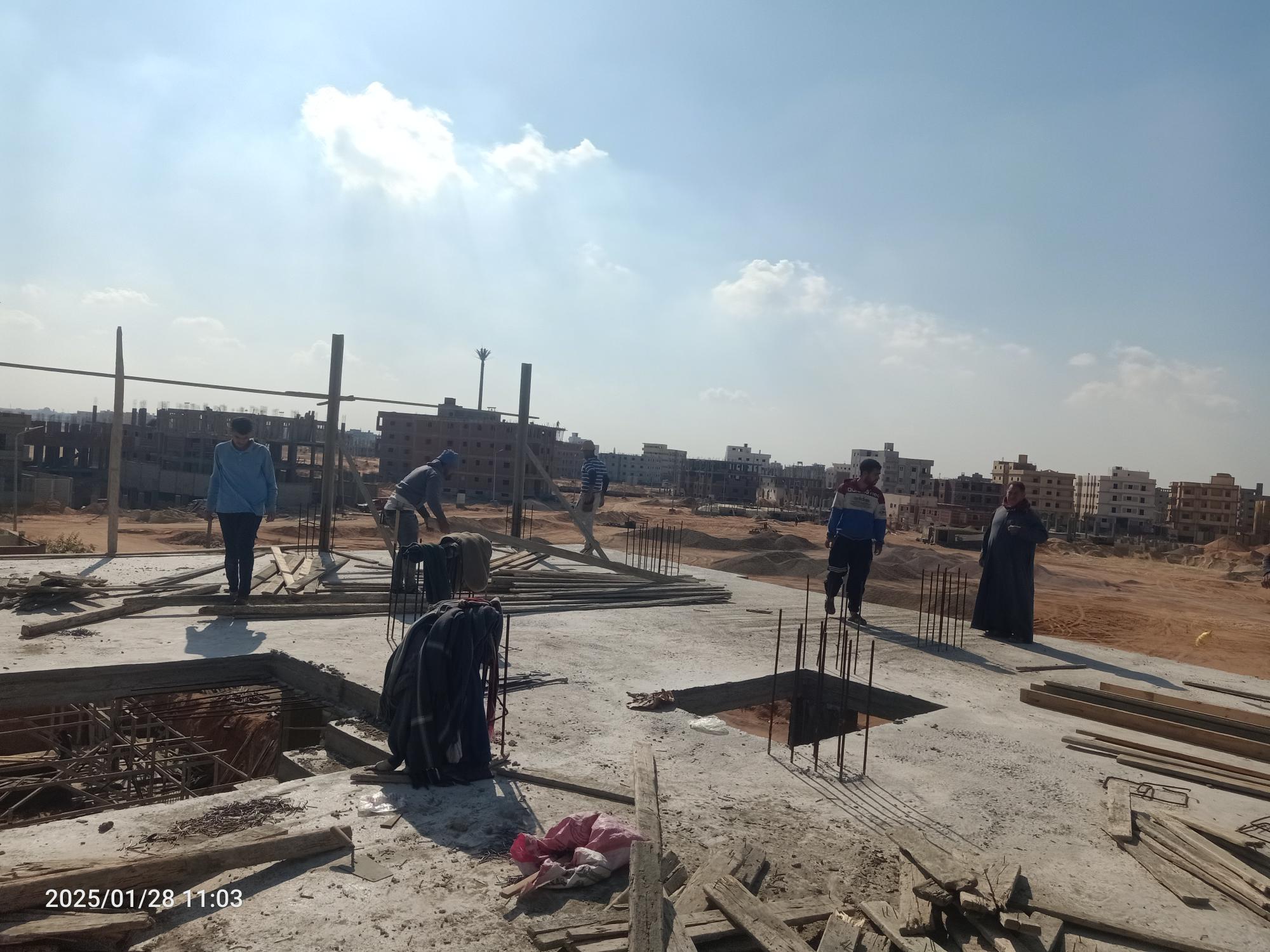

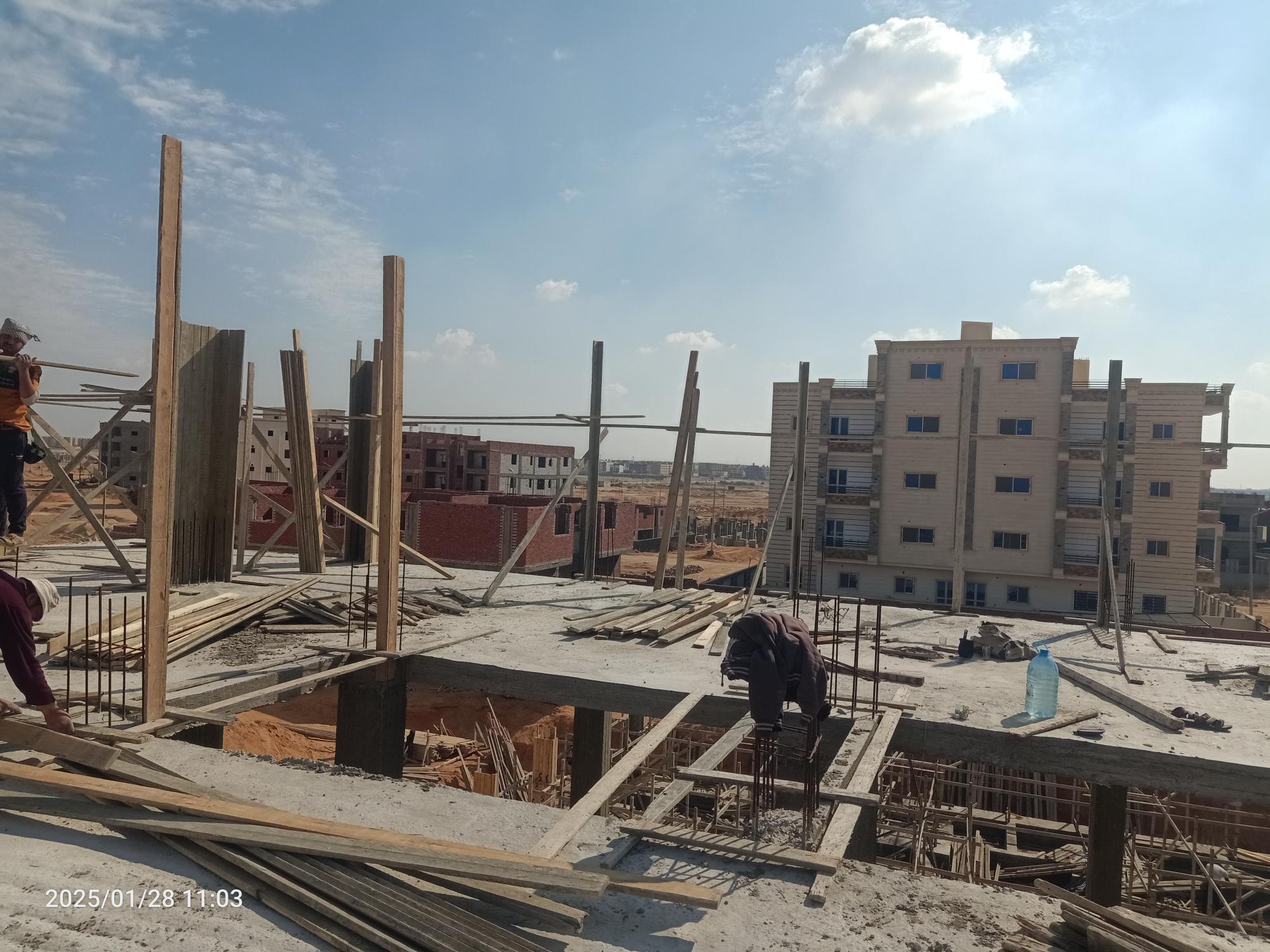

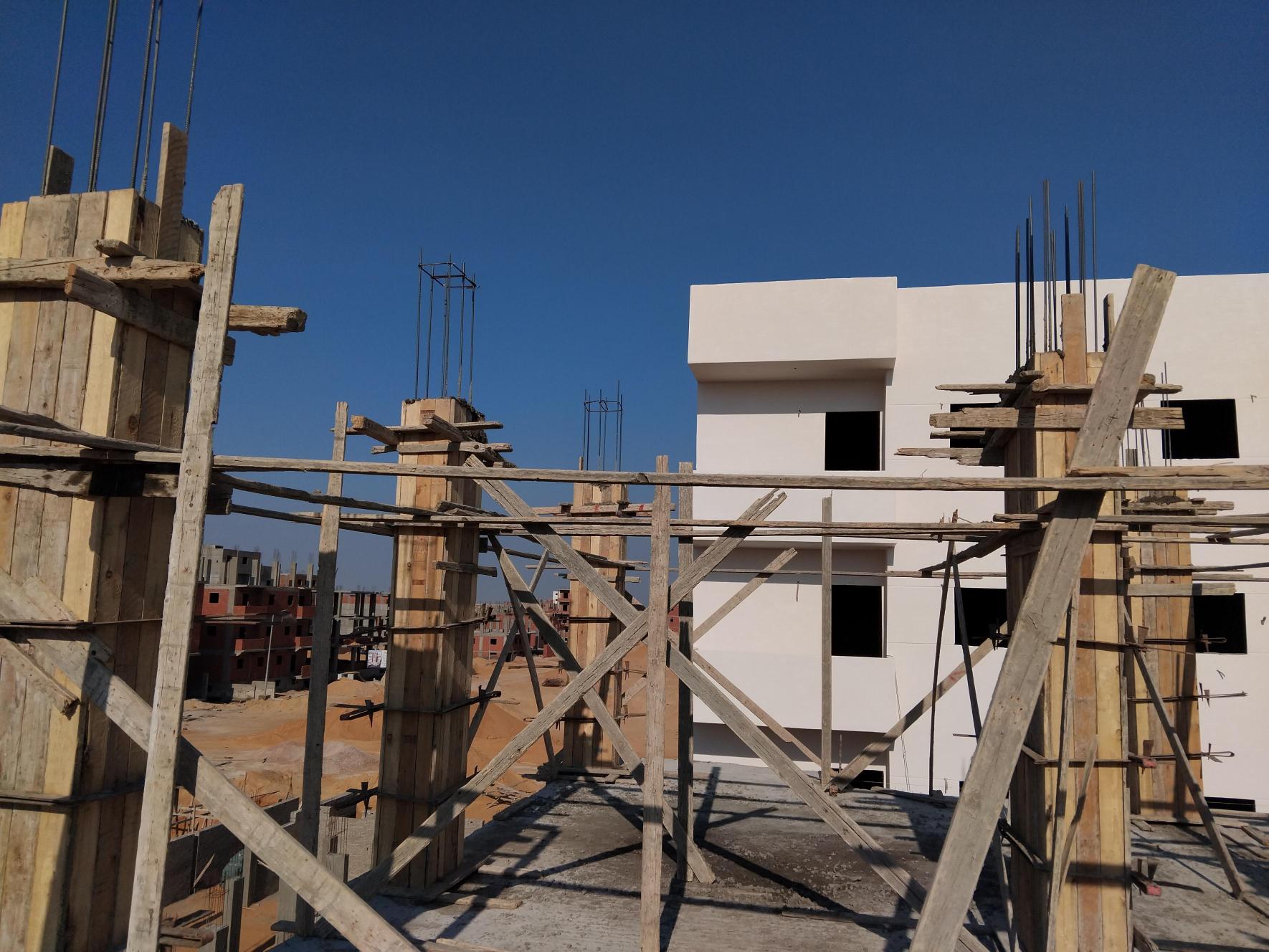

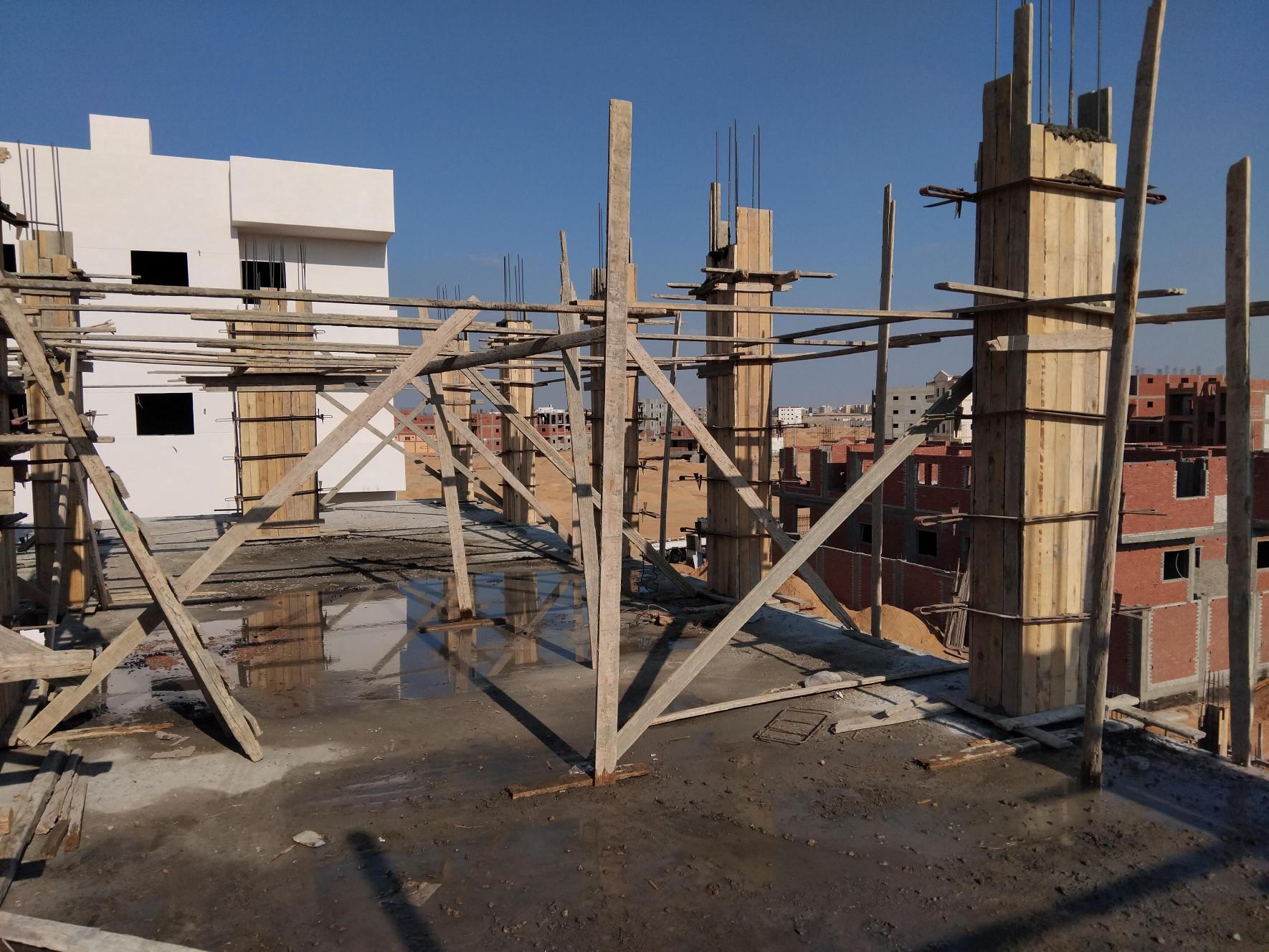

Second floor columns

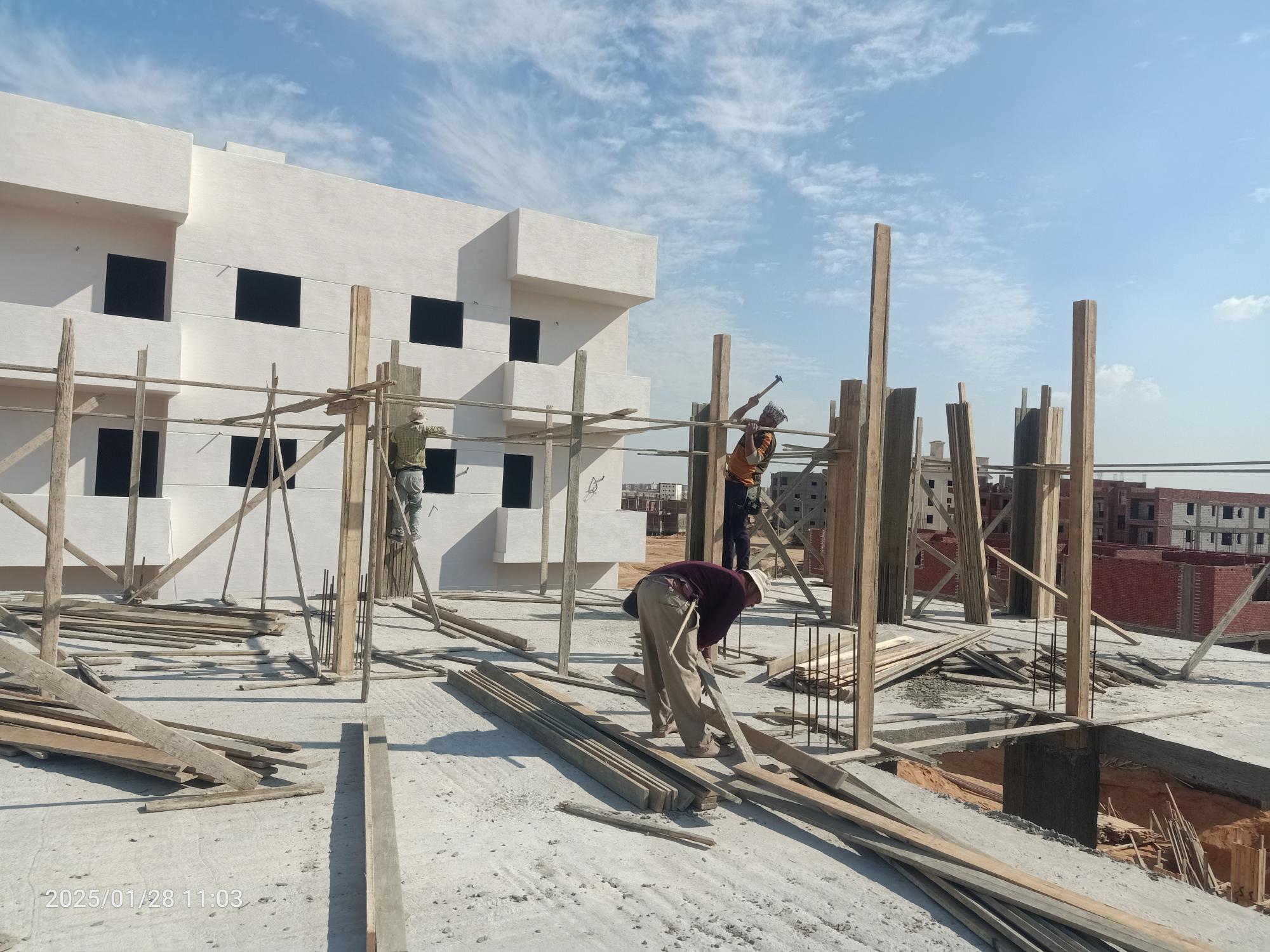

November 22, 2024

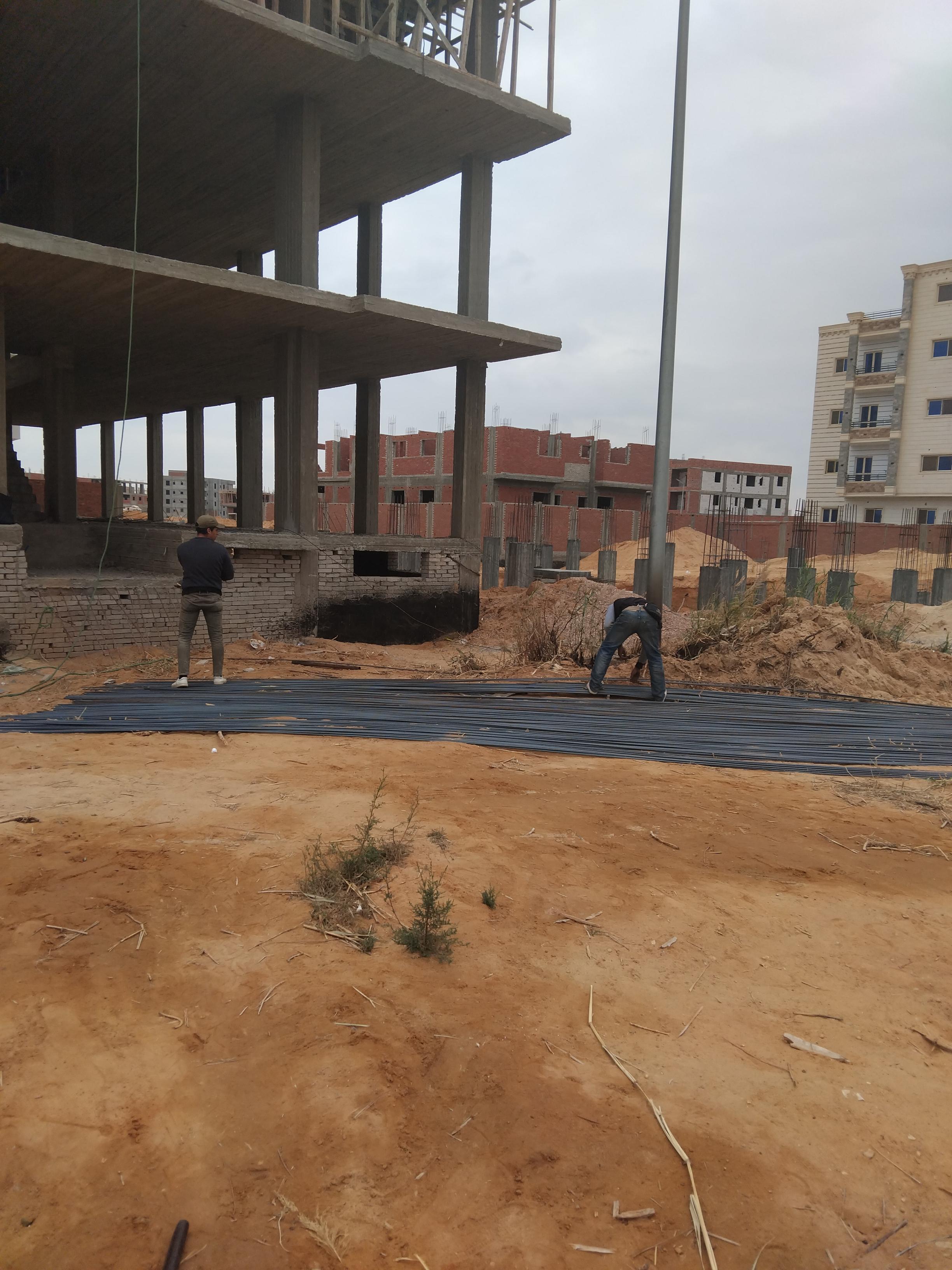

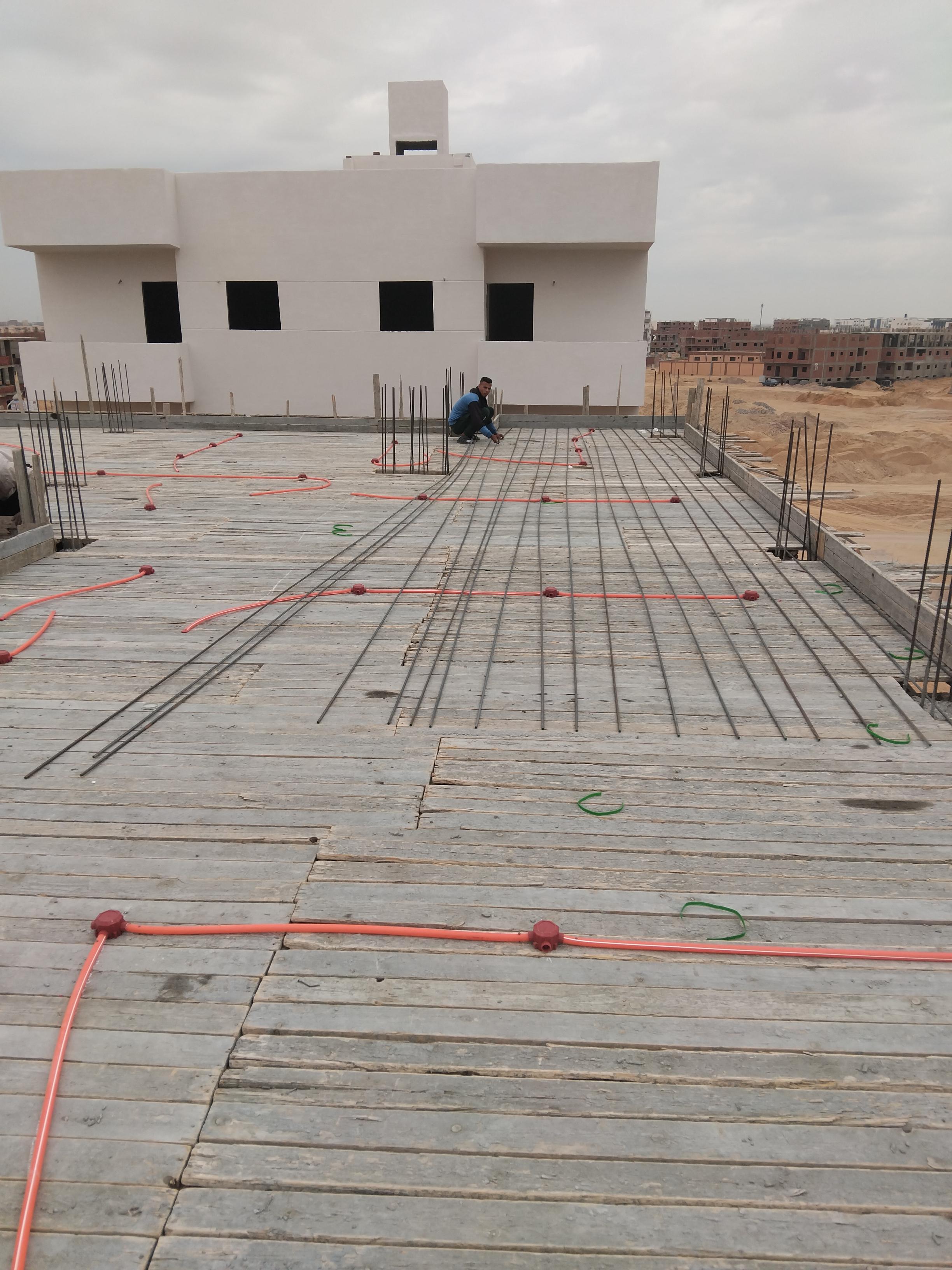

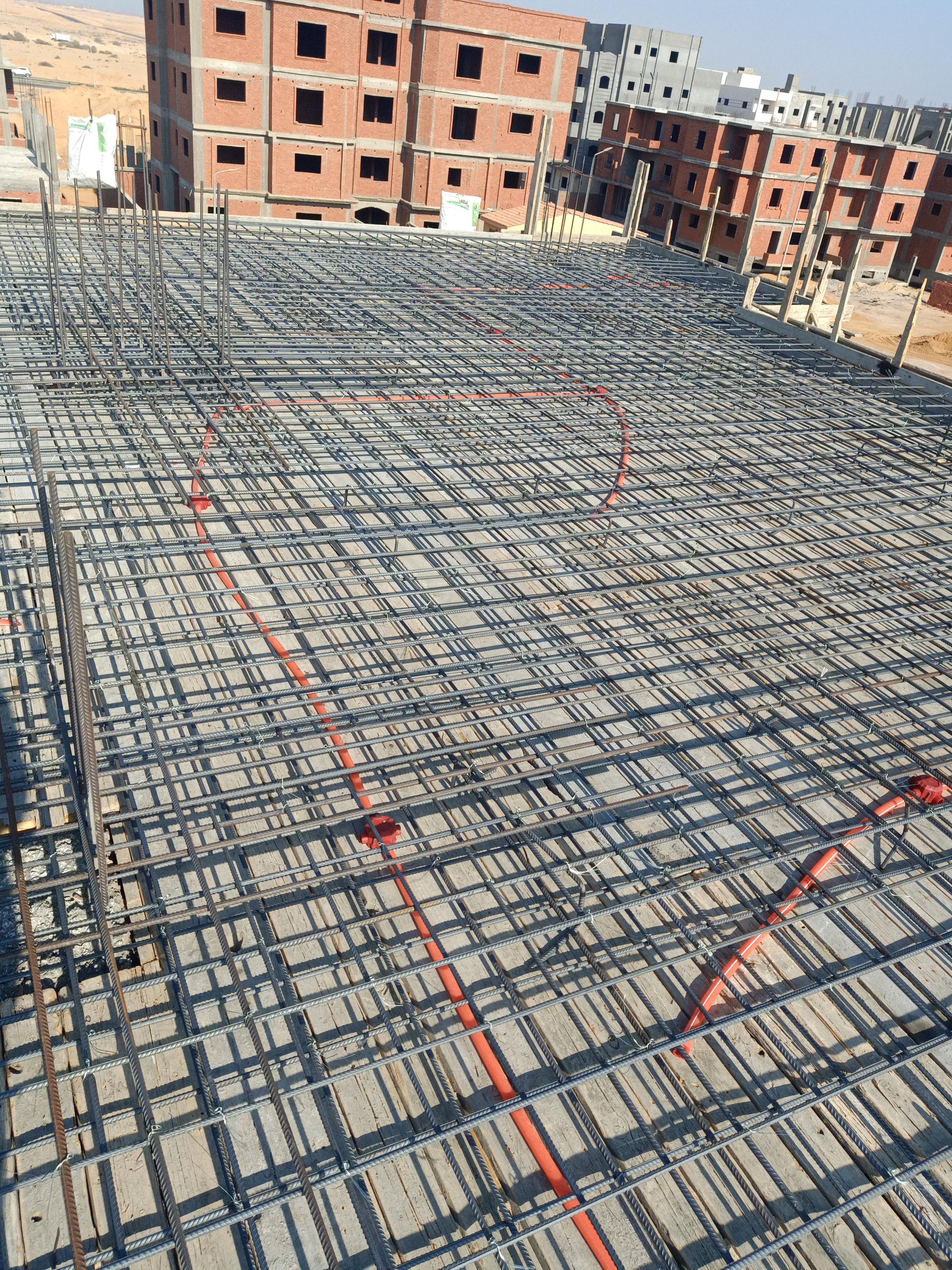

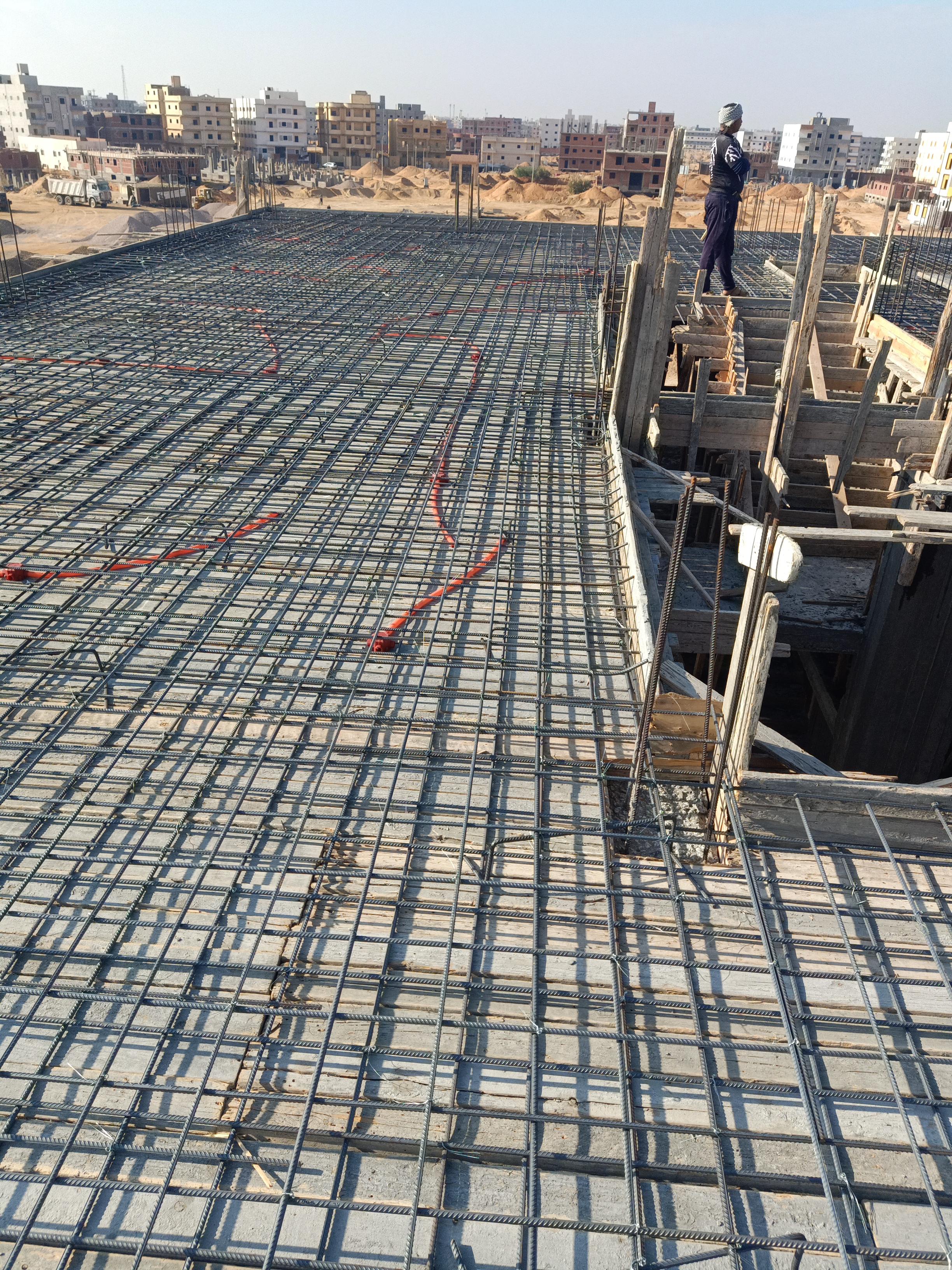

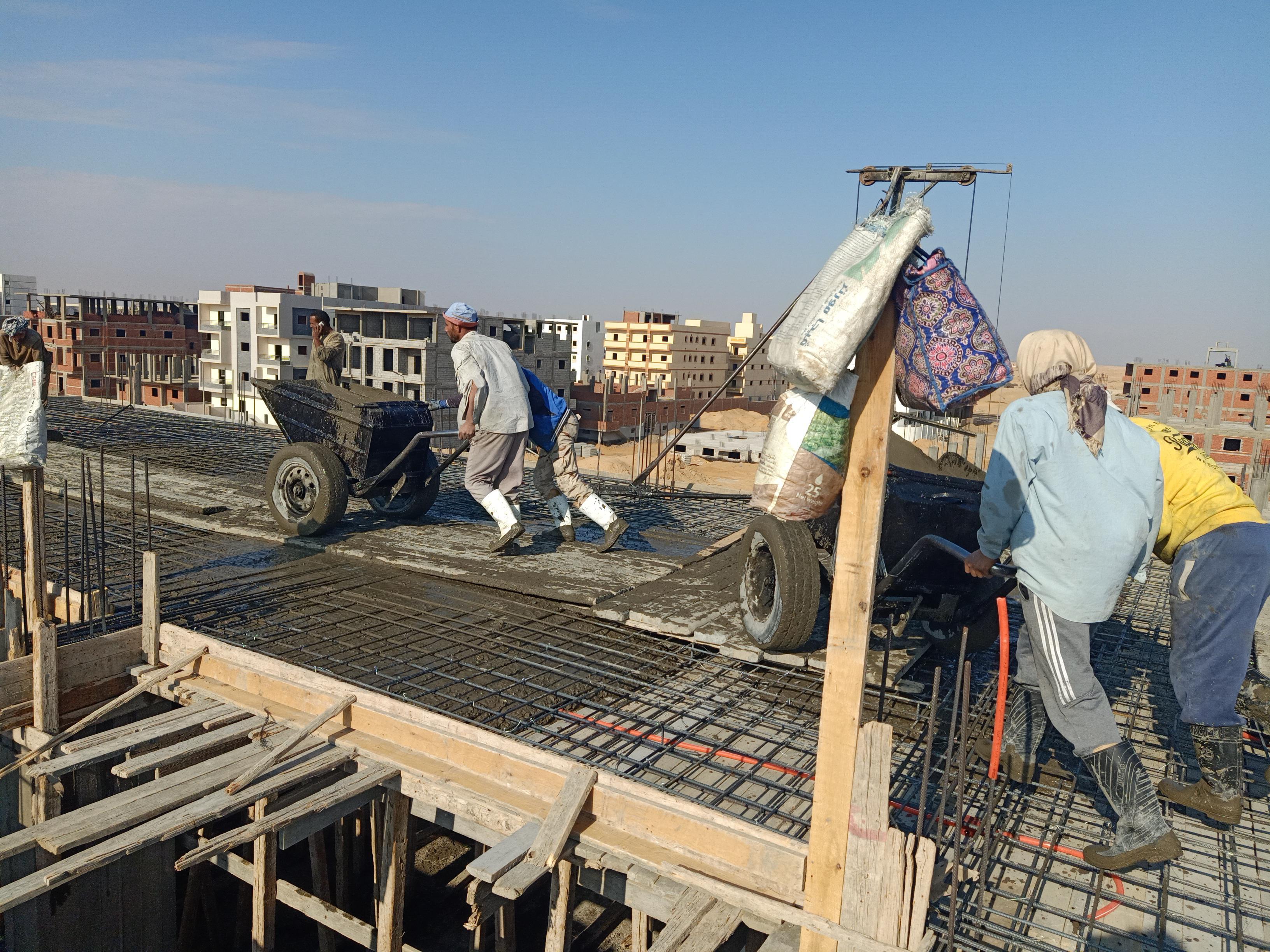

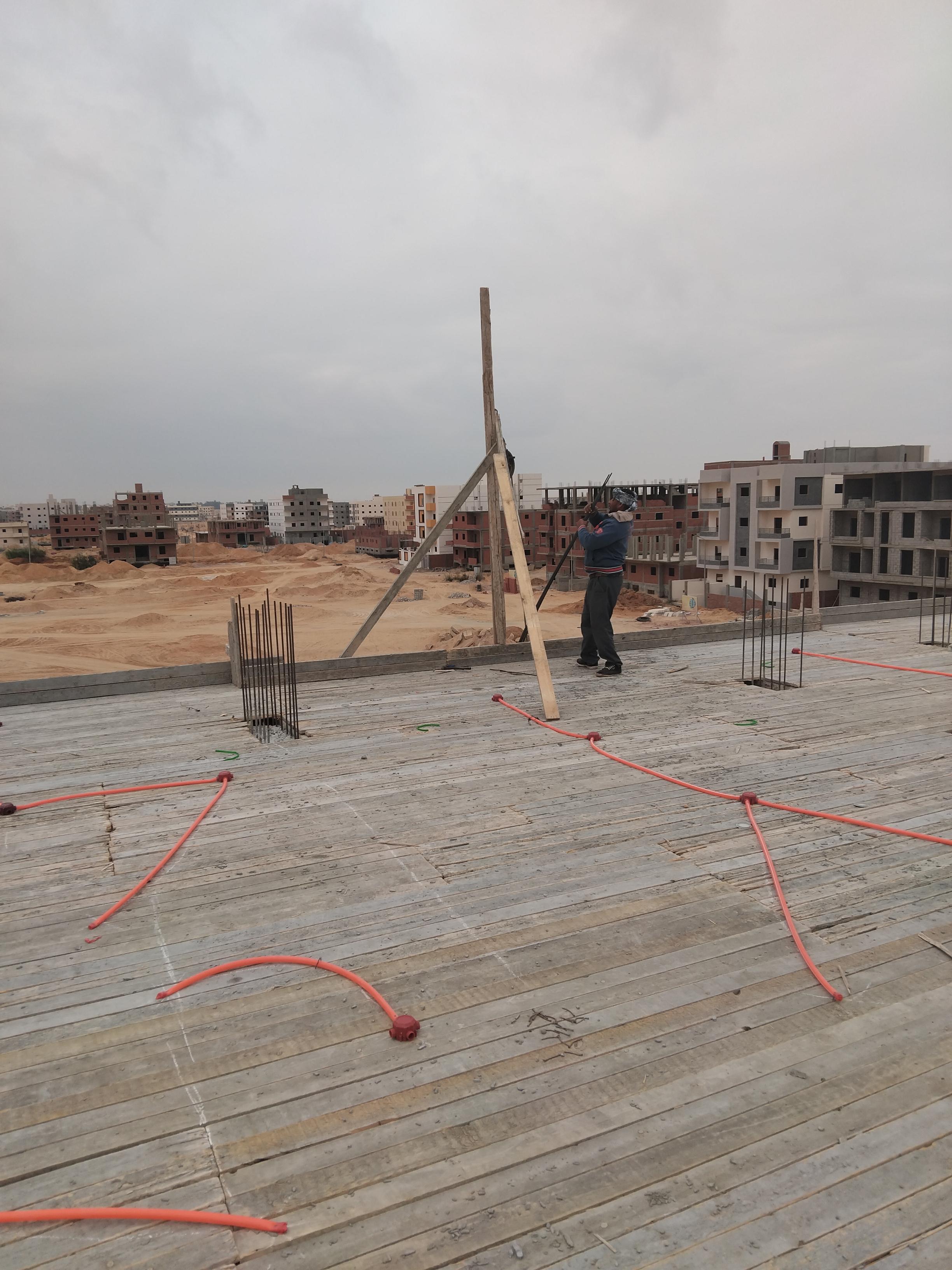

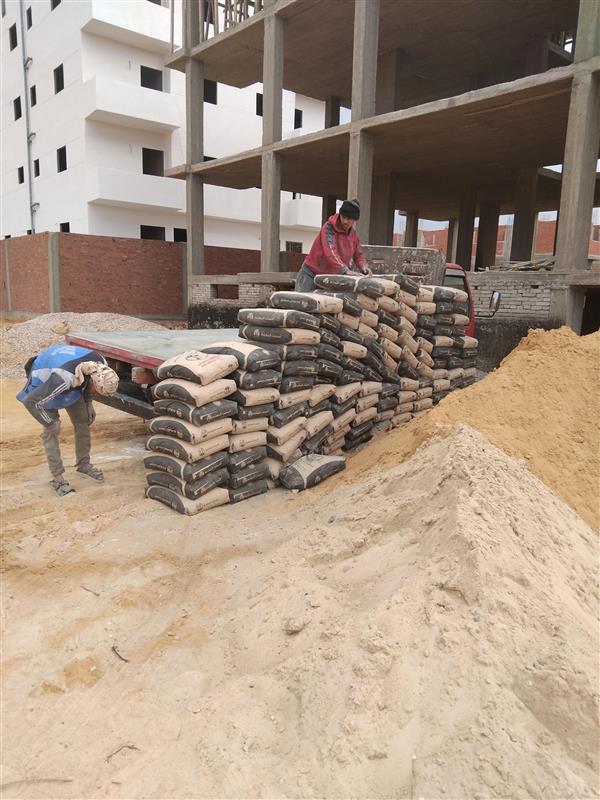

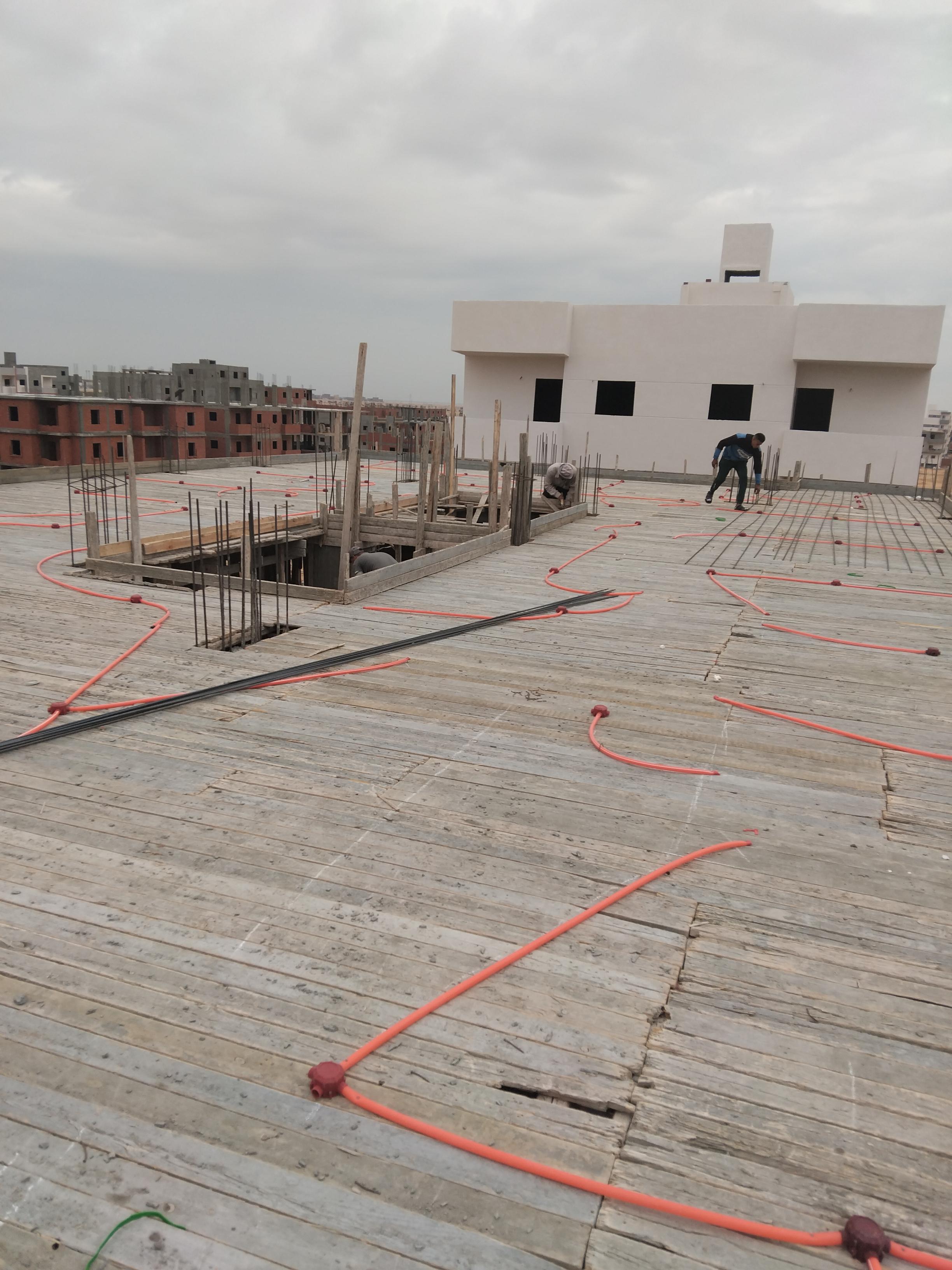

Second floor slab
December 2, 2024

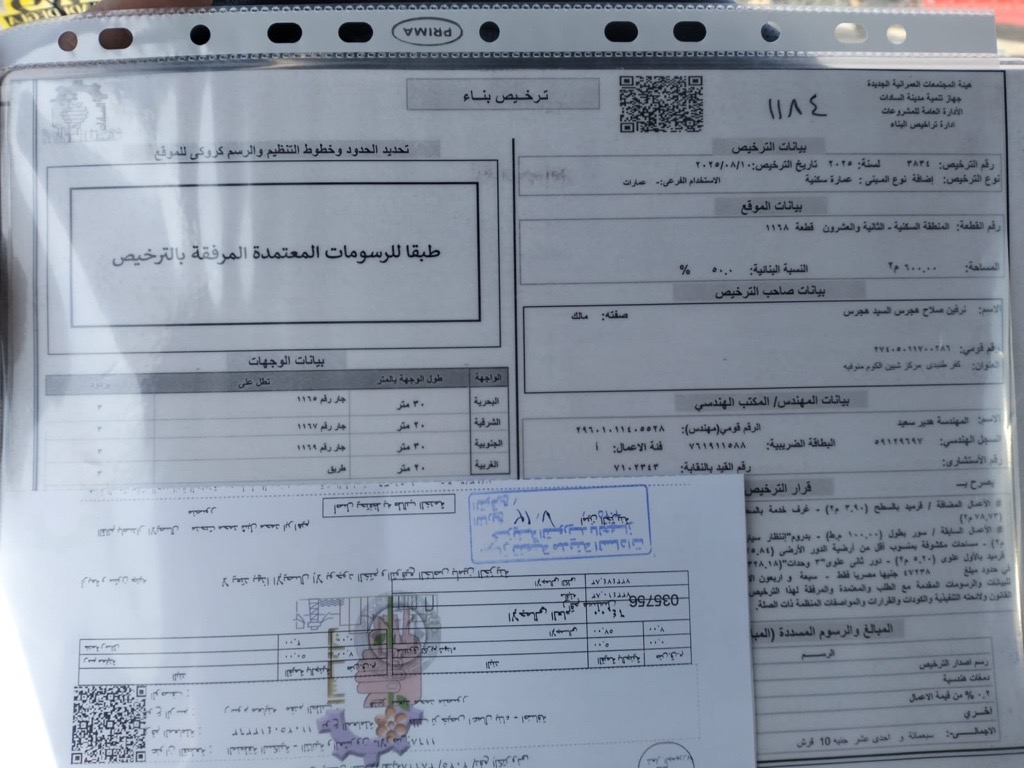

Third-floor addition permit
March 20, 2025

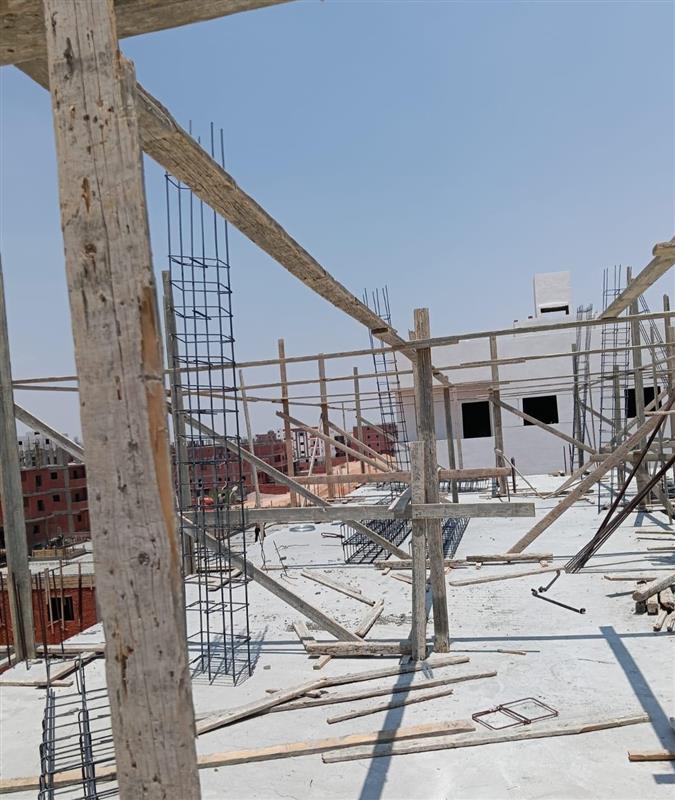

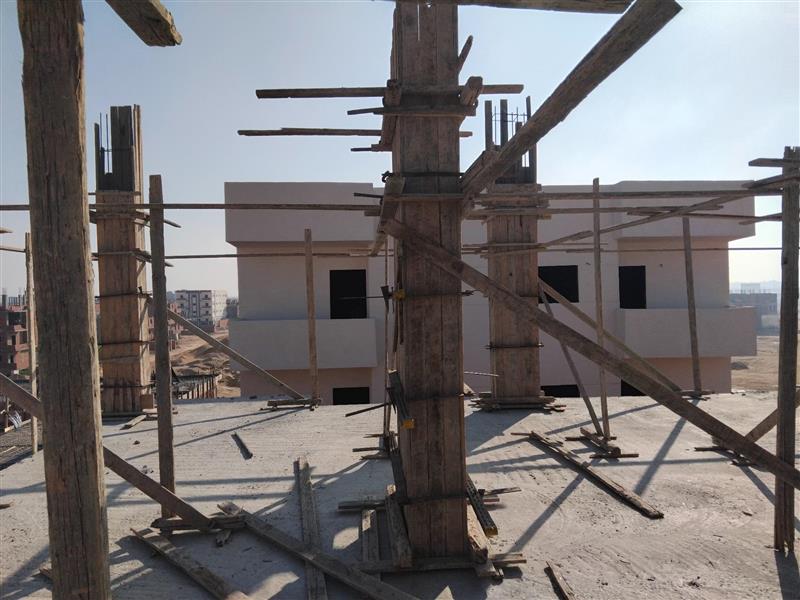

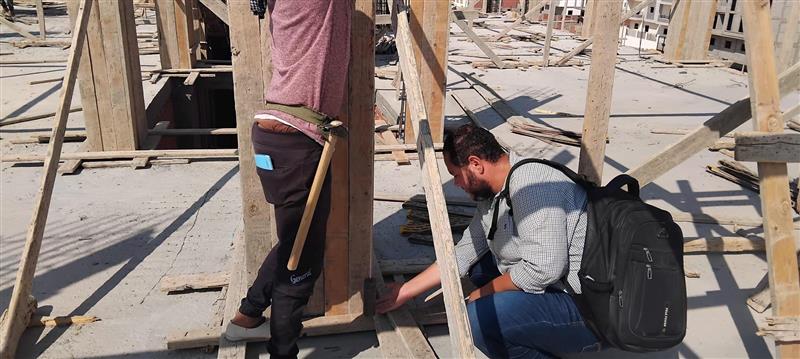

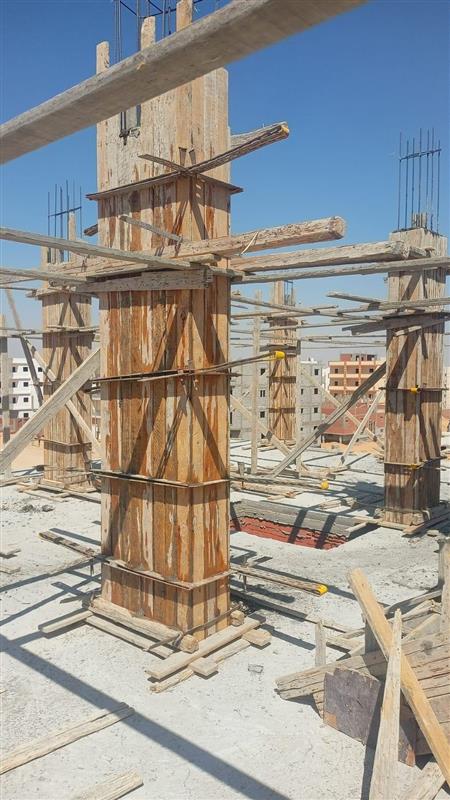

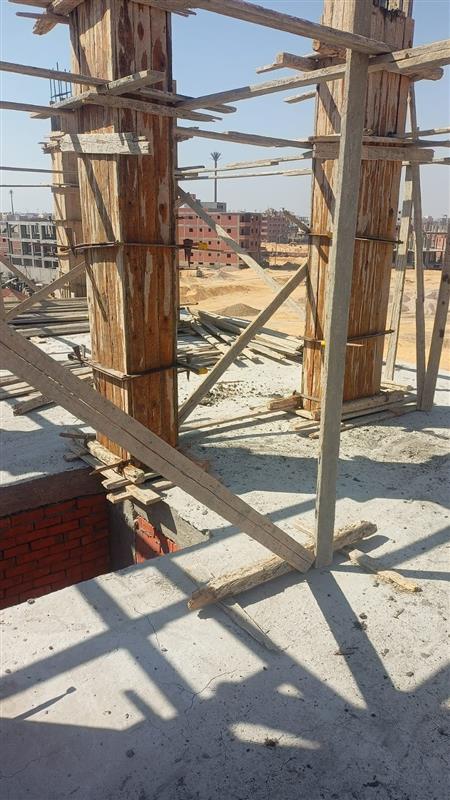

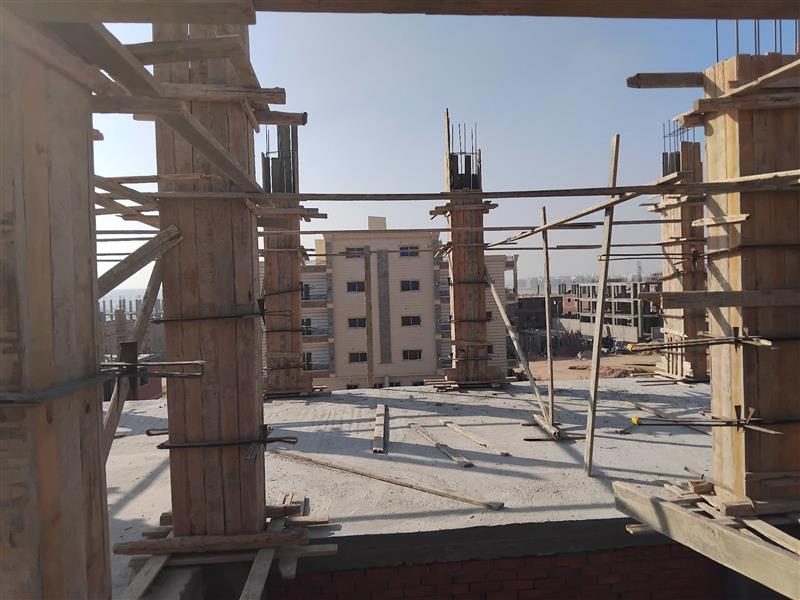

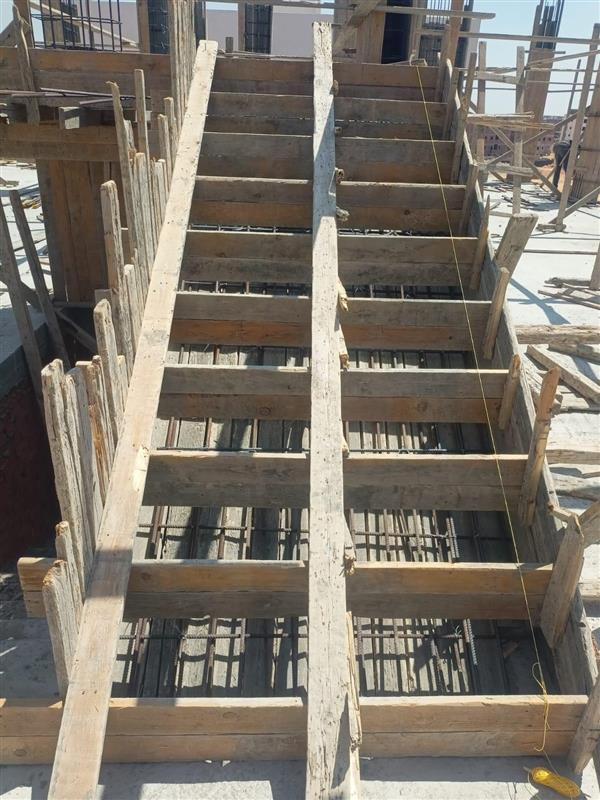

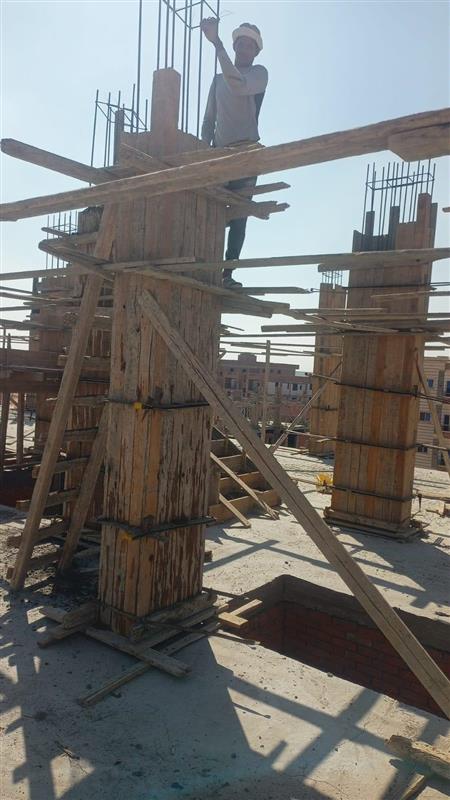

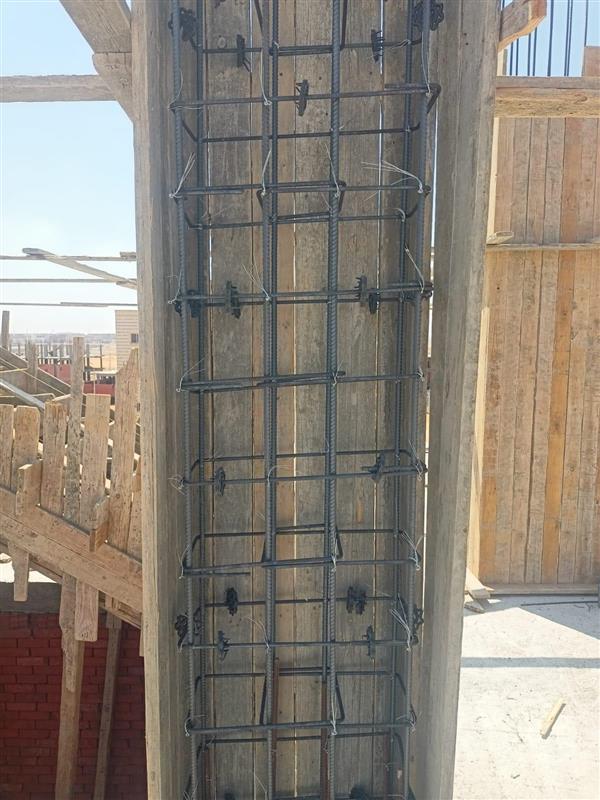

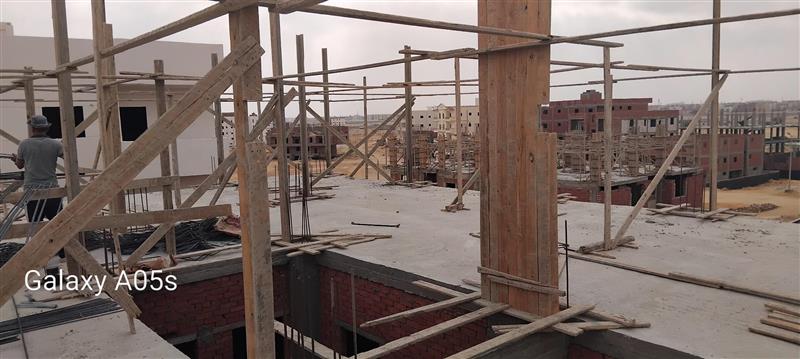

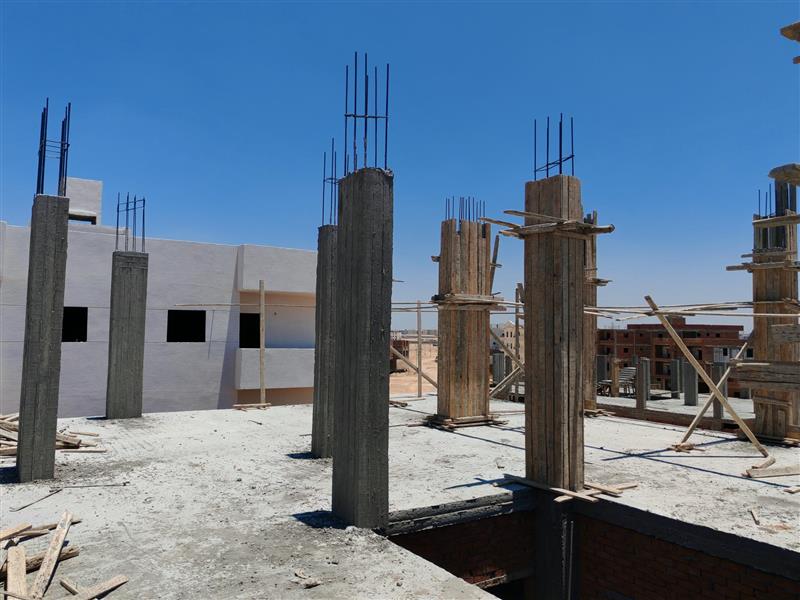

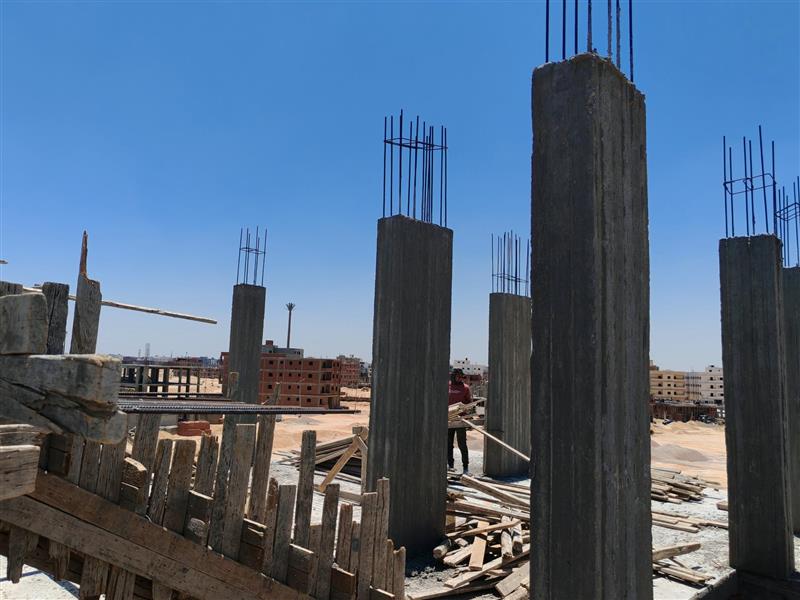

Third floor columns

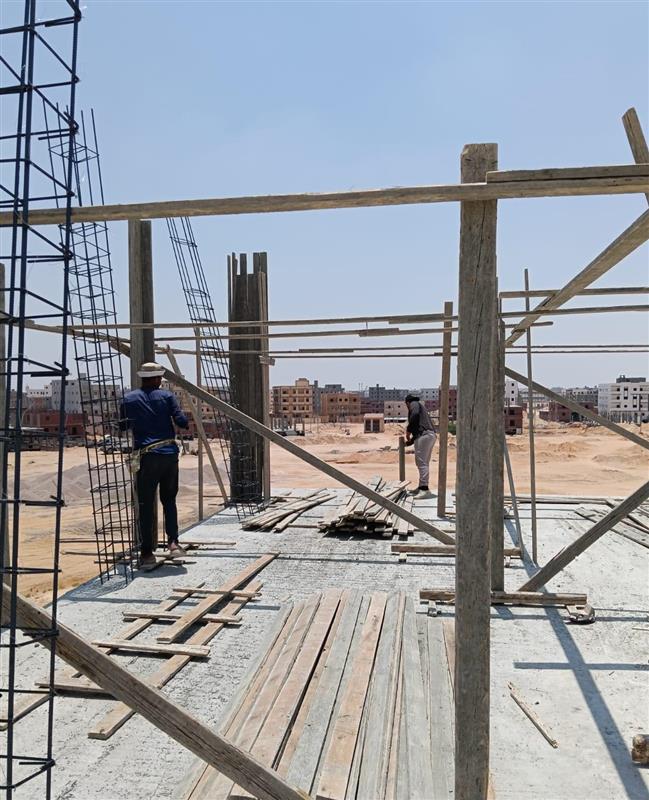

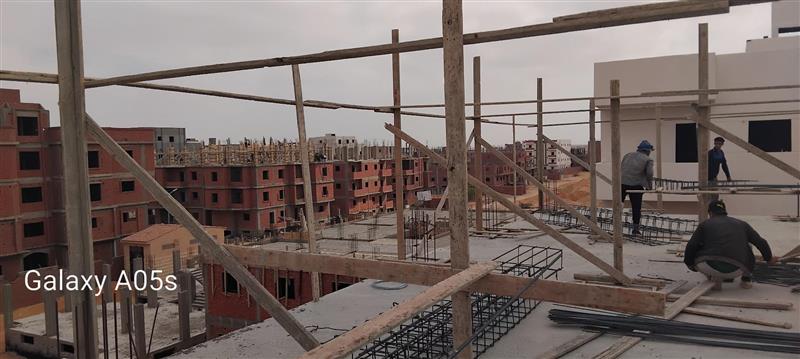

June 16, 2025

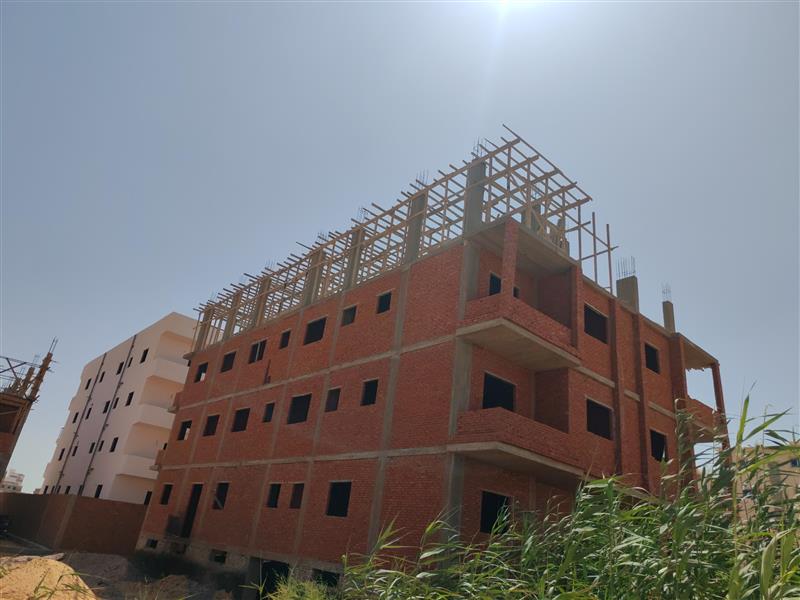

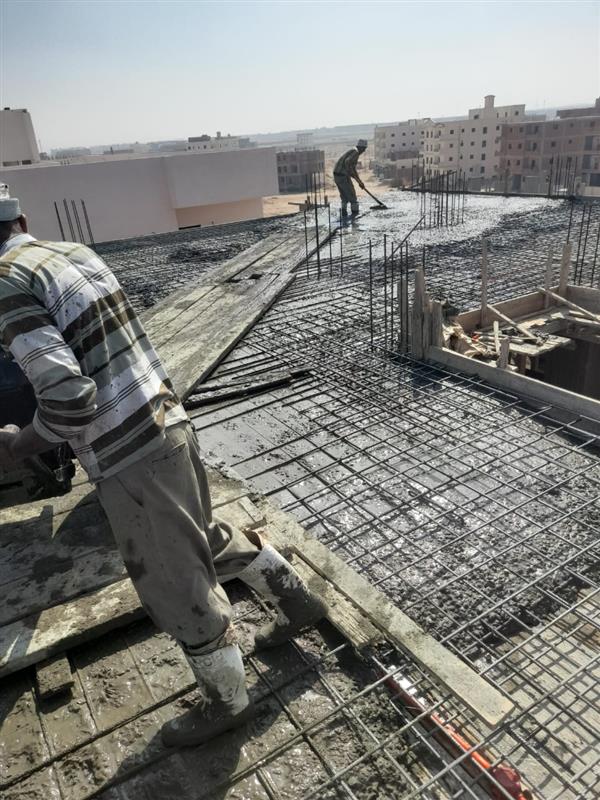

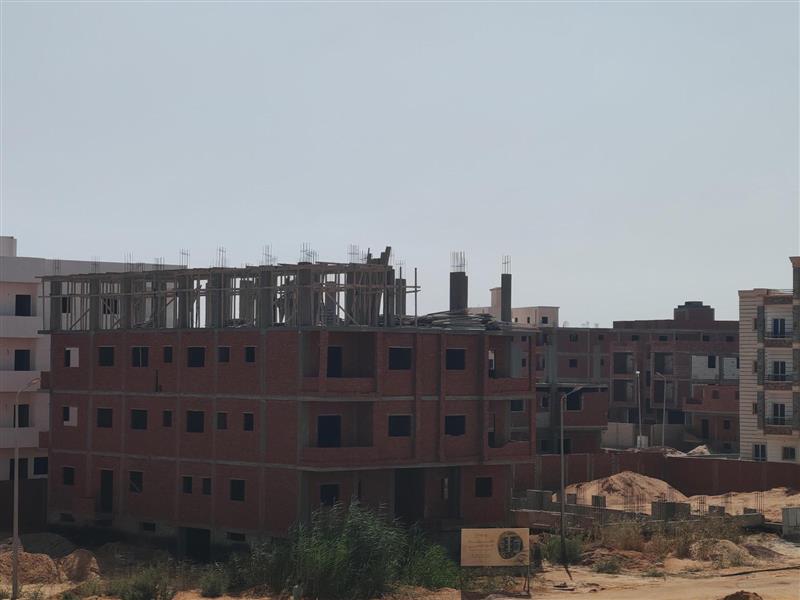

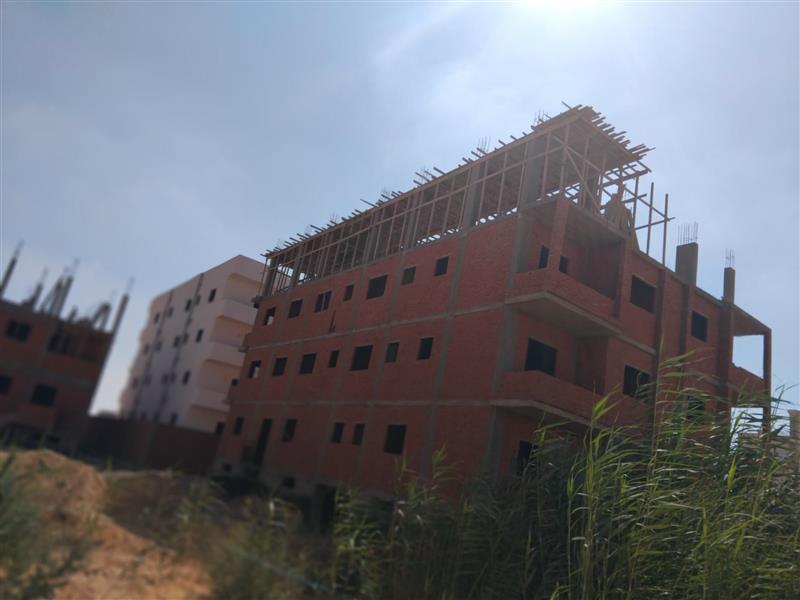

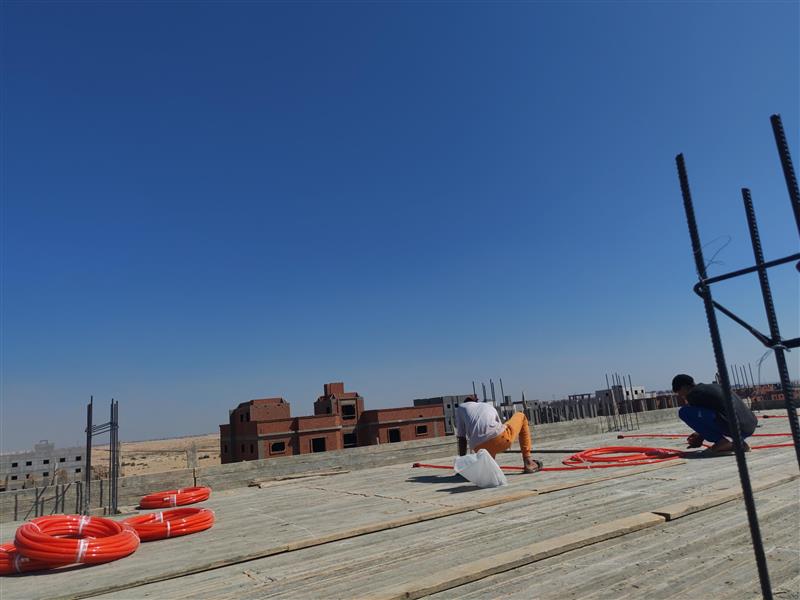

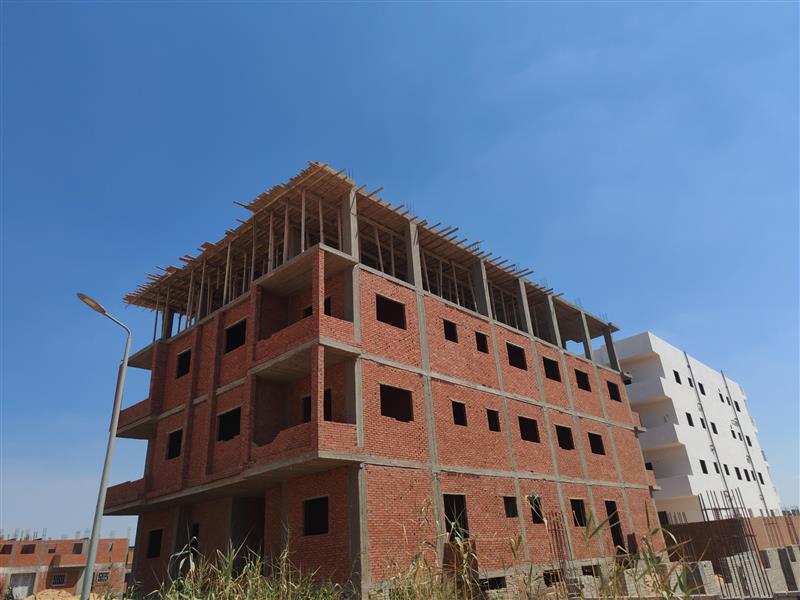

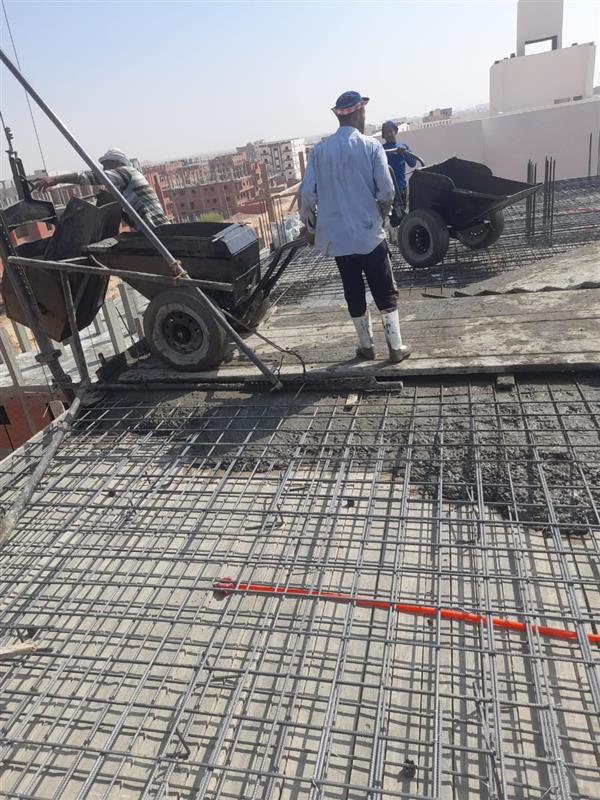

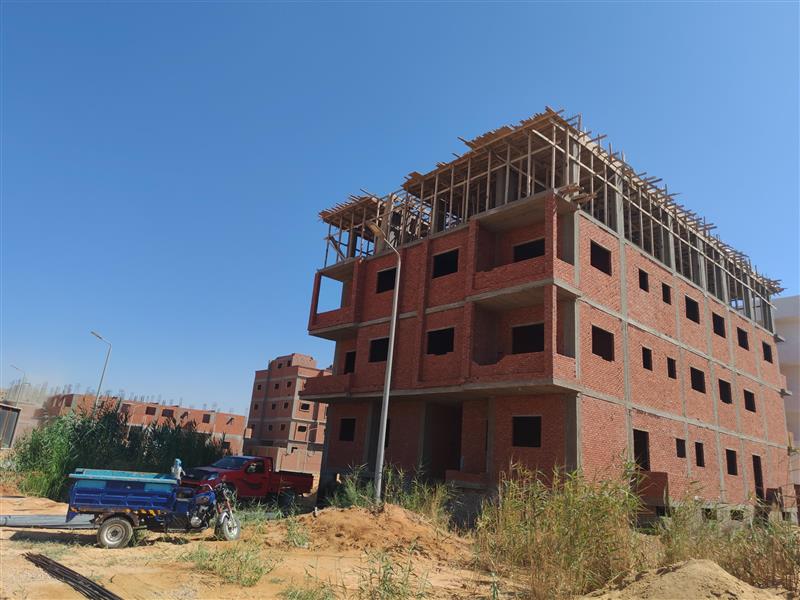

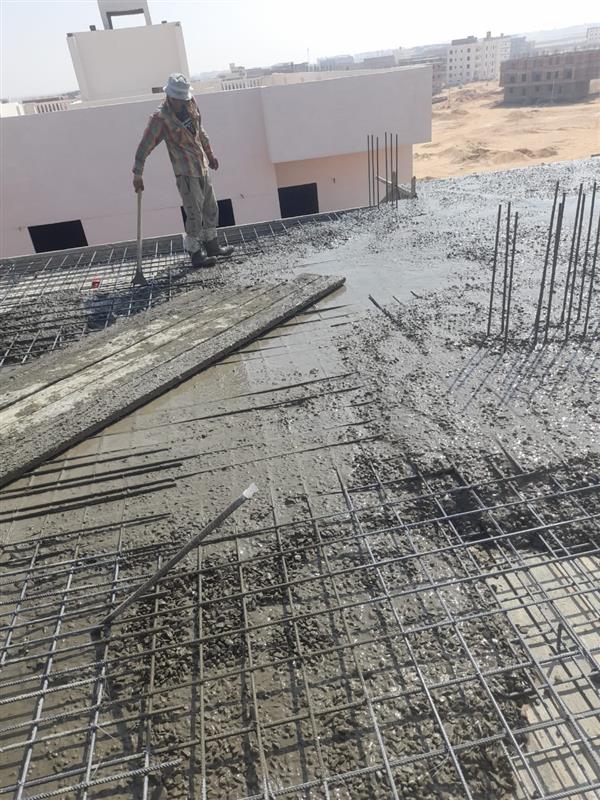

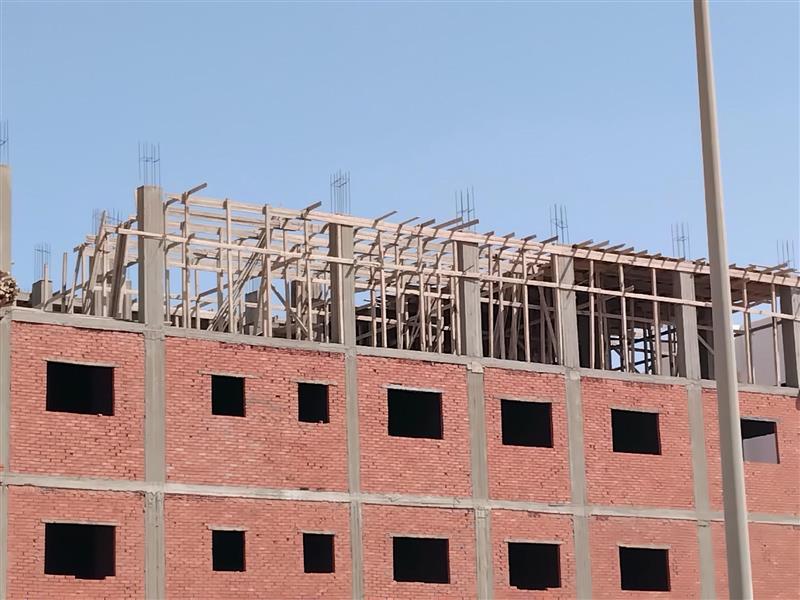

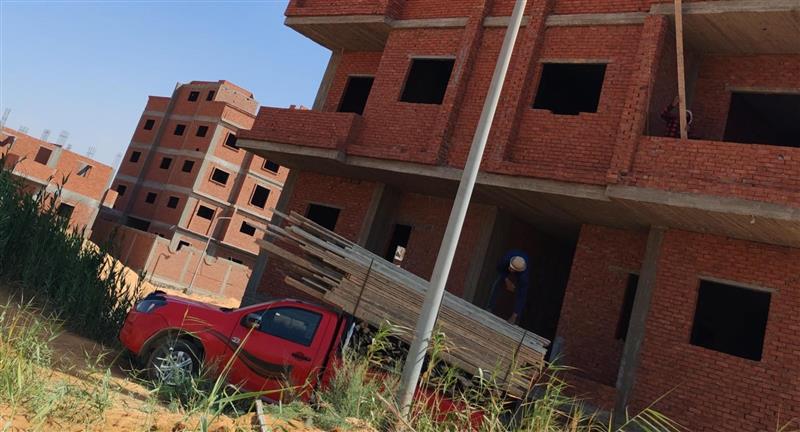

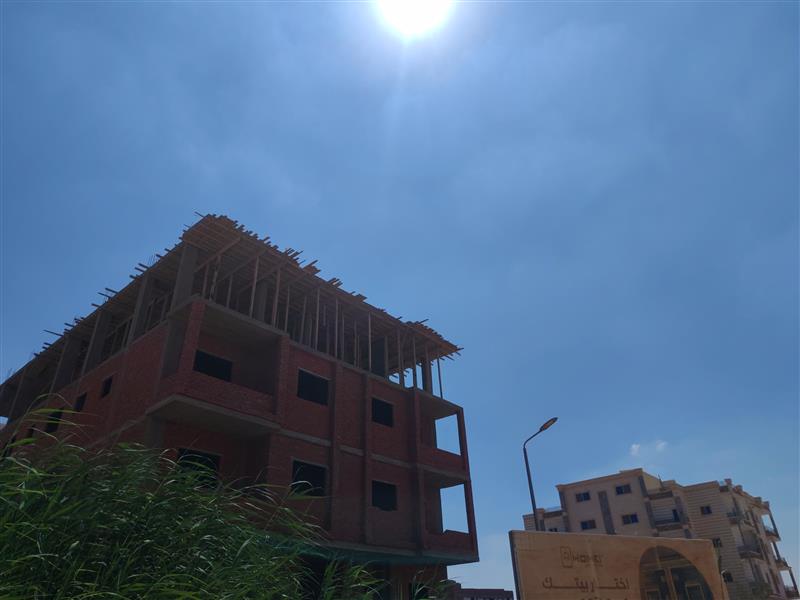

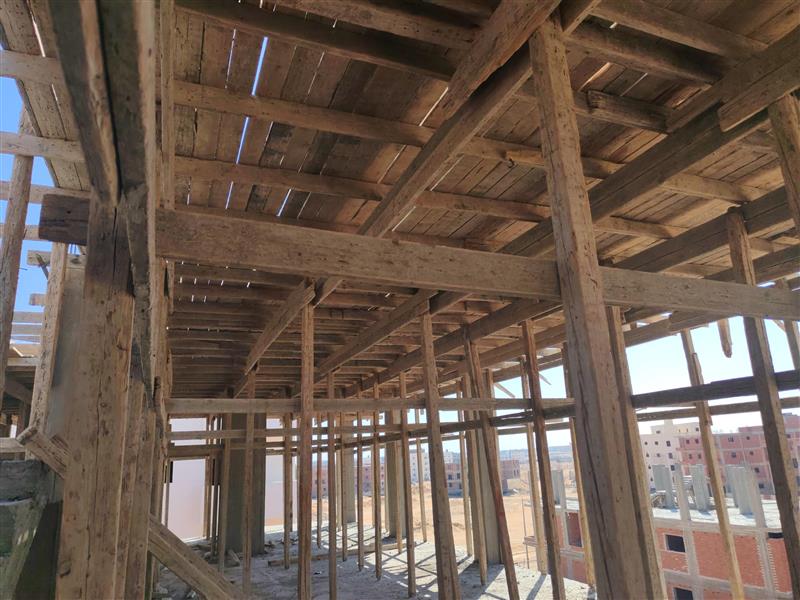

Third floor slab

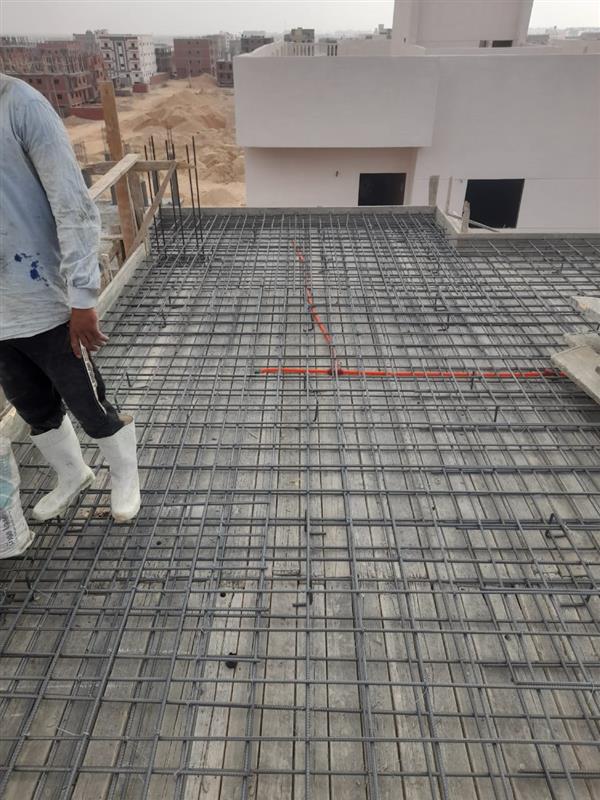

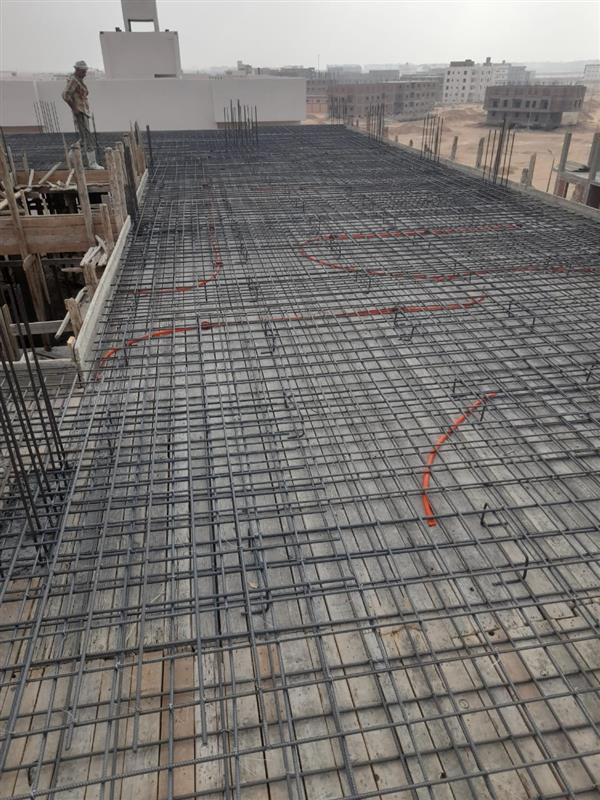

June 23, 2025

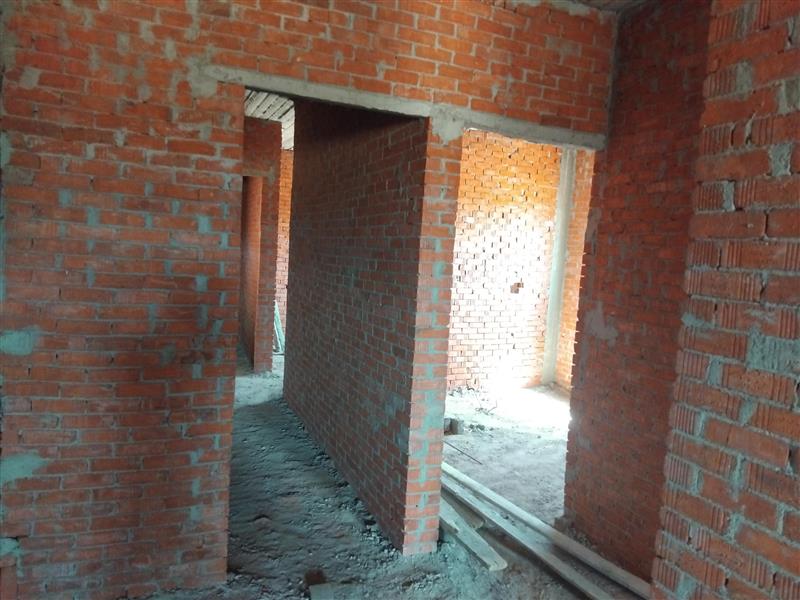

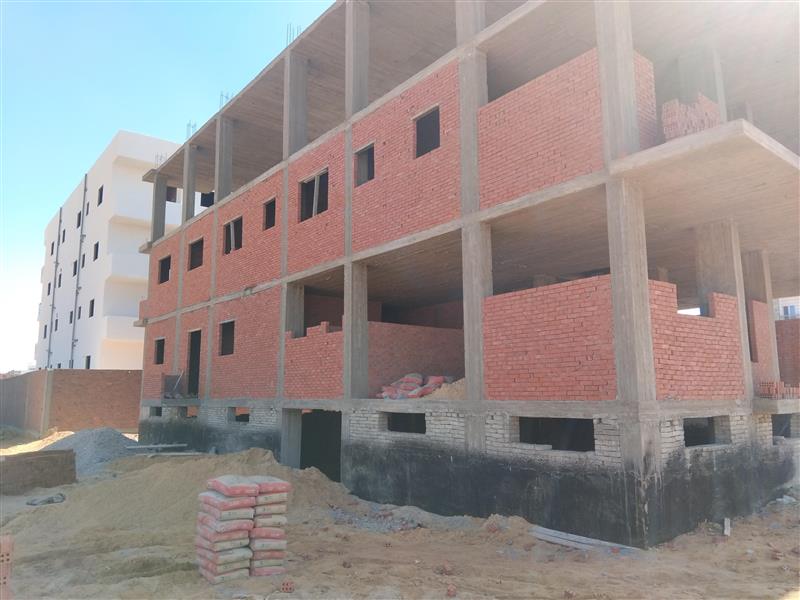

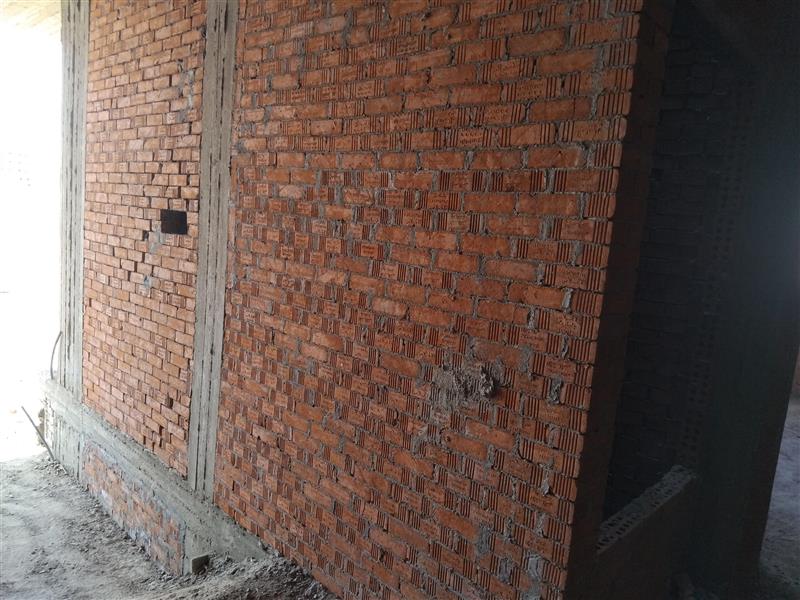

First floor walls
March 11, 2025

Roof extension license
July 21, 2025
Roof concrete works
July 29, 2025

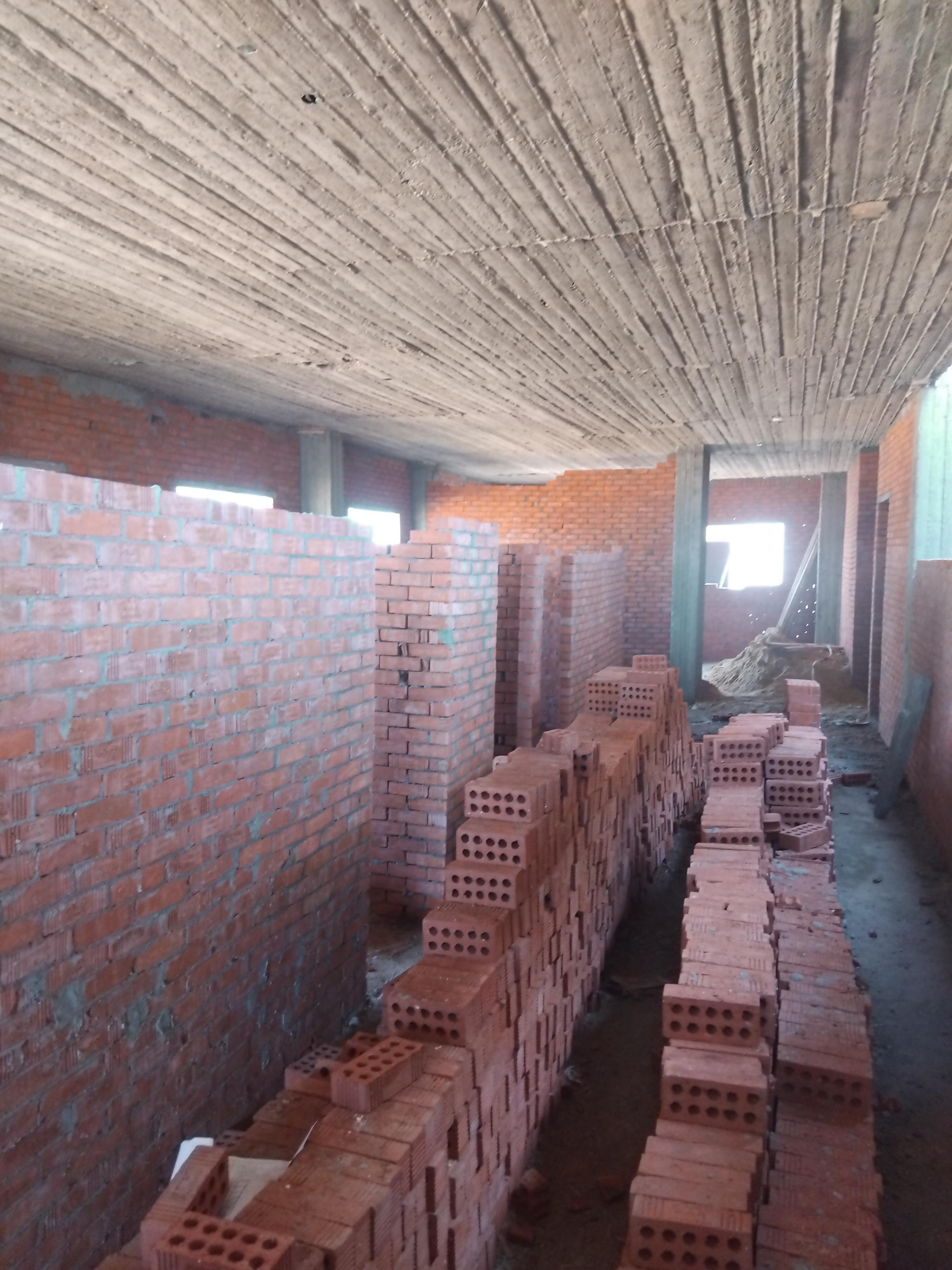

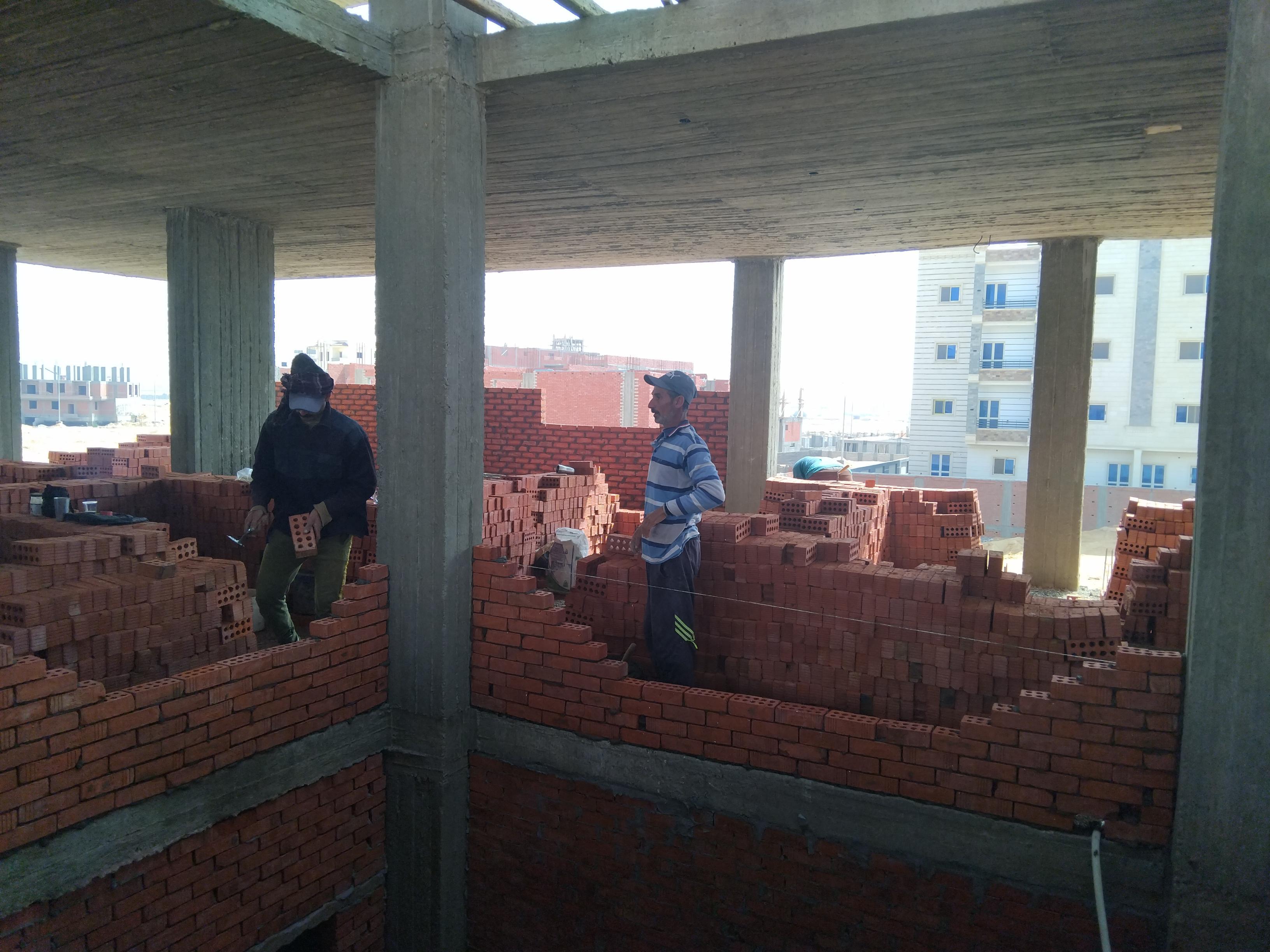

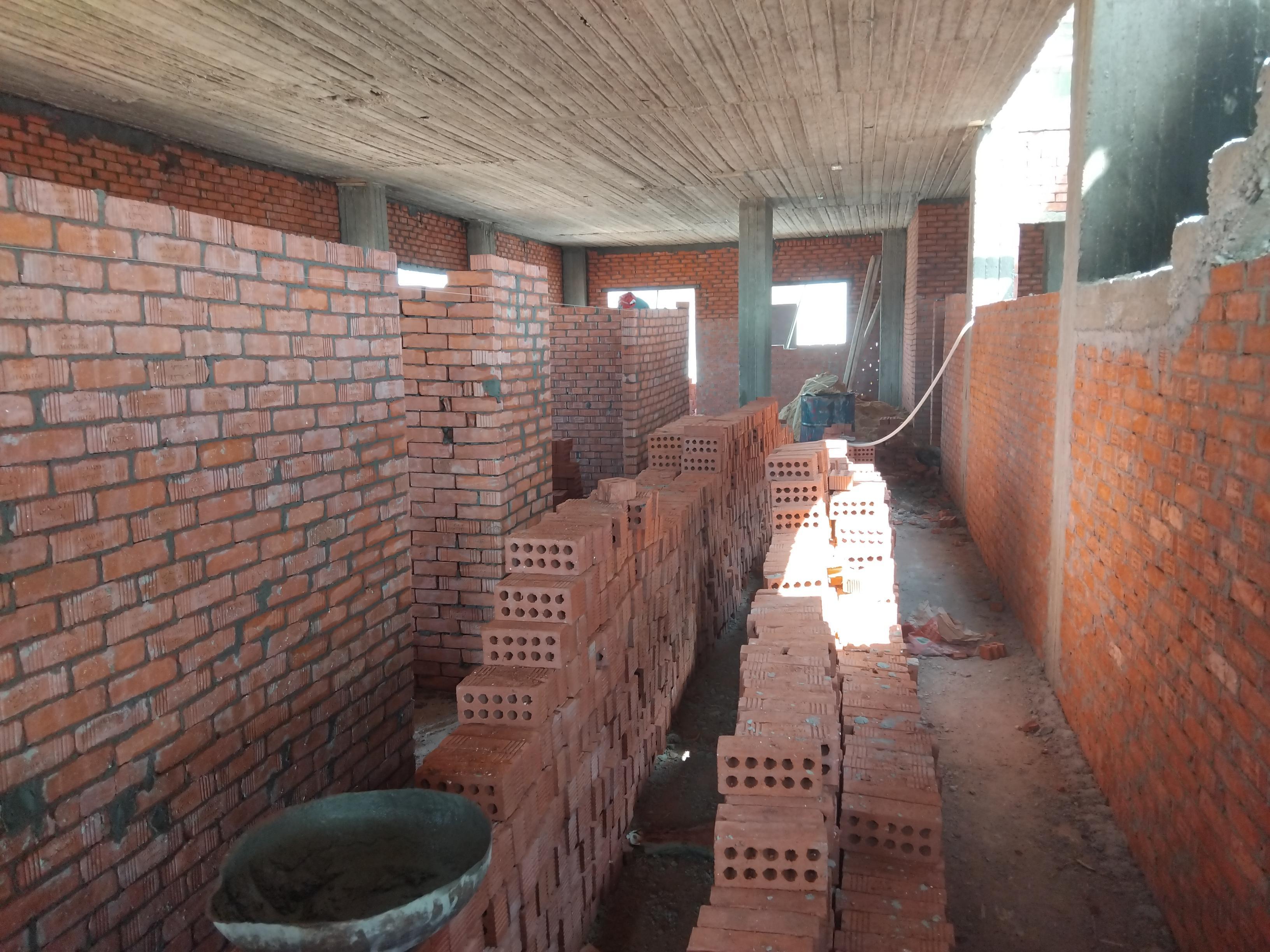

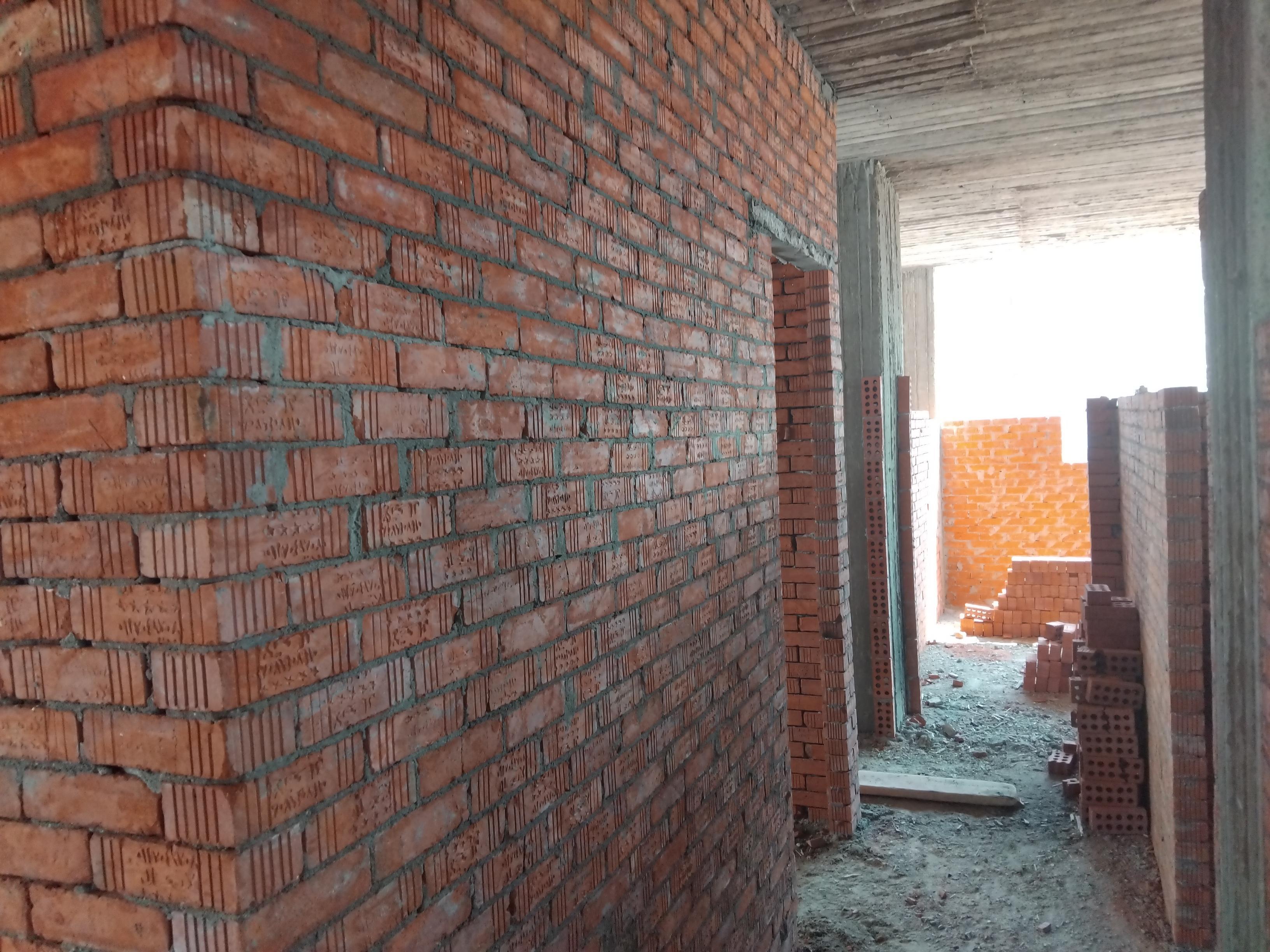

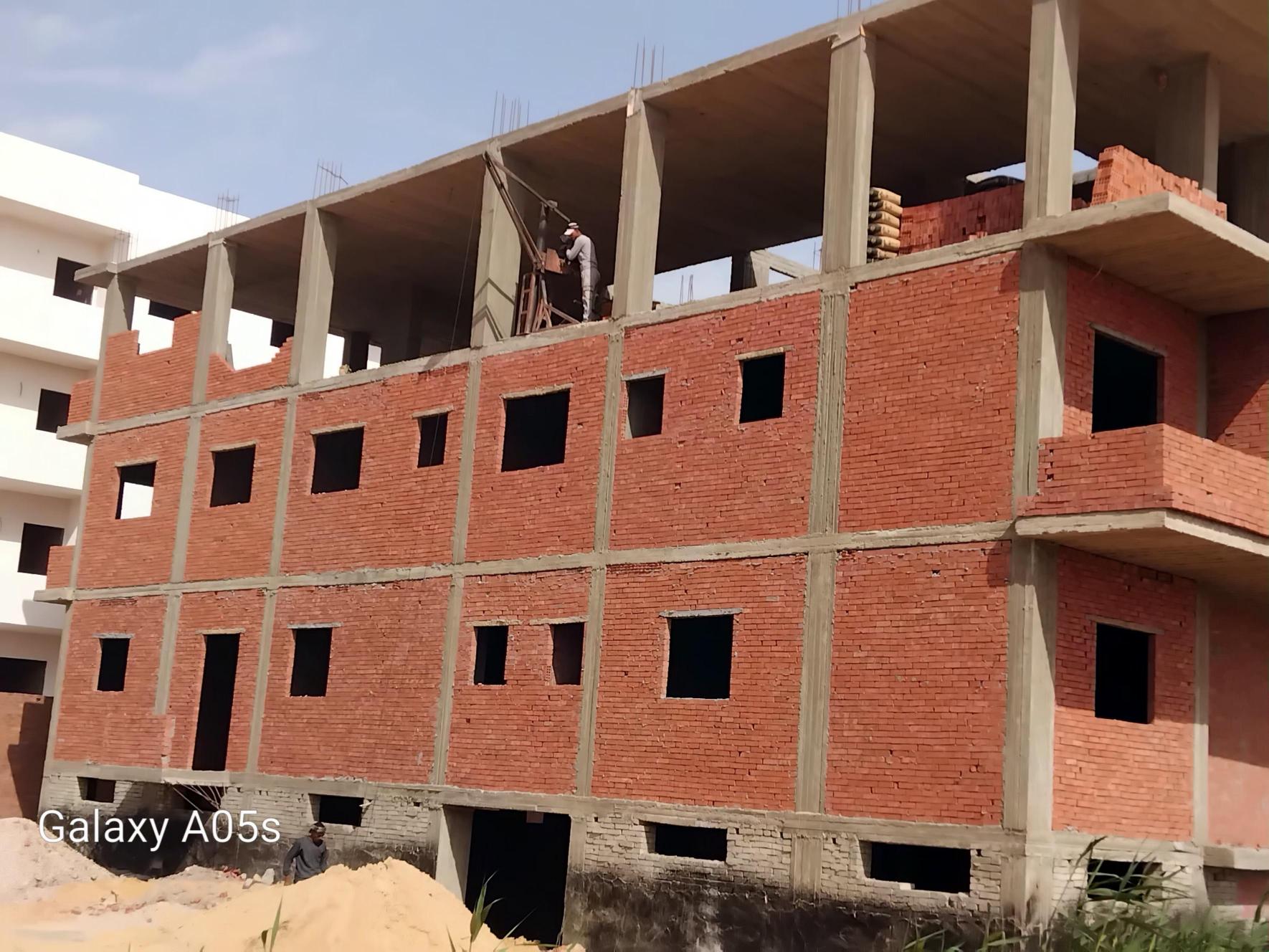

Second floor walls

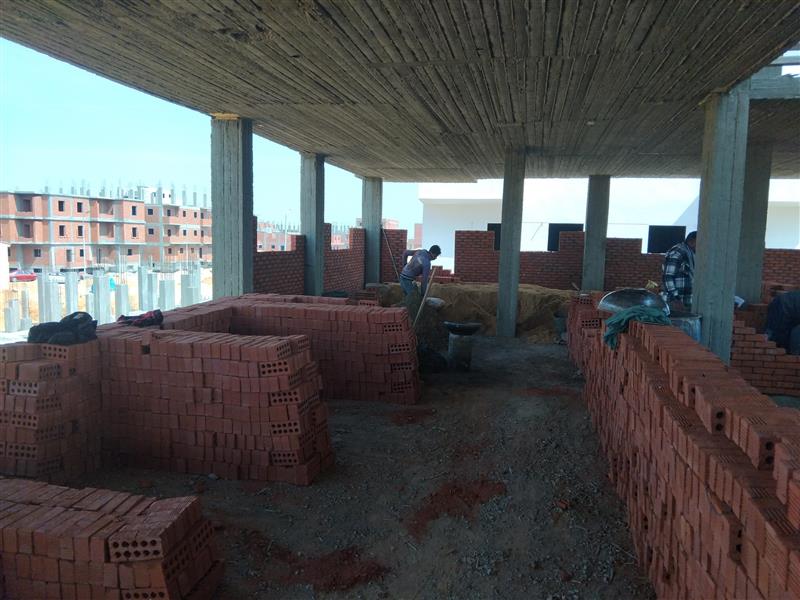

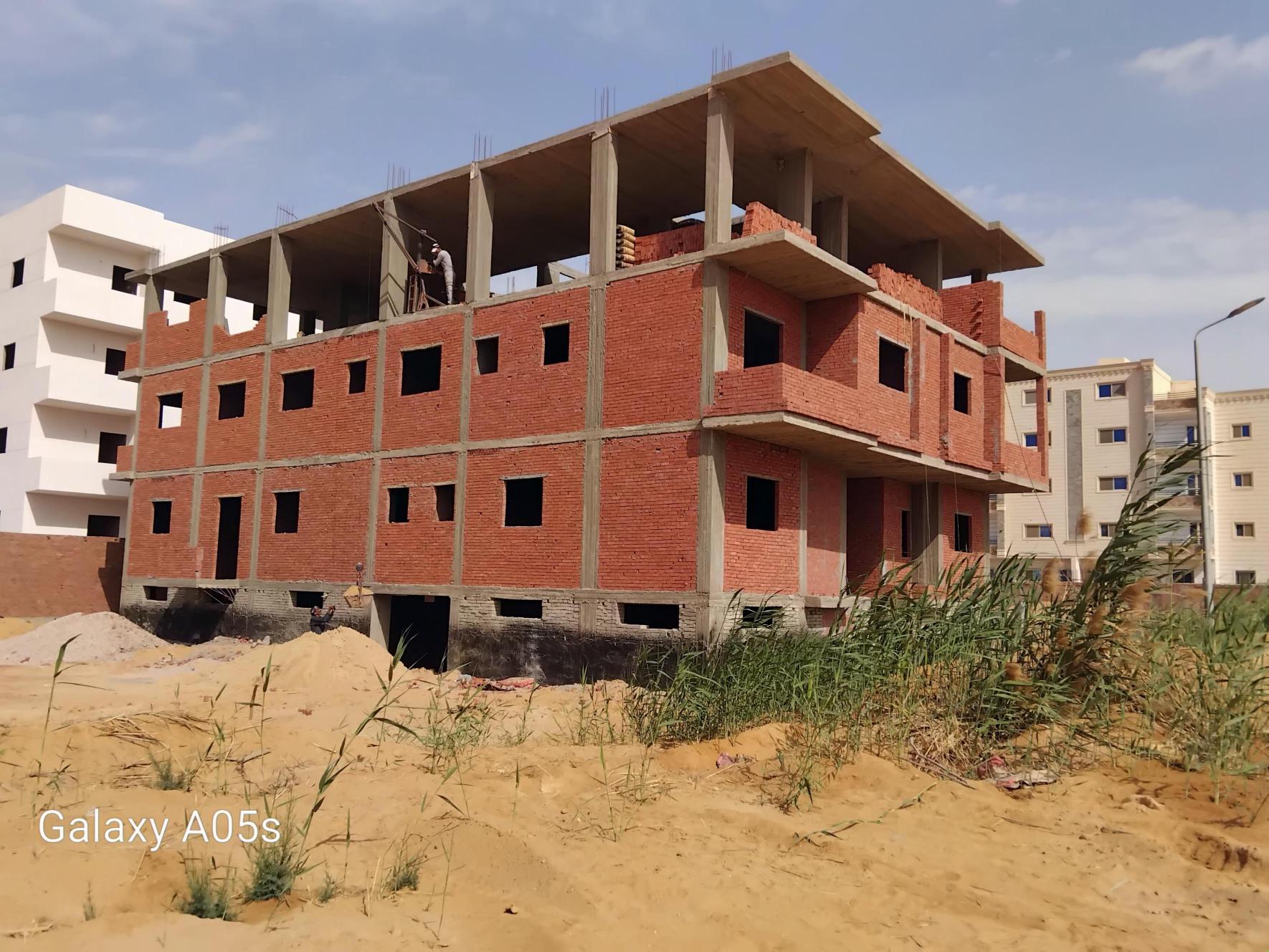

March 6, 2025

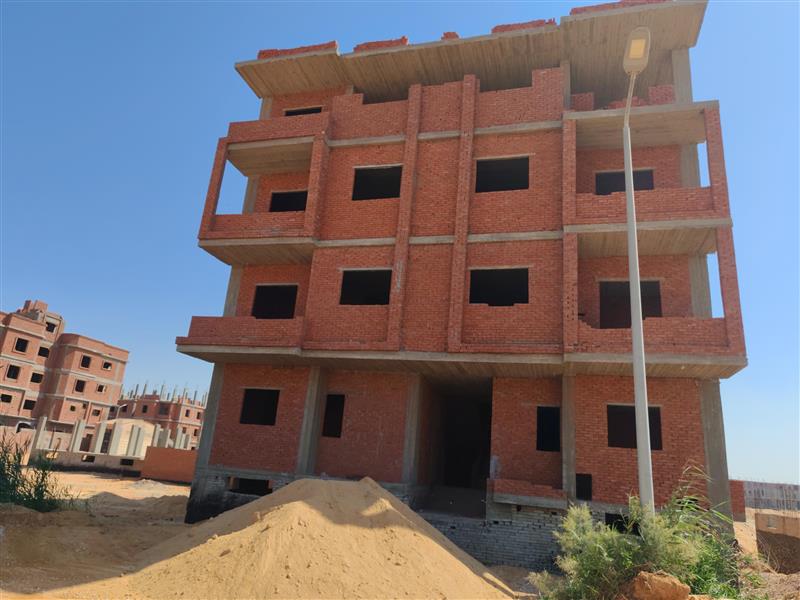

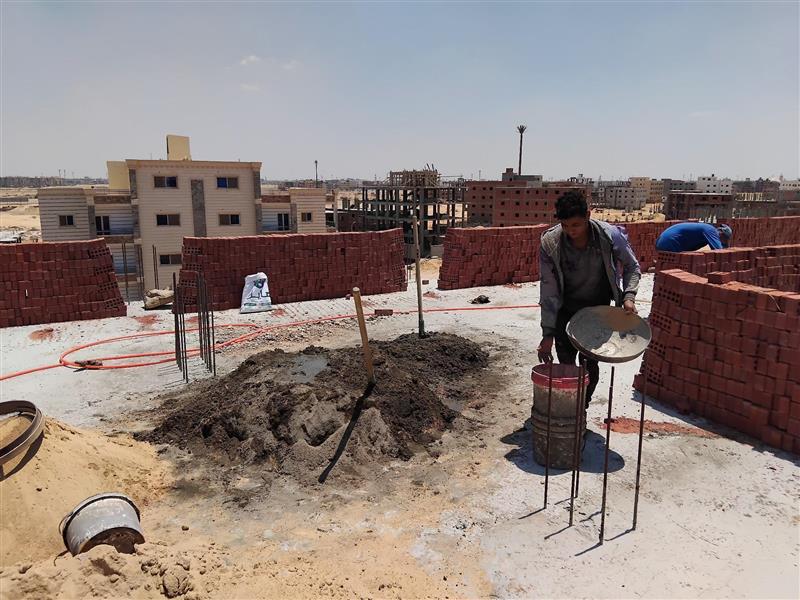

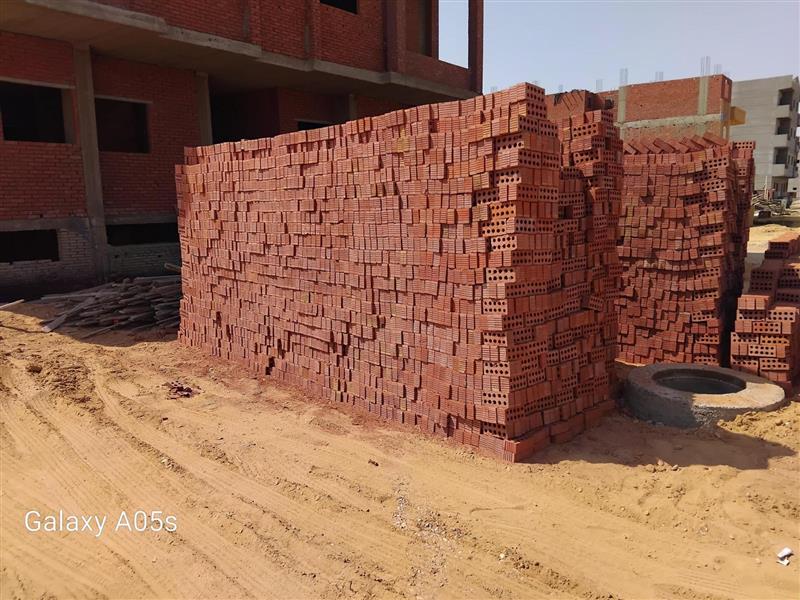

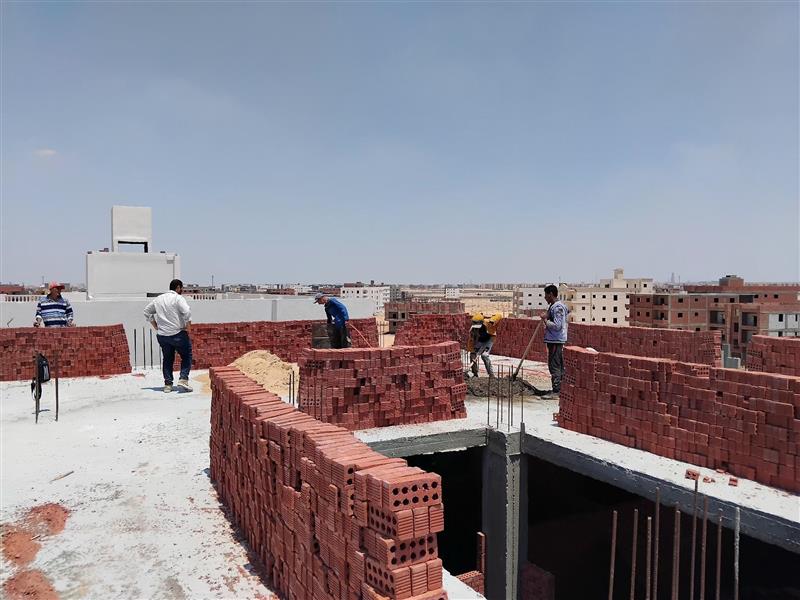

Third floor walls

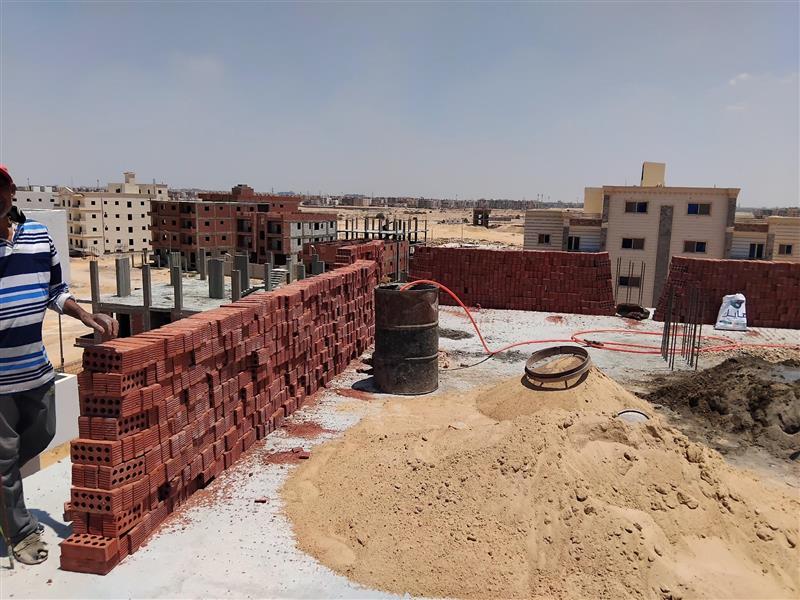

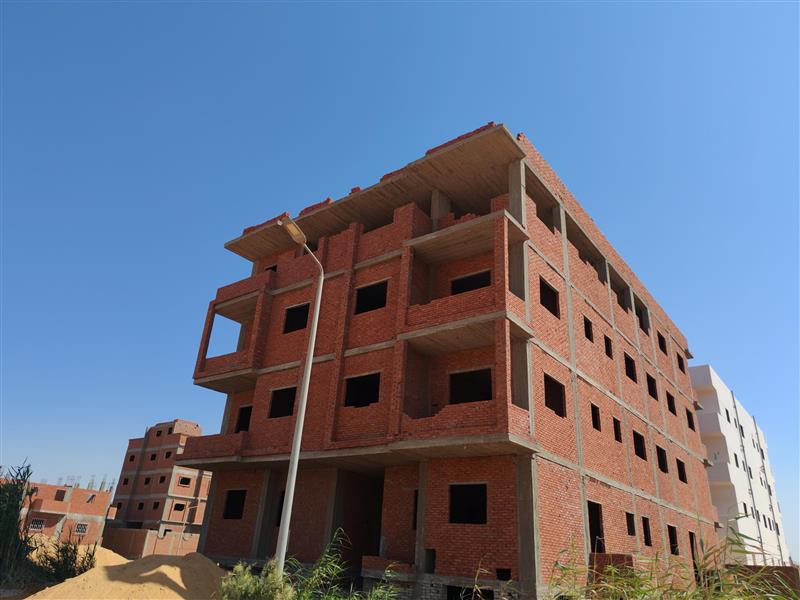

September 16, 2025

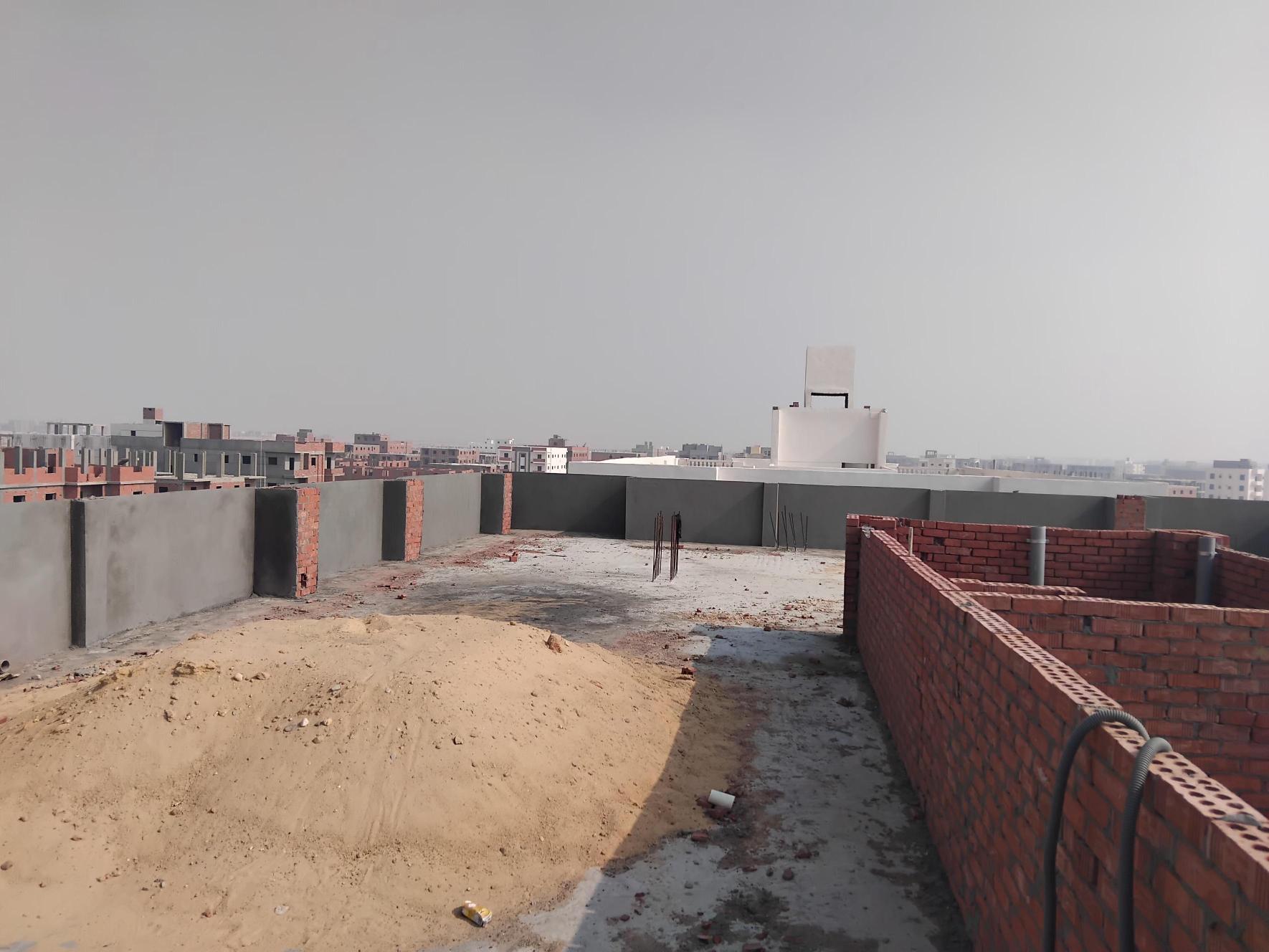

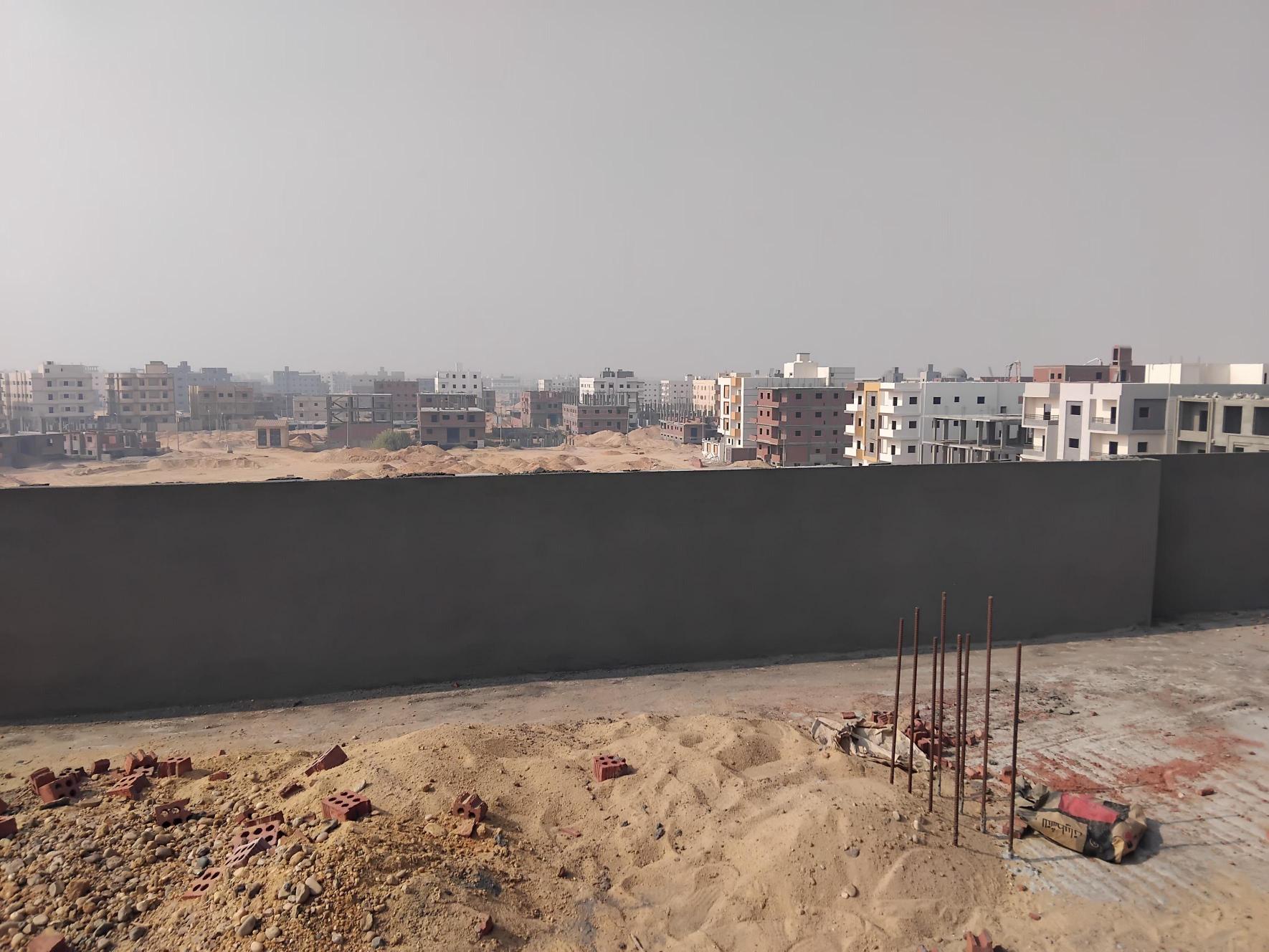

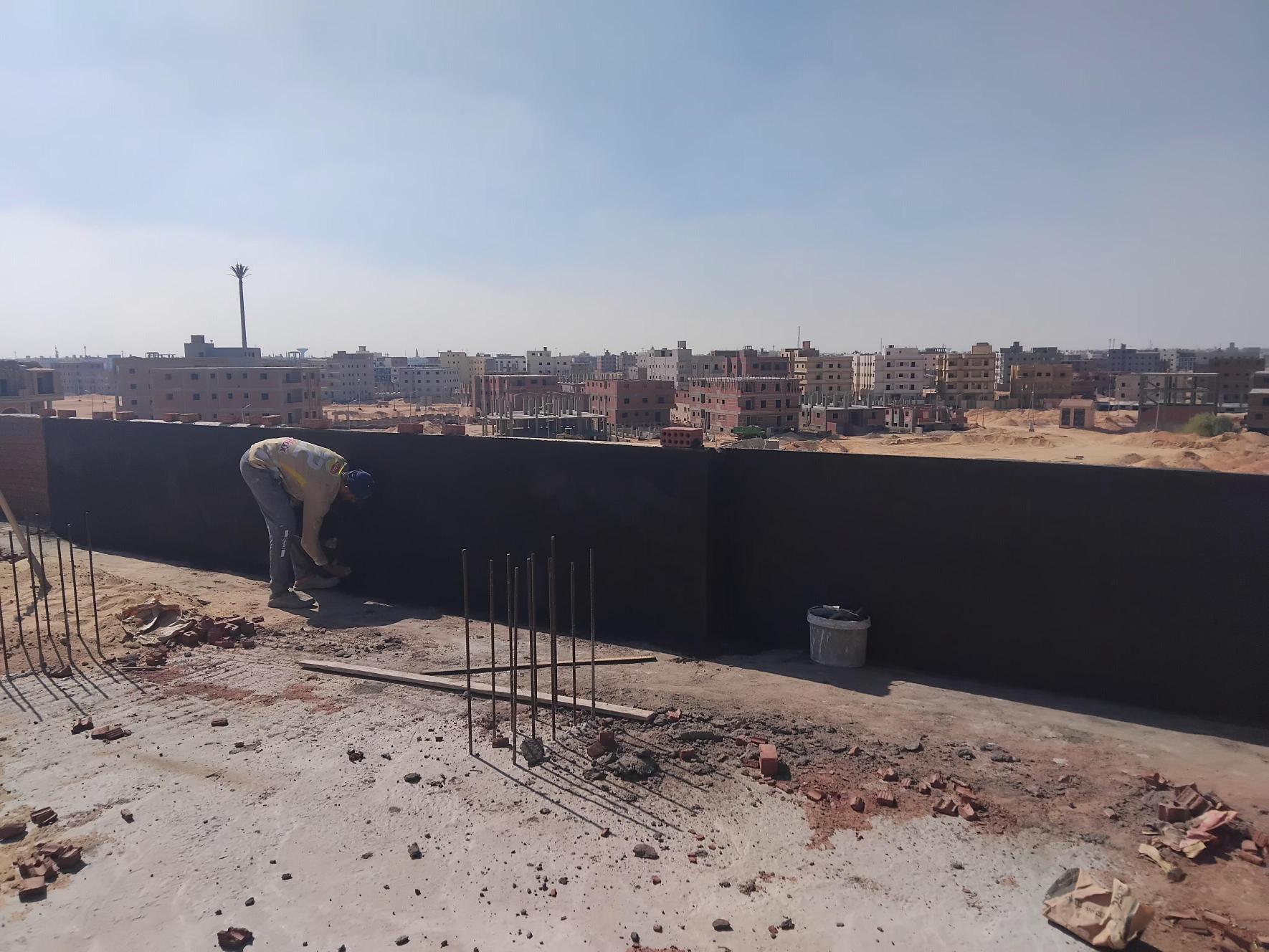

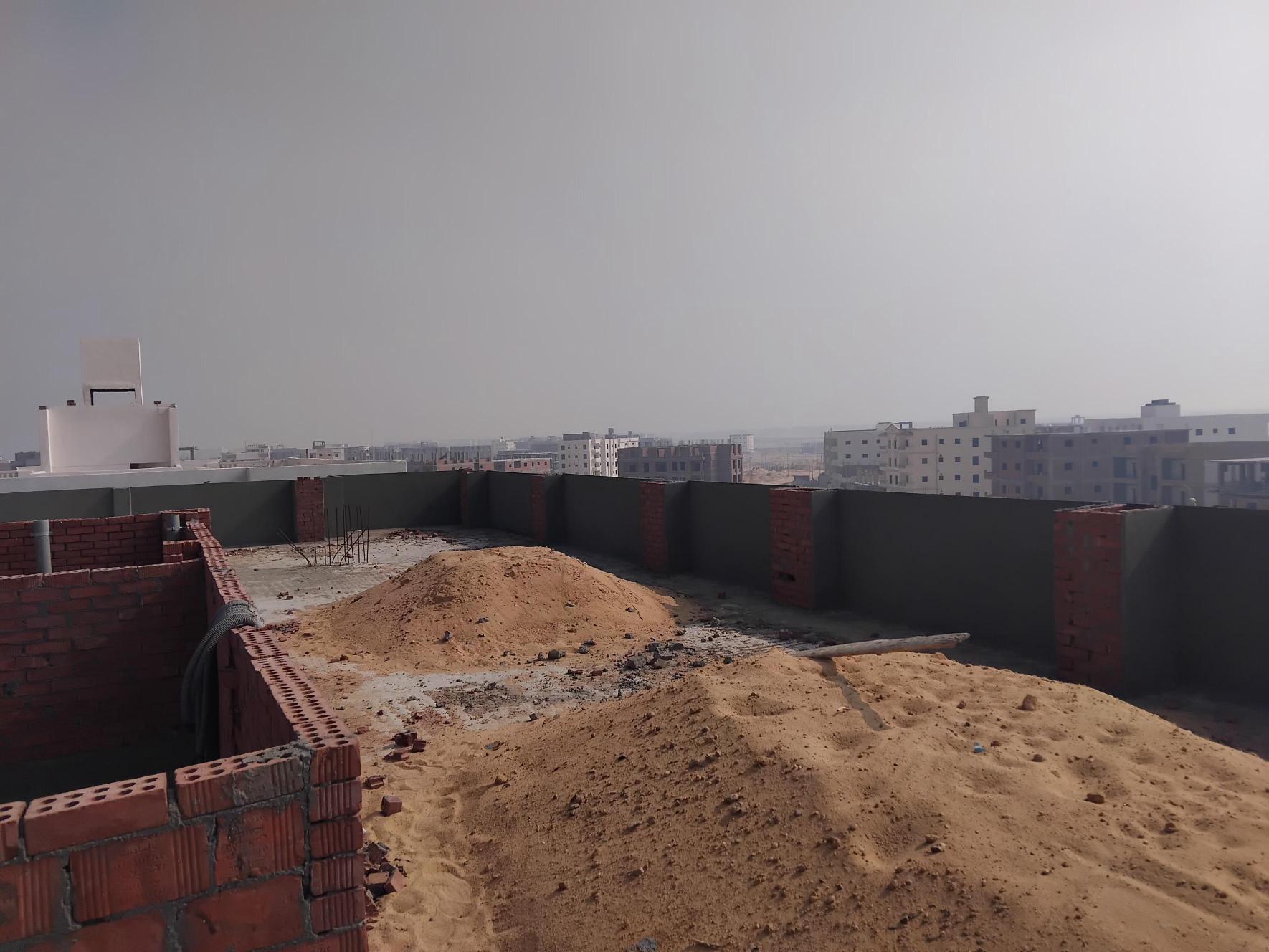

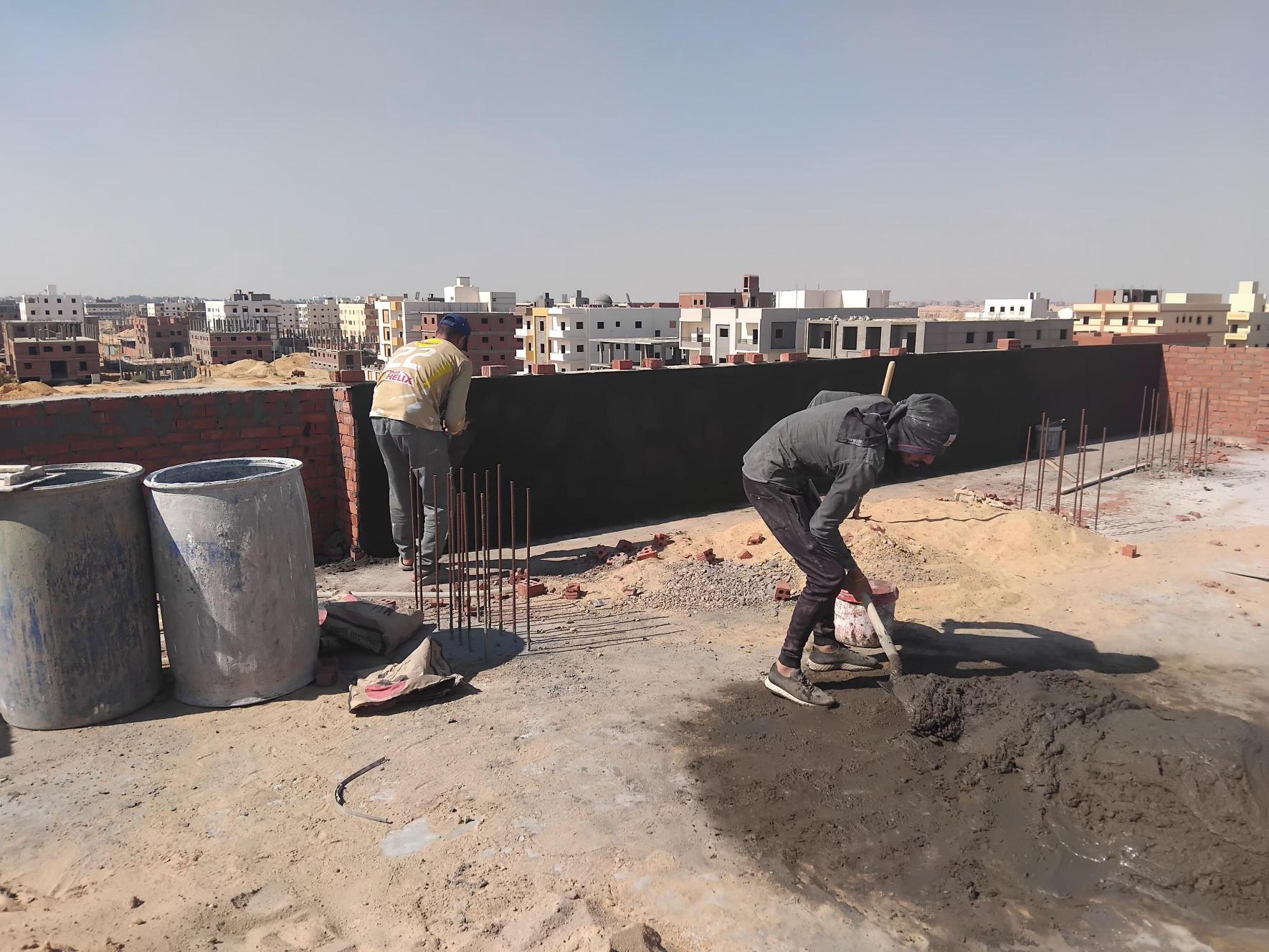

Roof walls

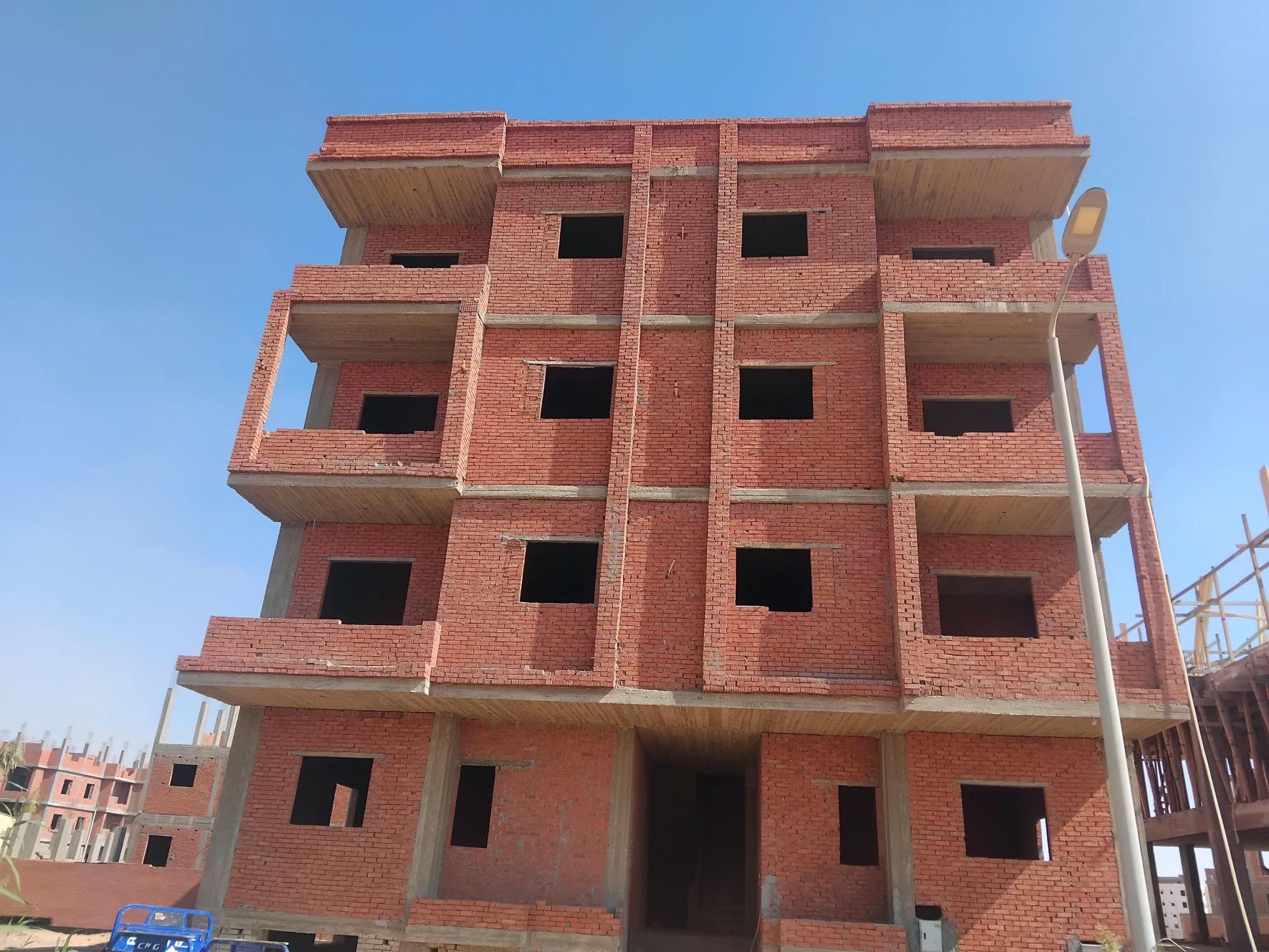

September 16, 2025

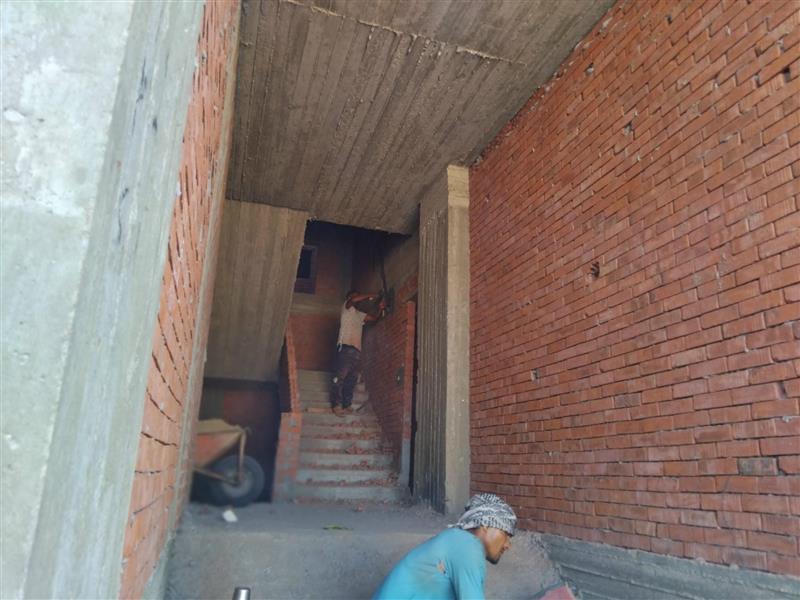

Electrical works
December 30, 2025

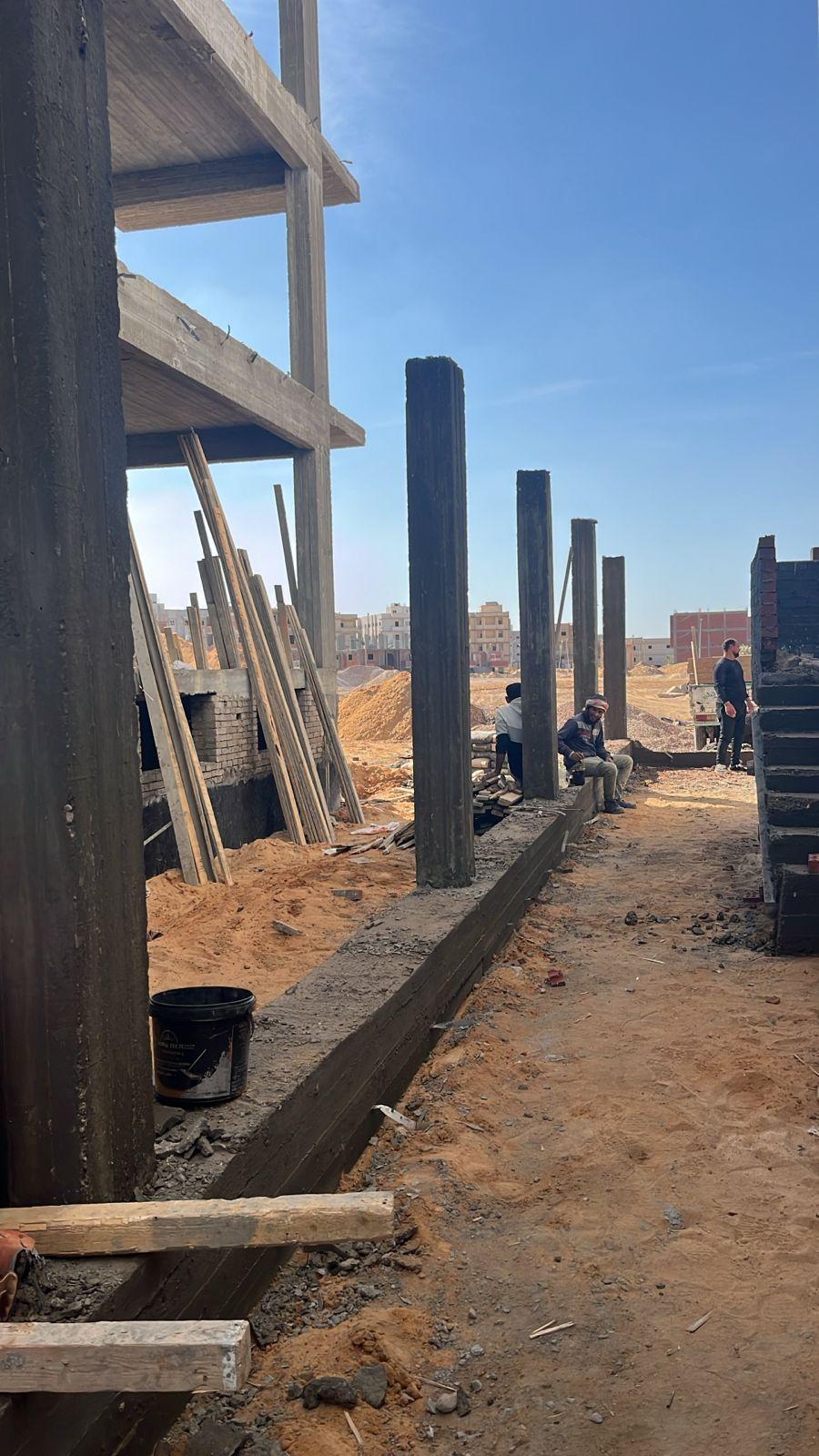

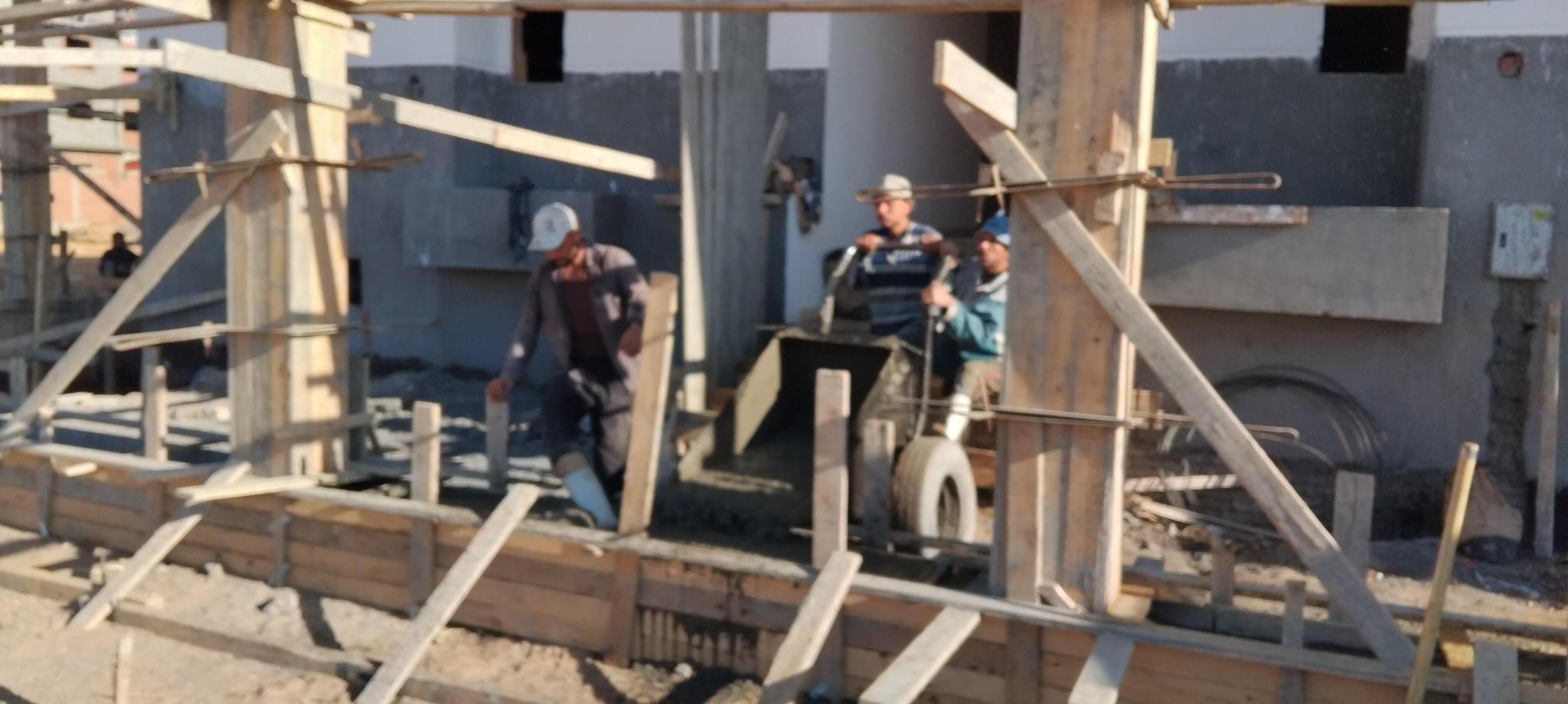

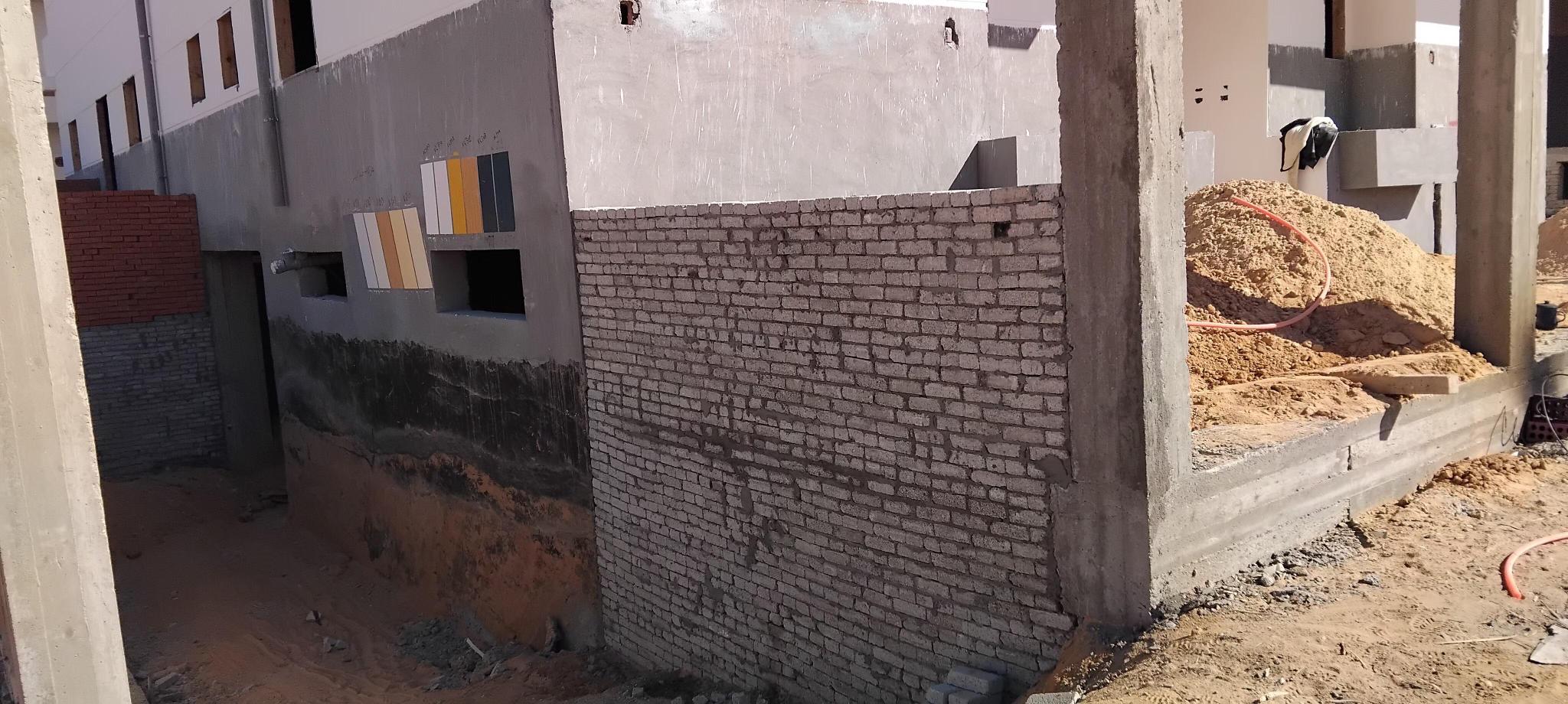

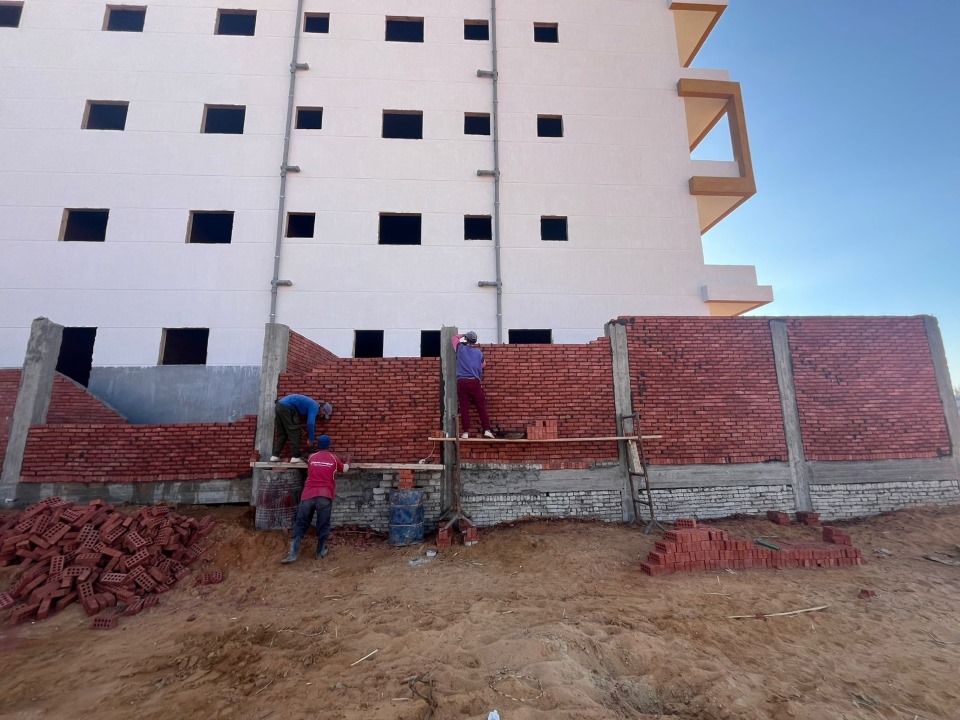

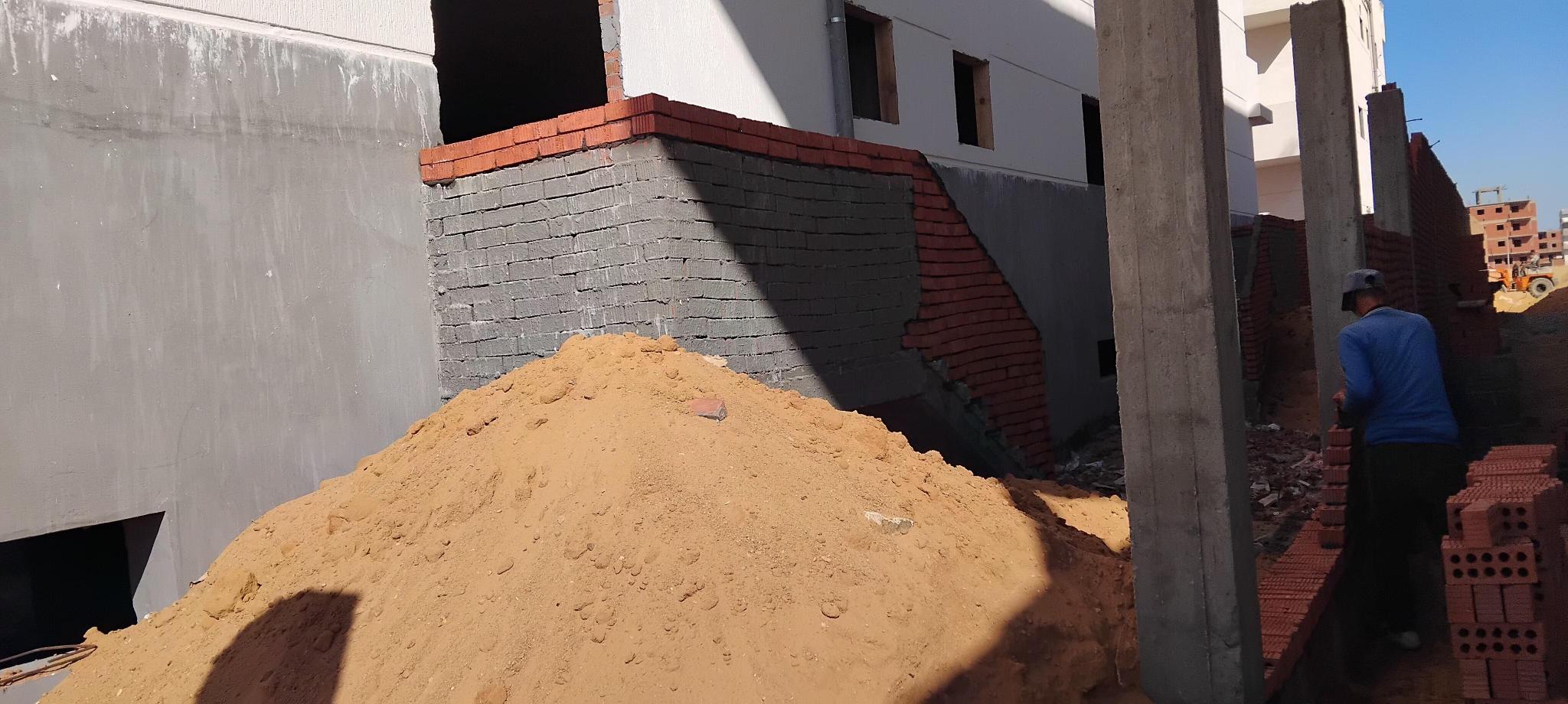

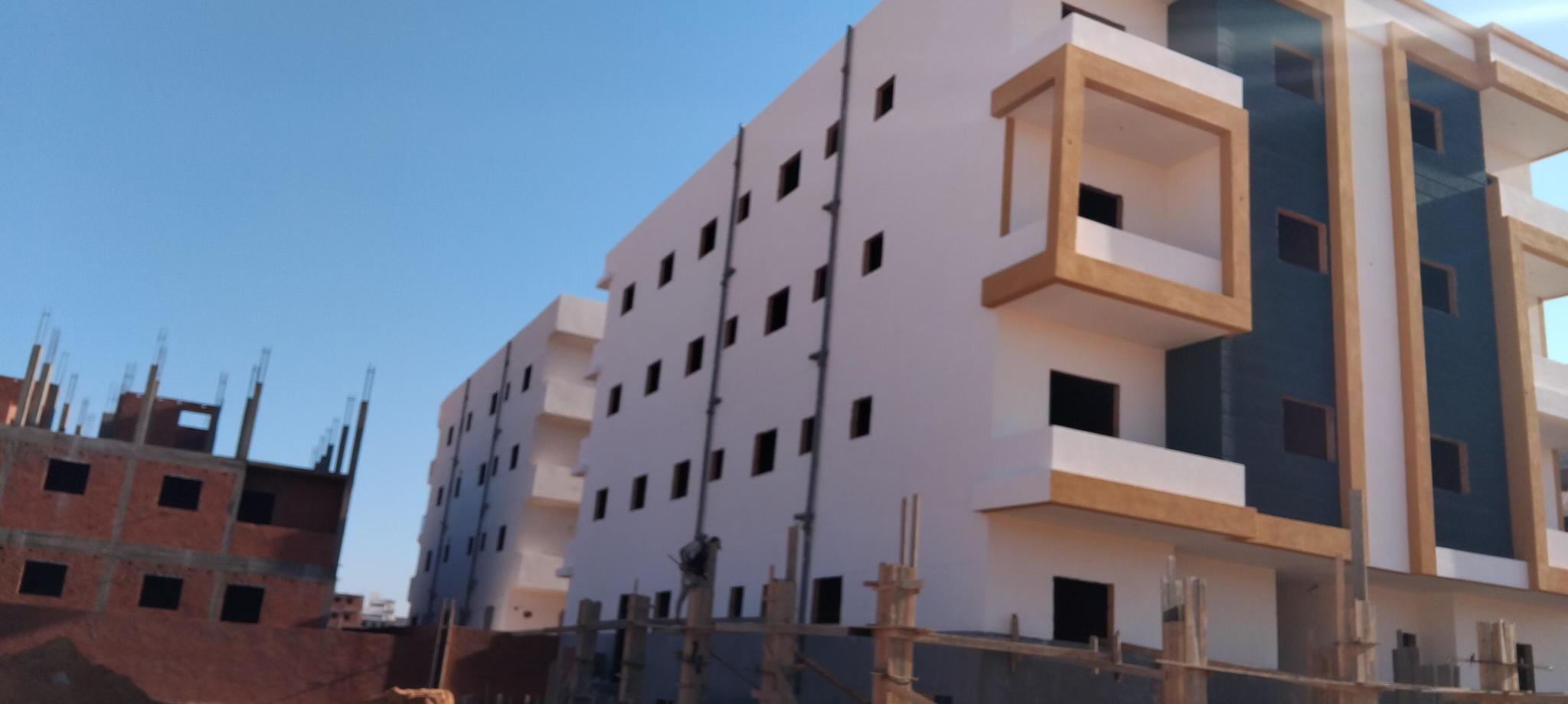

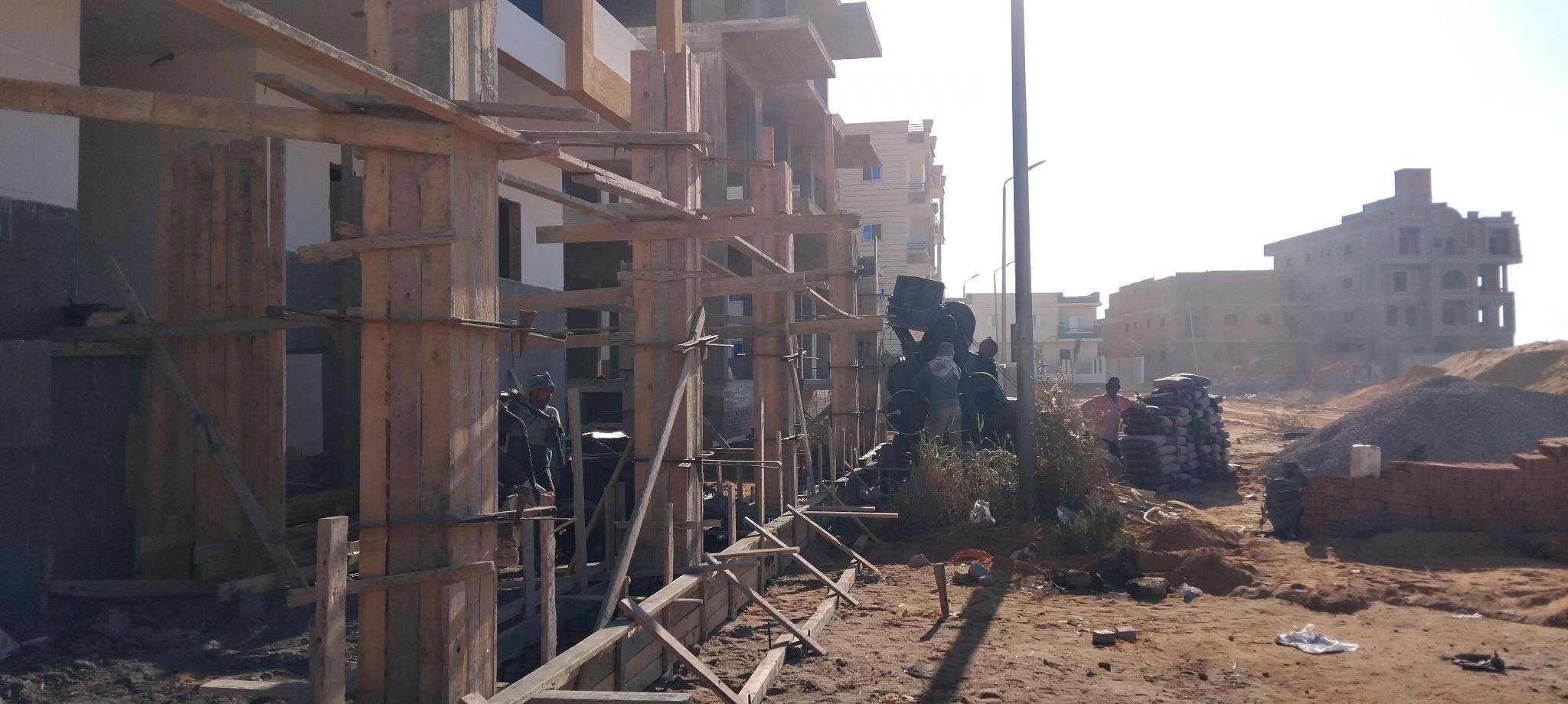

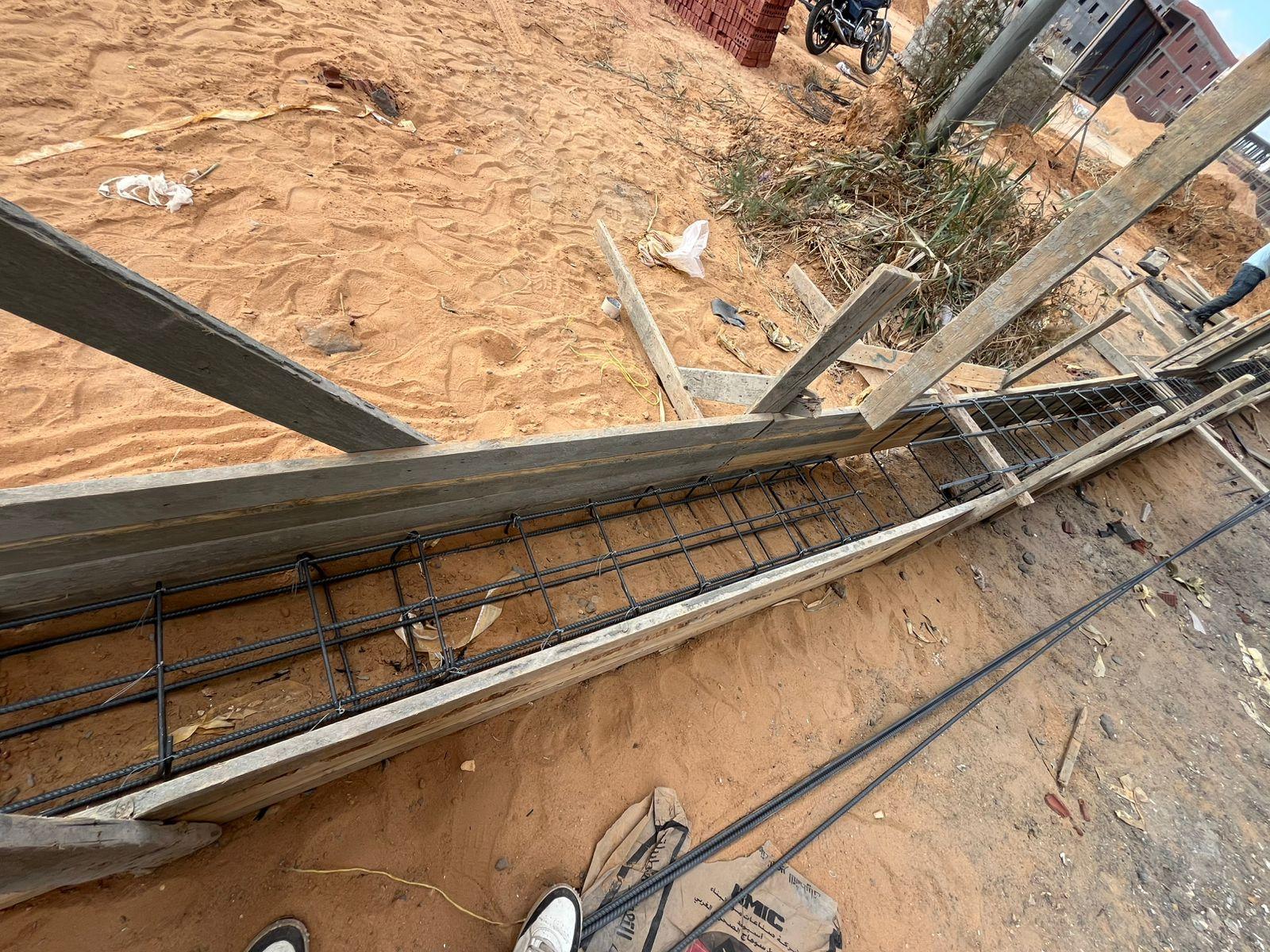

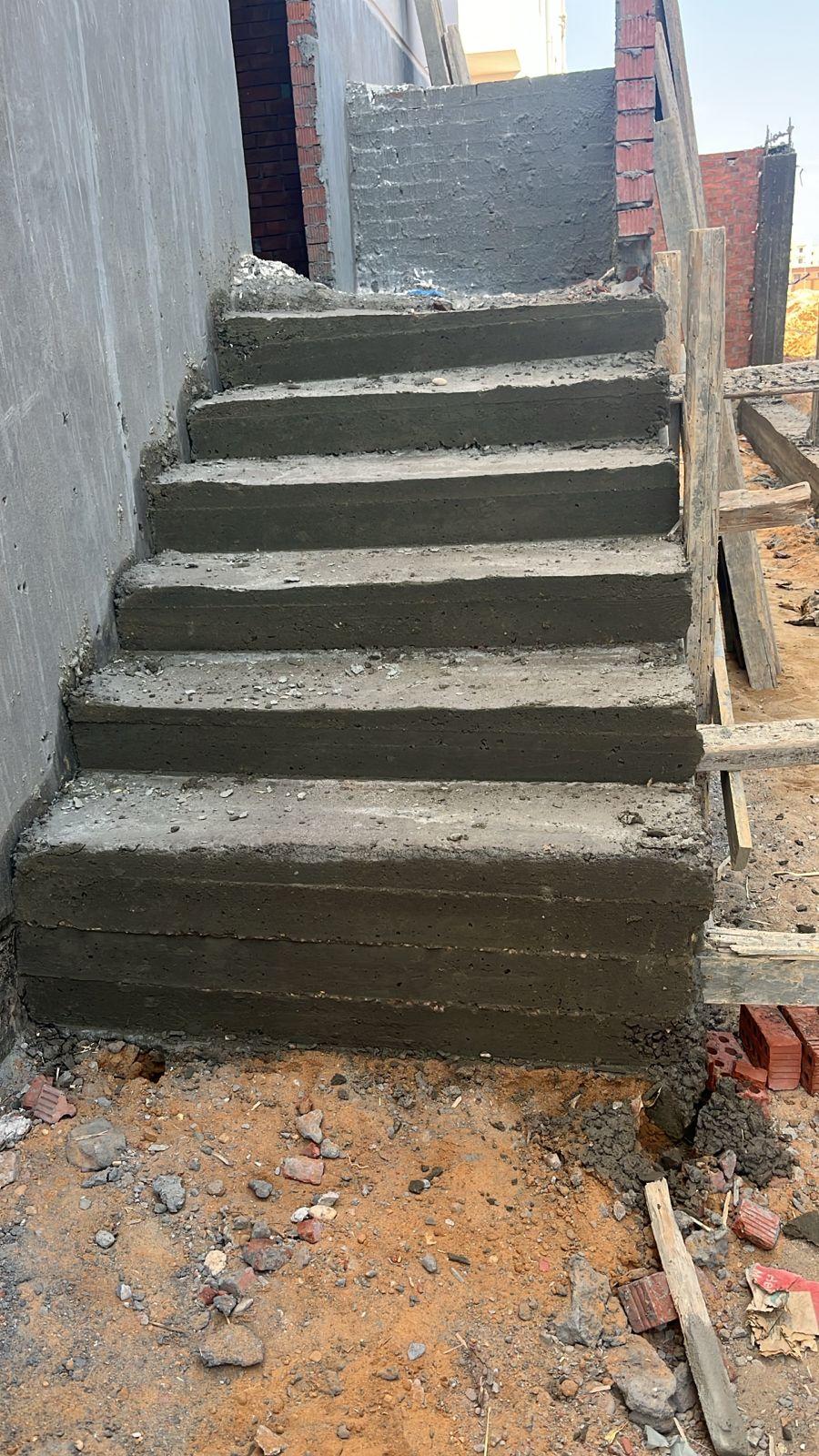

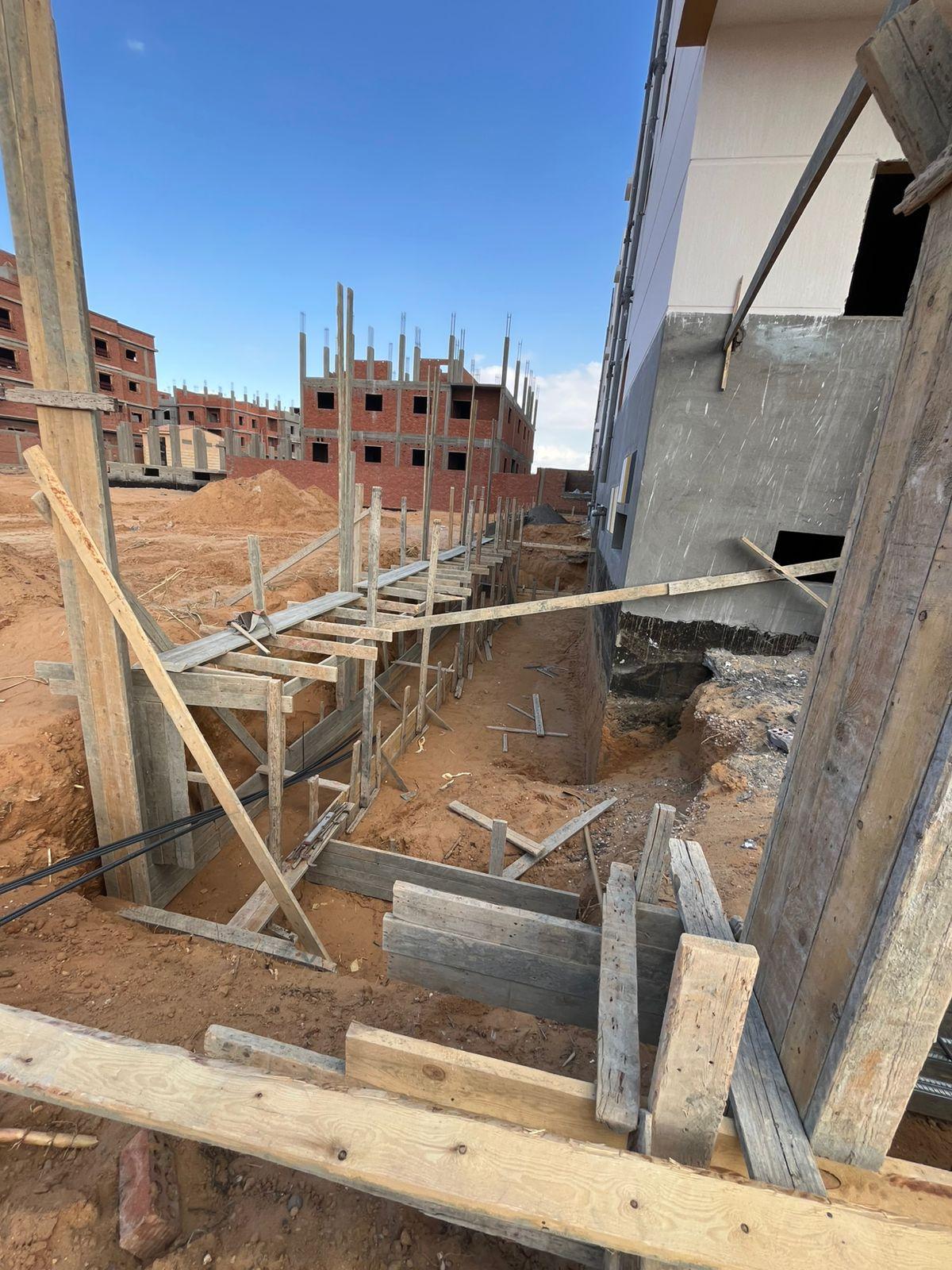

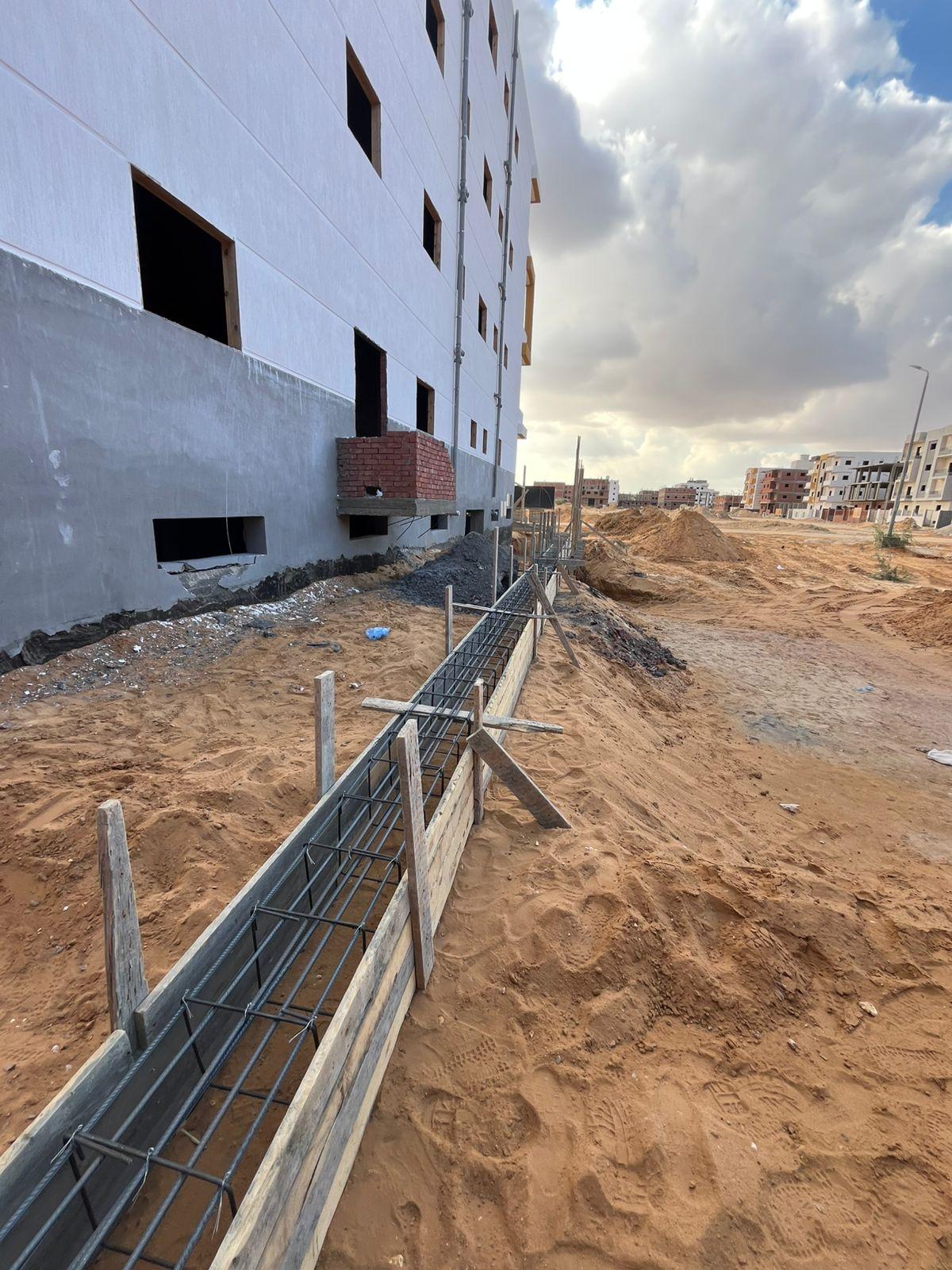

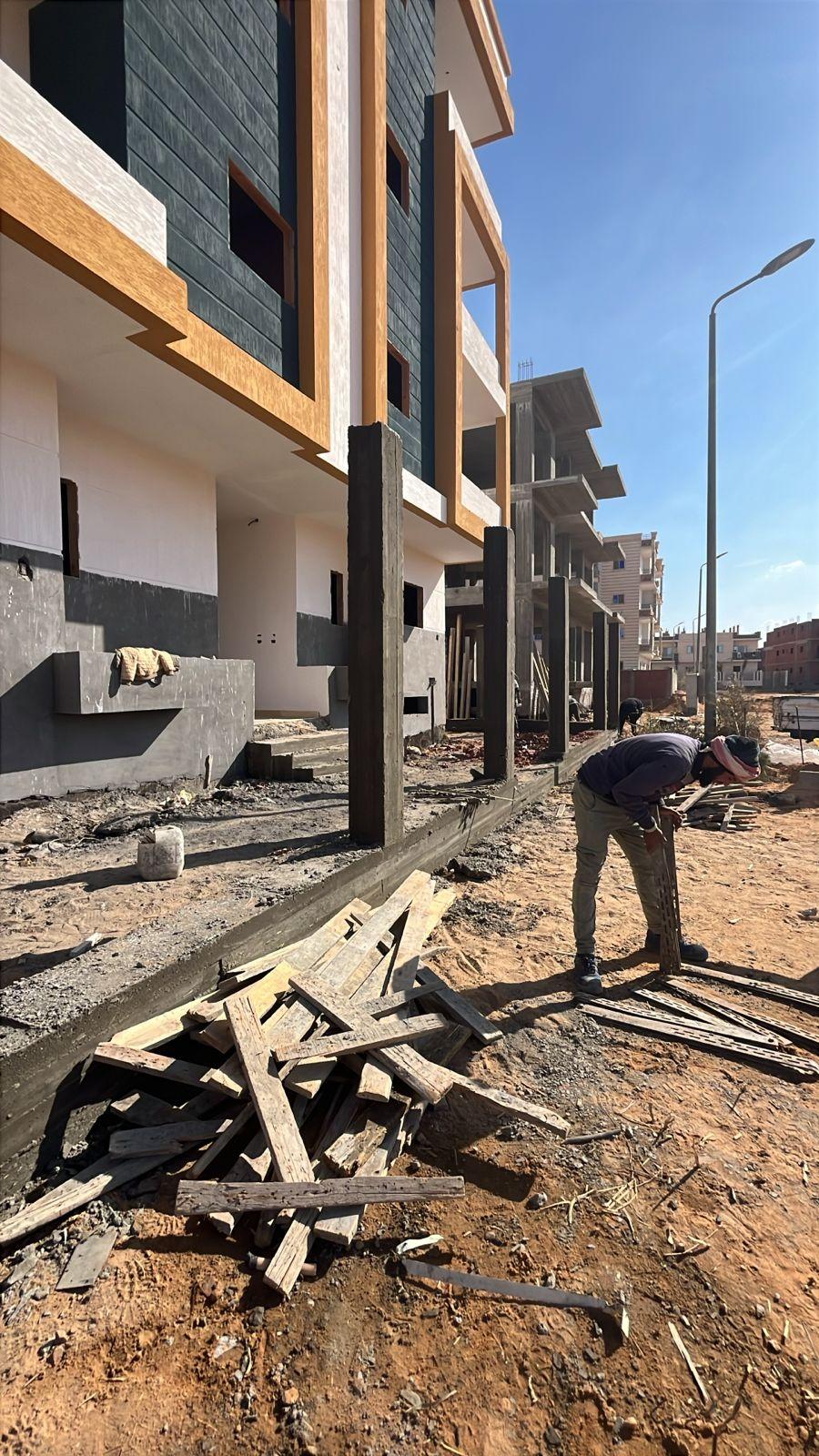

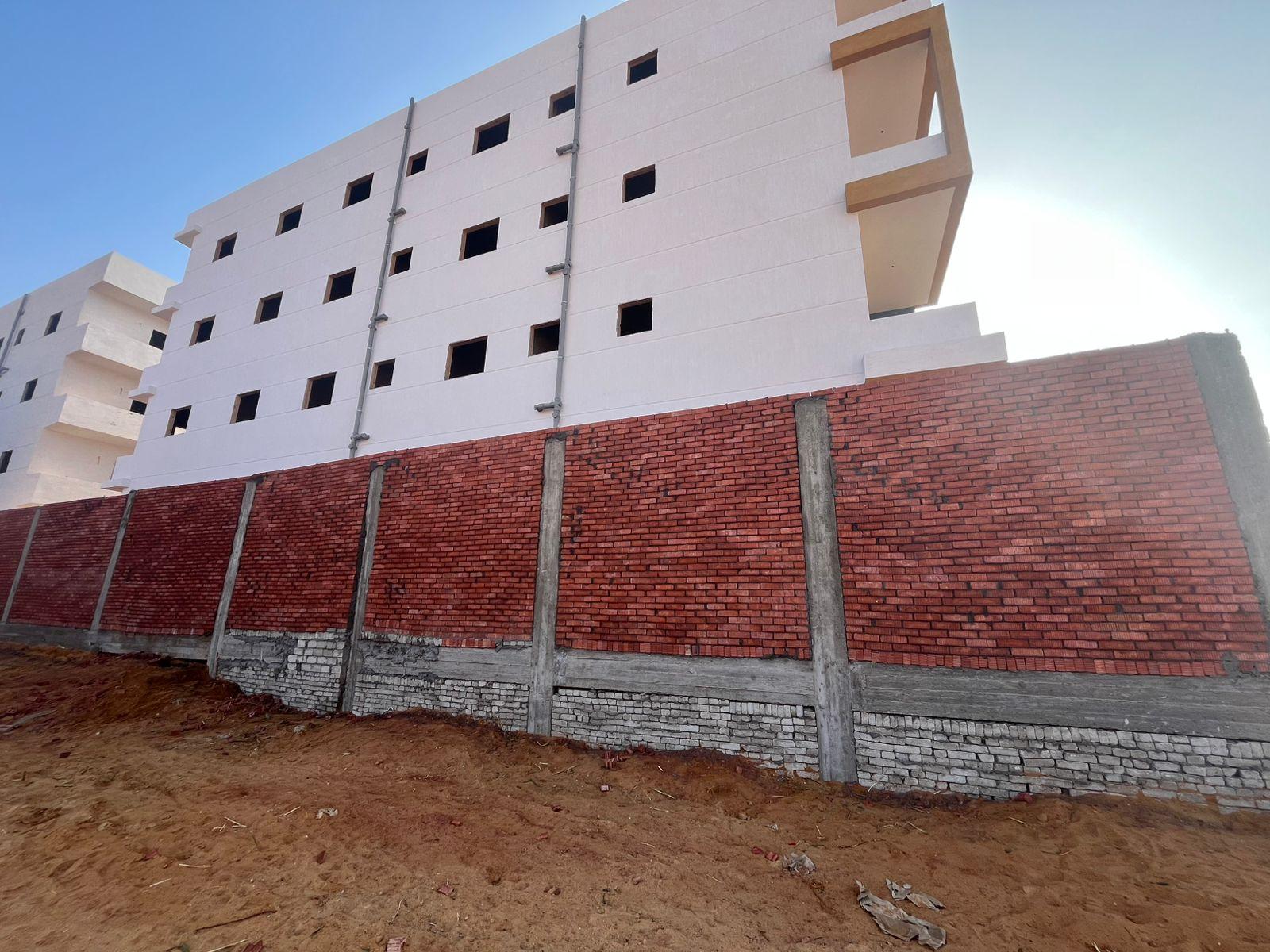

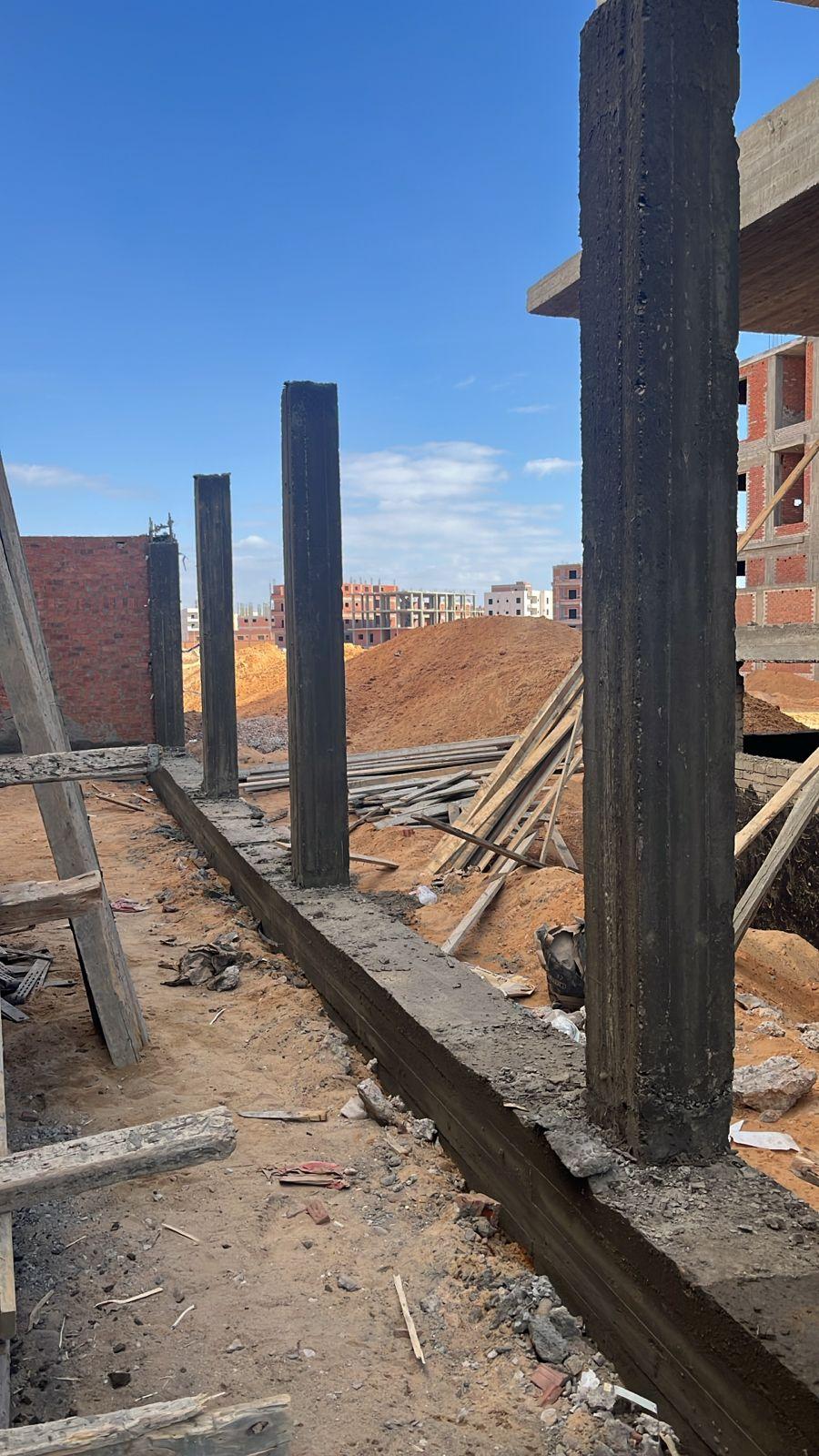

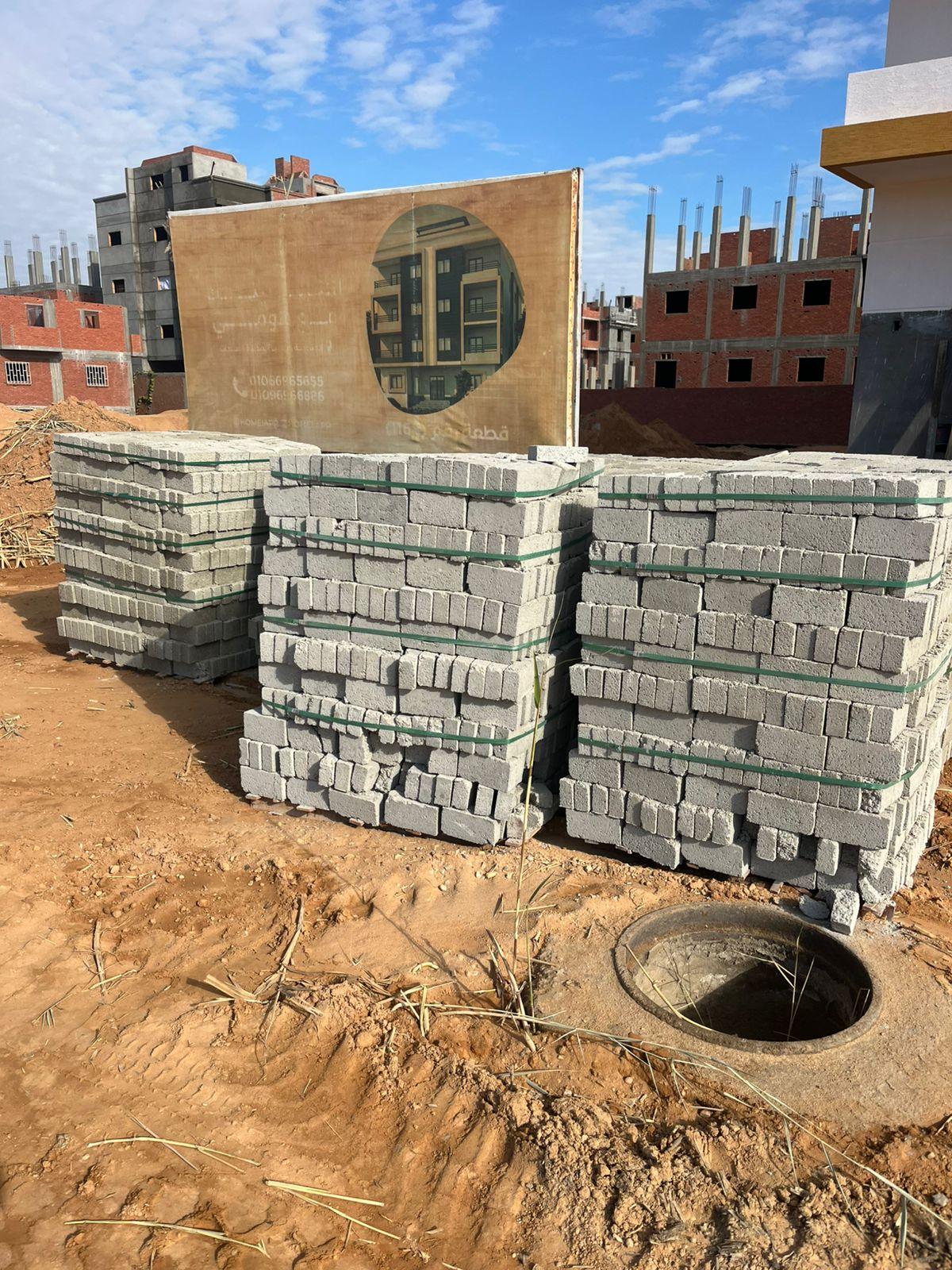

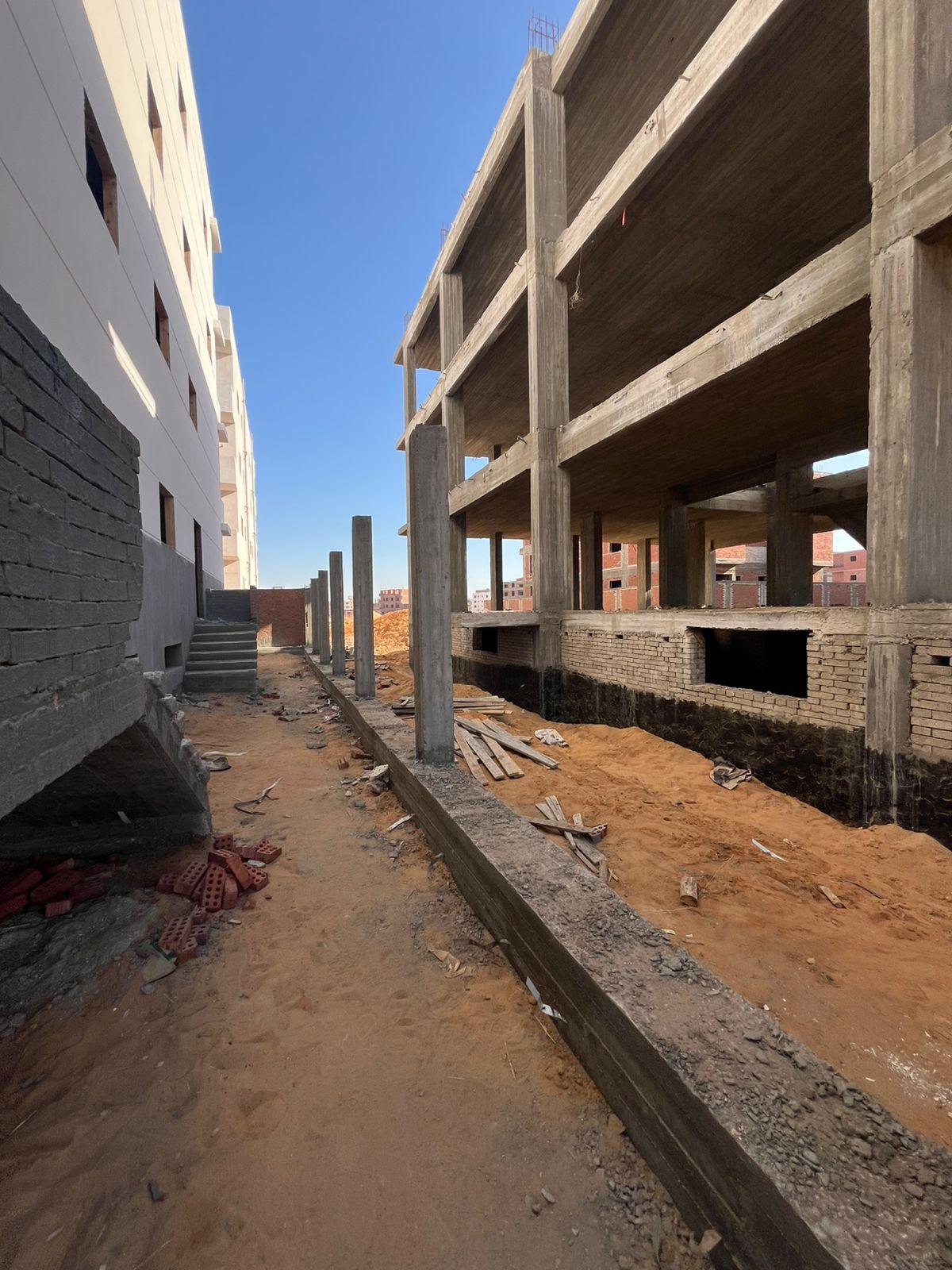

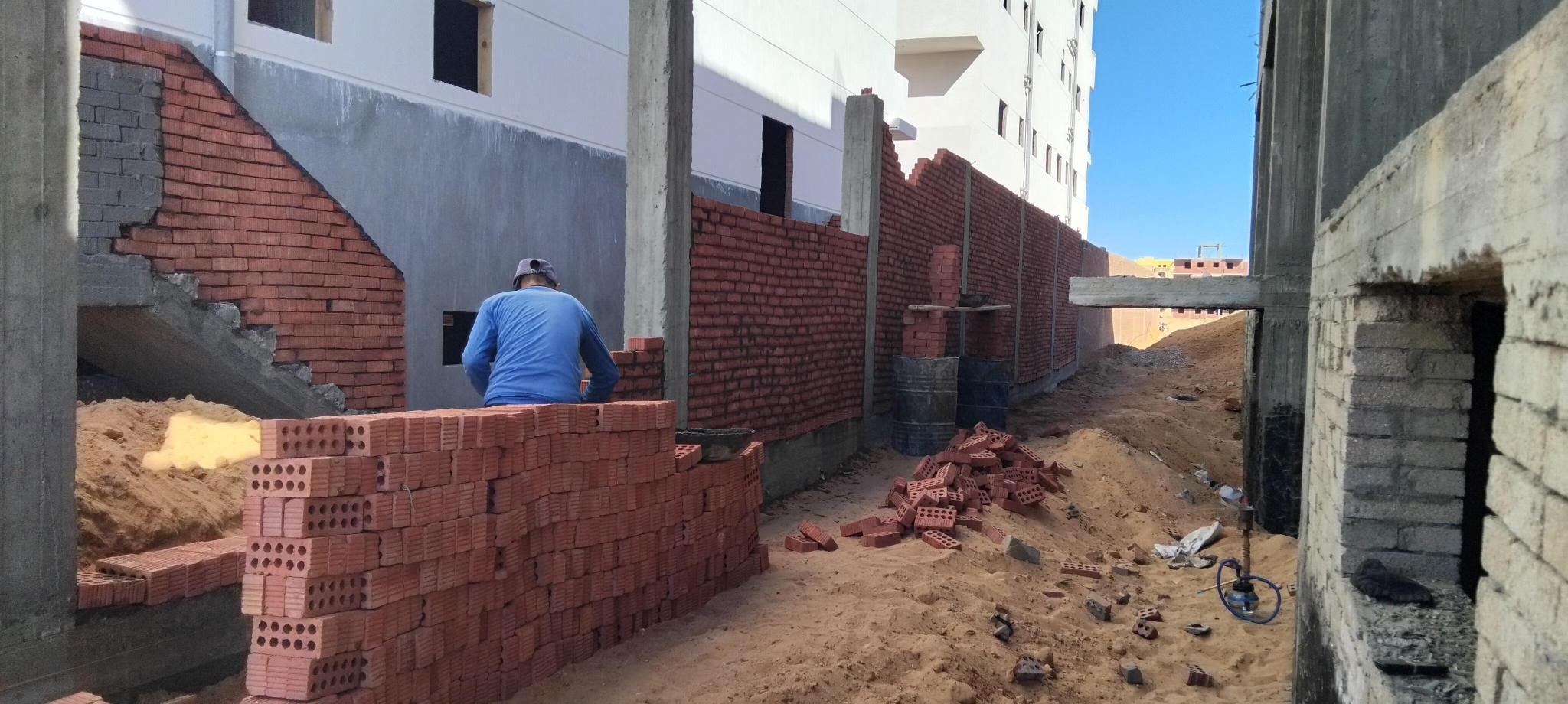

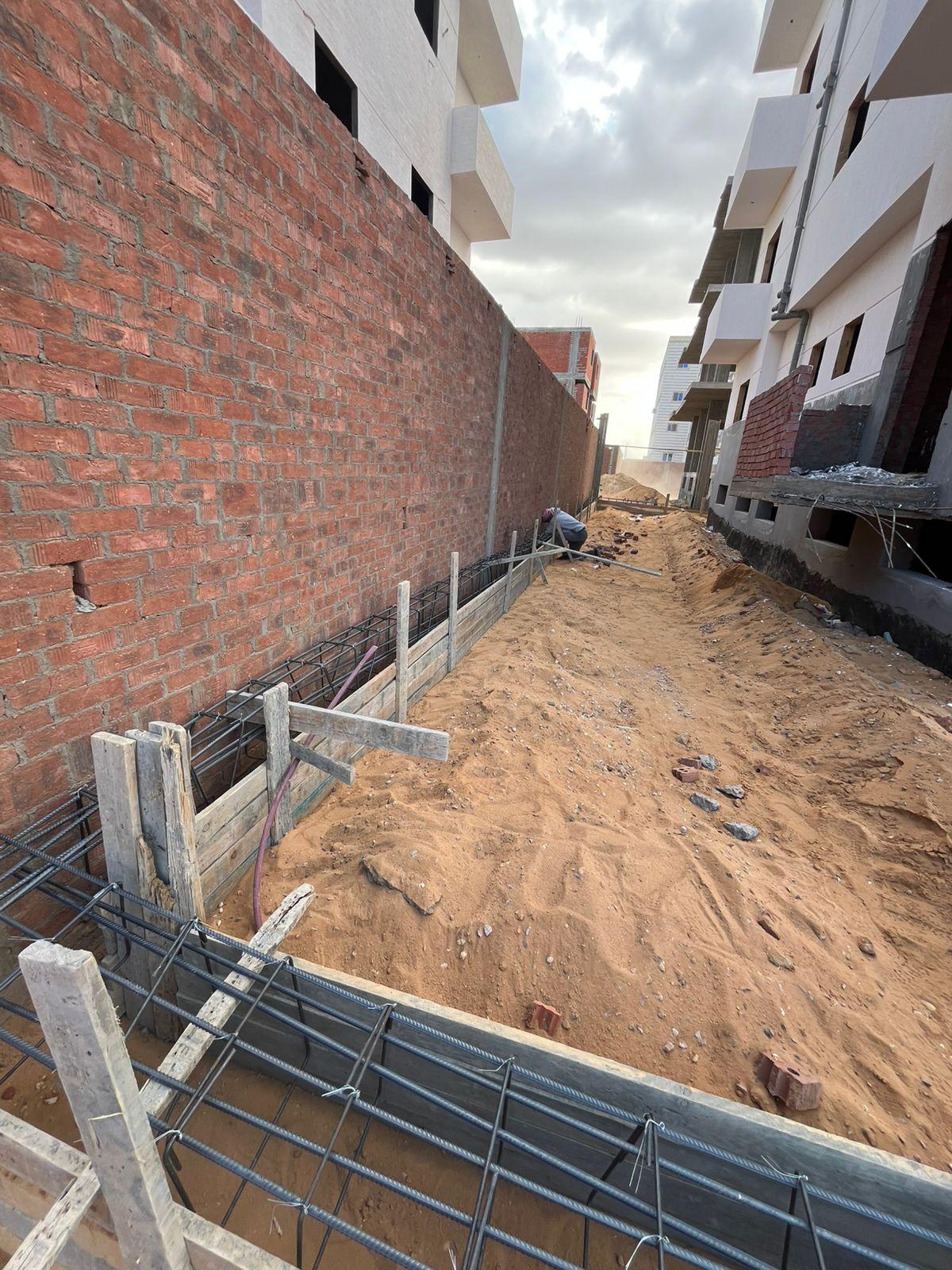

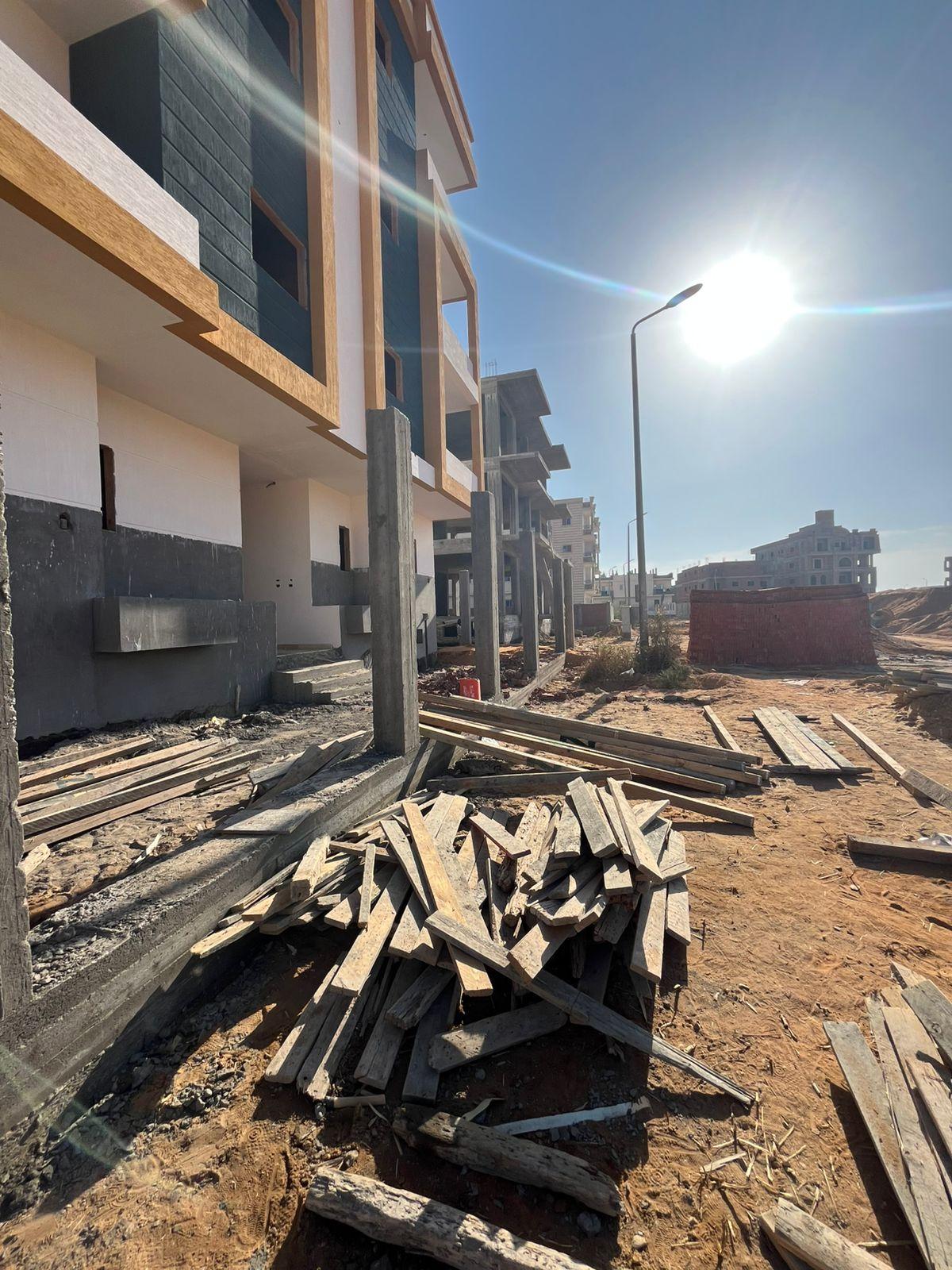

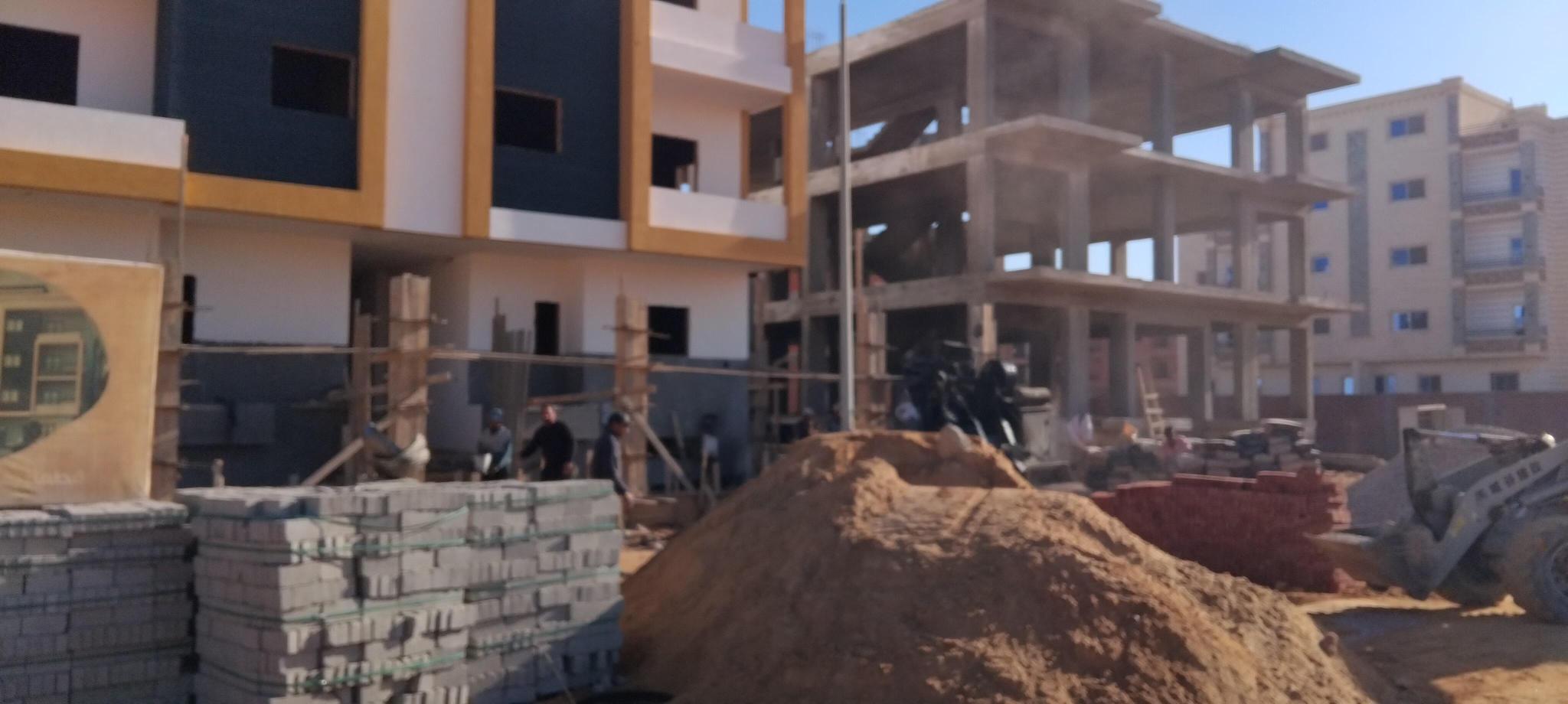

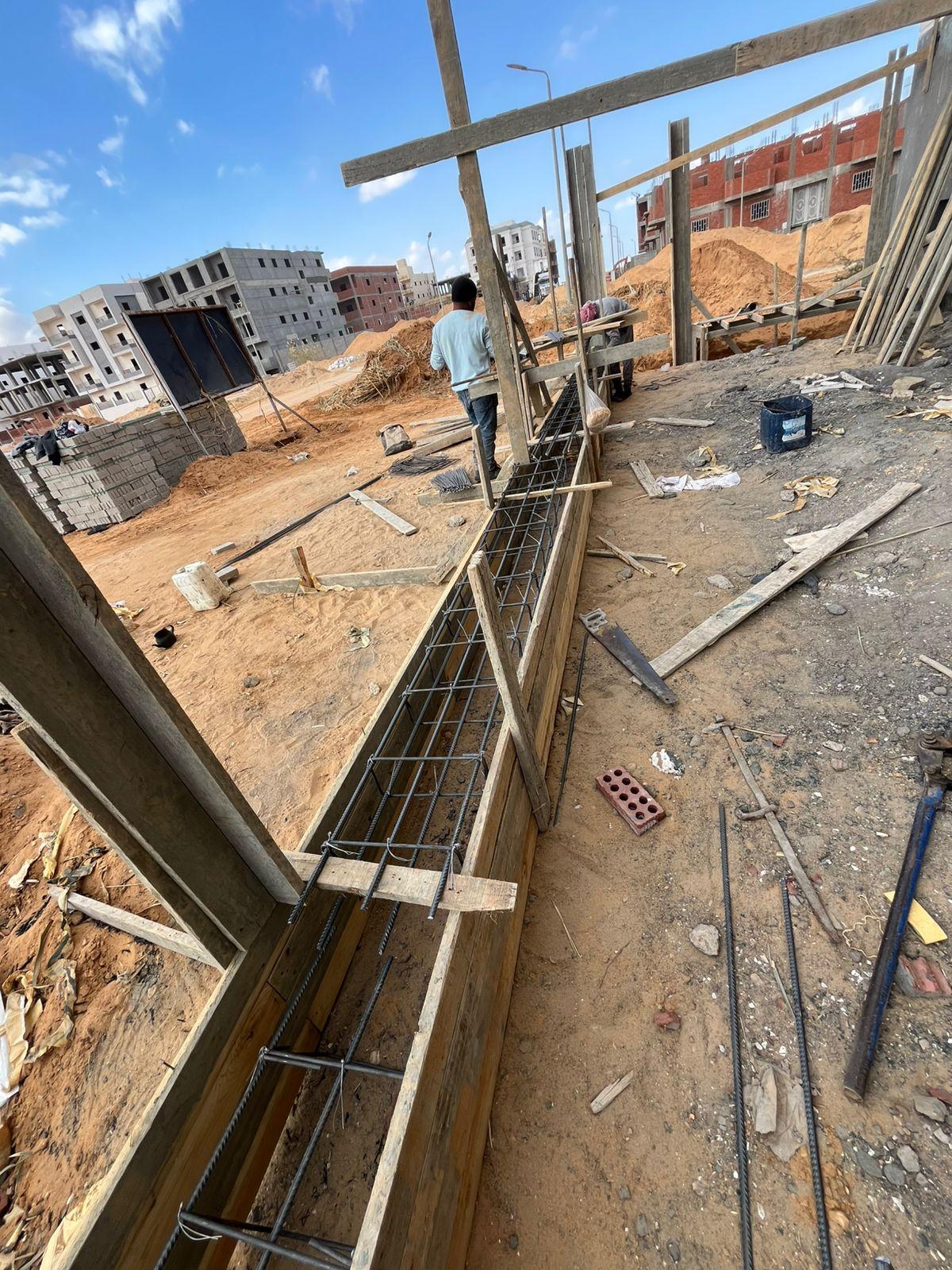

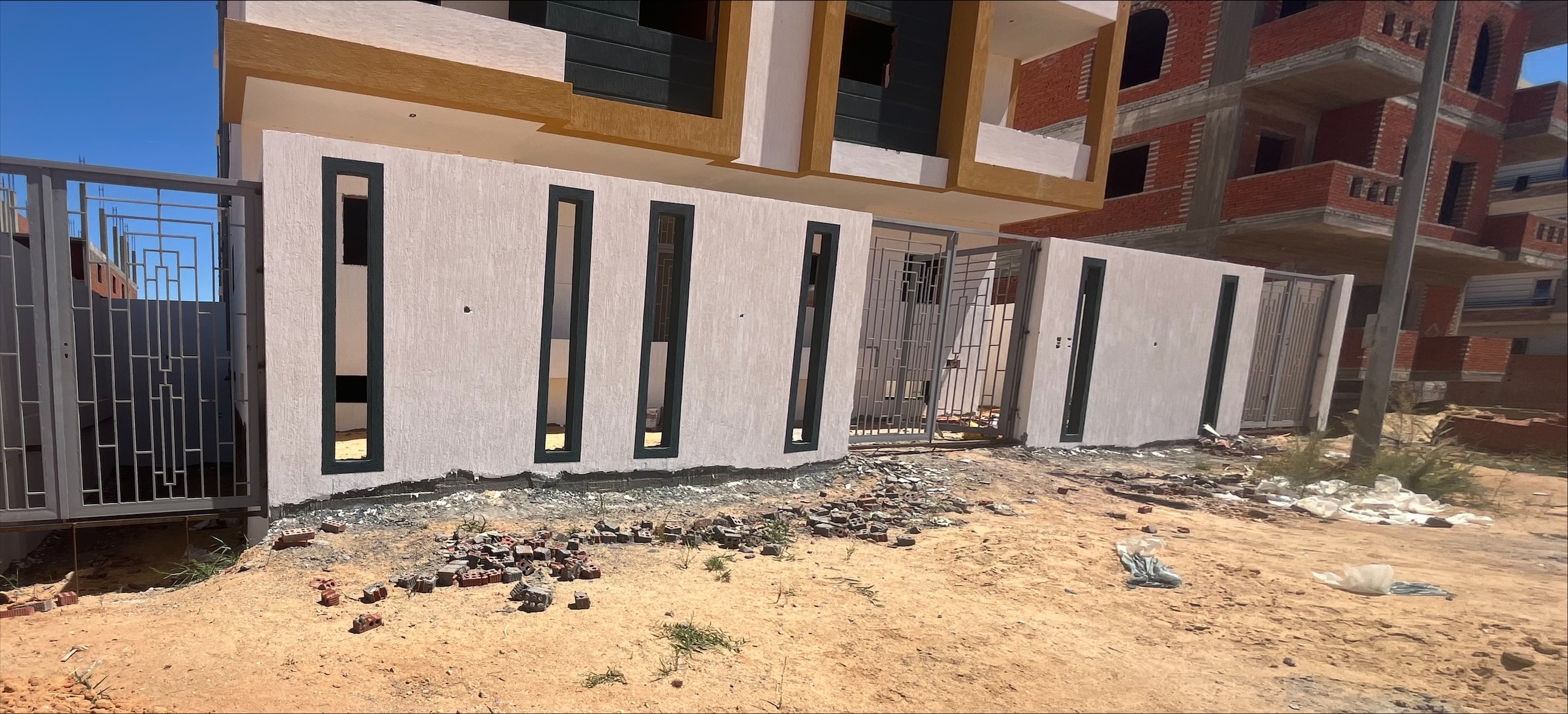

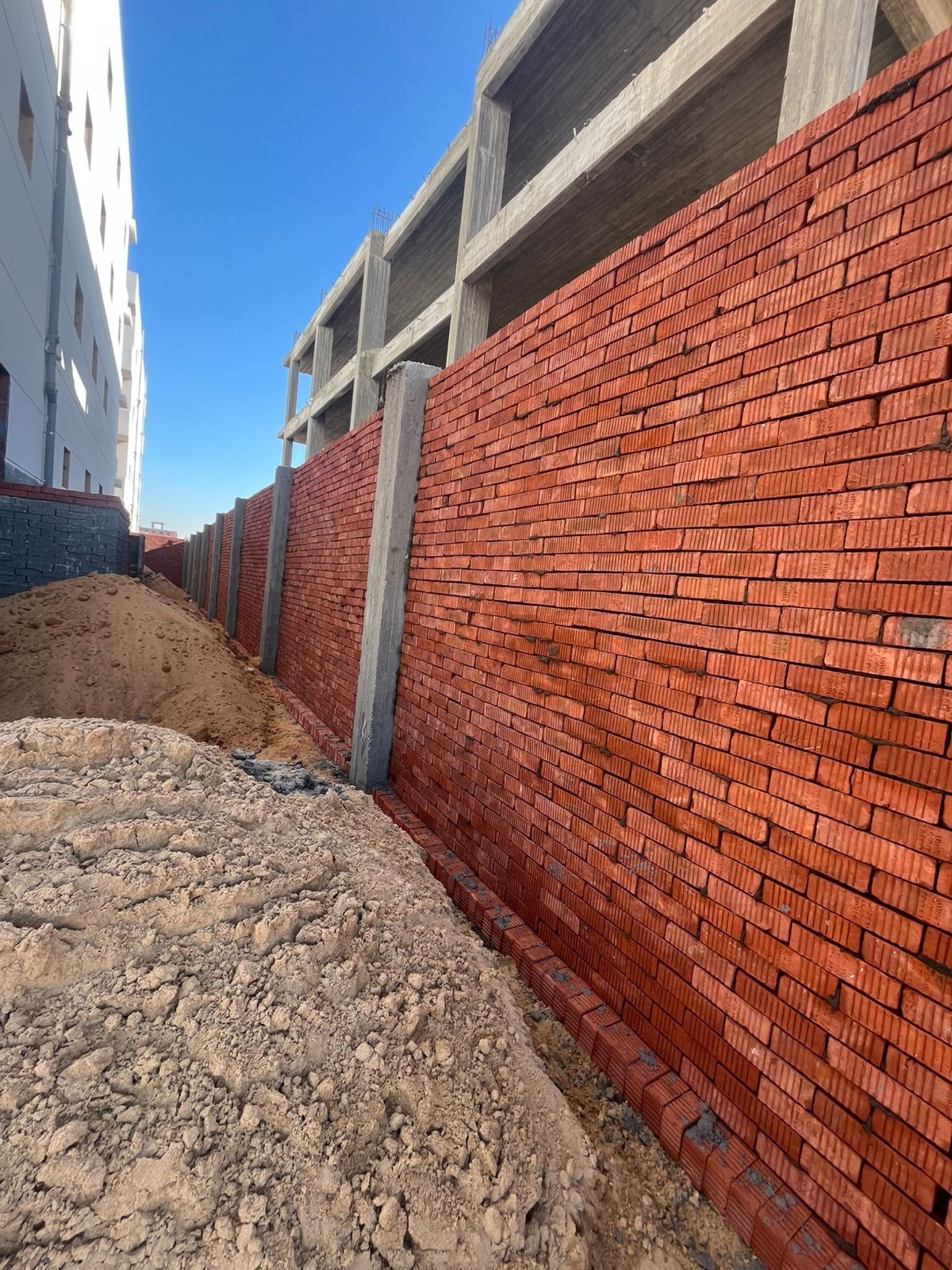

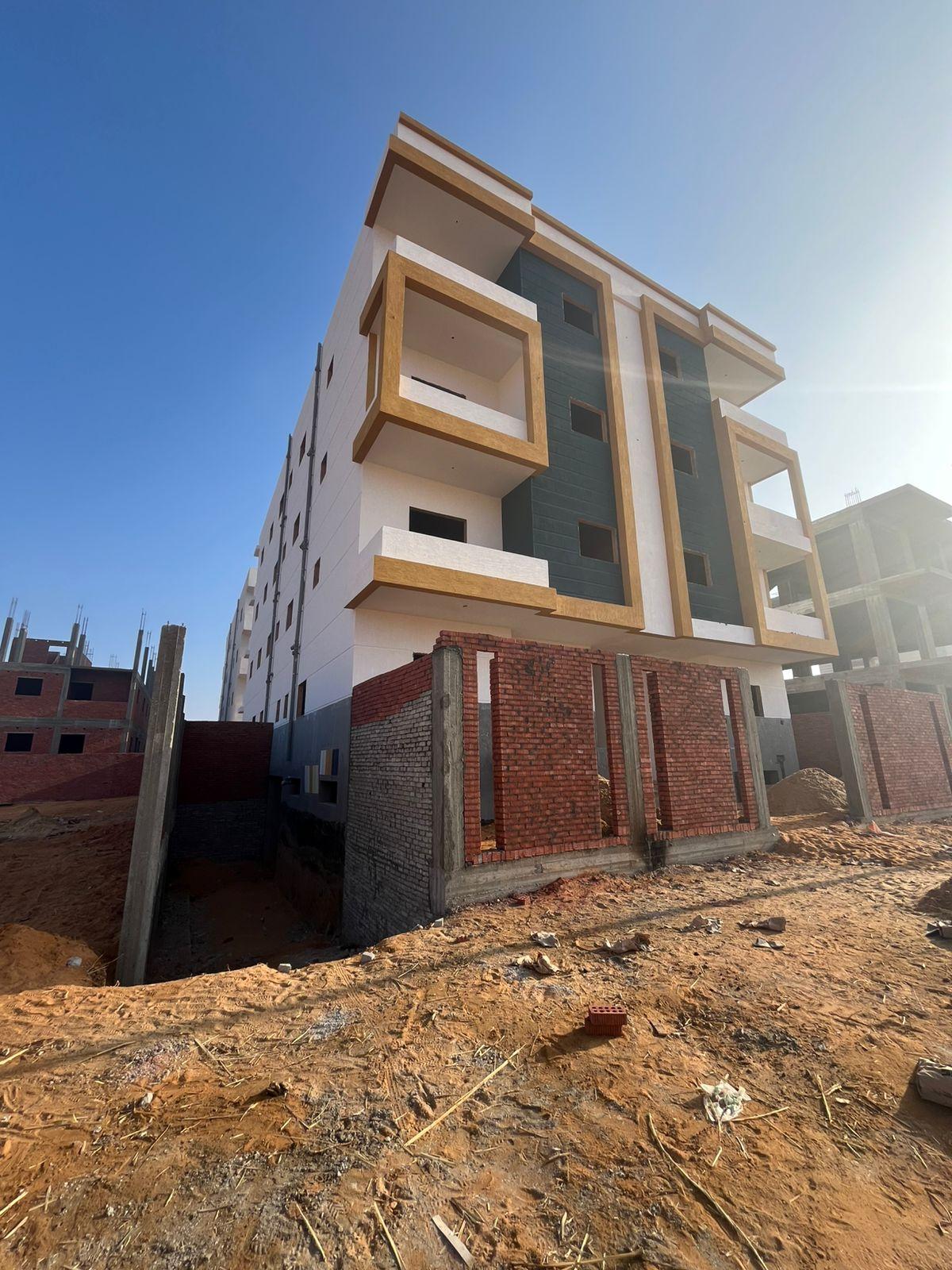

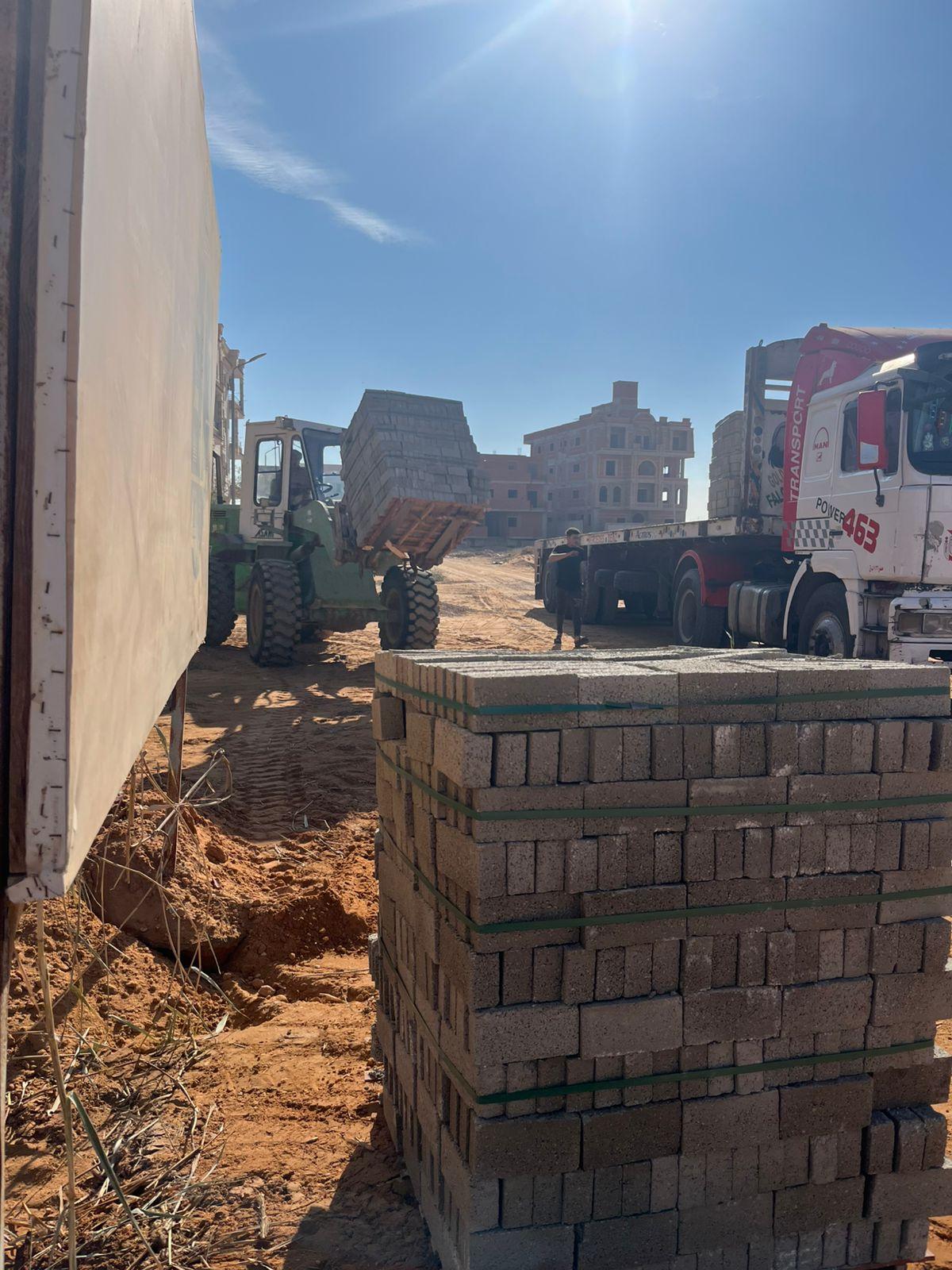

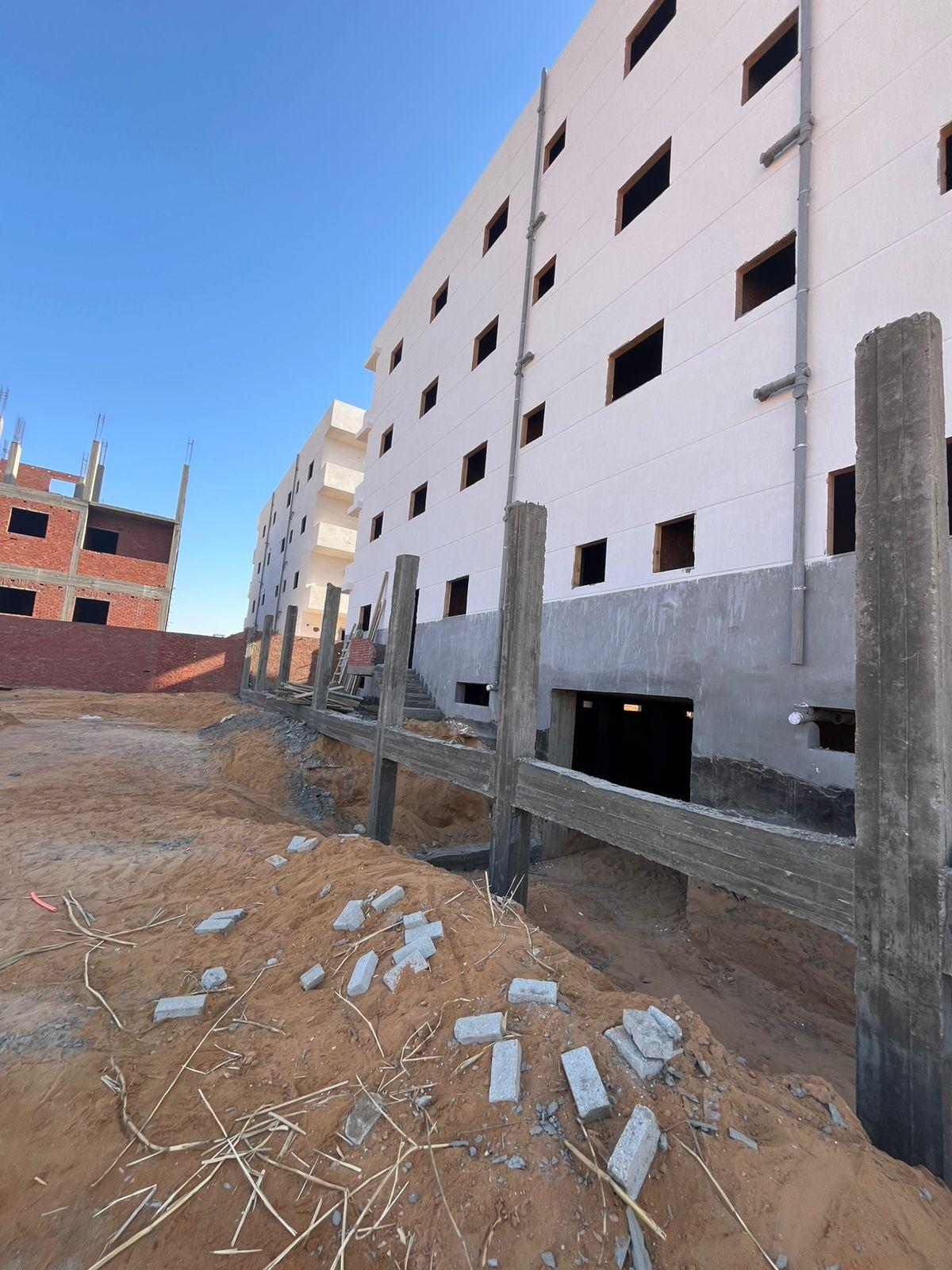

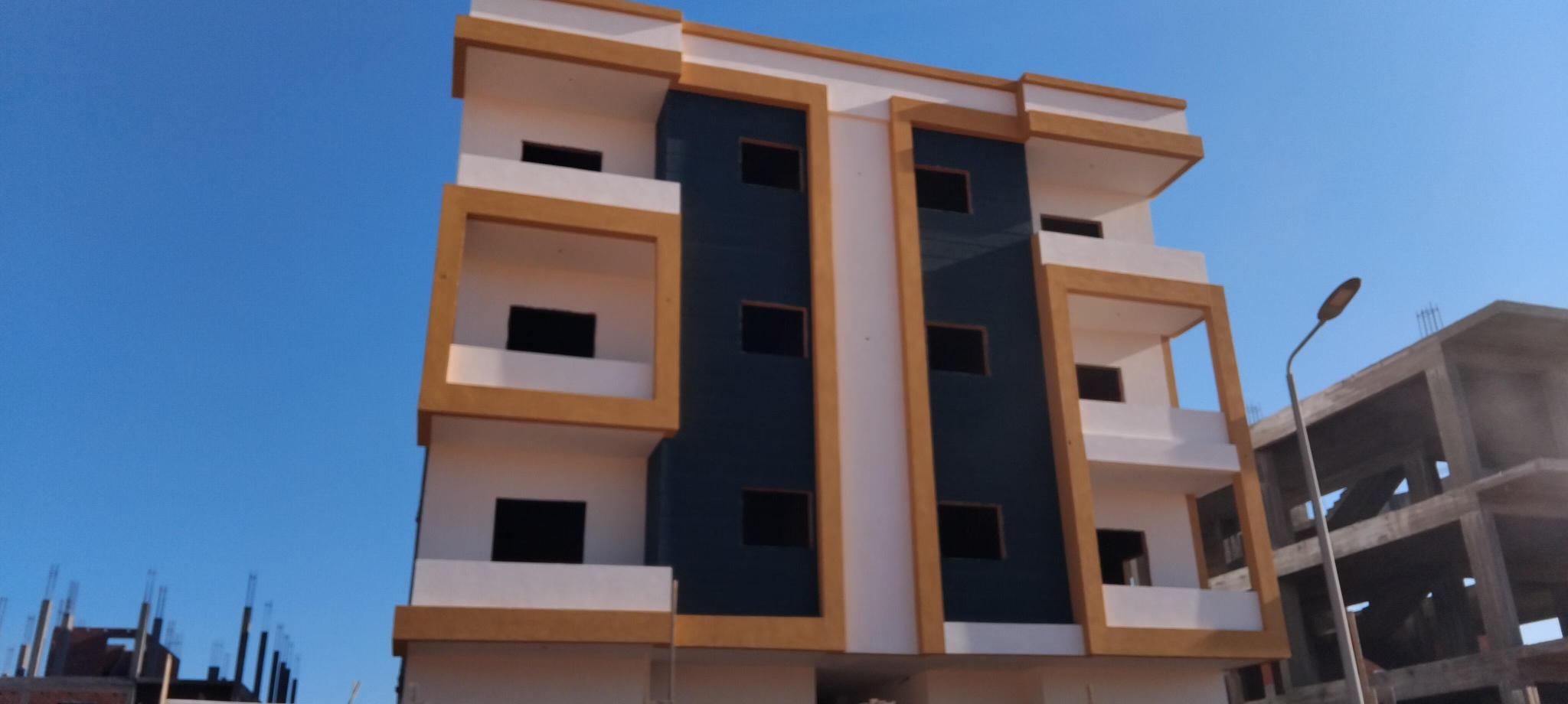

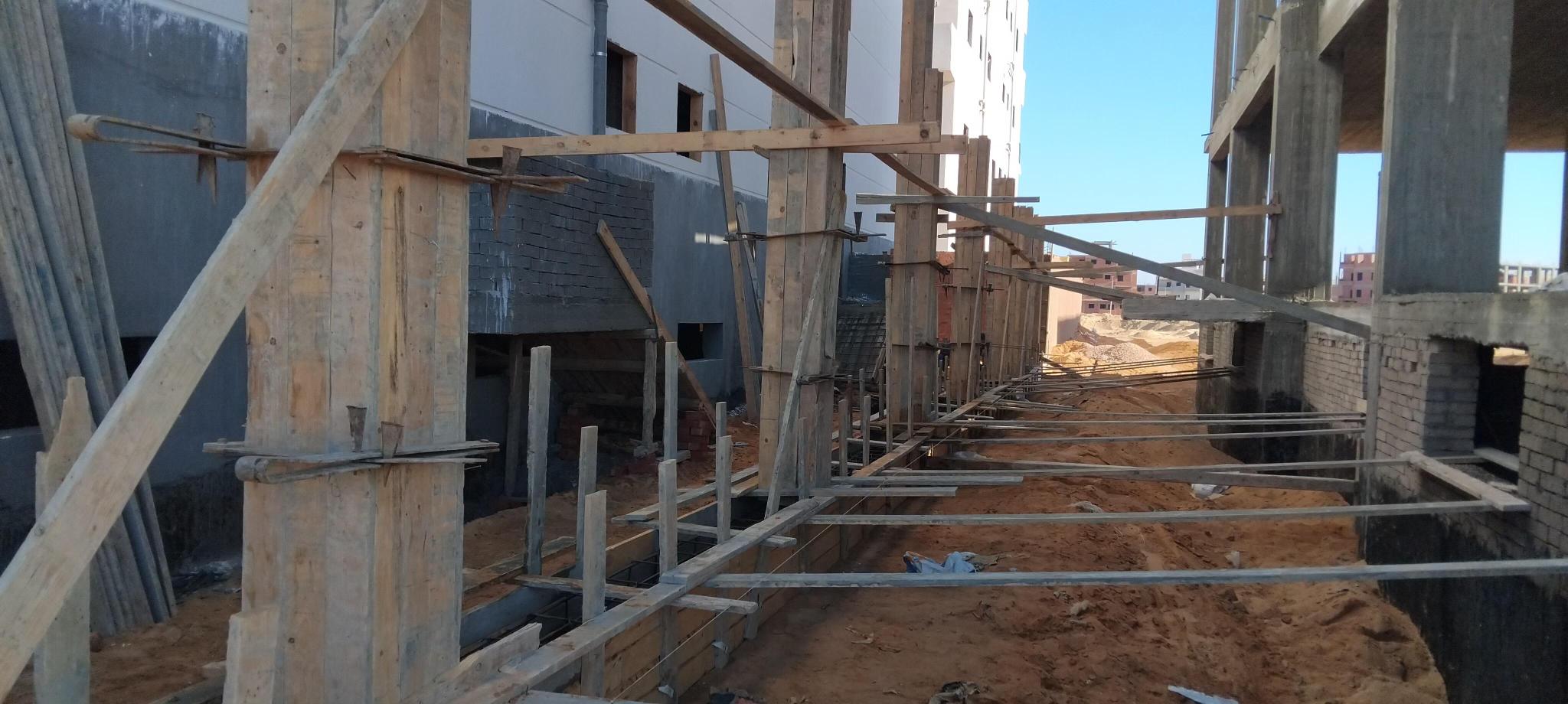

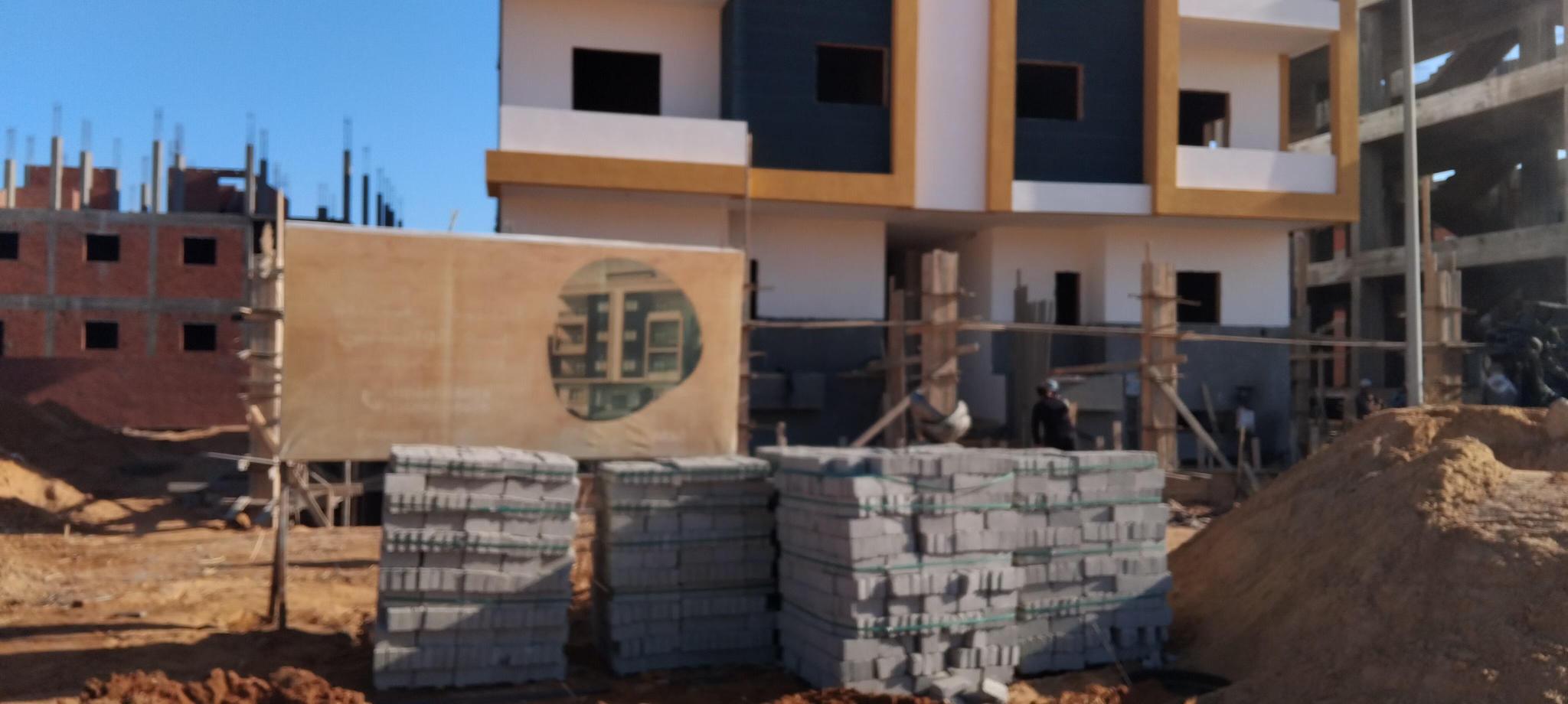

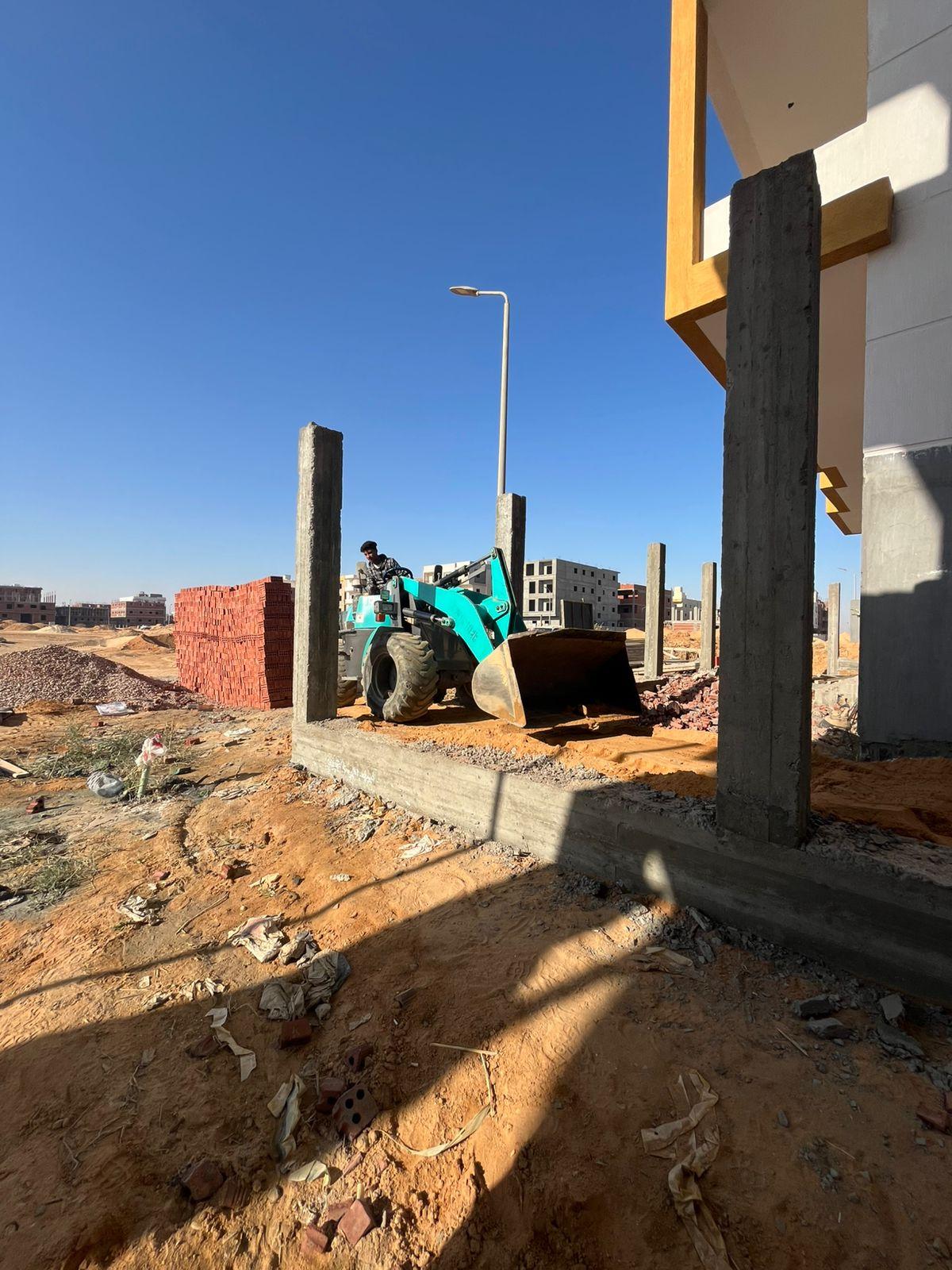

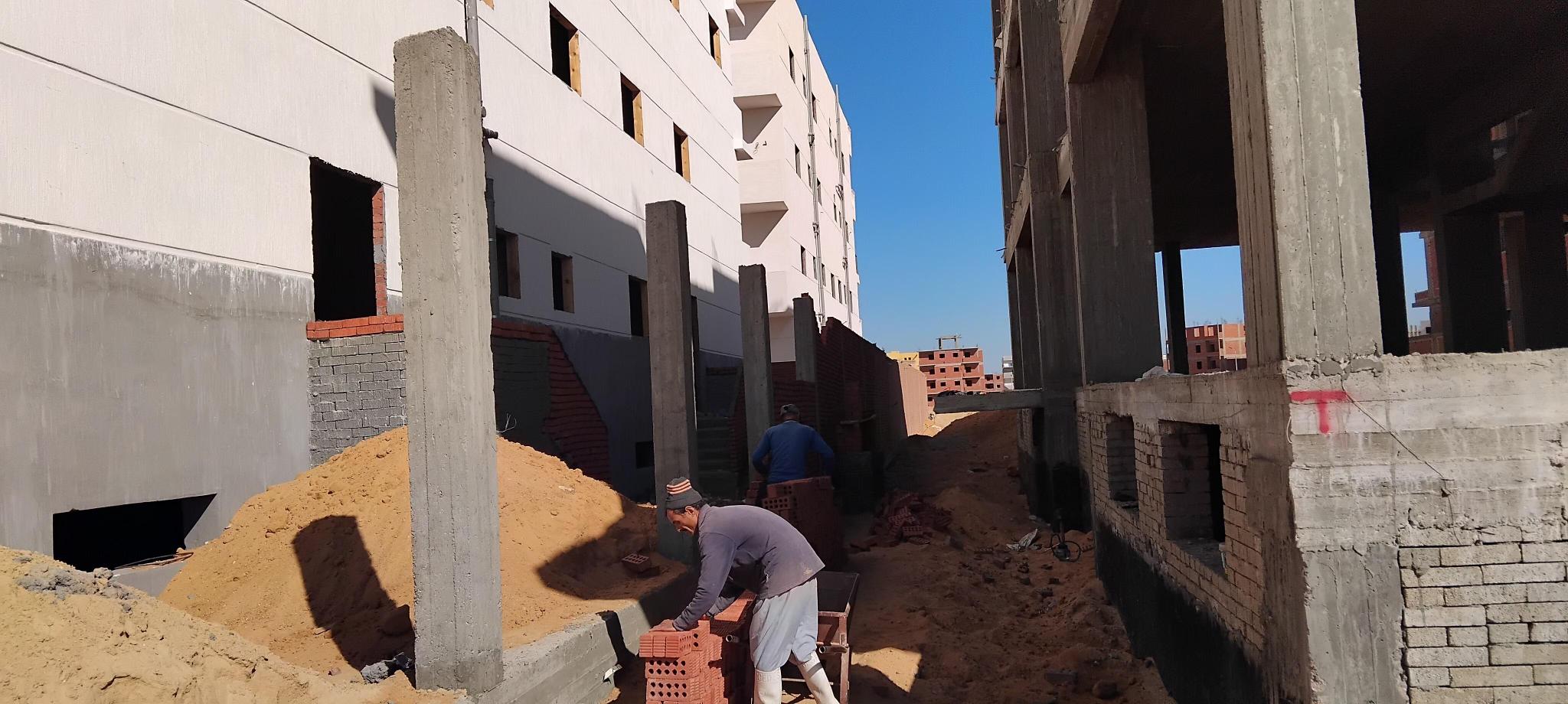

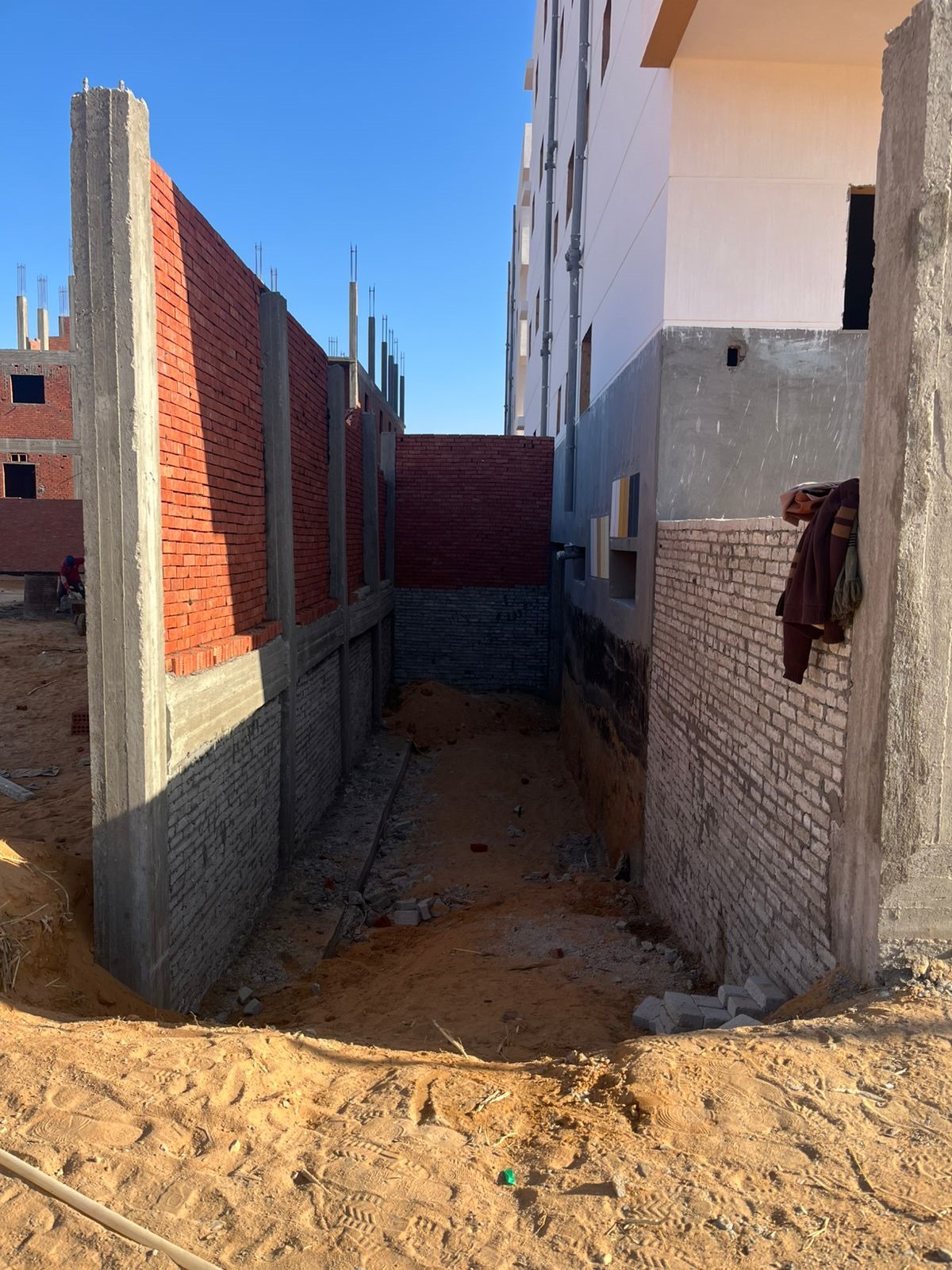

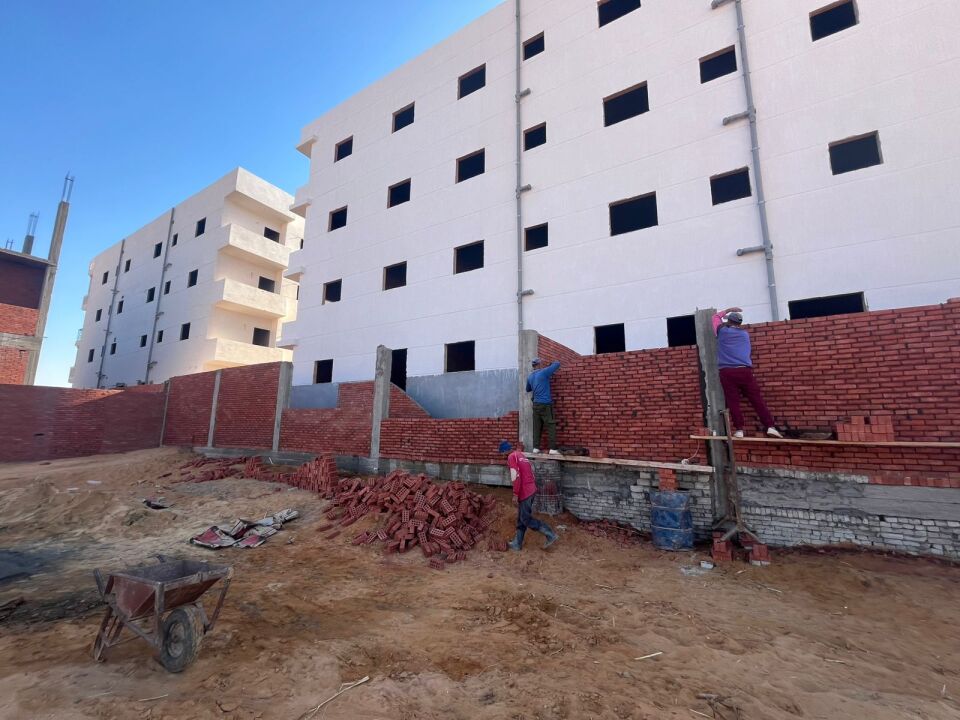

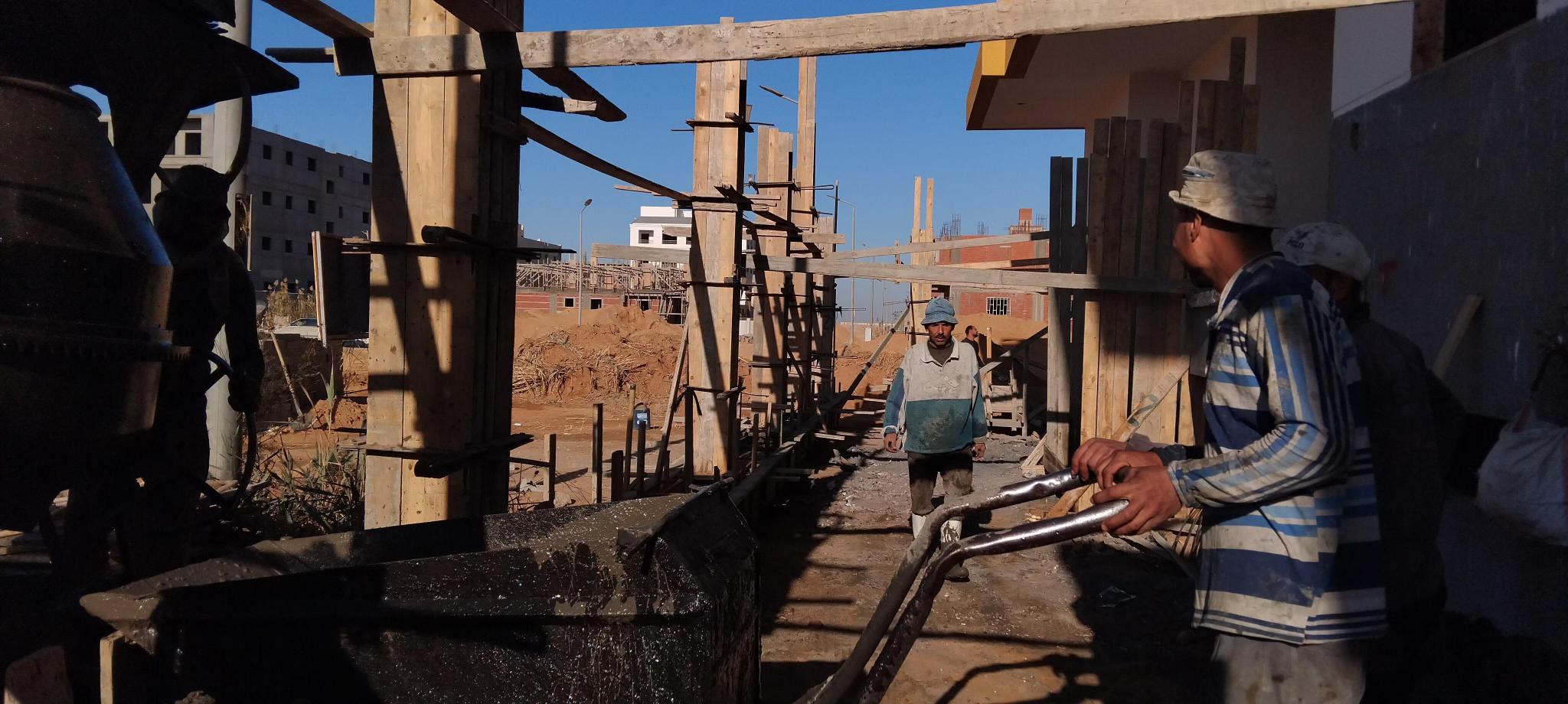

Wall Building works
November 15, 2025

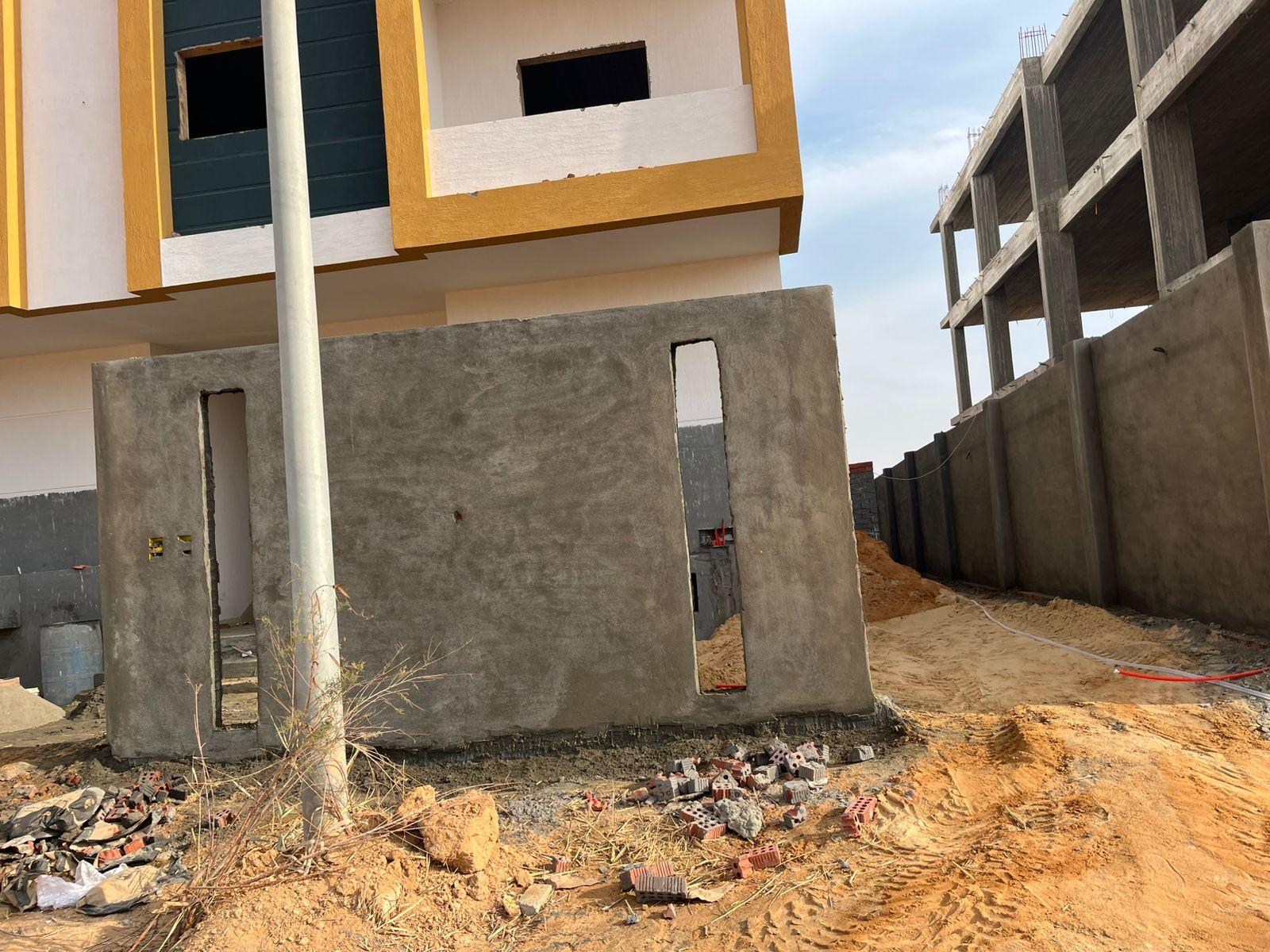

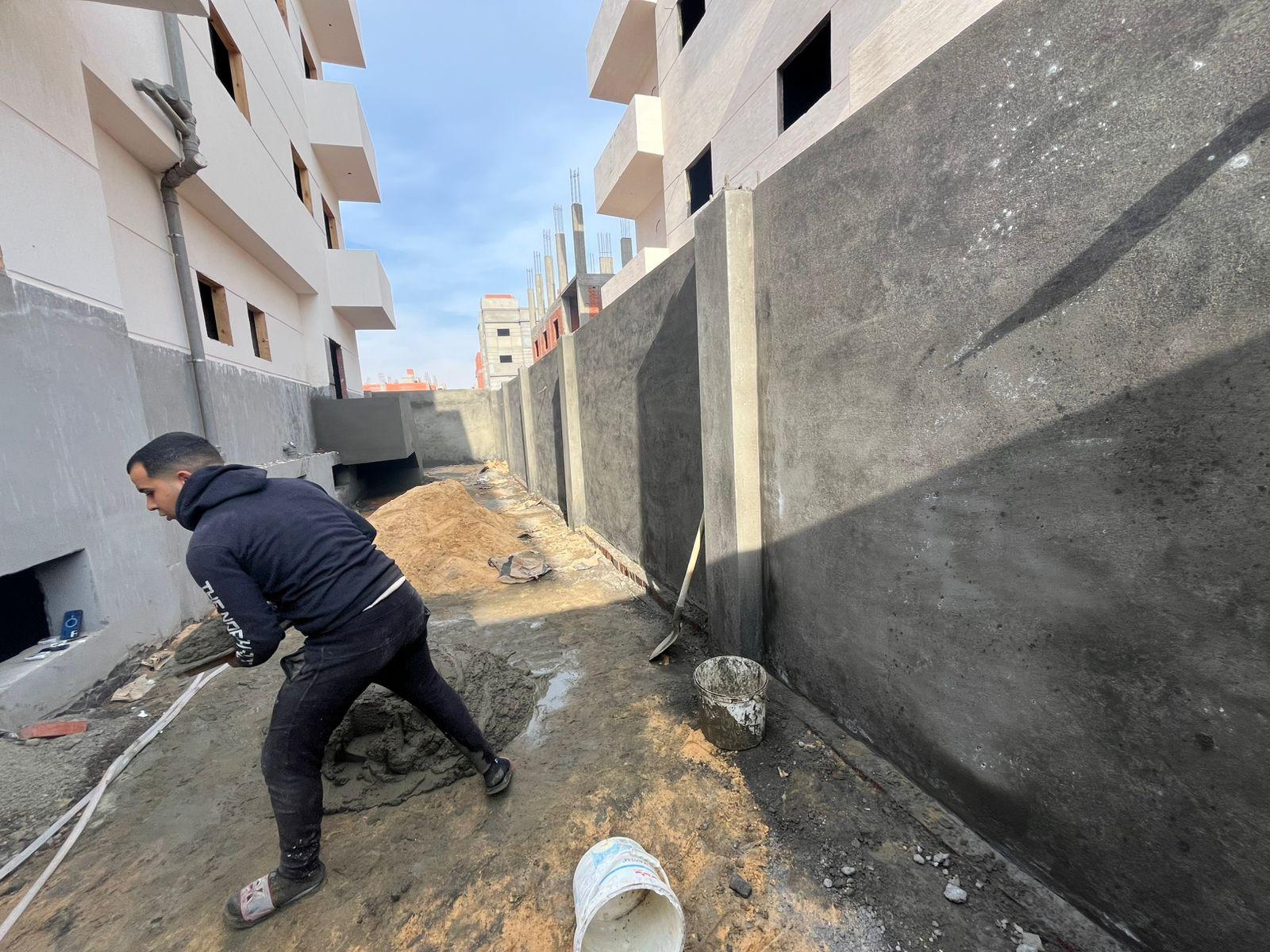

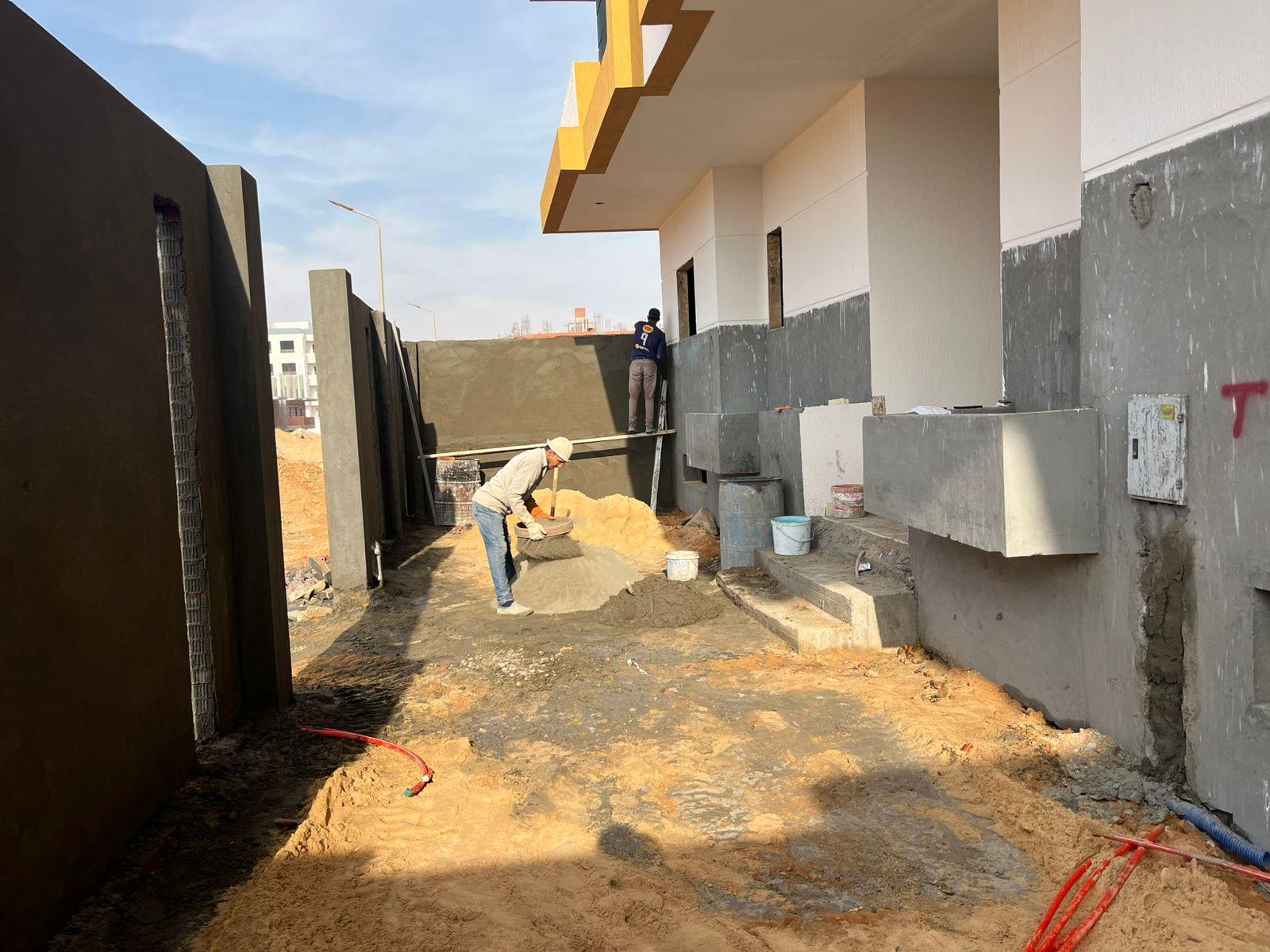

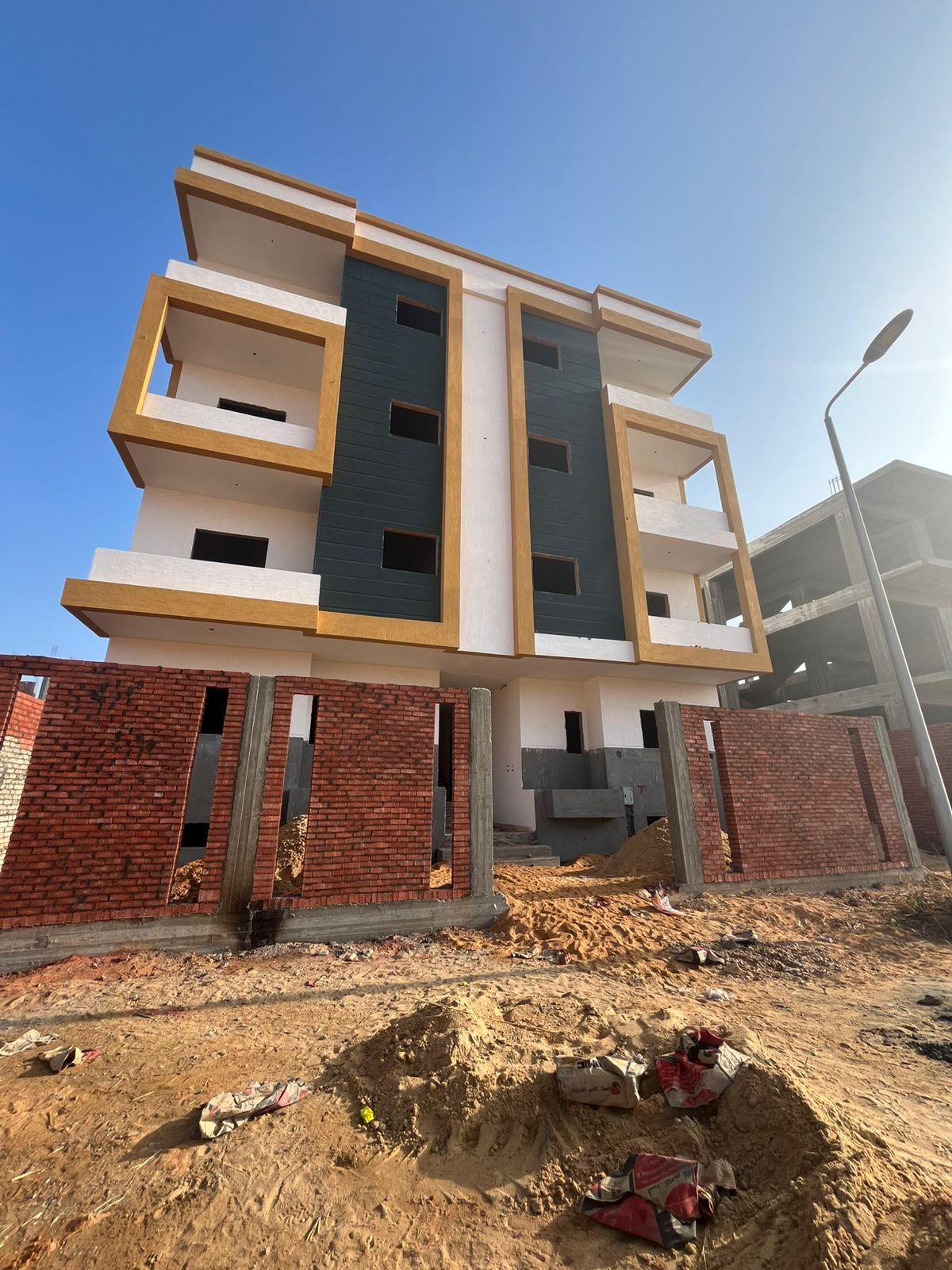

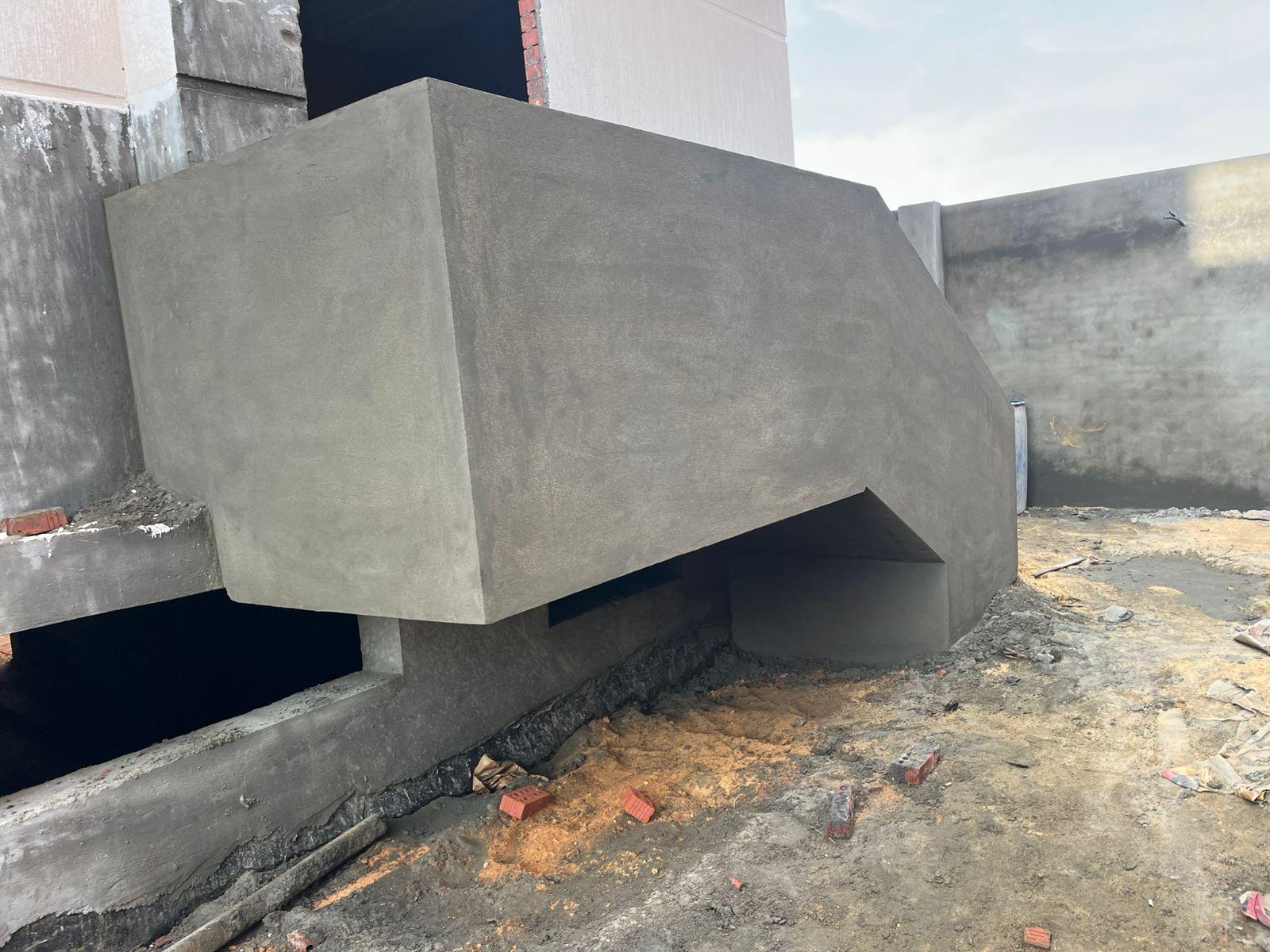

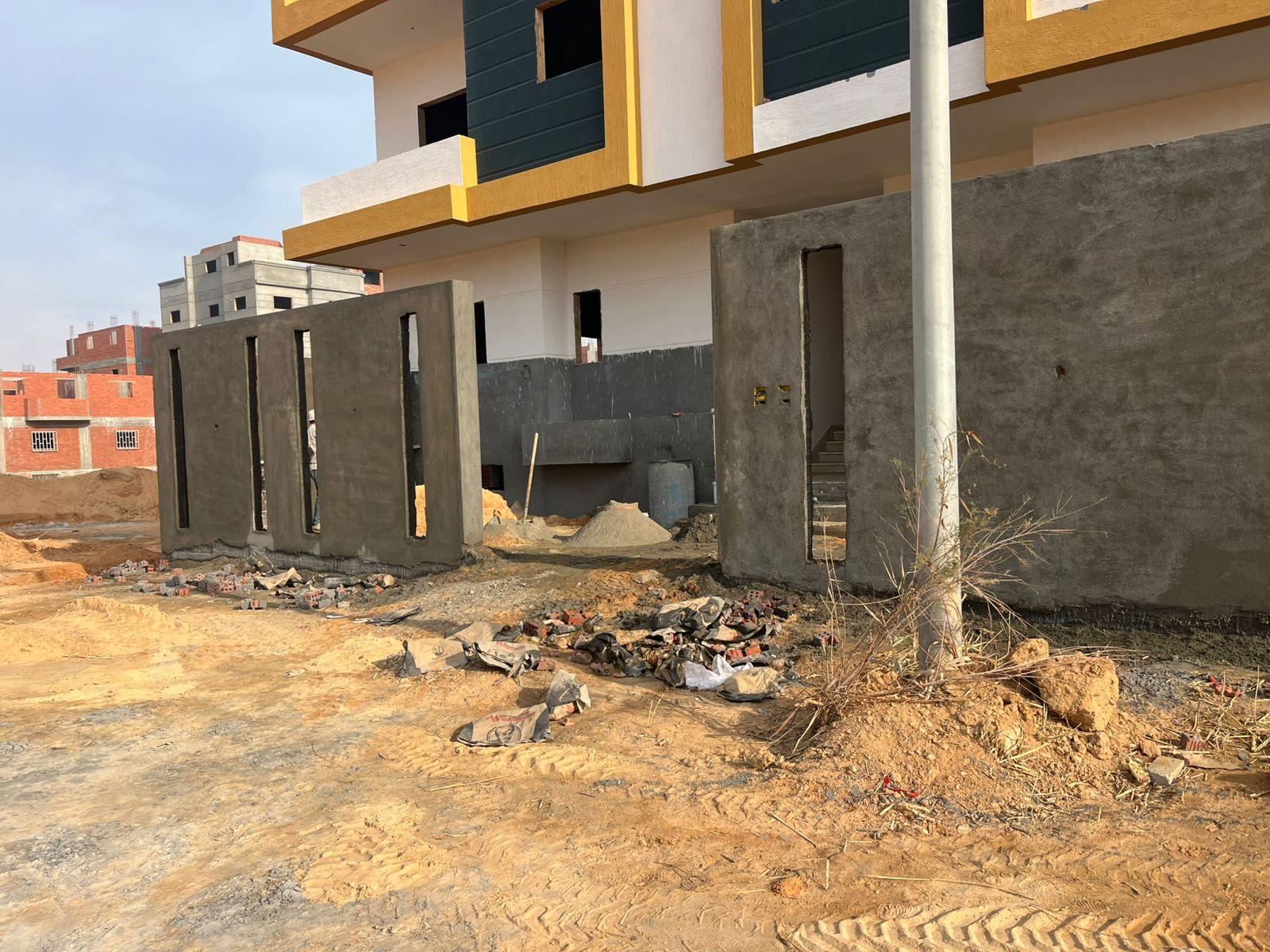

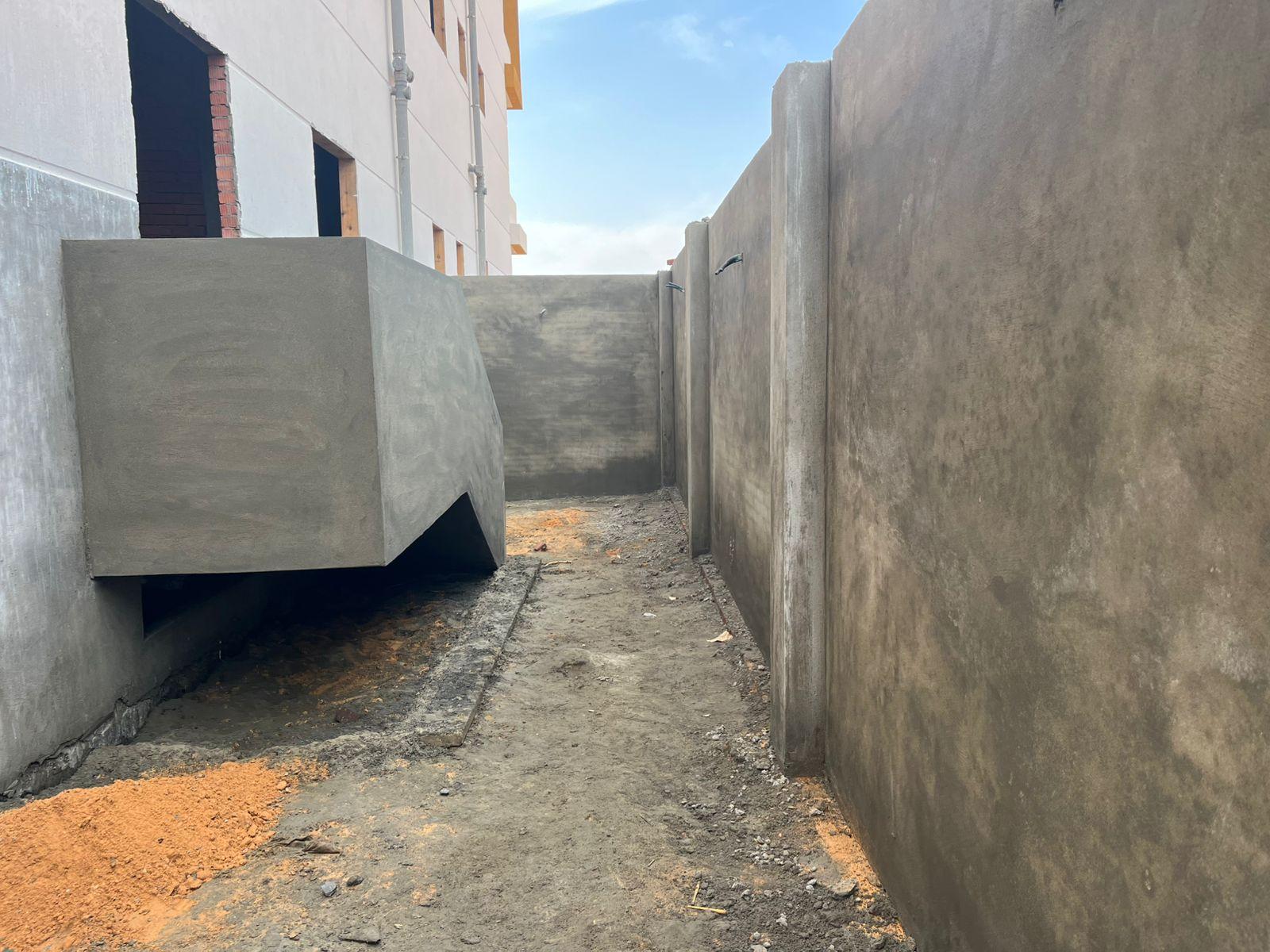

Concrete works for the external wall
November 1, 2025

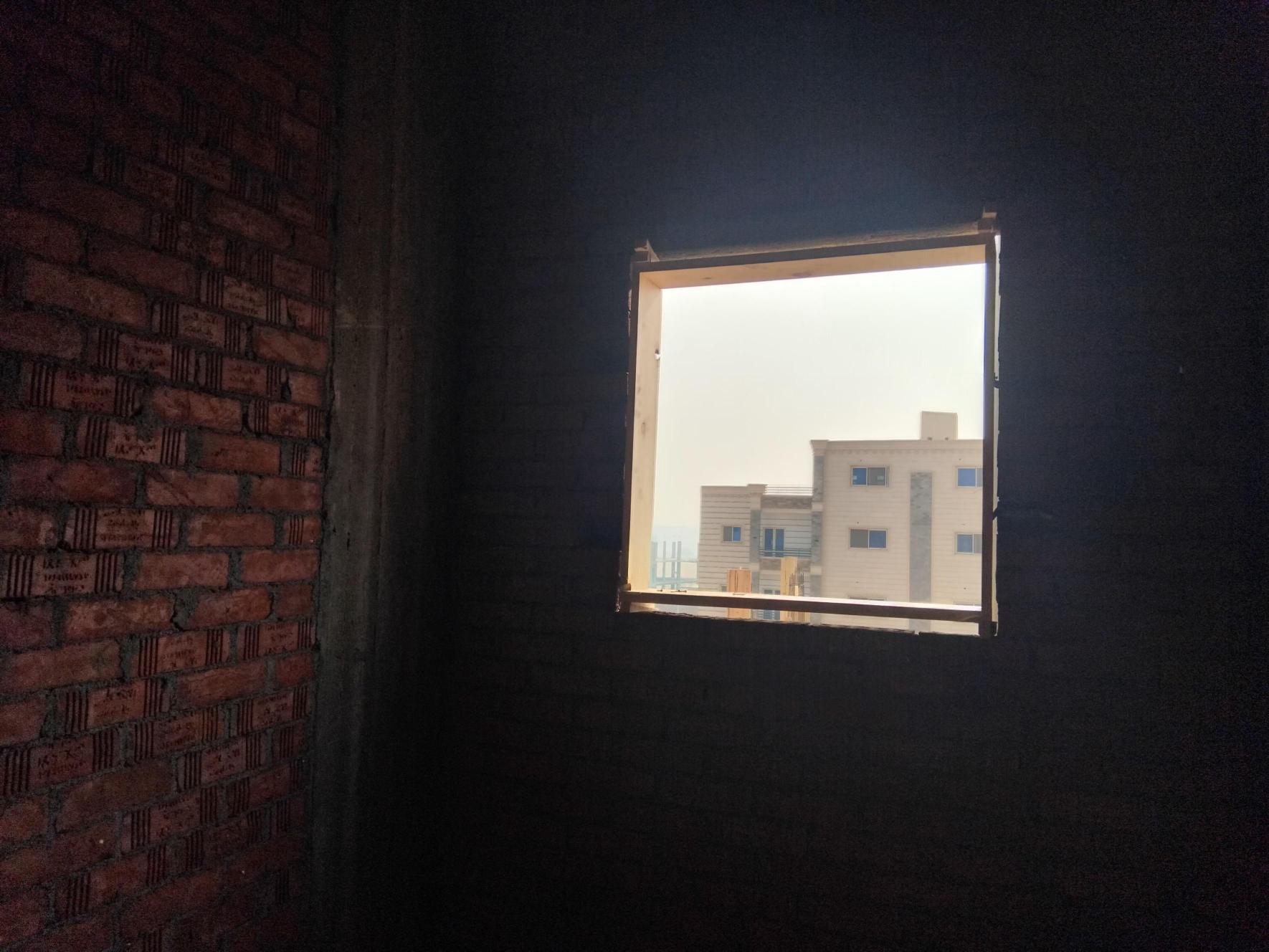

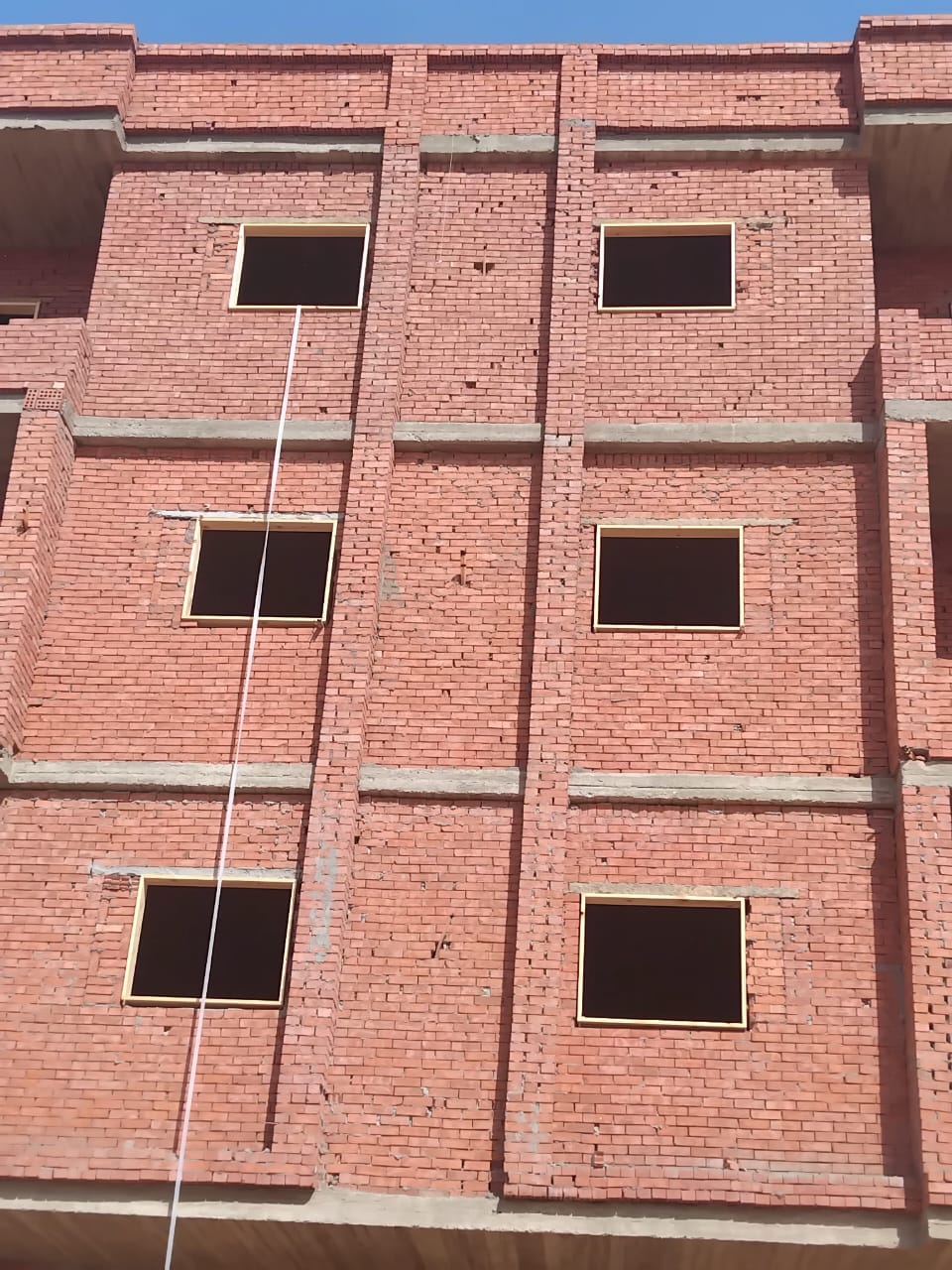

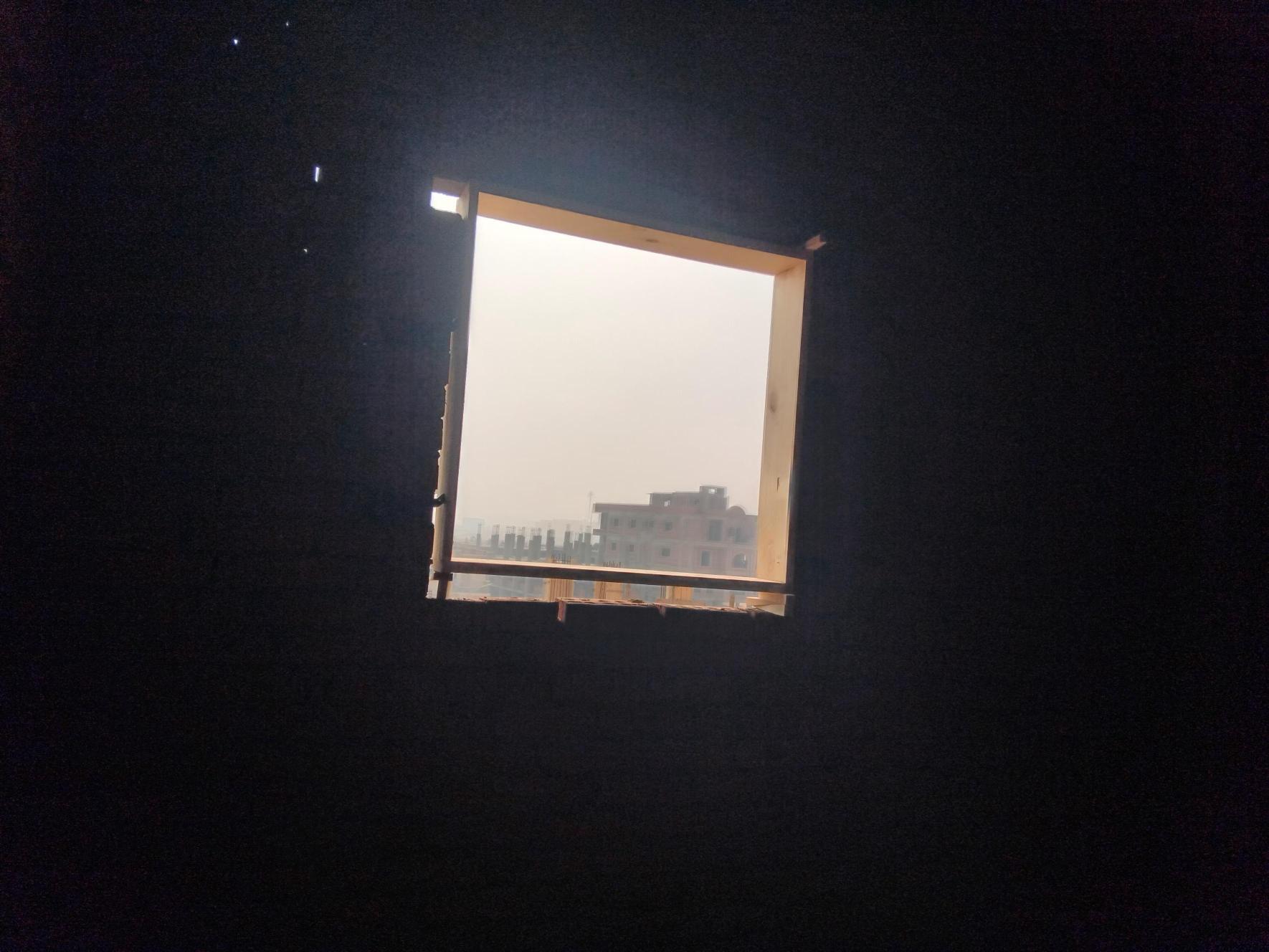

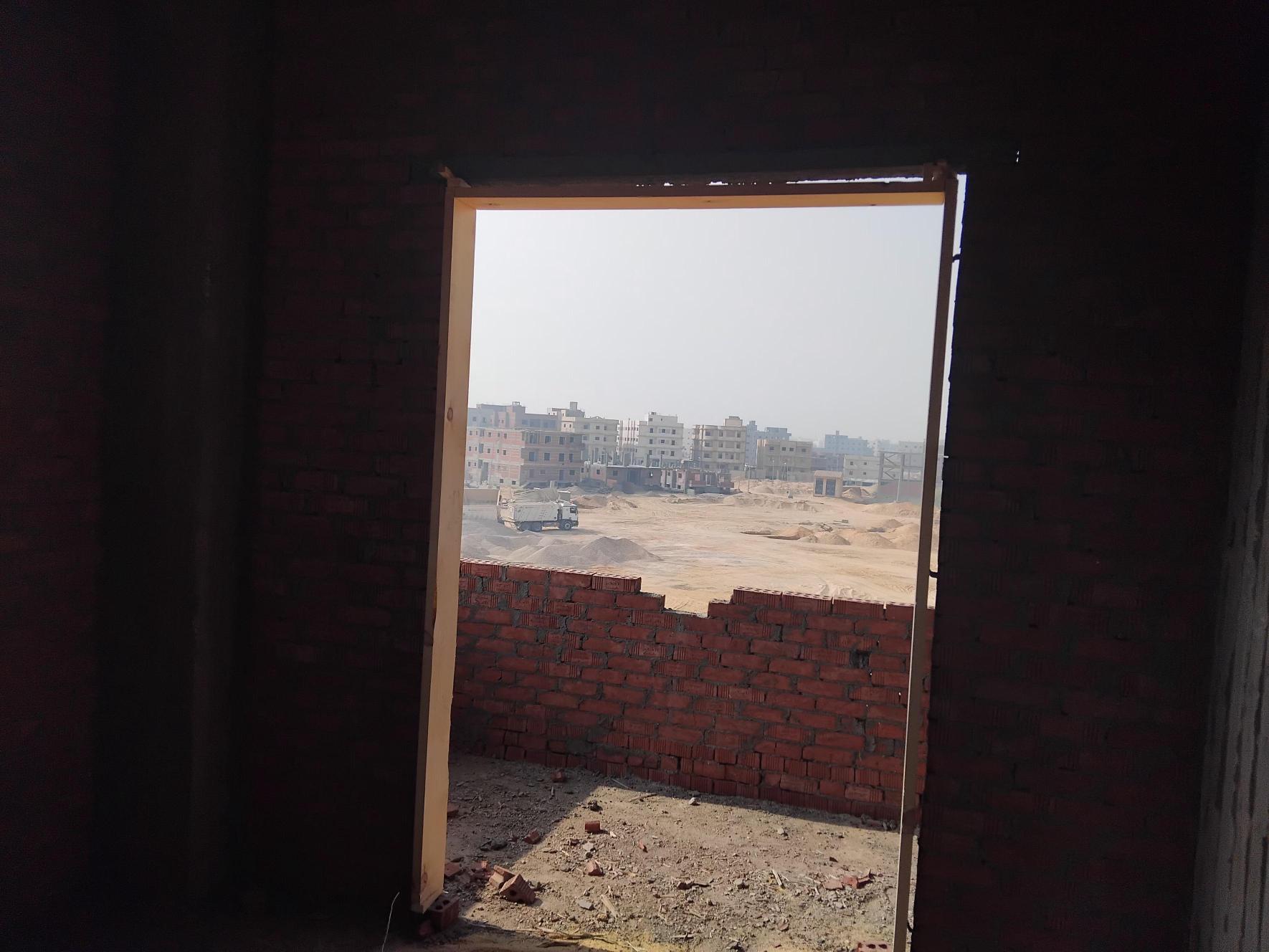

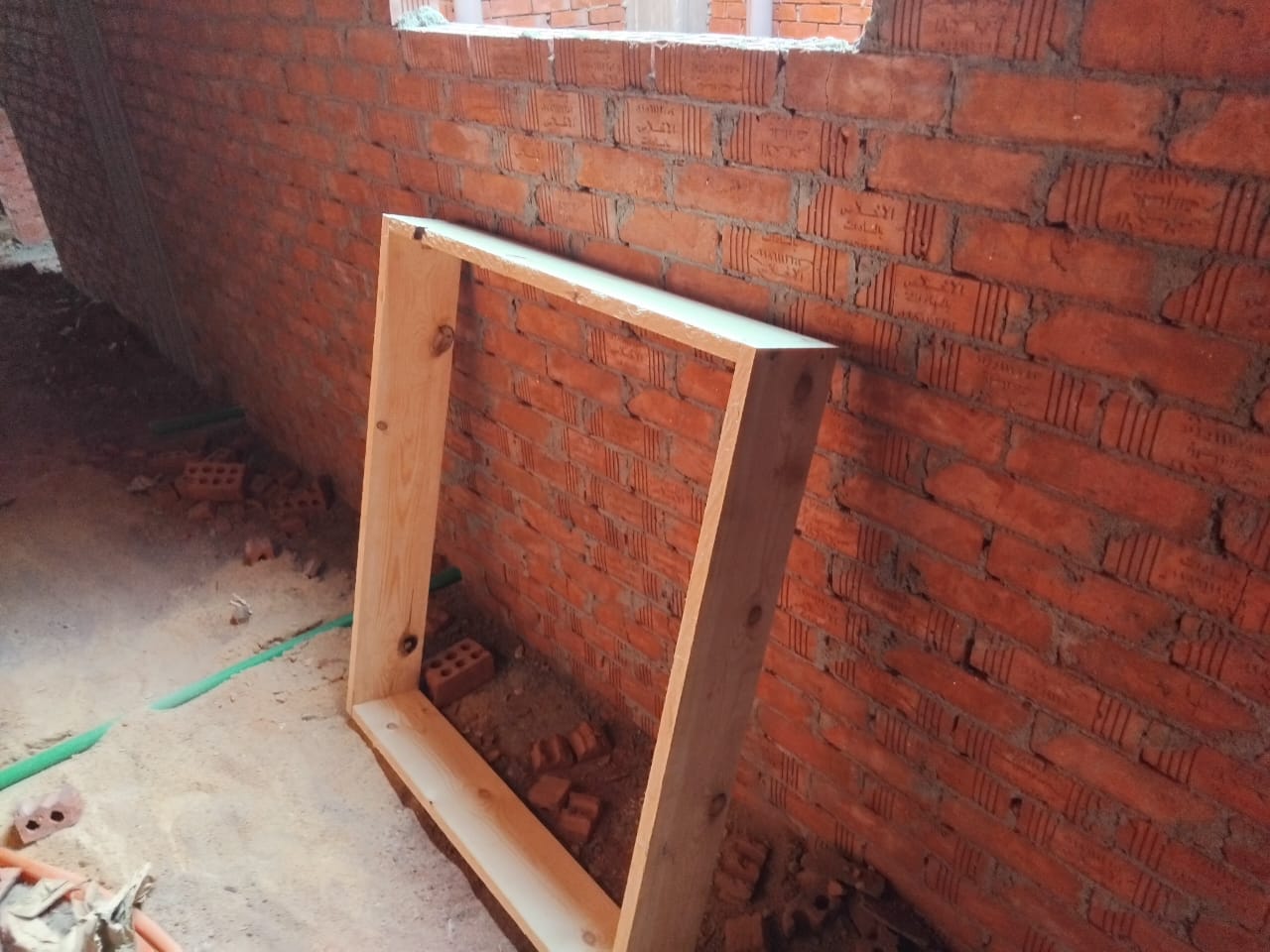

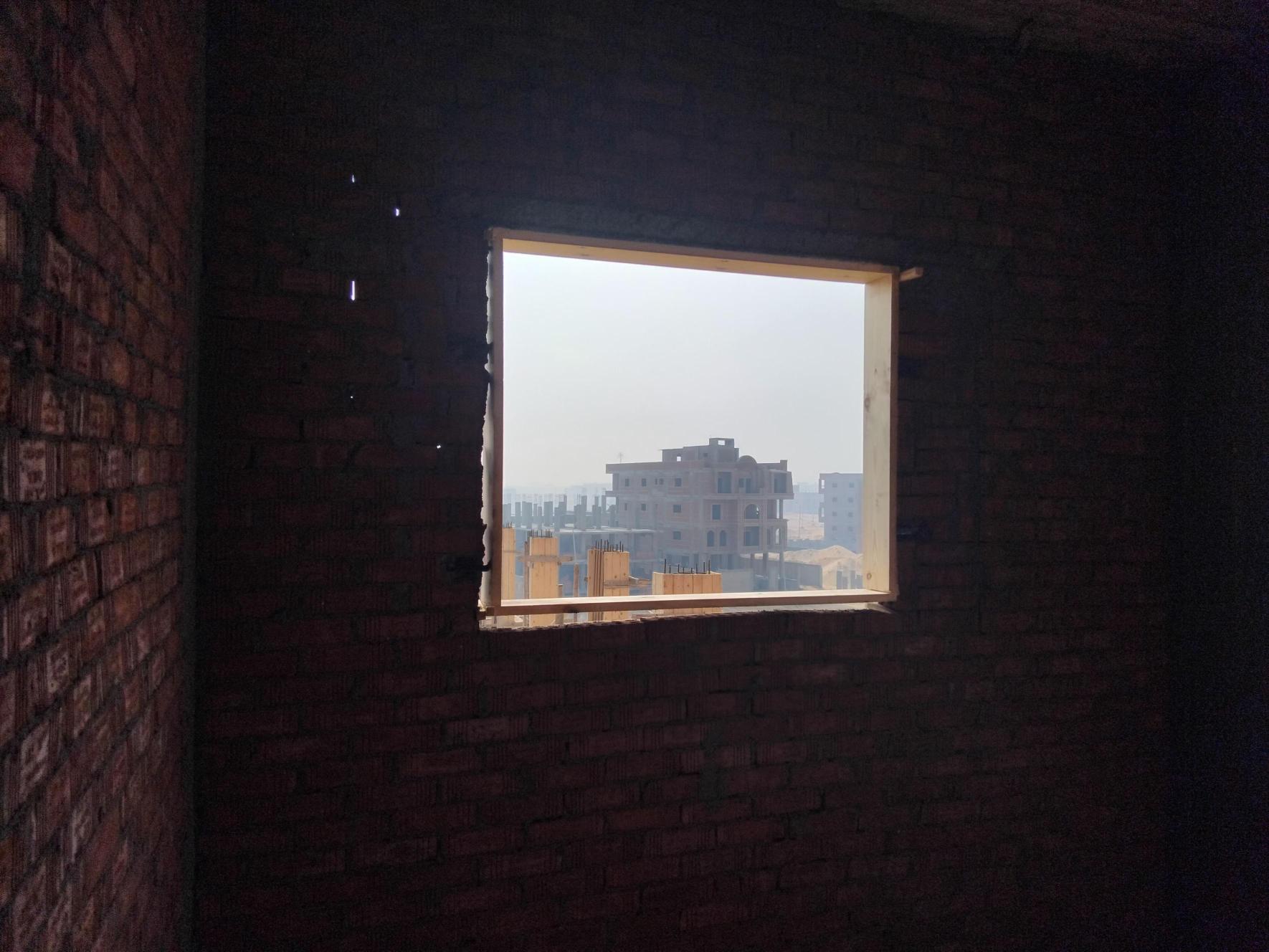

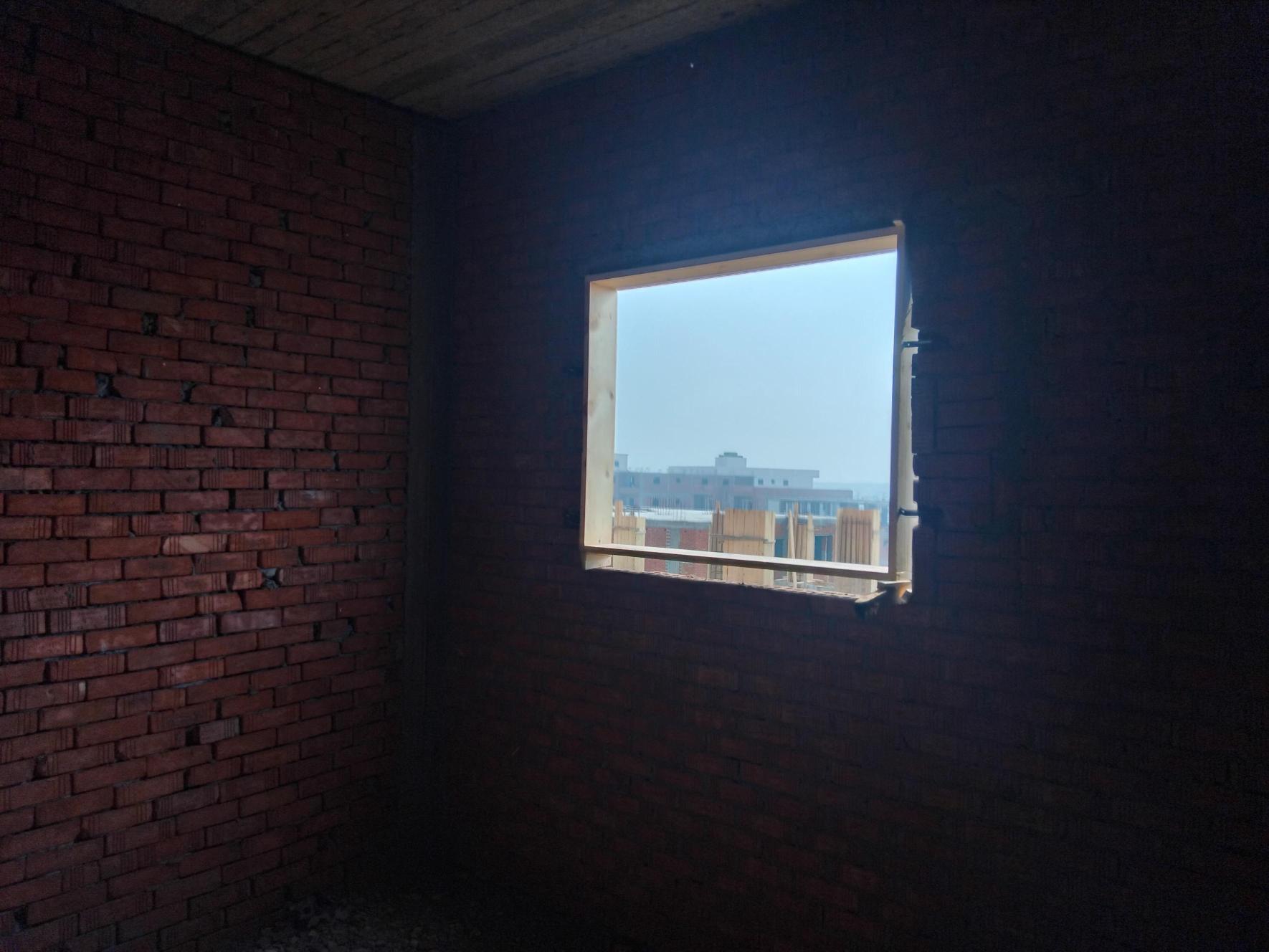

Wooden door frames
November 13, 2025

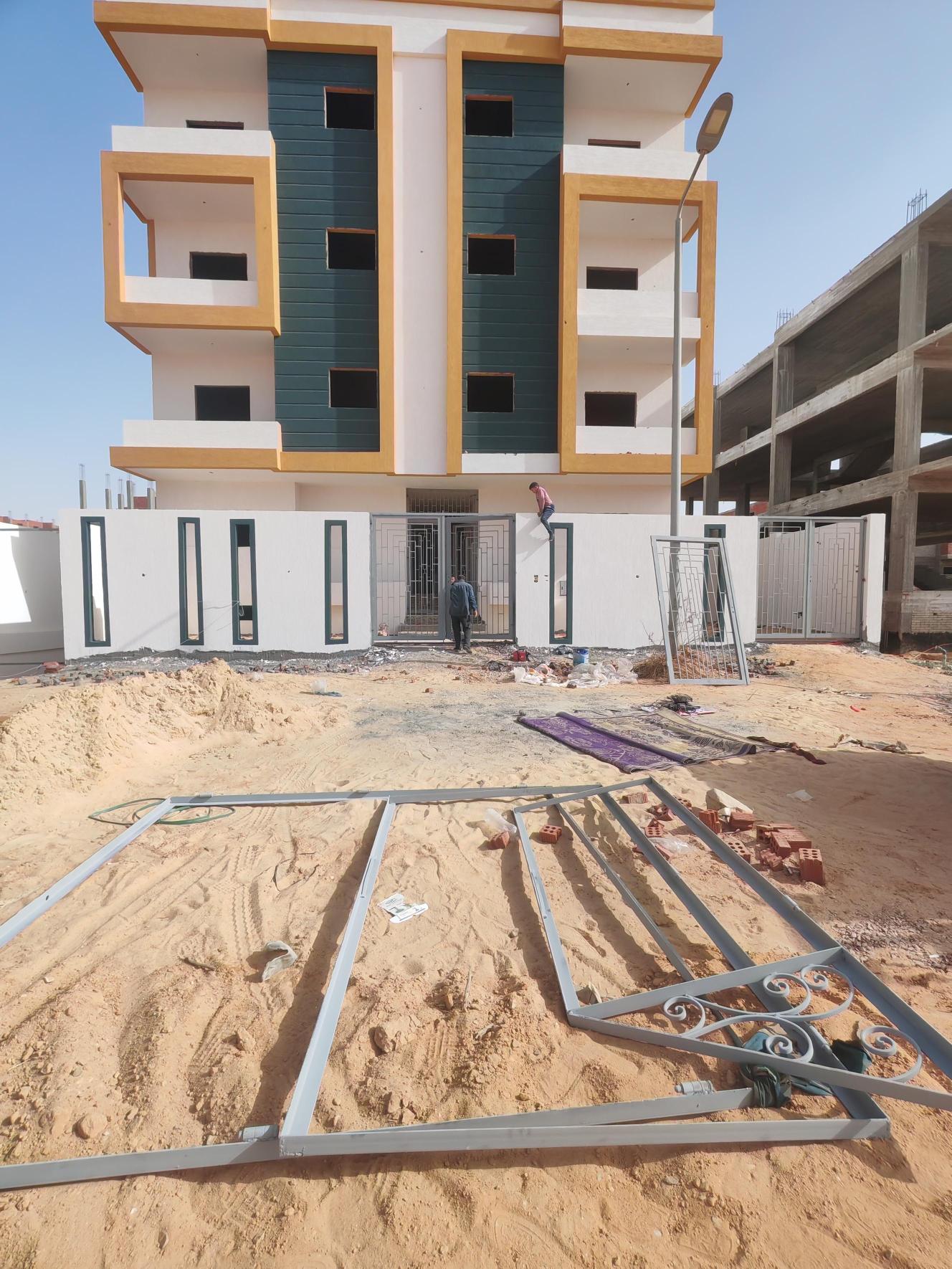

Aluminum & glass works (Krital)
January 3, 2026

Plumbing works
December 30, 2025

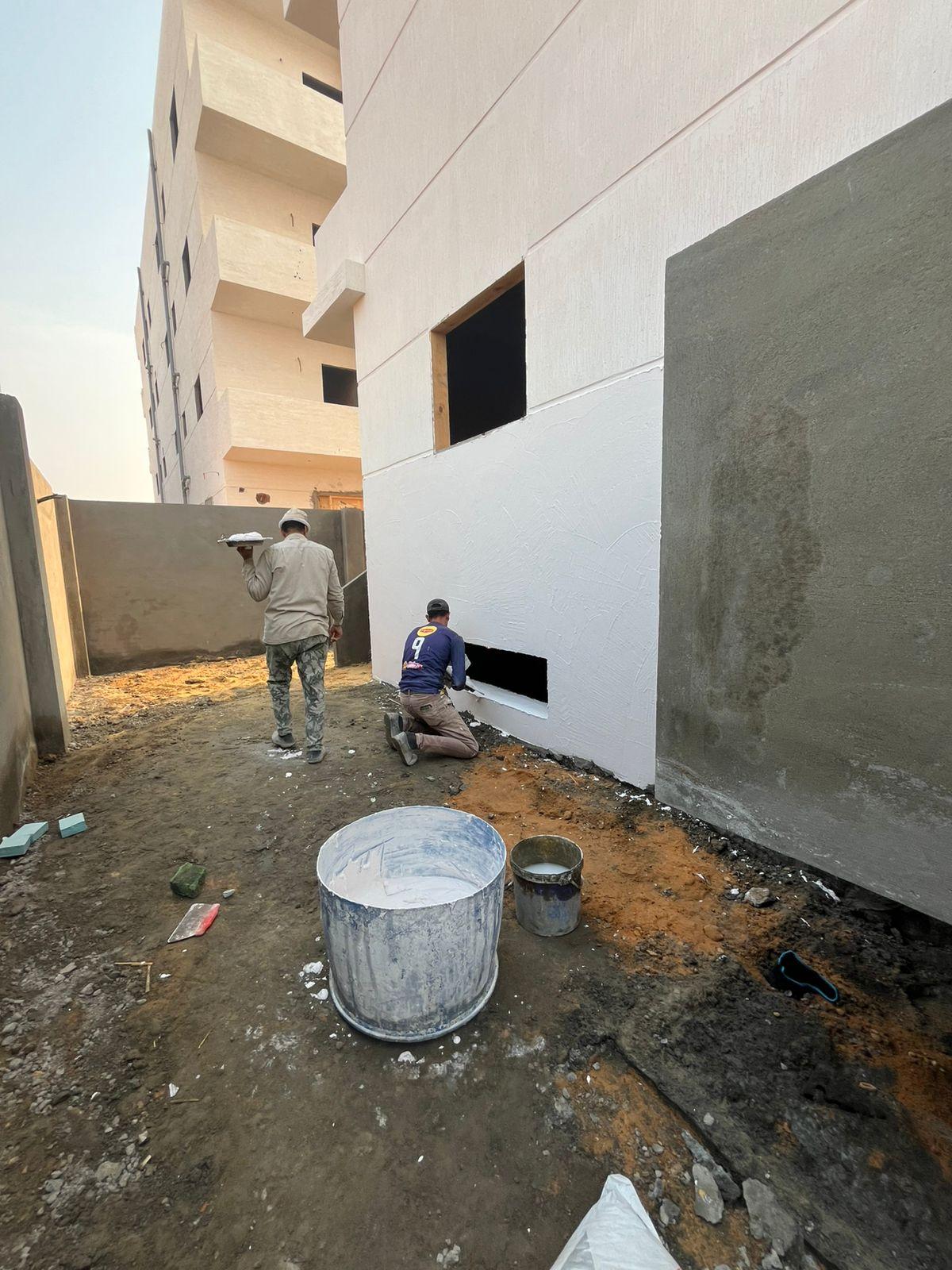

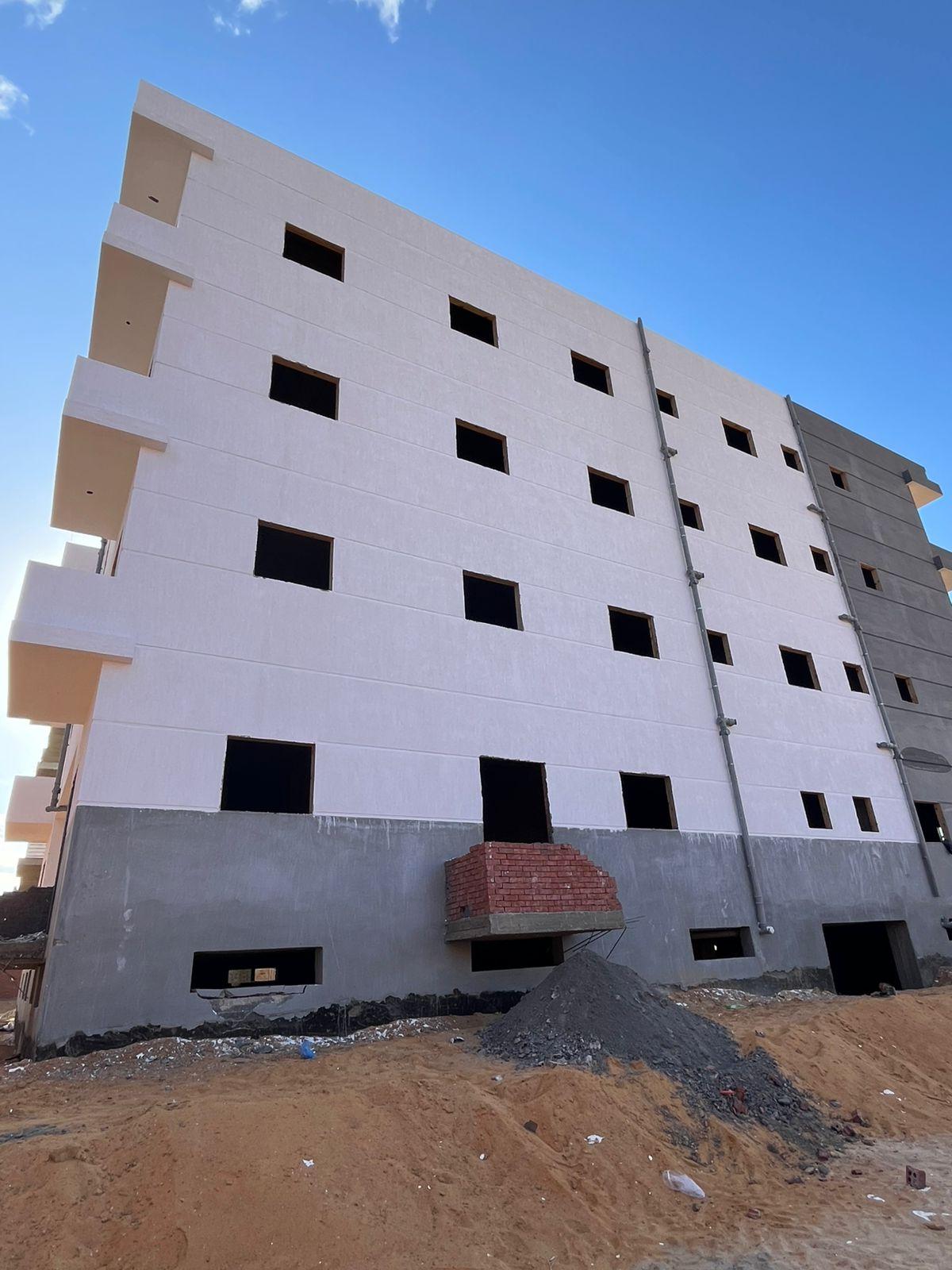

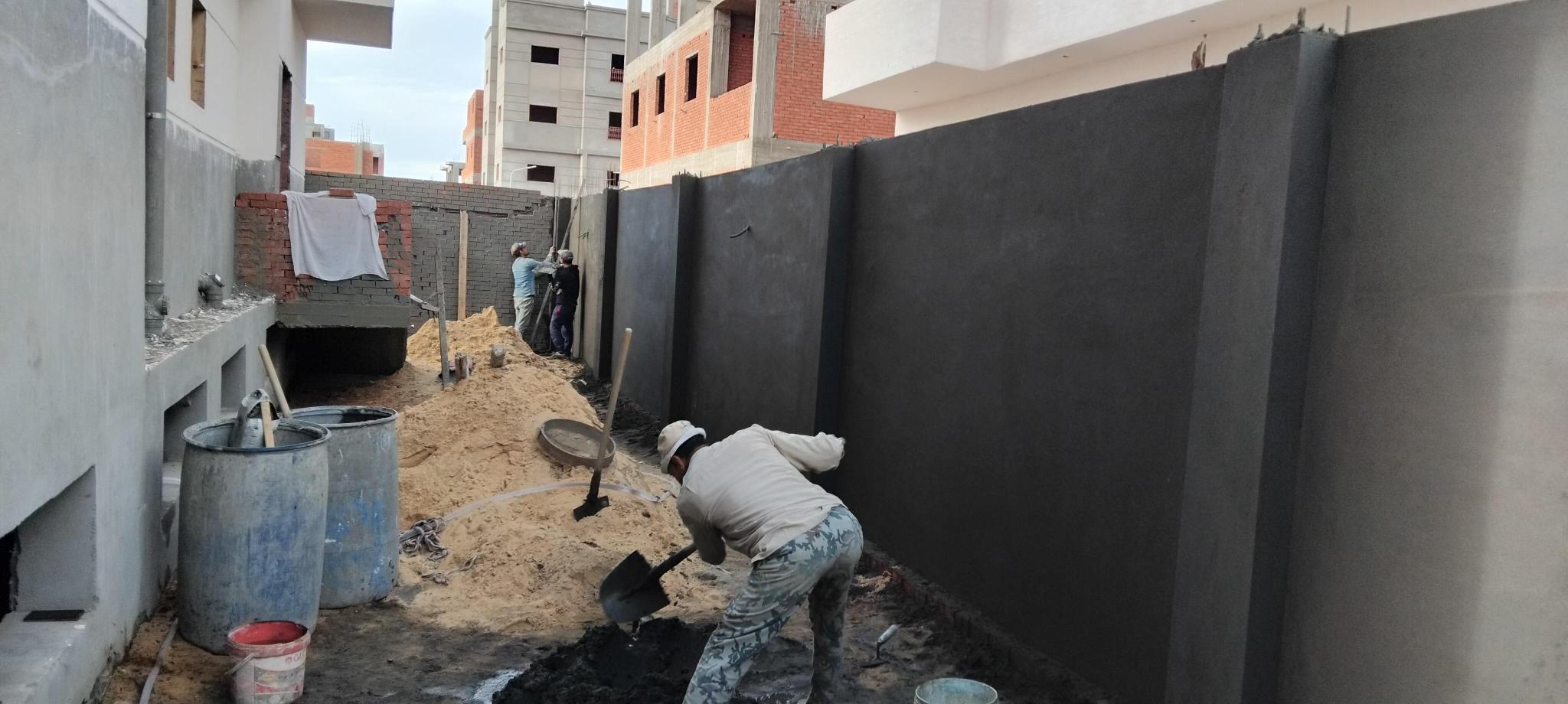

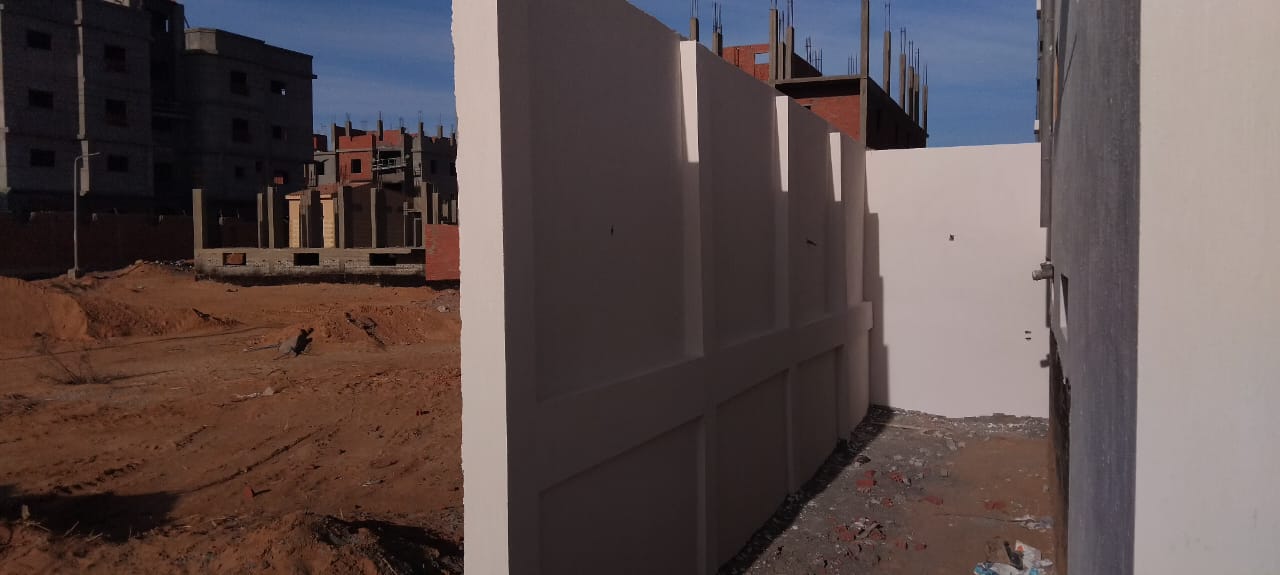

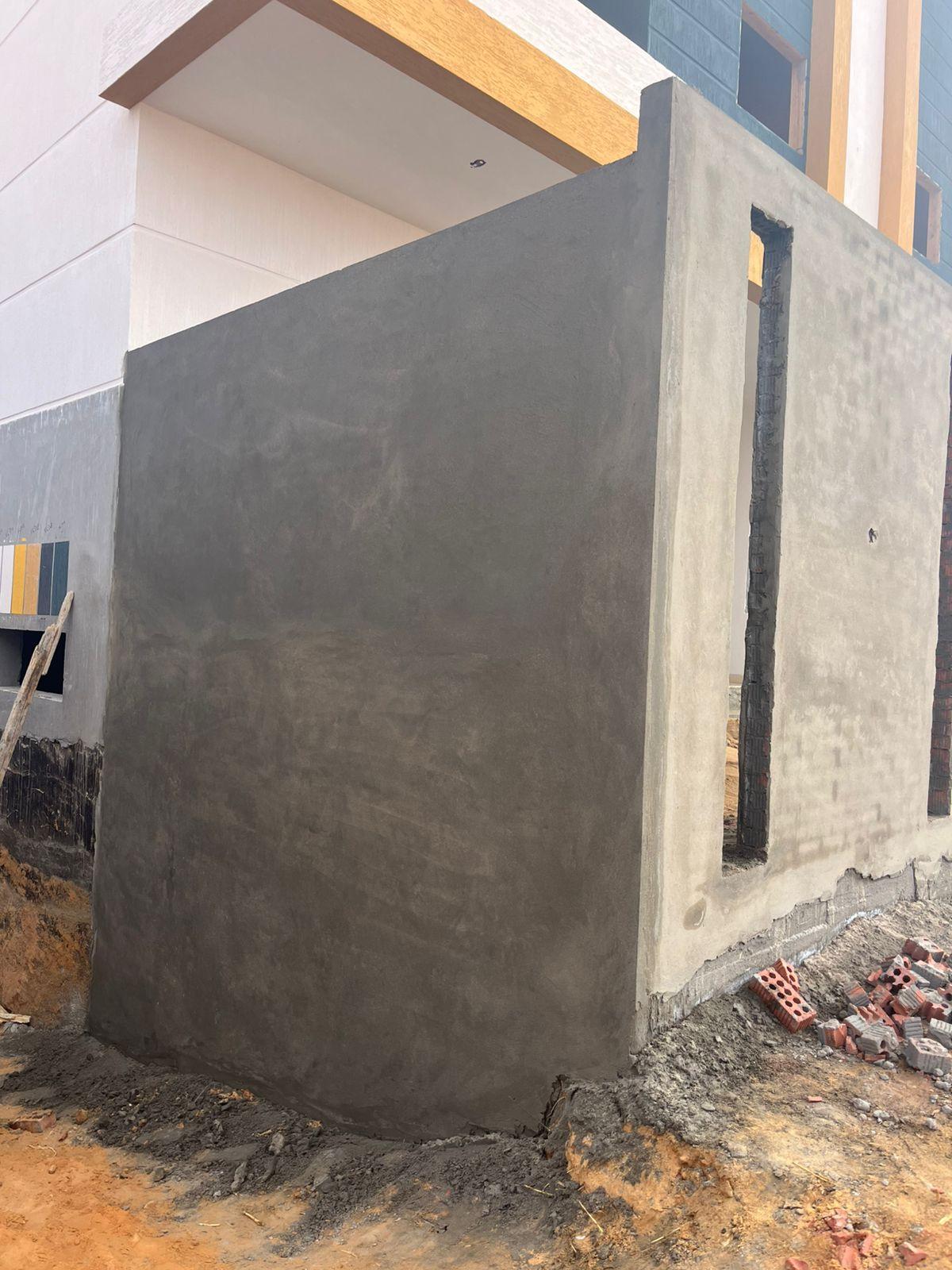

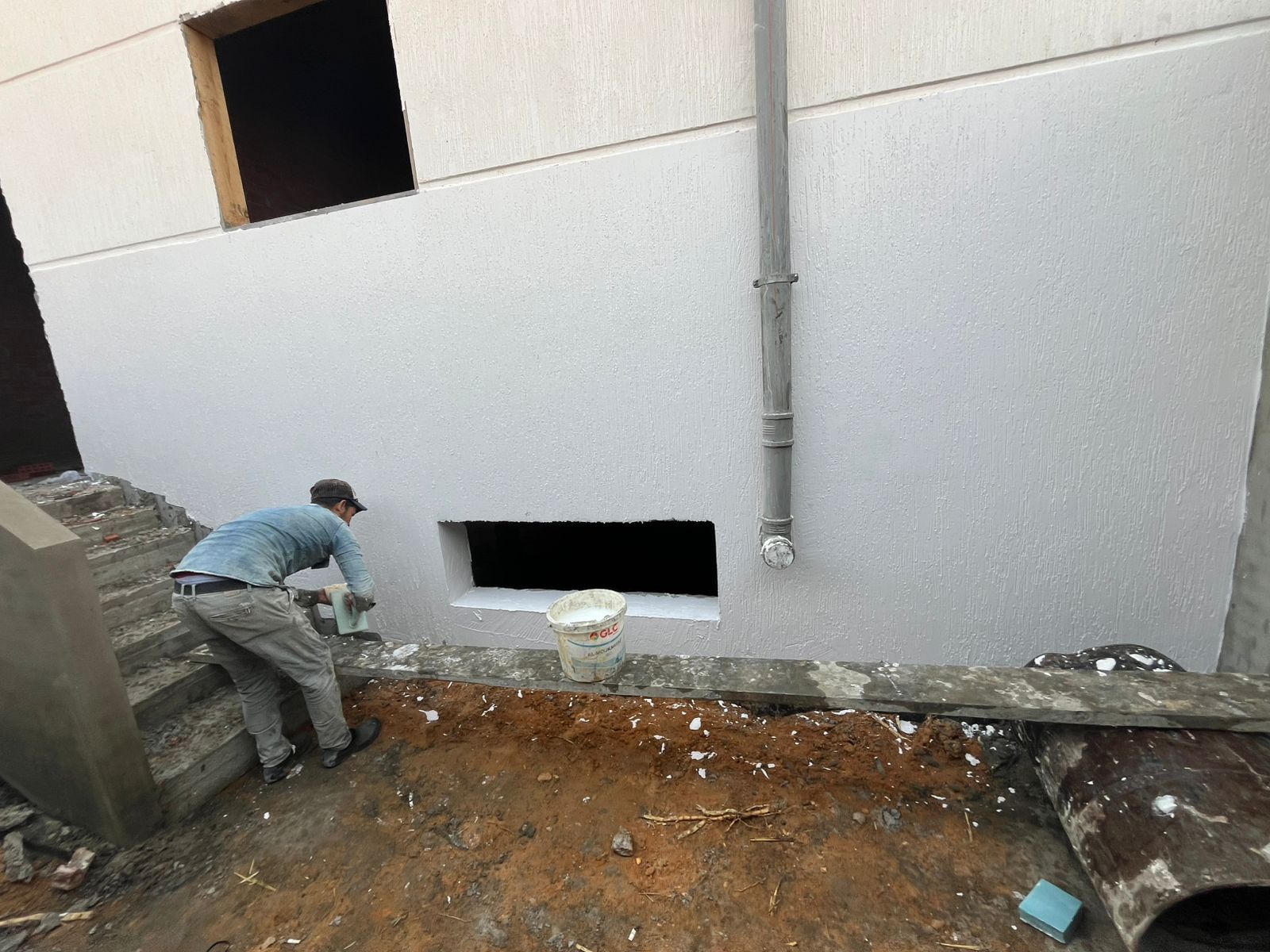

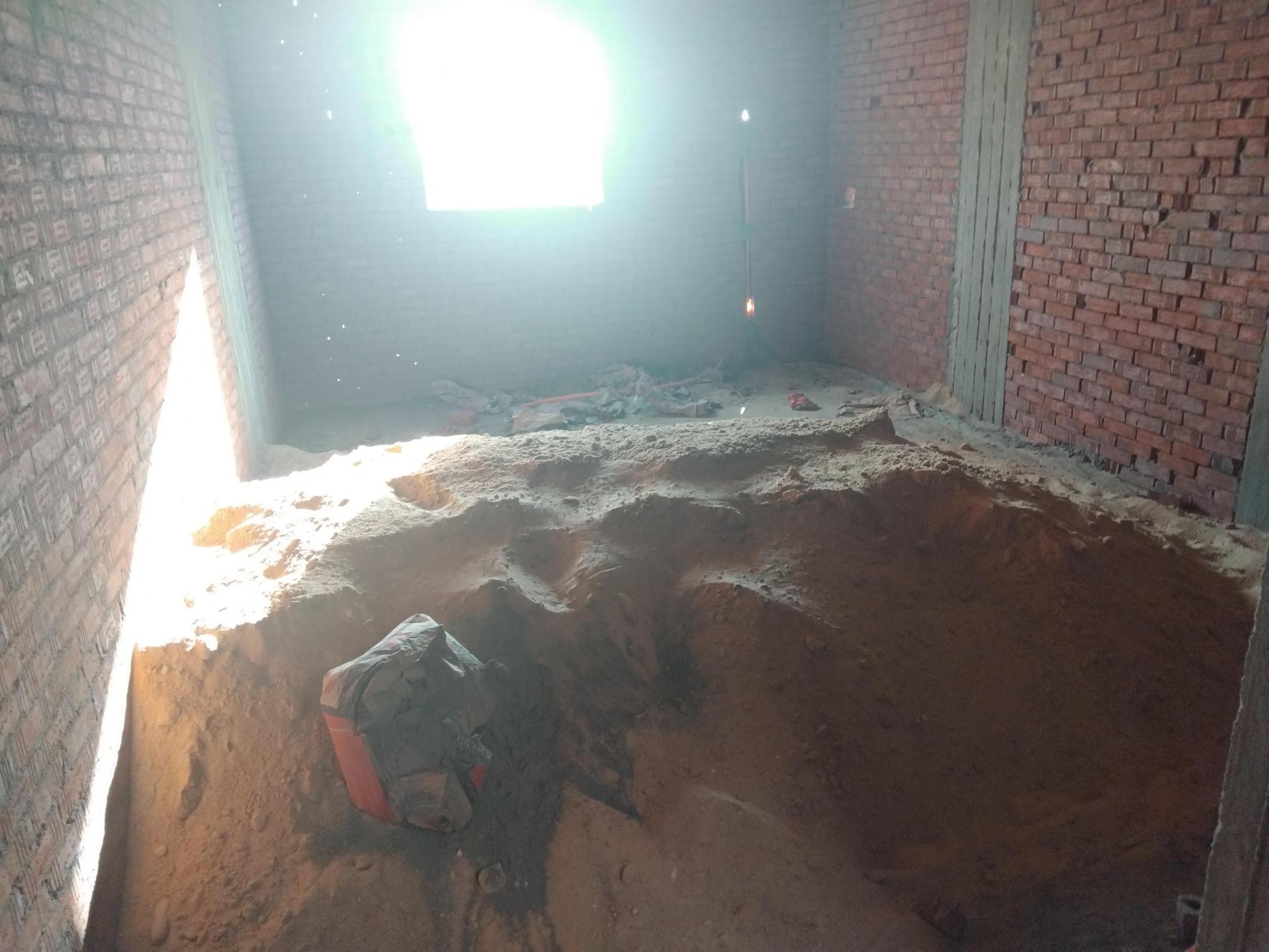

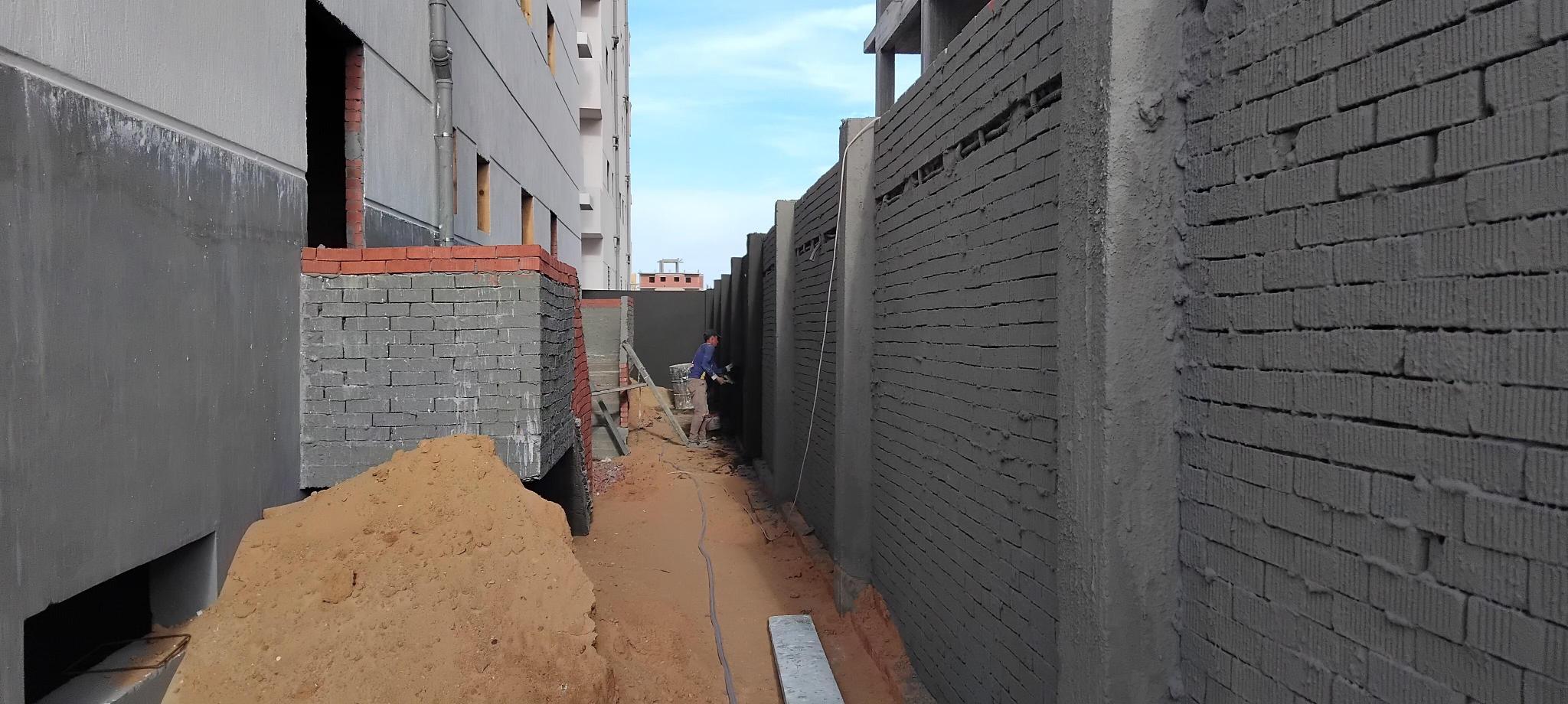

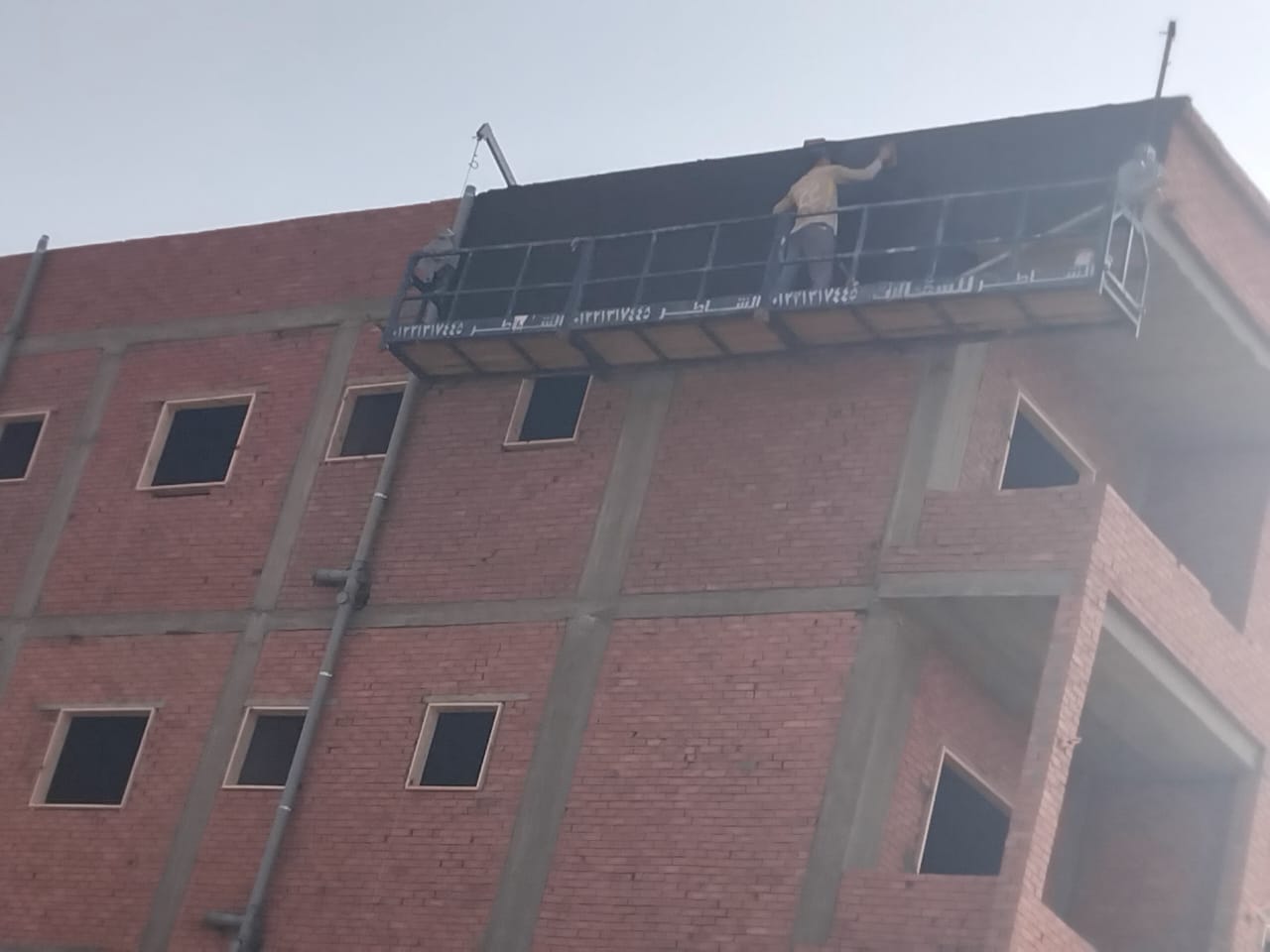

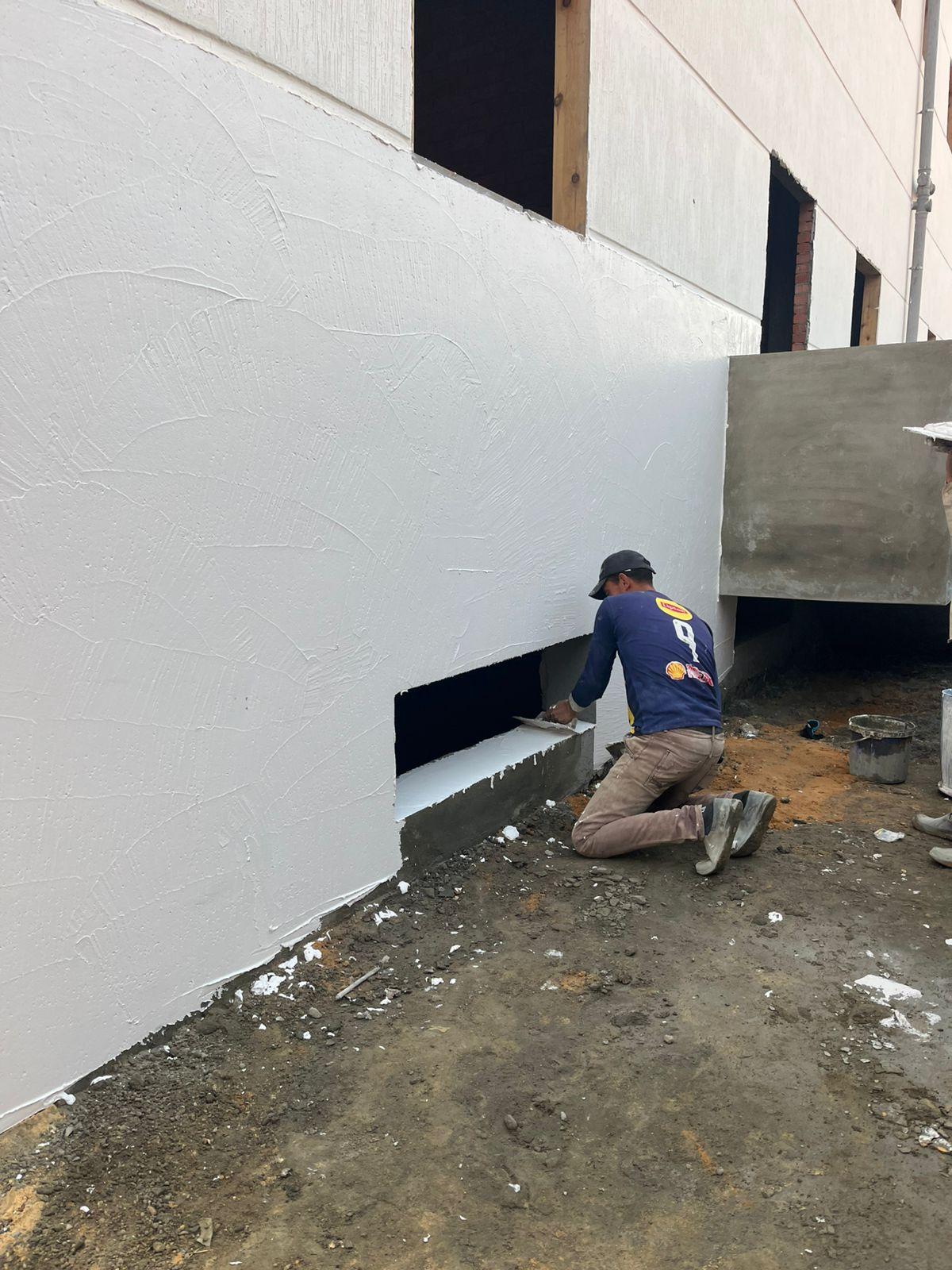

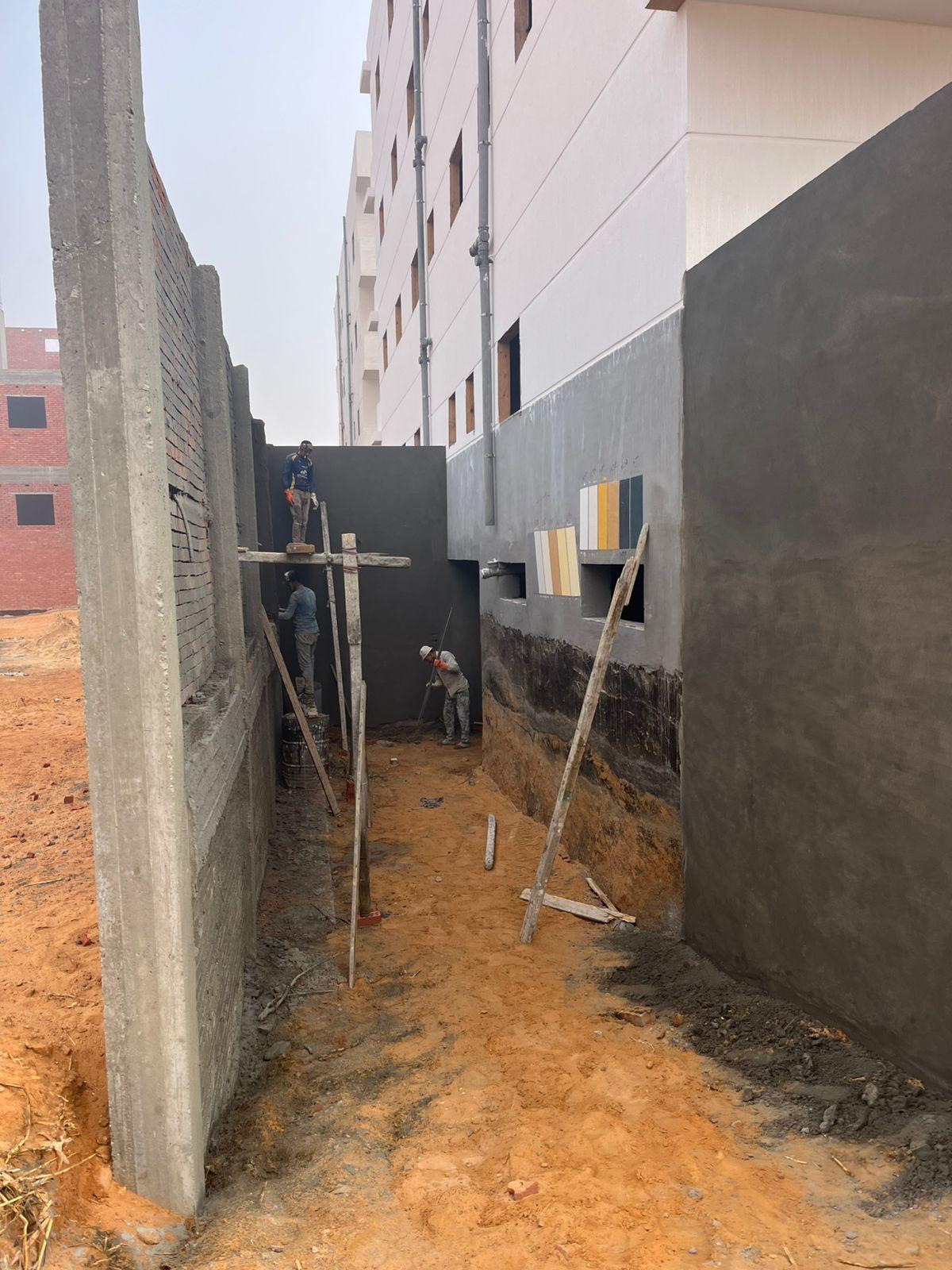

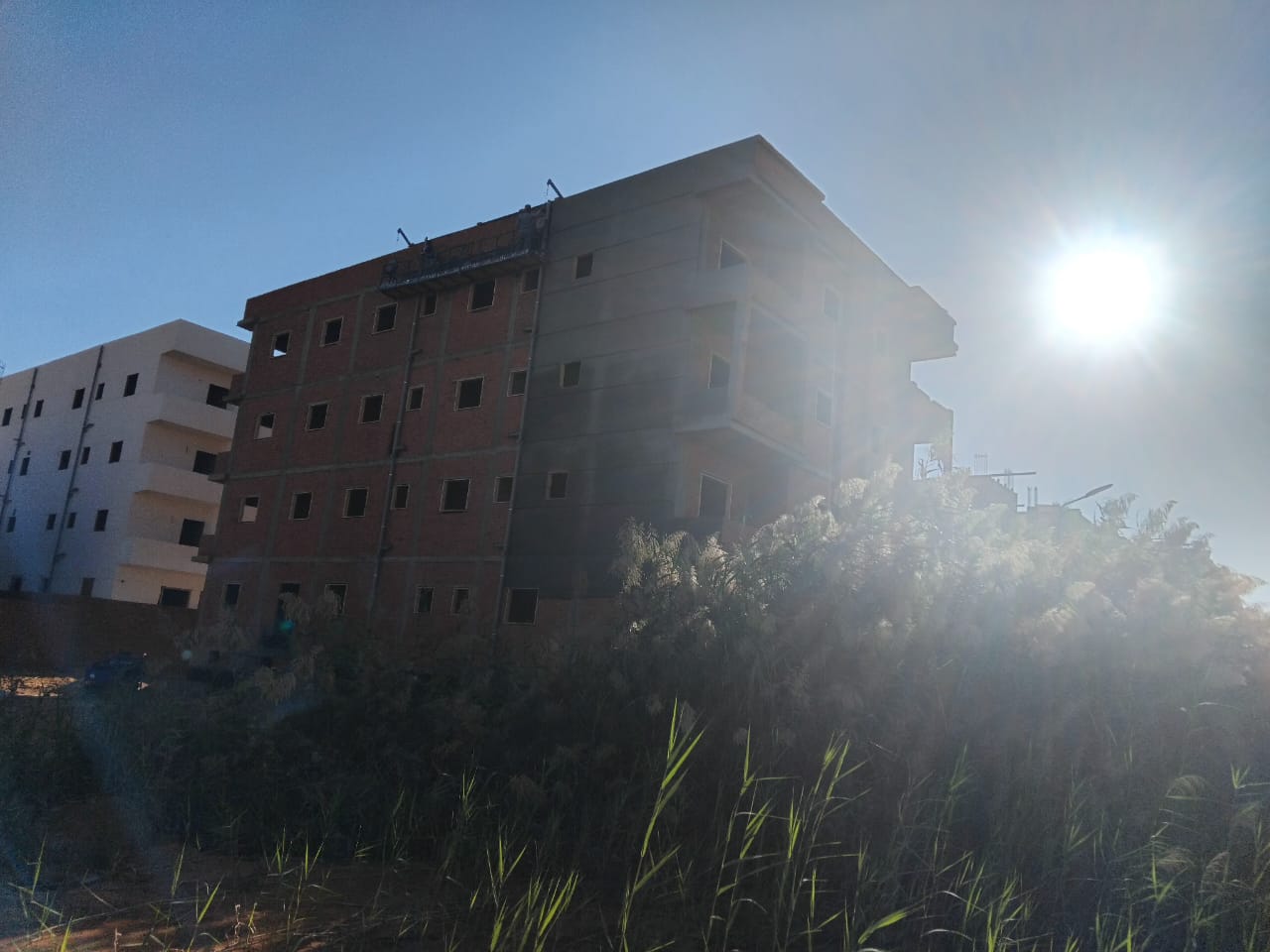

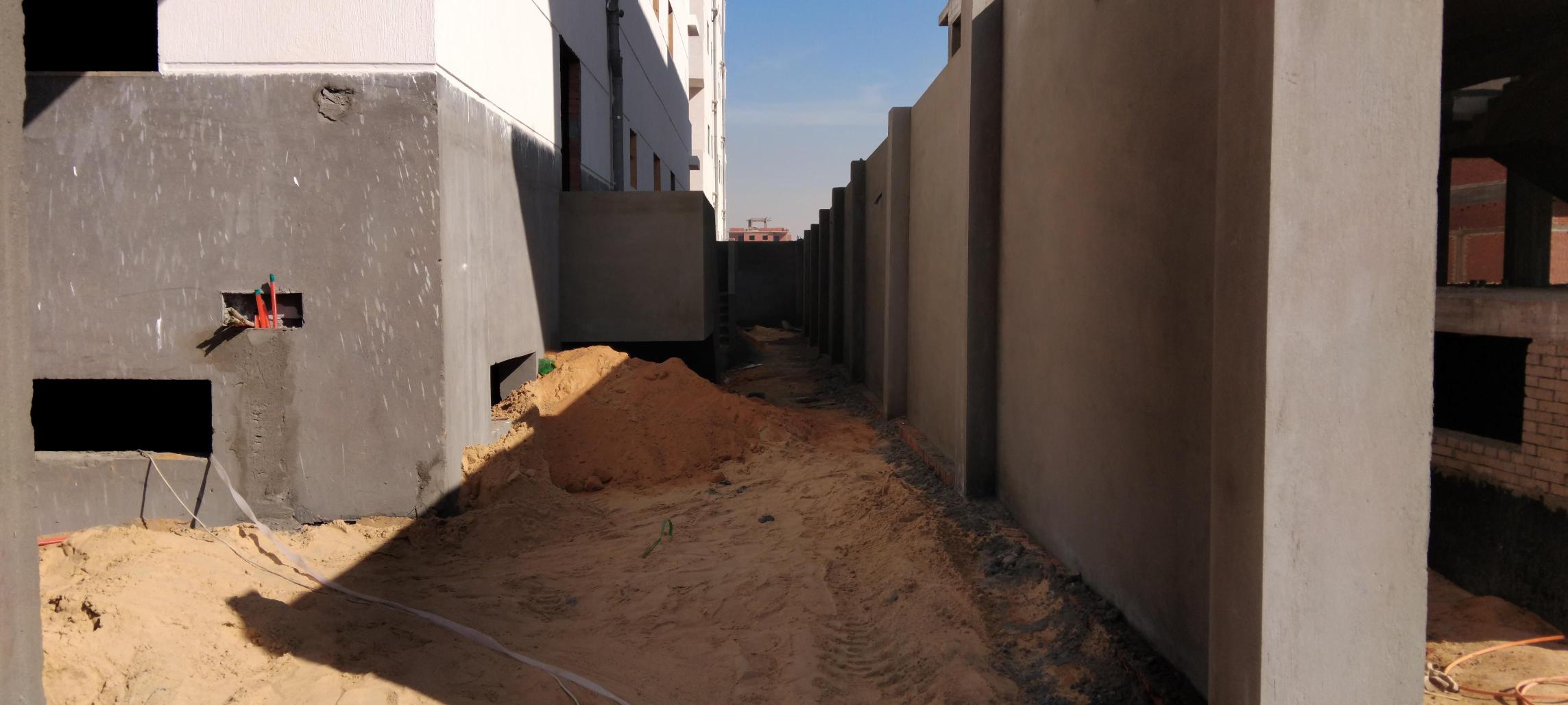

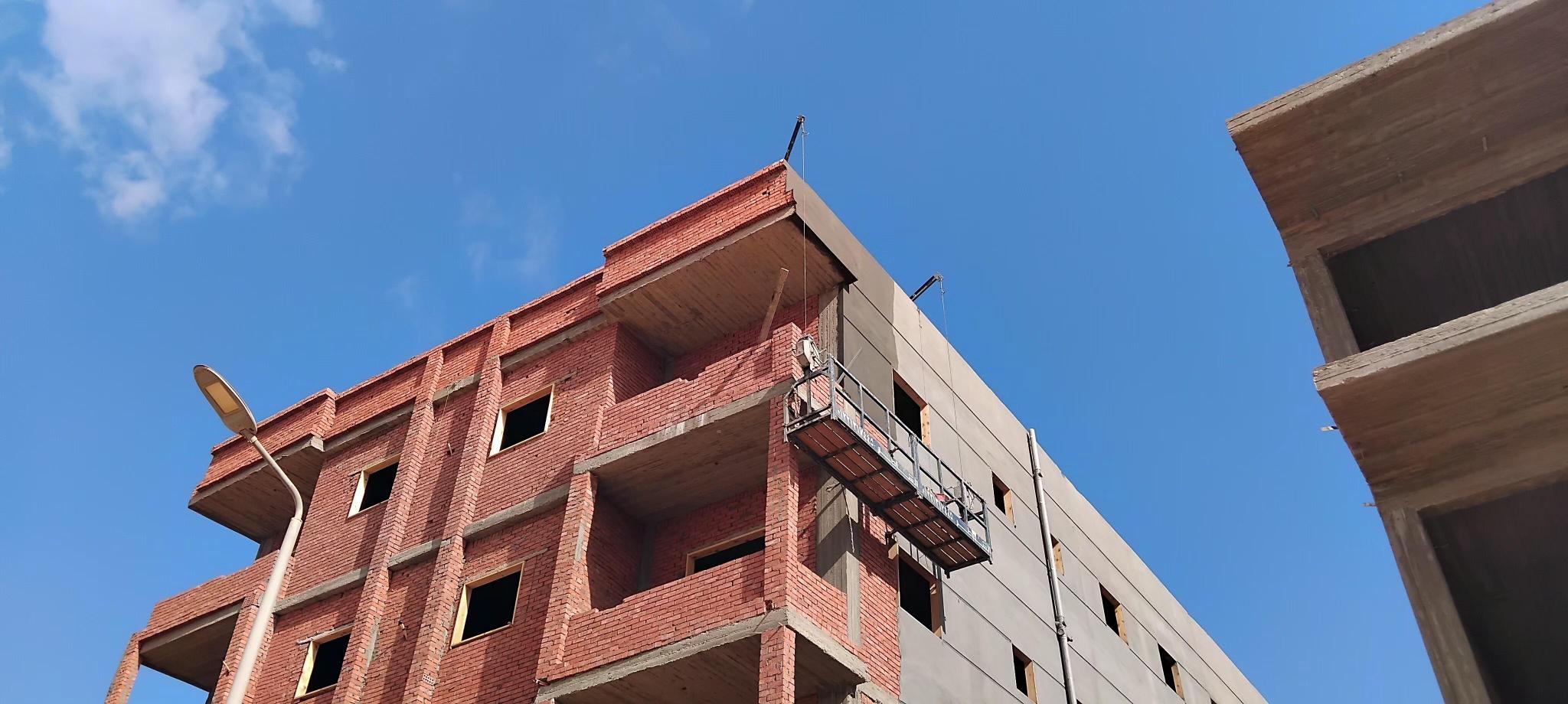

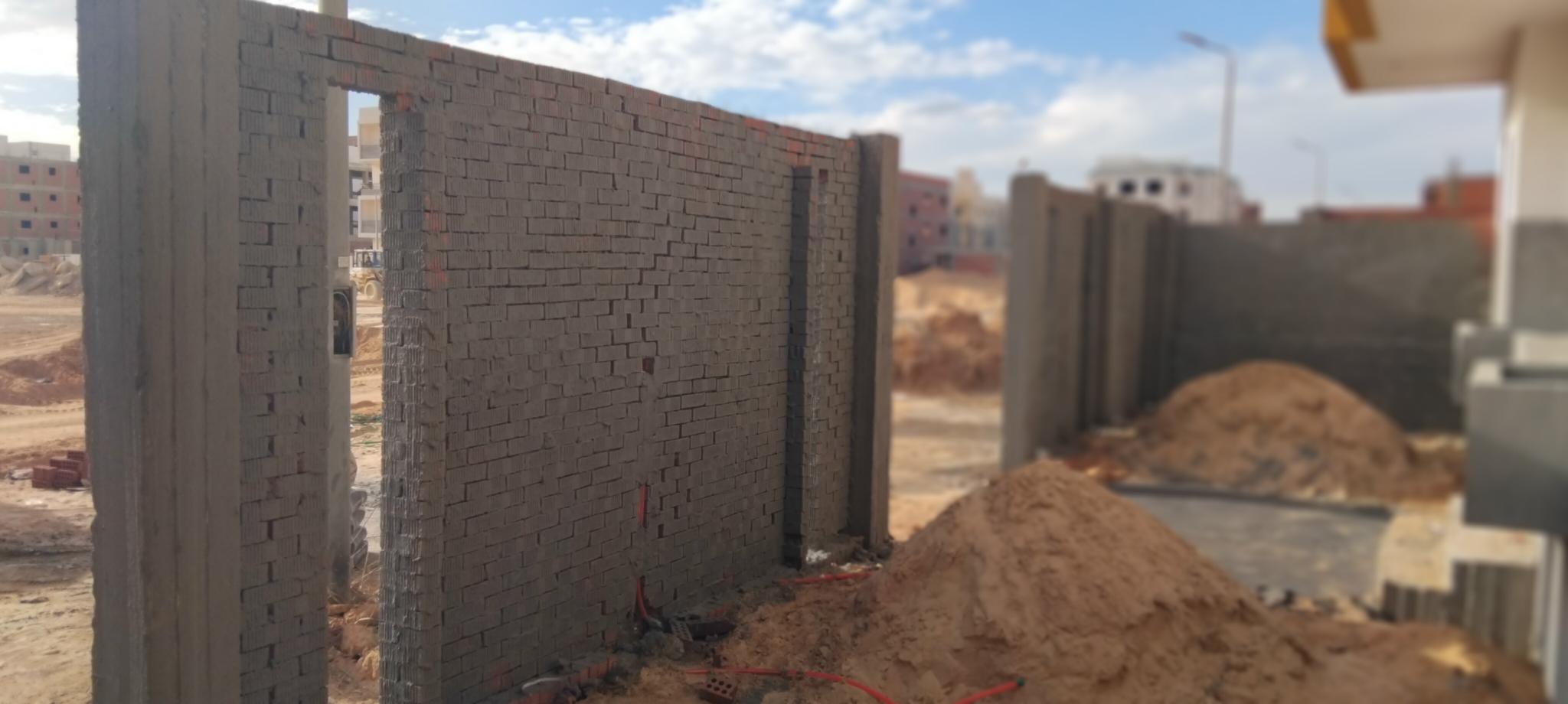

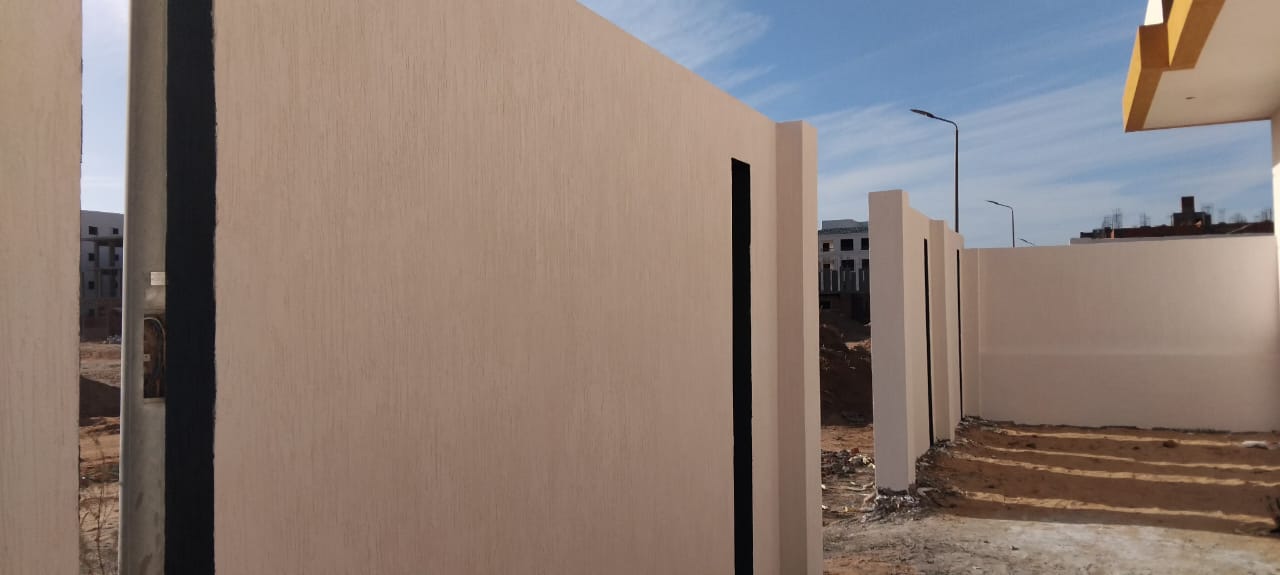

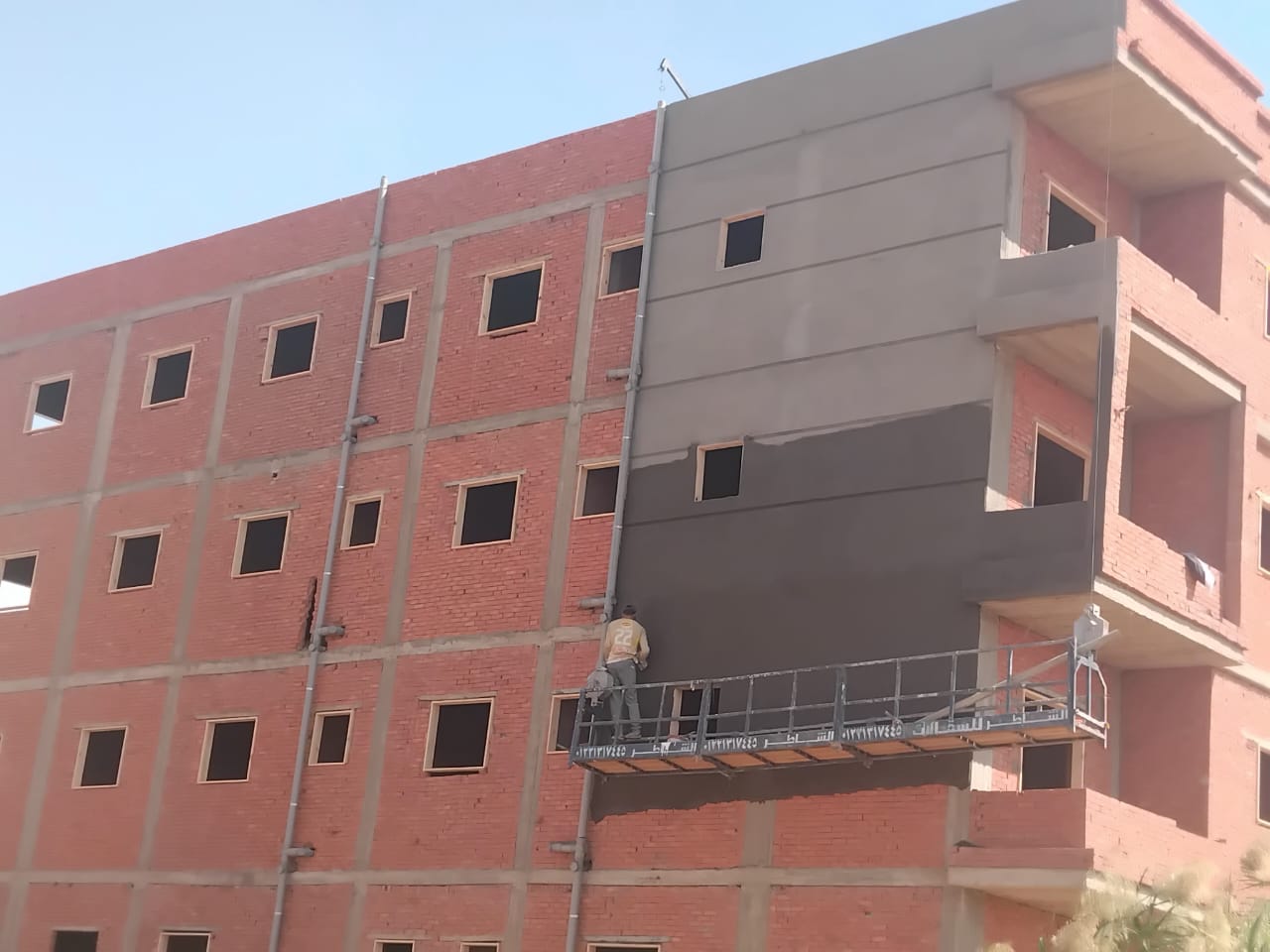

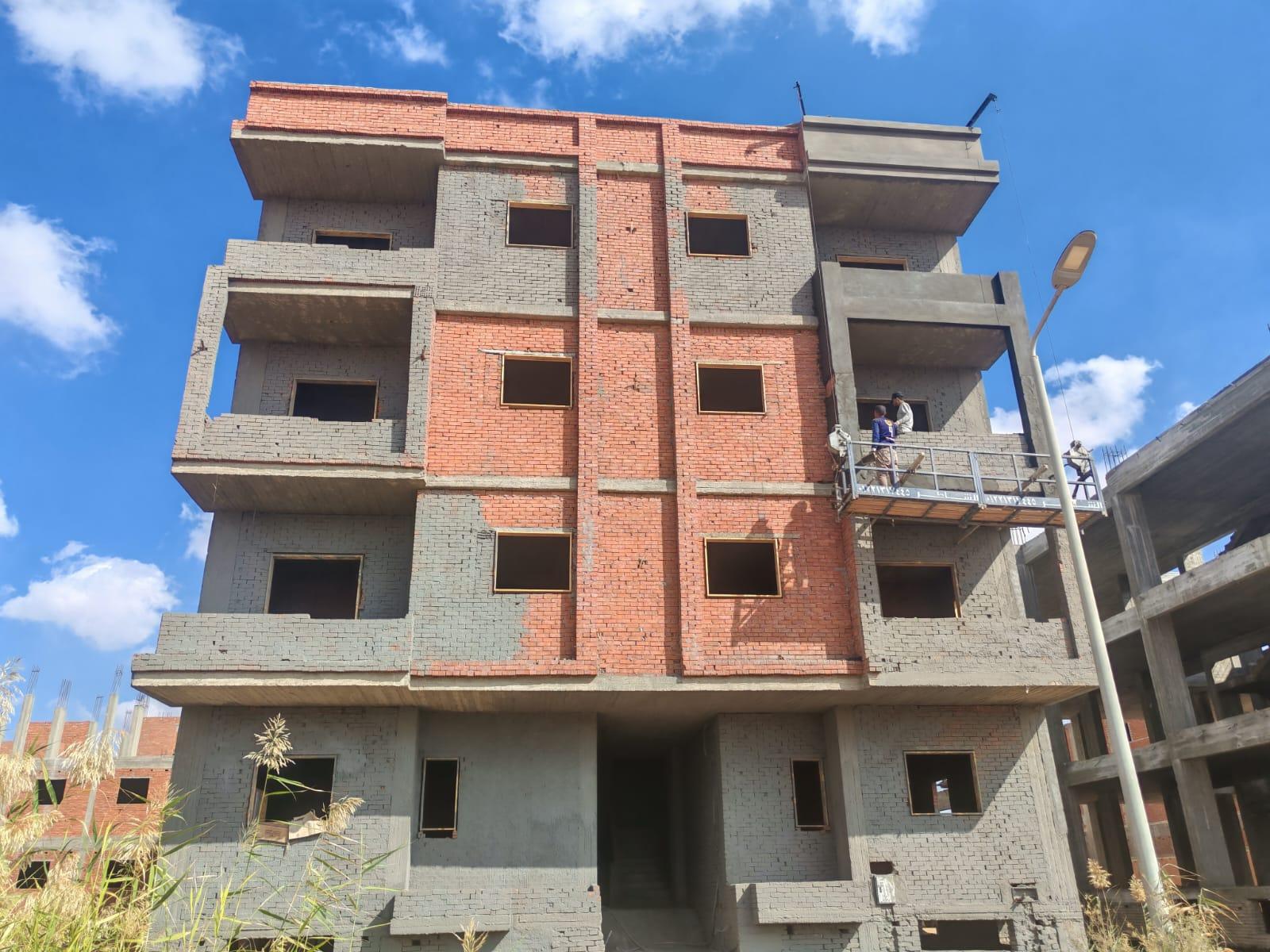

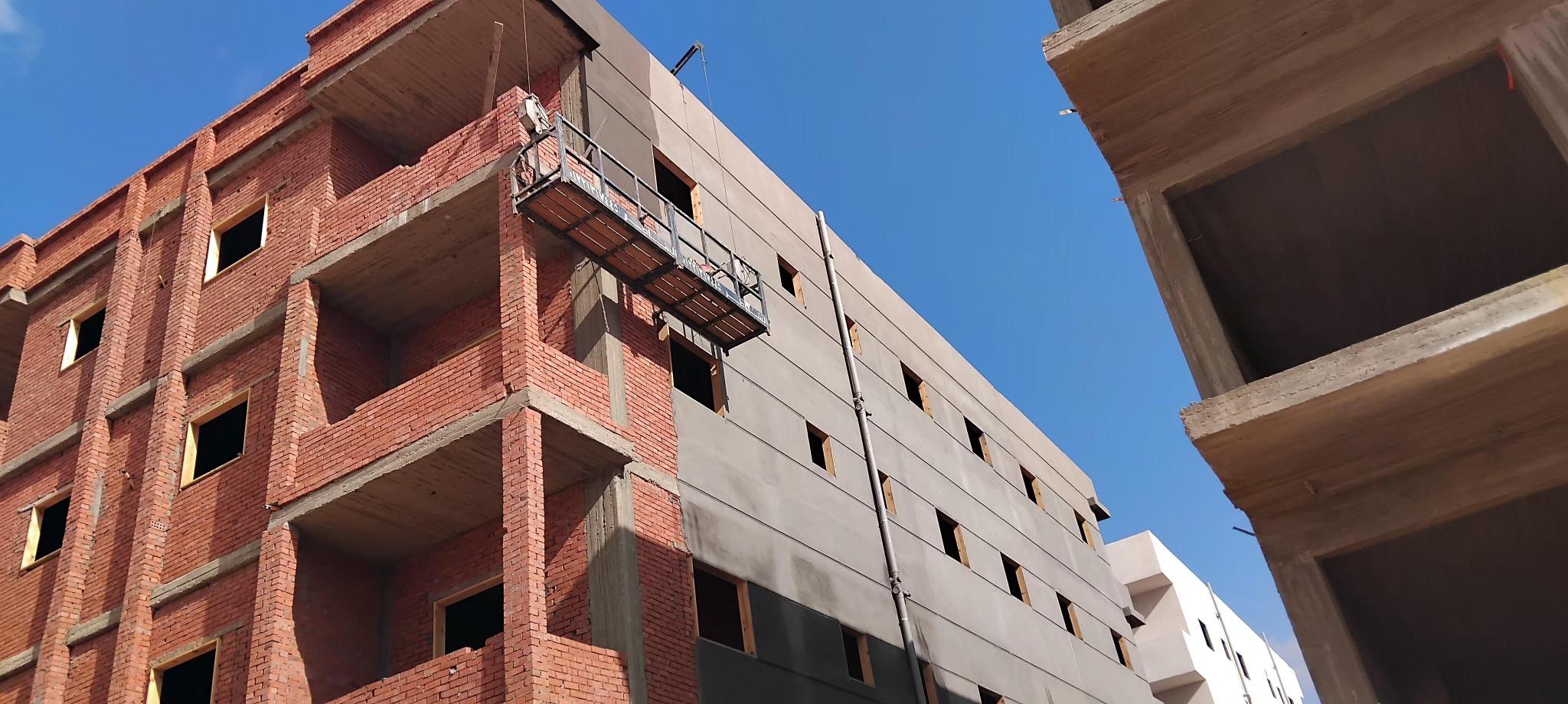

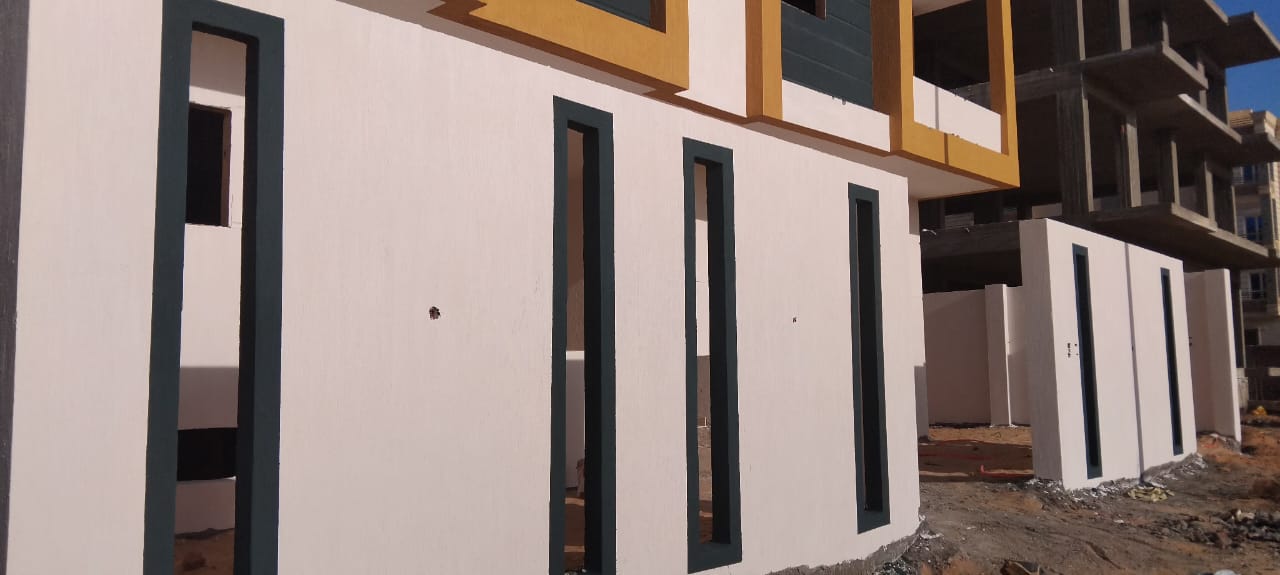

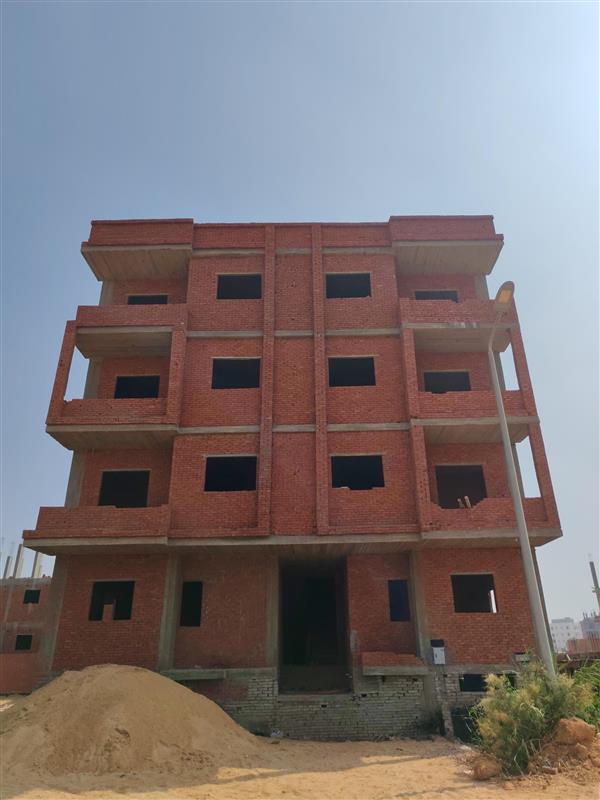

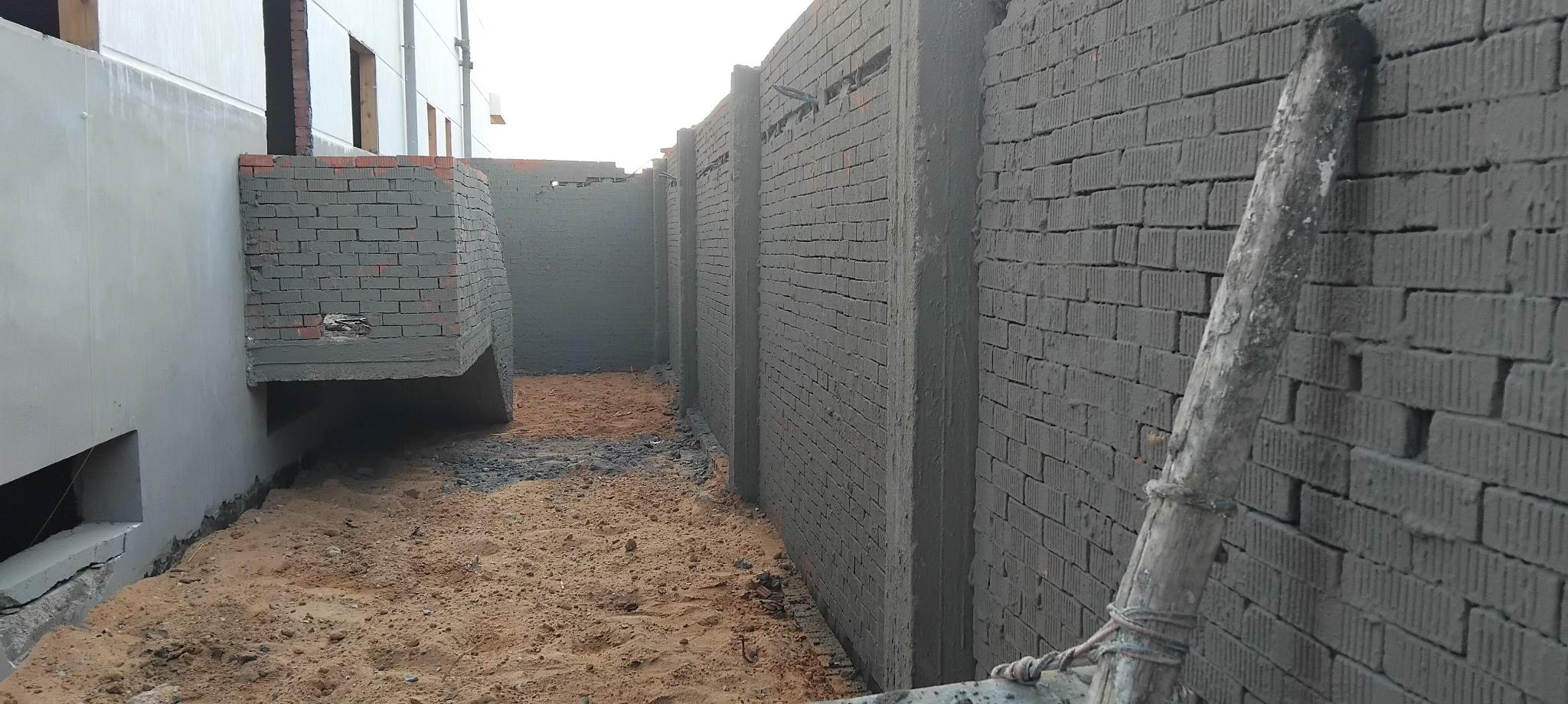

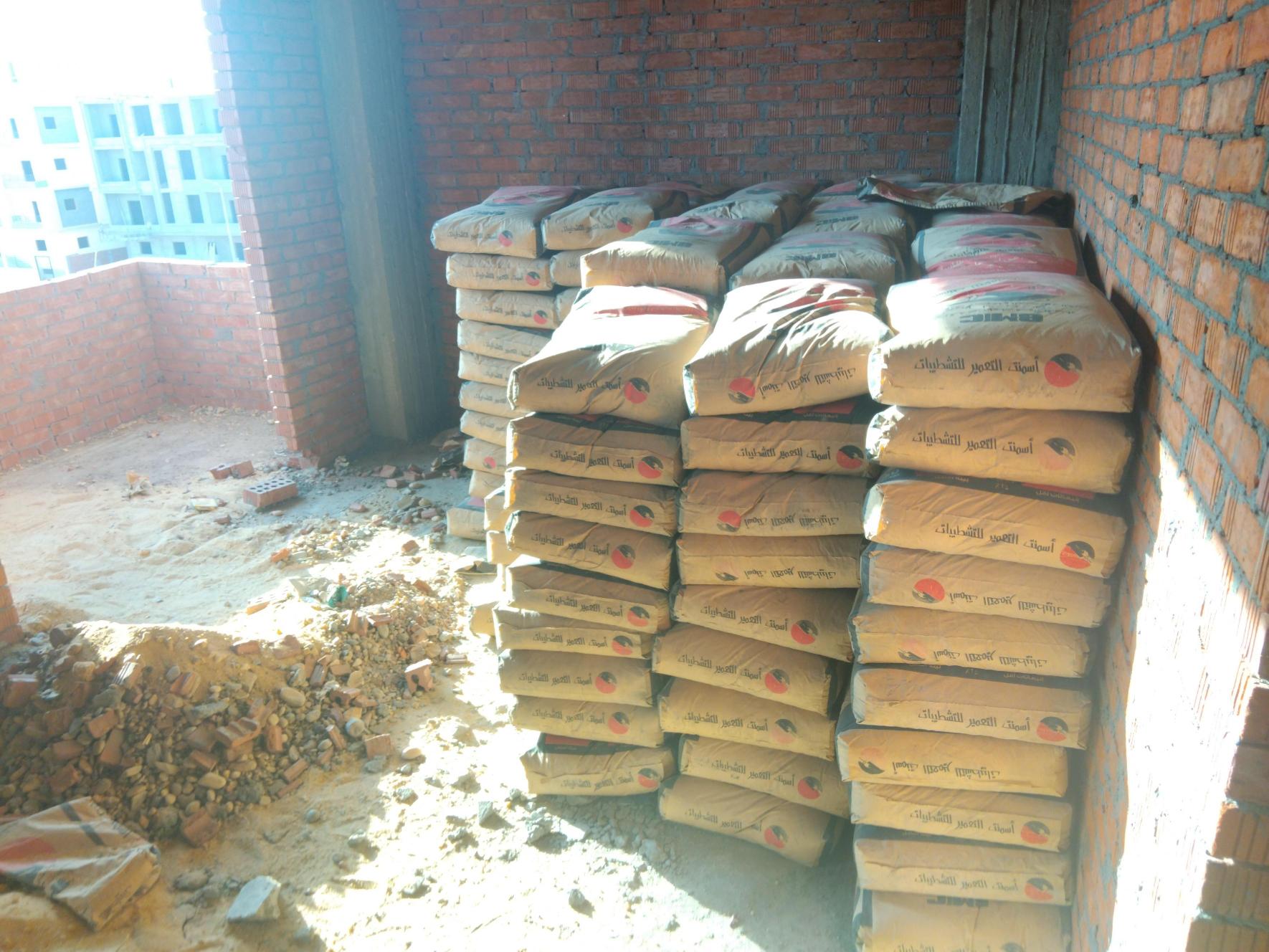

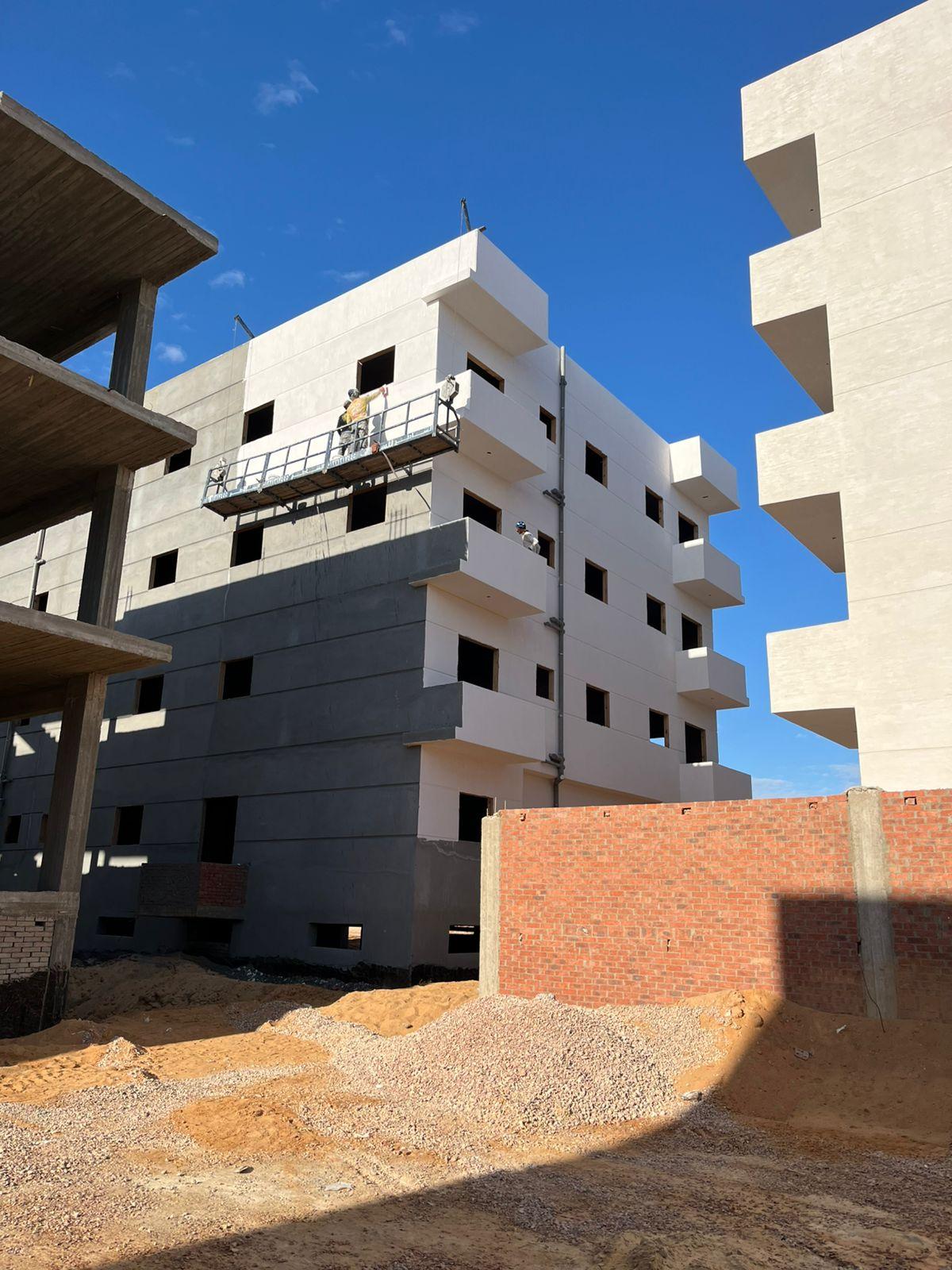

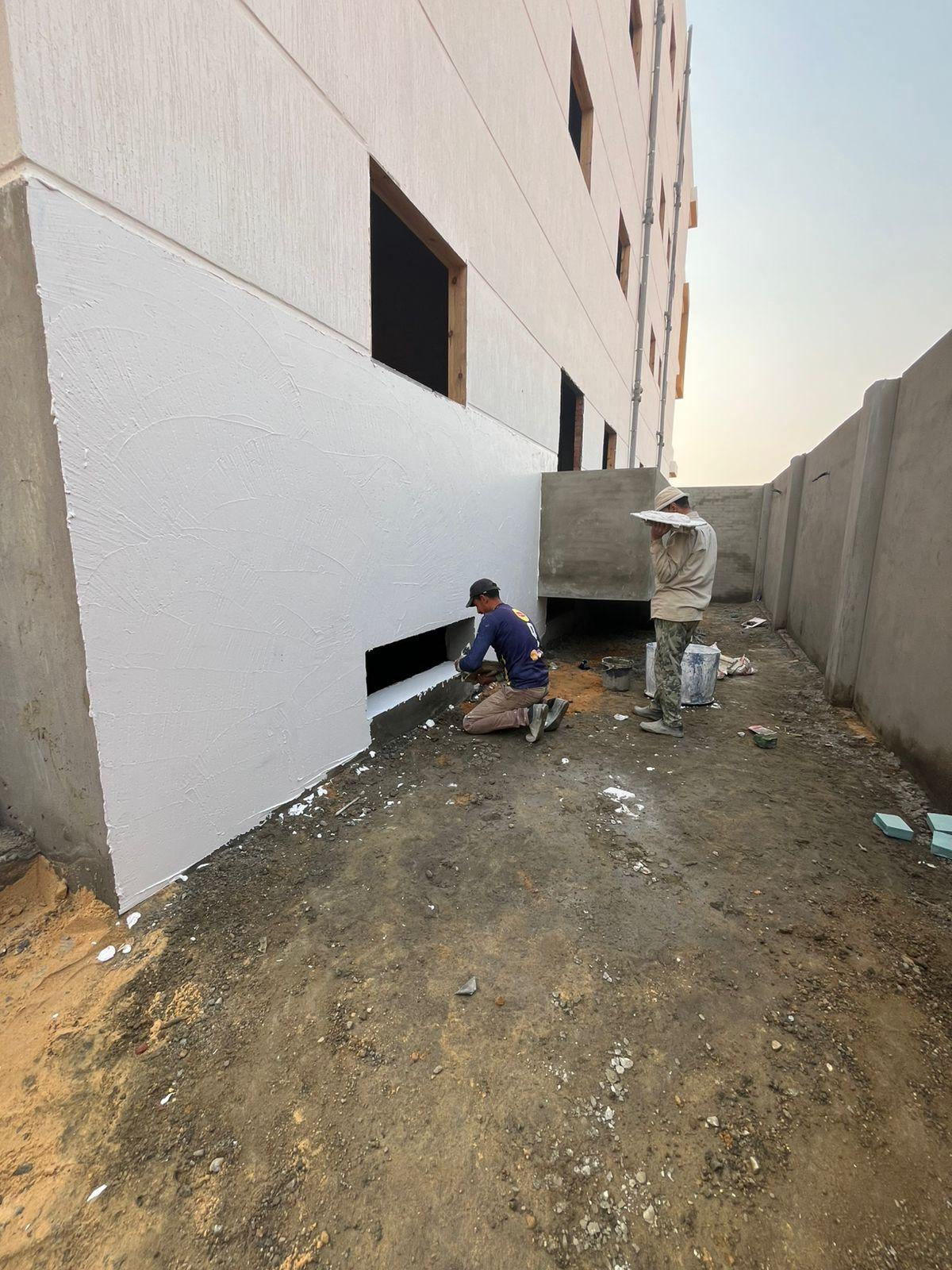

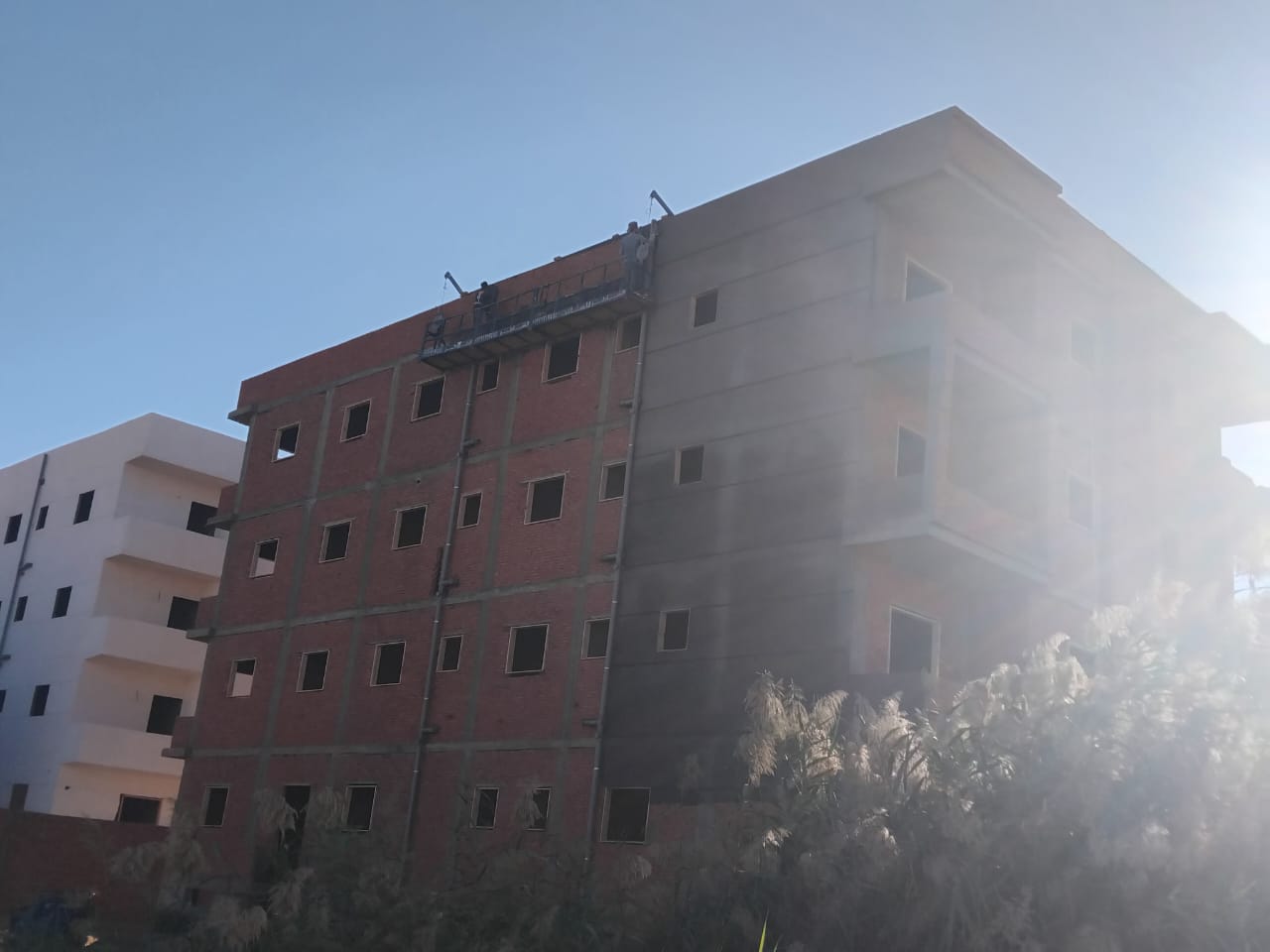

Plaster and putty

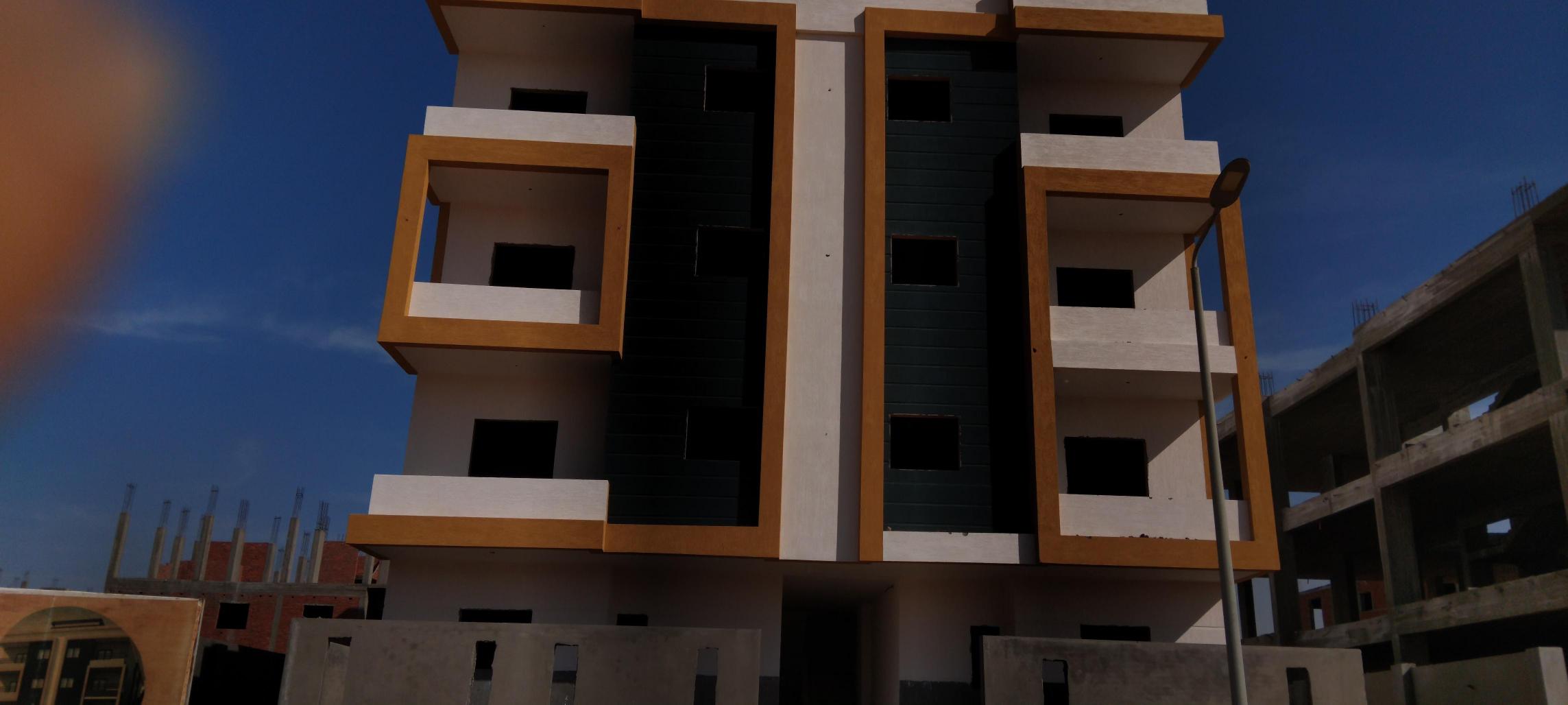

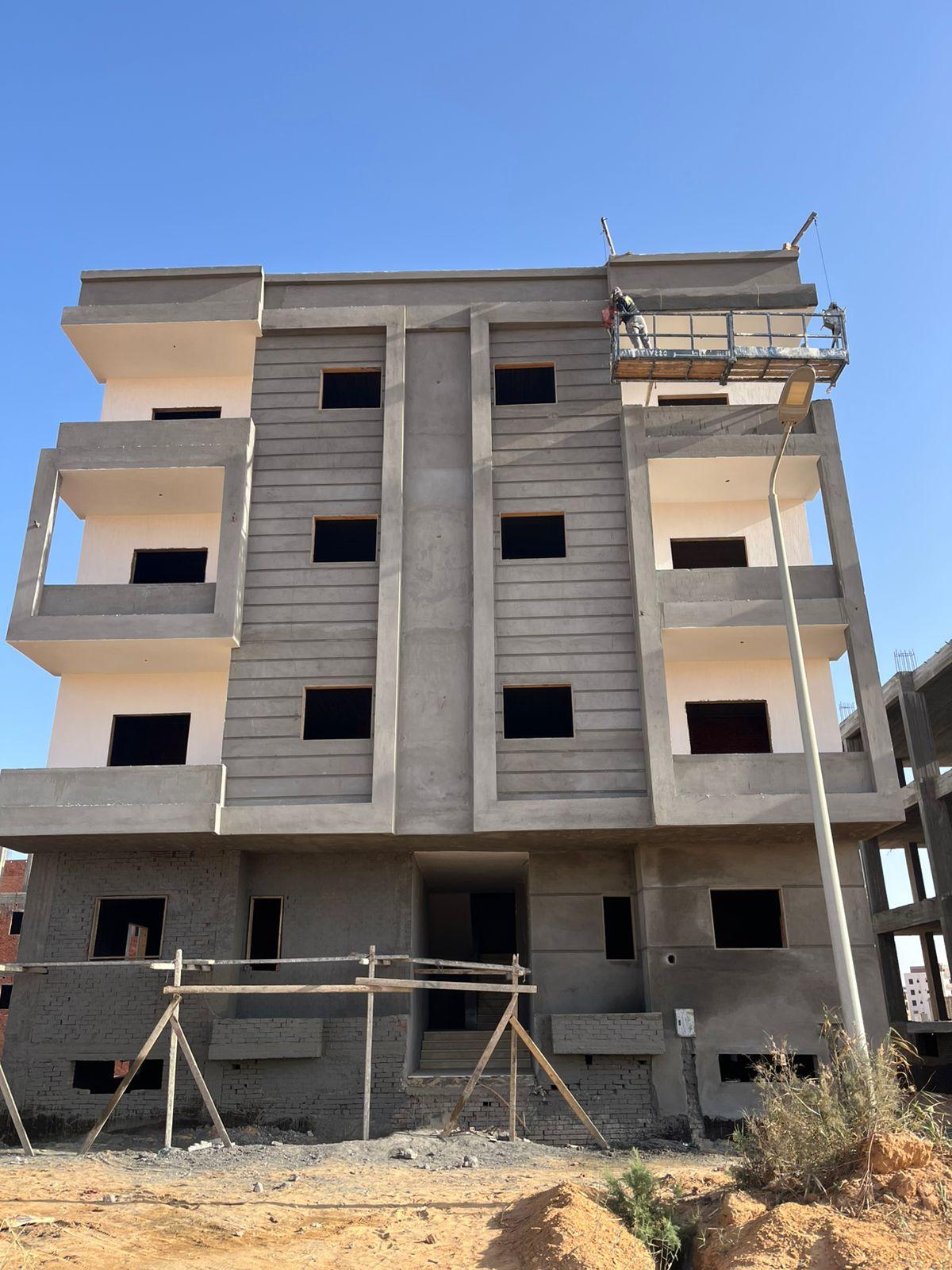

December 31, 2025

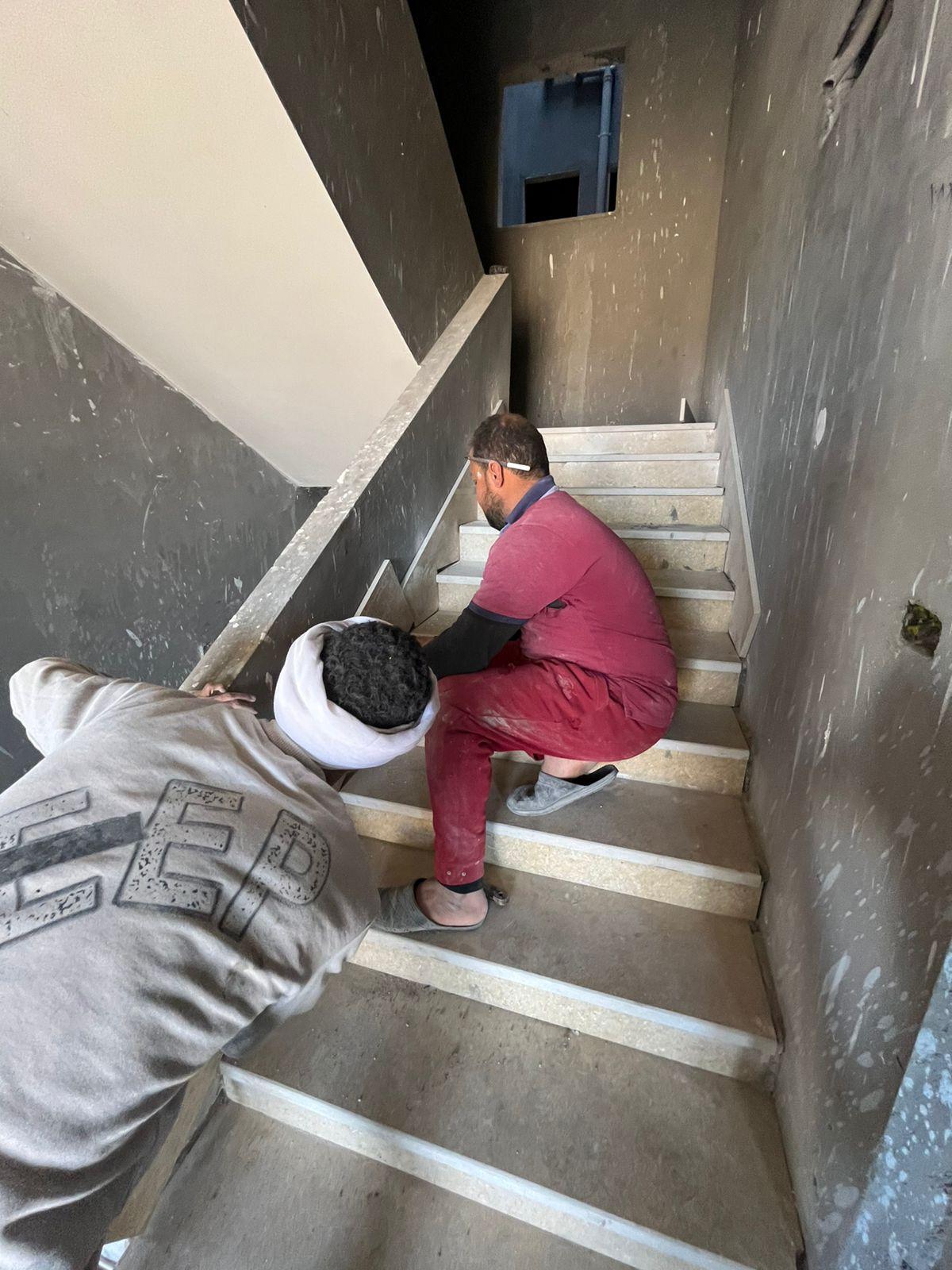

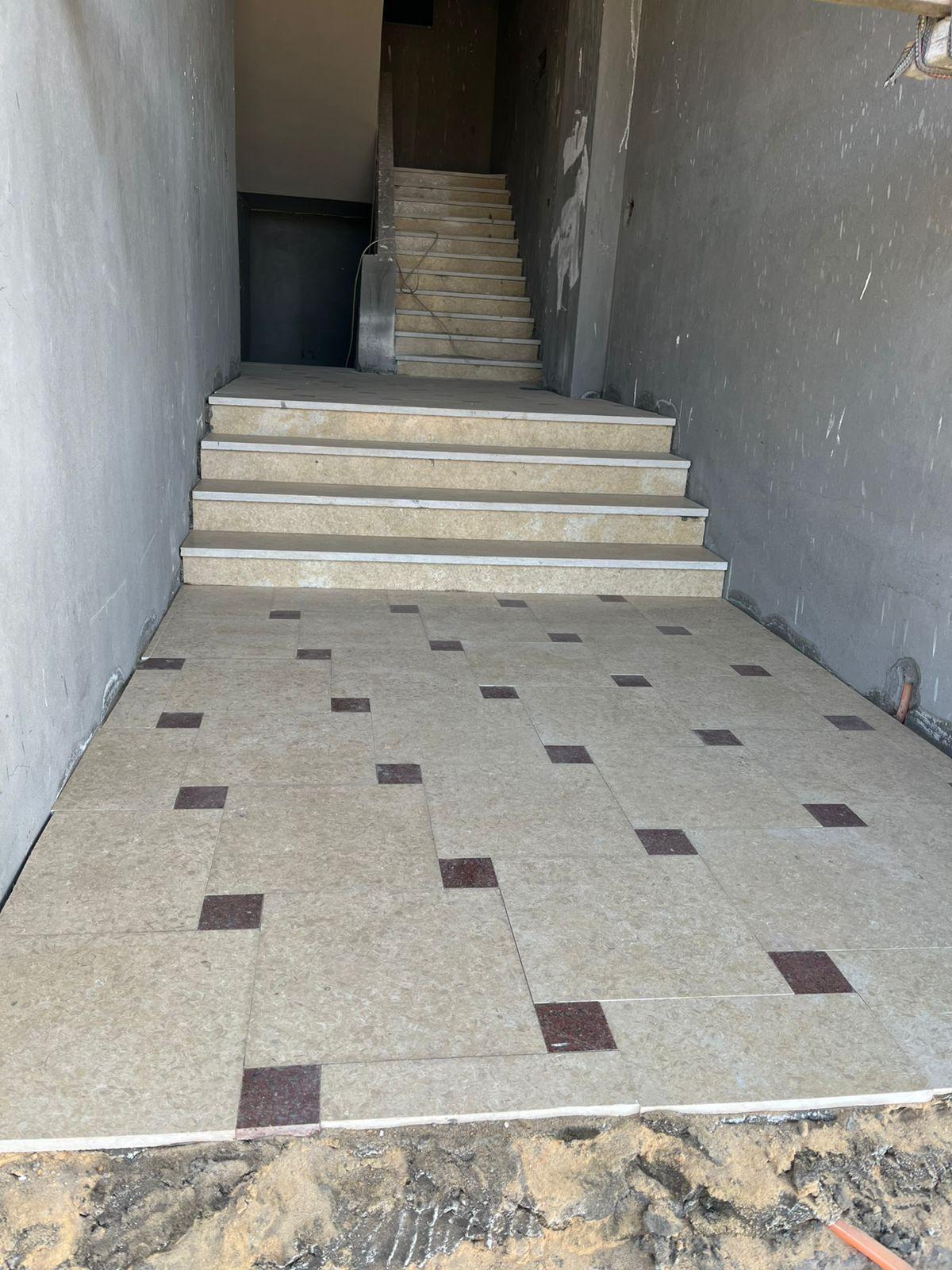

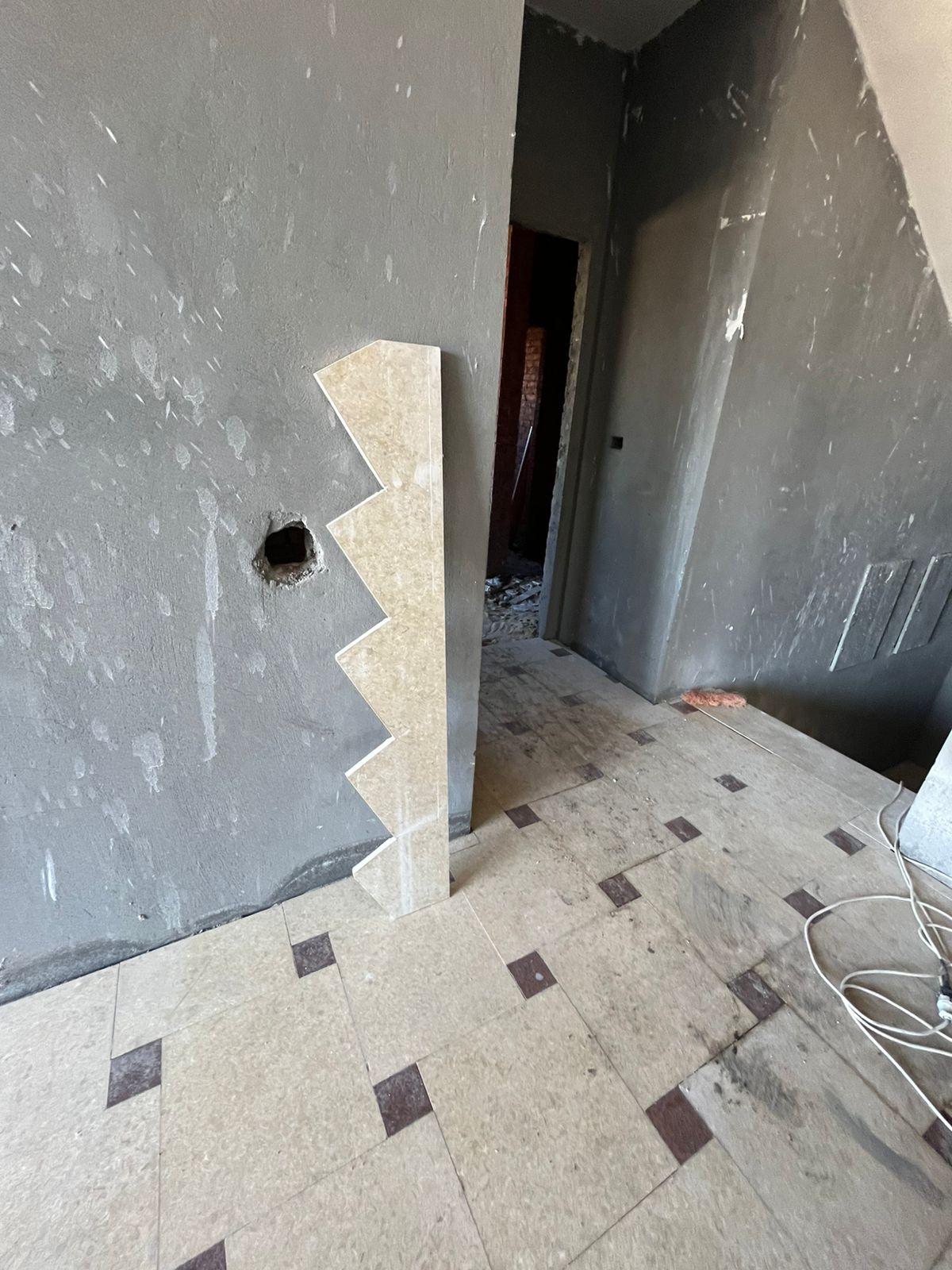

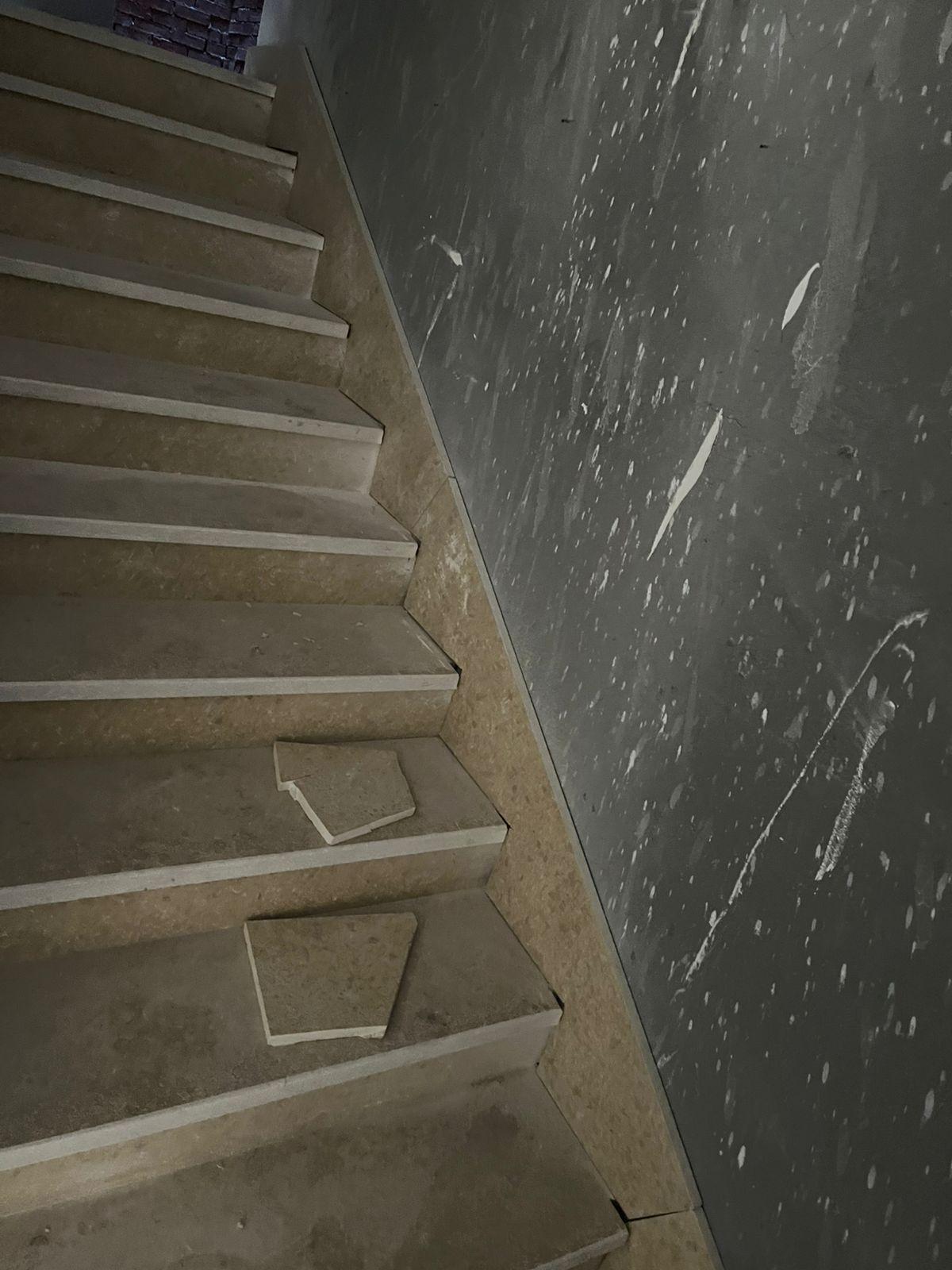

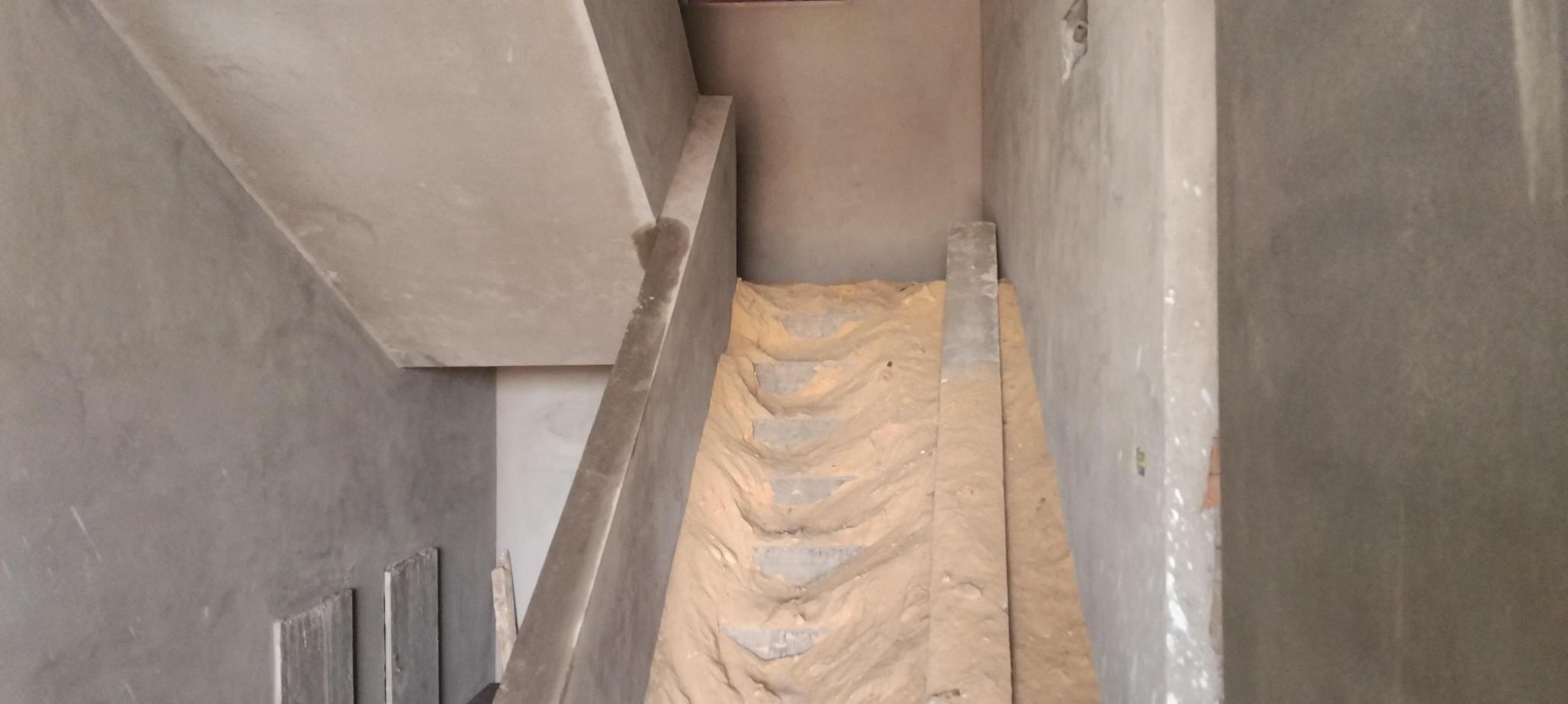

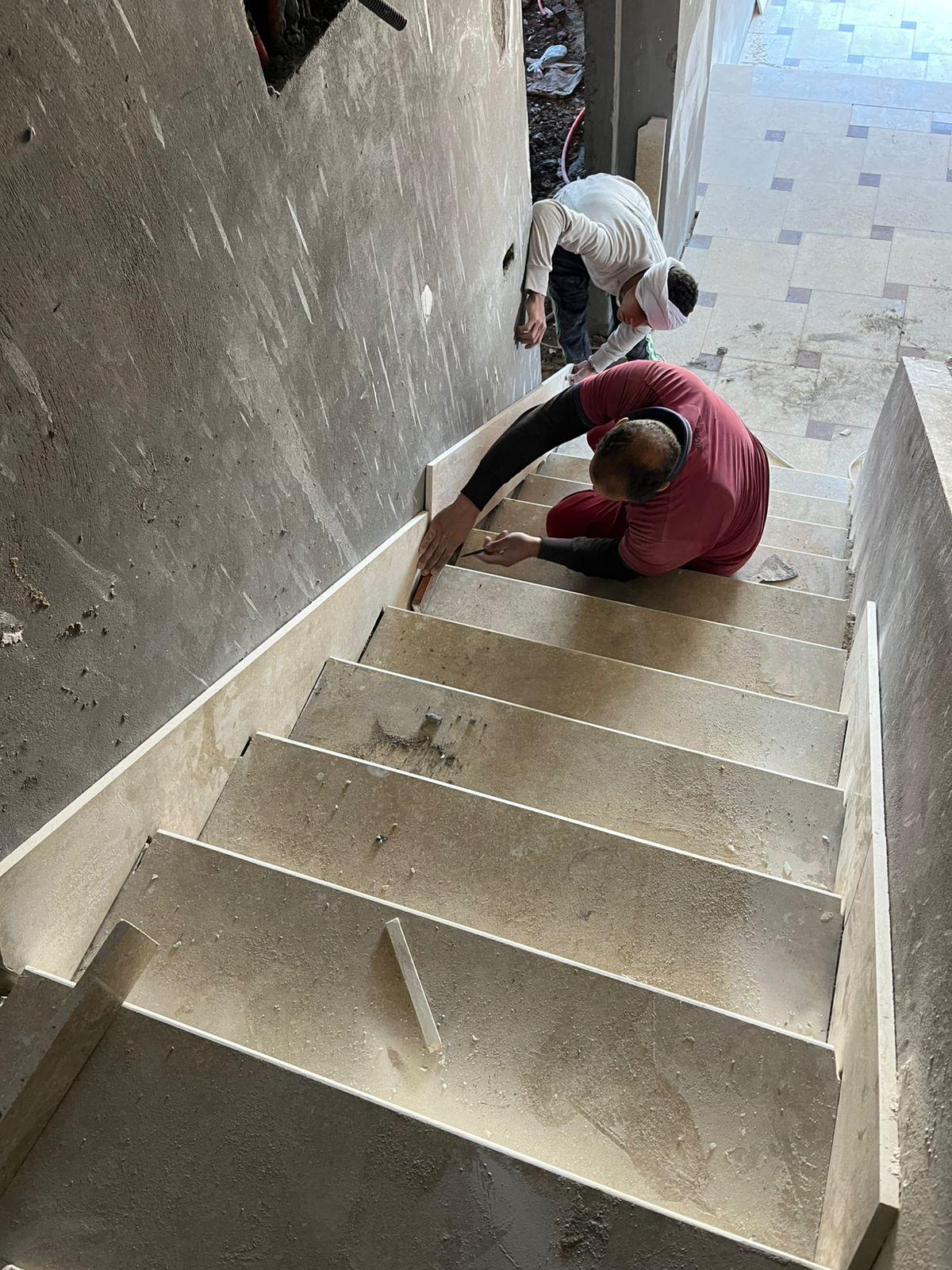

Marble works

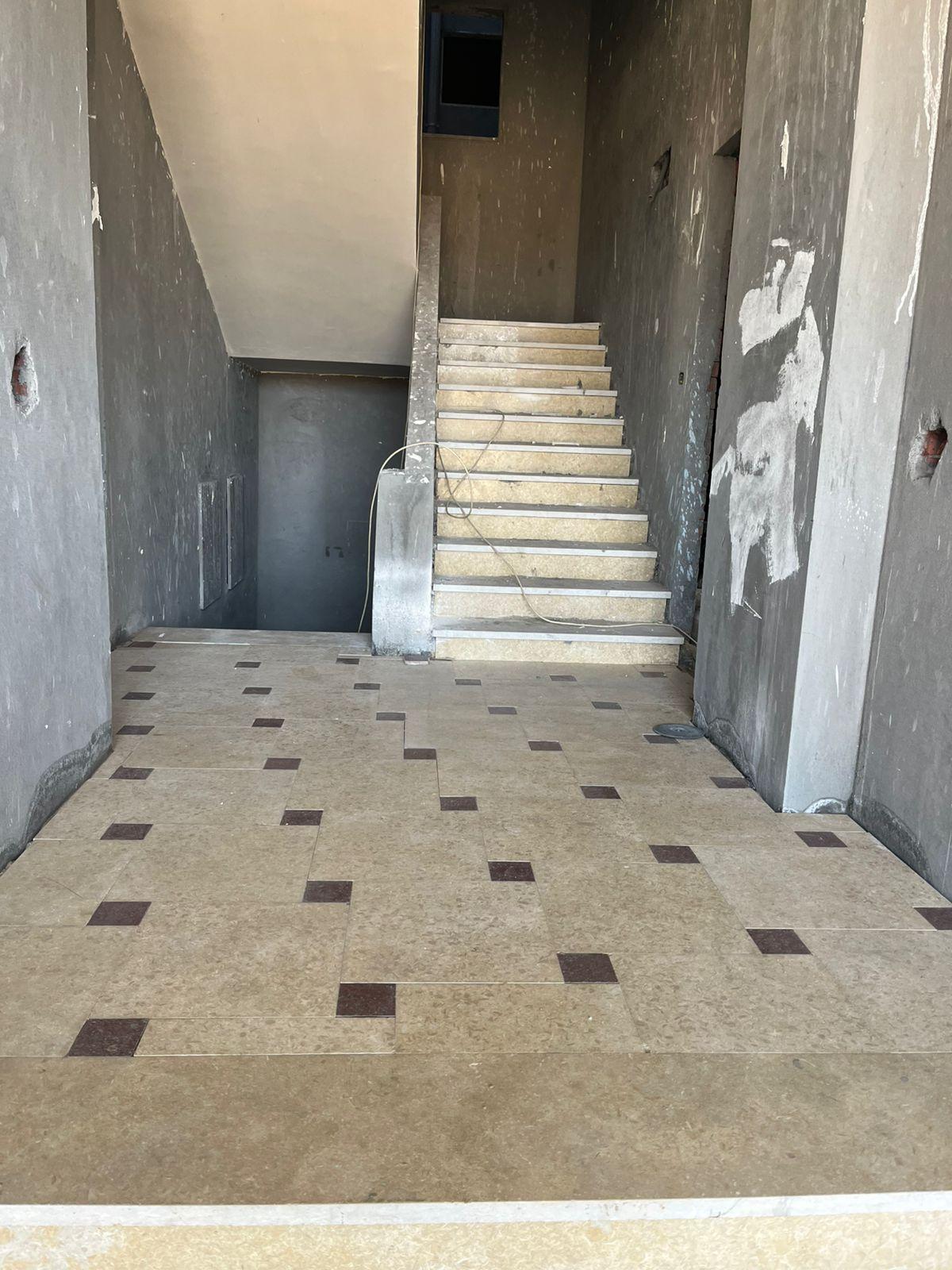

February 1, 2026
Elevator
March 1, 2026
Project handover to the authority
June 1, 2026
Utilities meter installation
July 1, 2026
