Project Details
Land Number
744
Region
The Area 21, El Sadat City
HOMEi Price
2,999.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
| 2 |
|
- | Finished |
| 3 |
|
- | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 25% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
128 m²
Delivery
Unit Delivery Date
April 2025
Average Unit Price
438,683 EGP
Project Location
Map View
The Area 21, El Sadat City
HOMEi Timeline
License office contract
January 5, 2023

Building permit

January 15, 2023
Extracting a Building water meter
January 17, 2023
Obtaining a construction insurance certificate
January 22, 2023

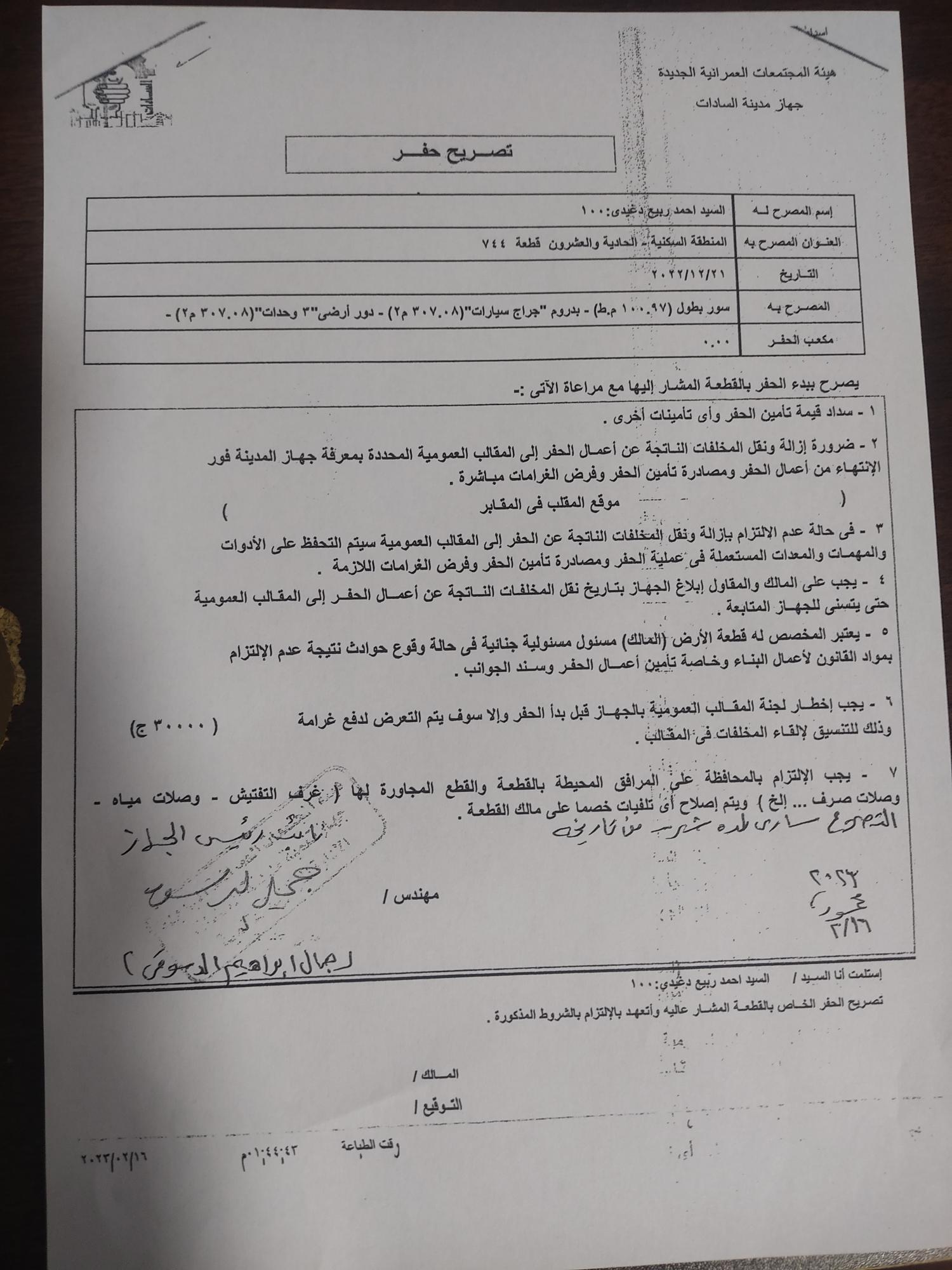

Excavation permit
January 27, 2023
Mining permit
January 28, 2023
Construction contract in progress
January 29, 2023
Construction contract signed
January 30, 2023
Excavation
January 31, 2023

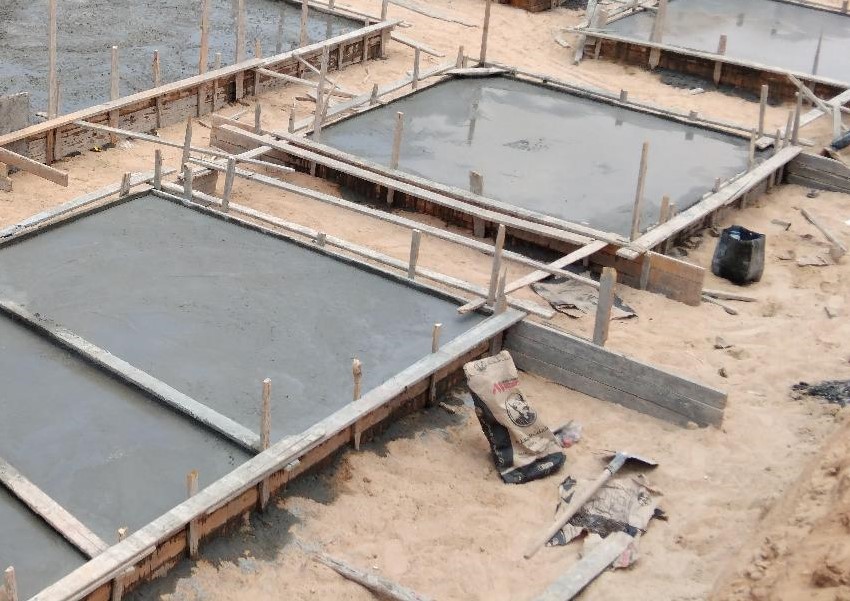

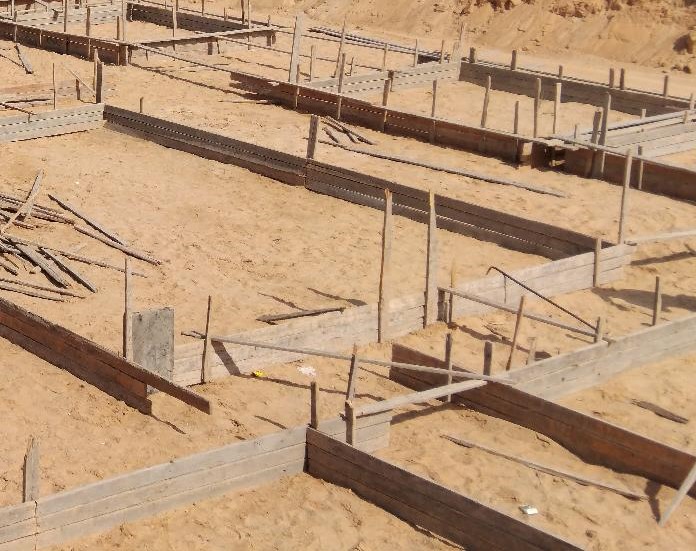

Plain foundations
February 1, 2023
Reinforced foundations
February 5, 2023

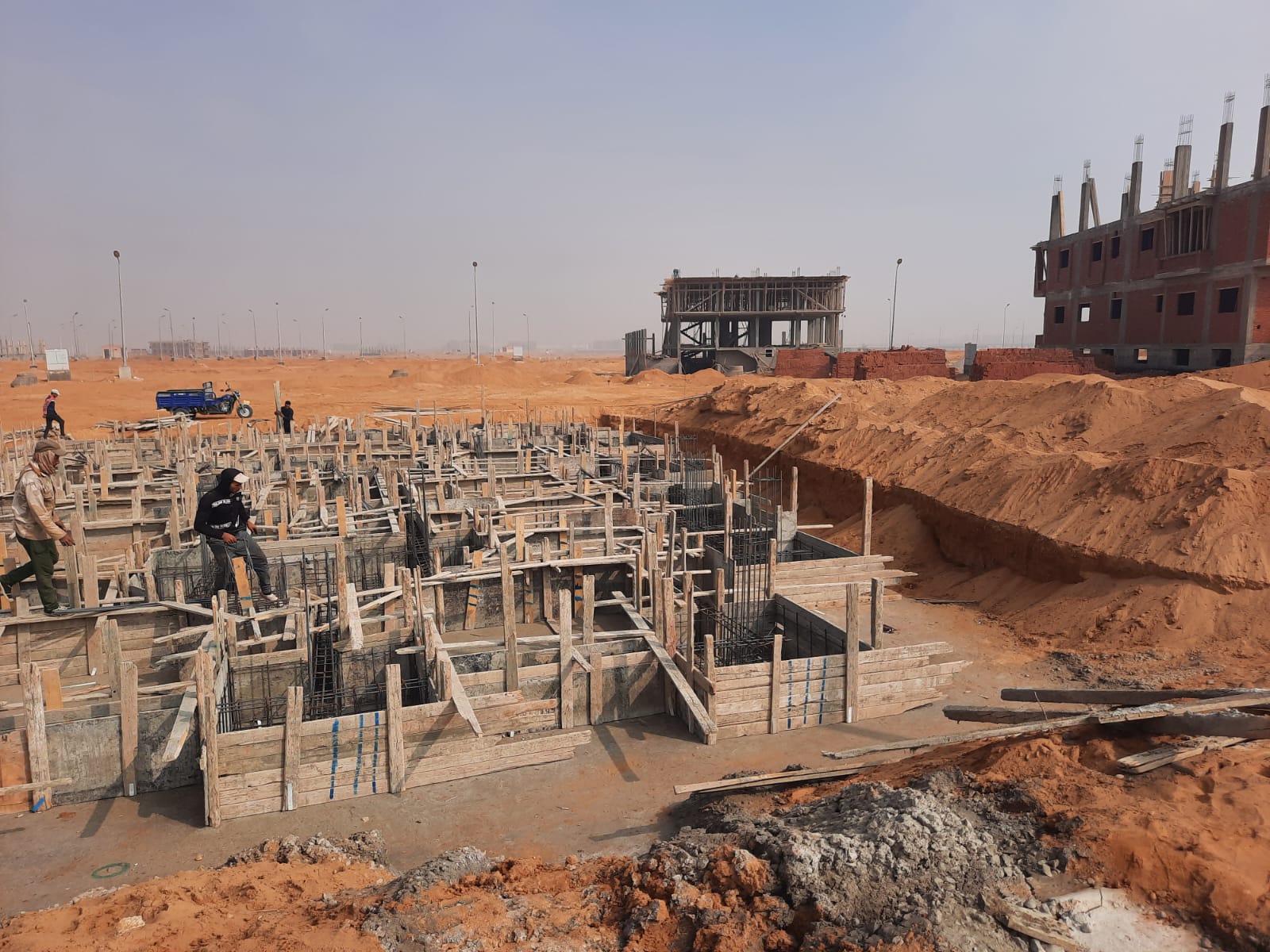

Footings insulation
February 17, 2023

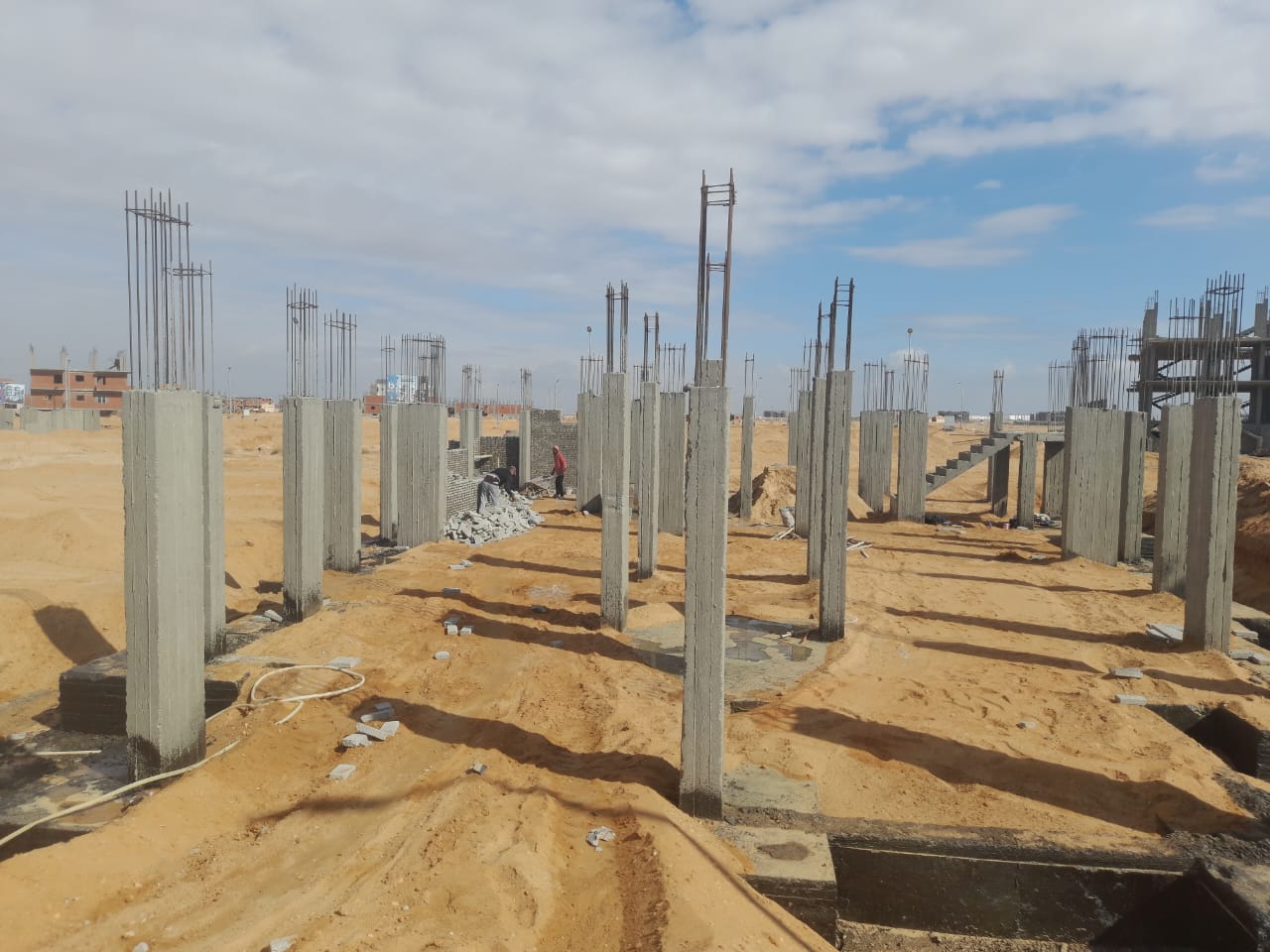

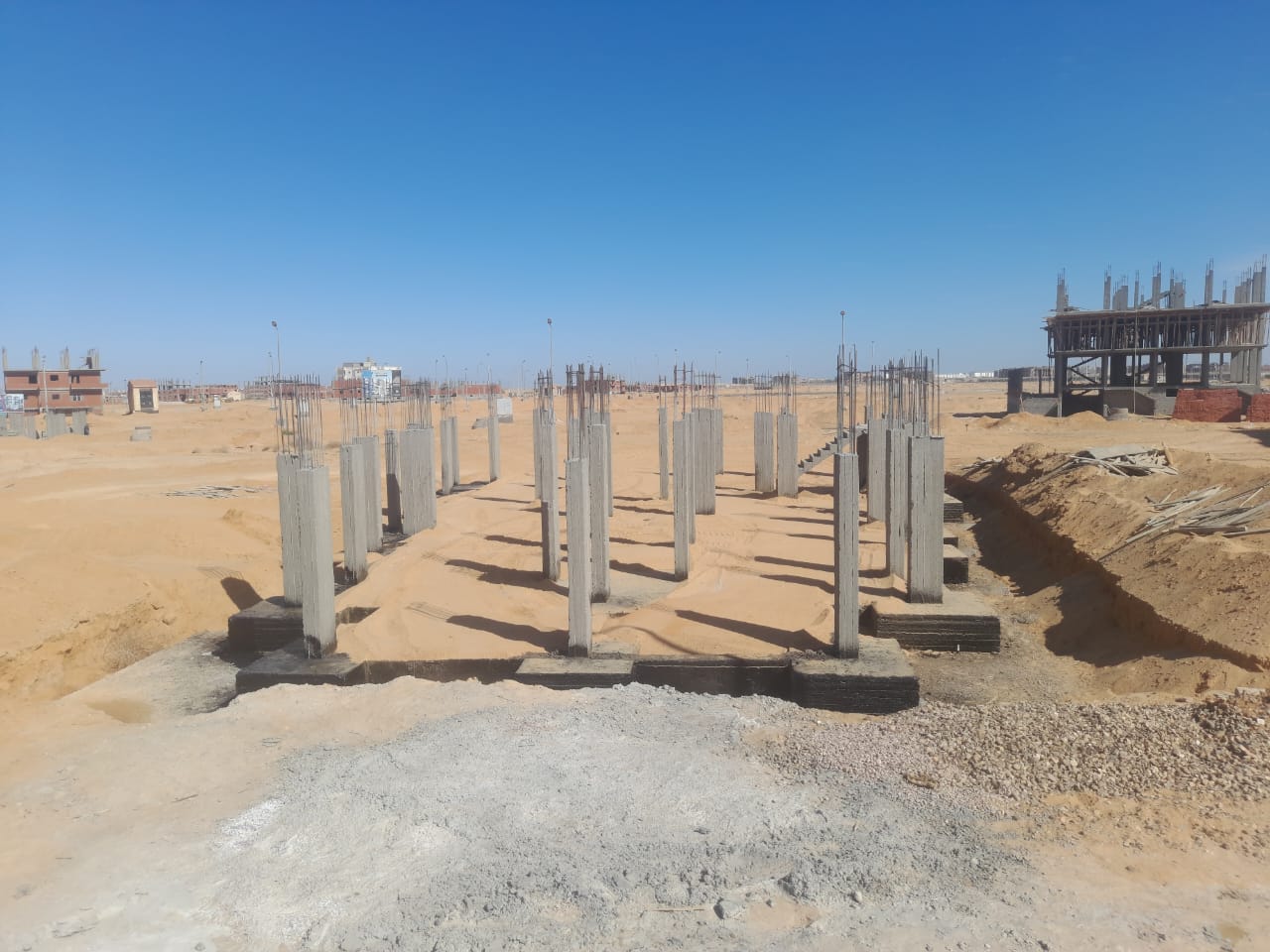

Backfilling over footings
February 18, 2023

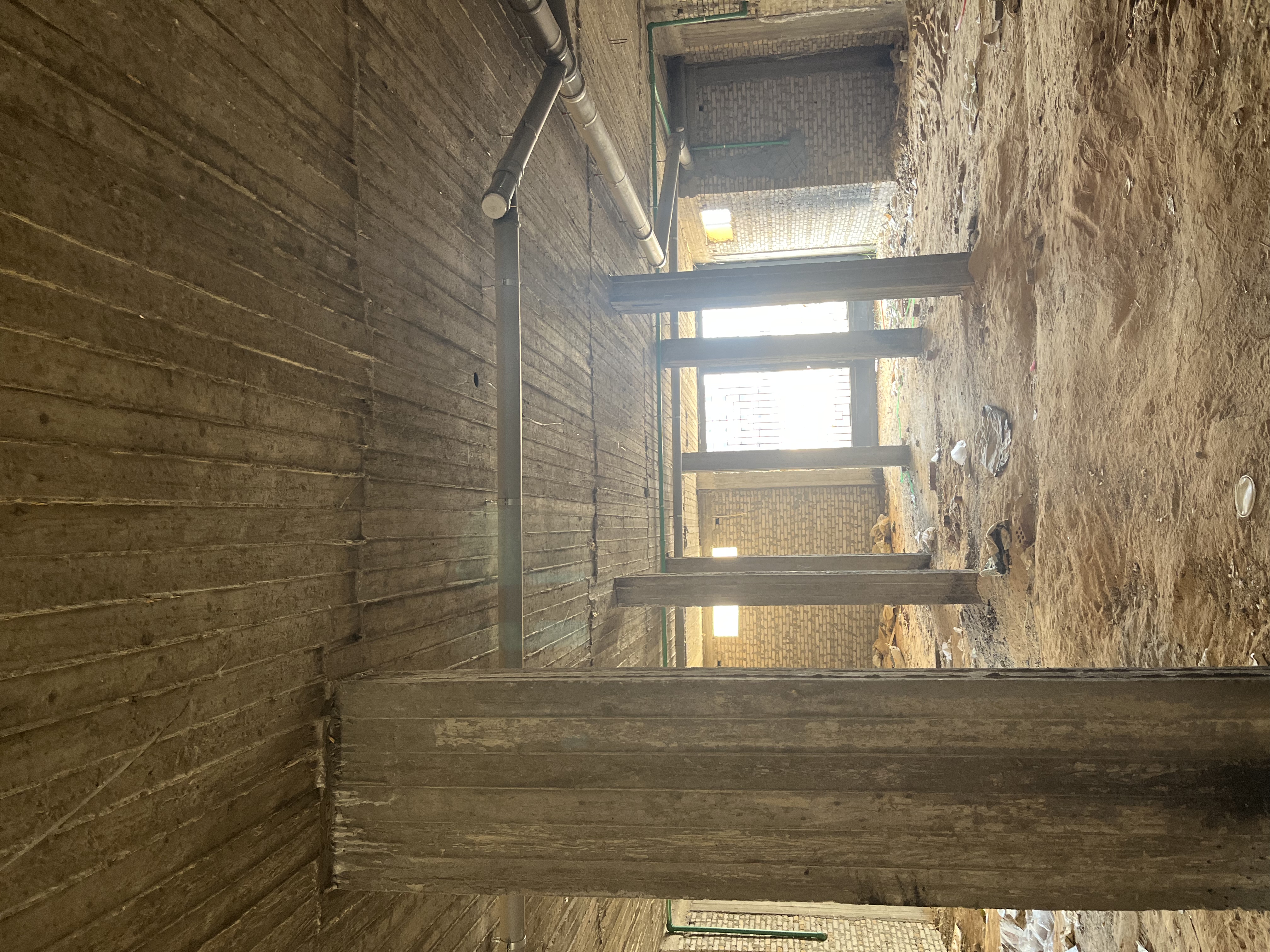

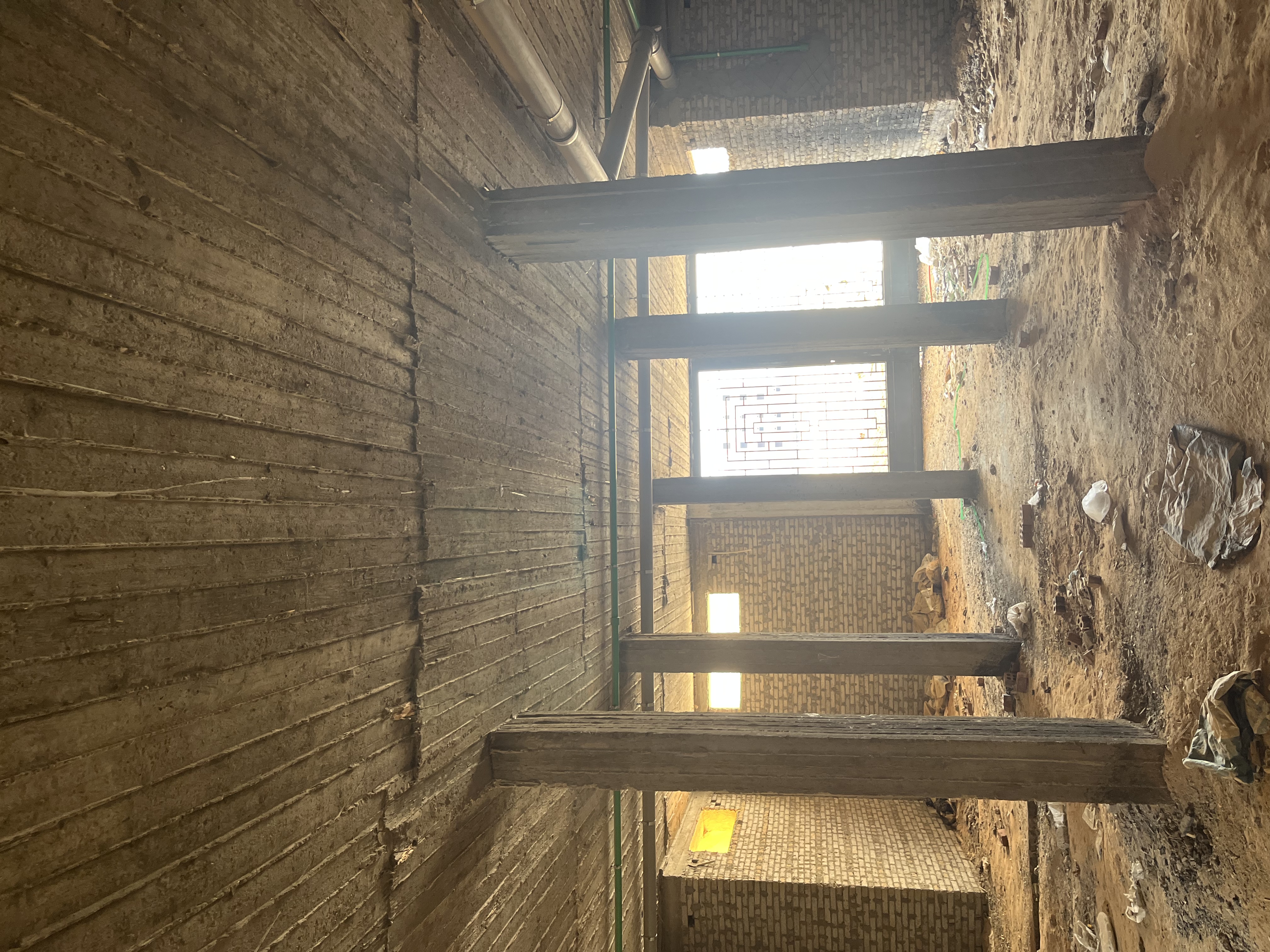

Basement columns

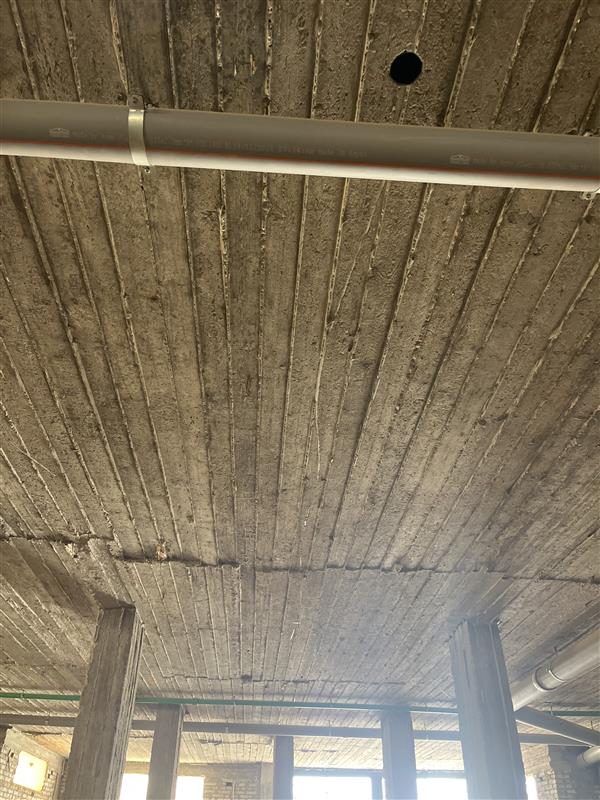

March 13, 2023

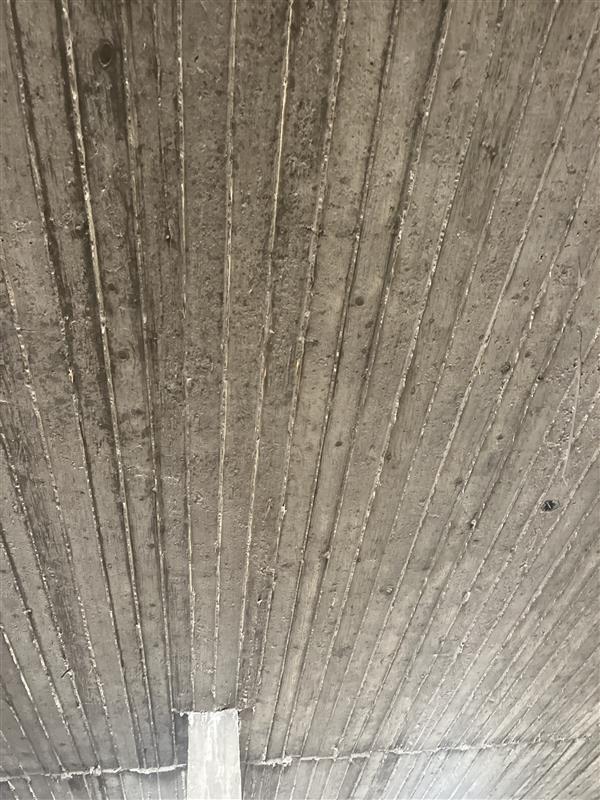

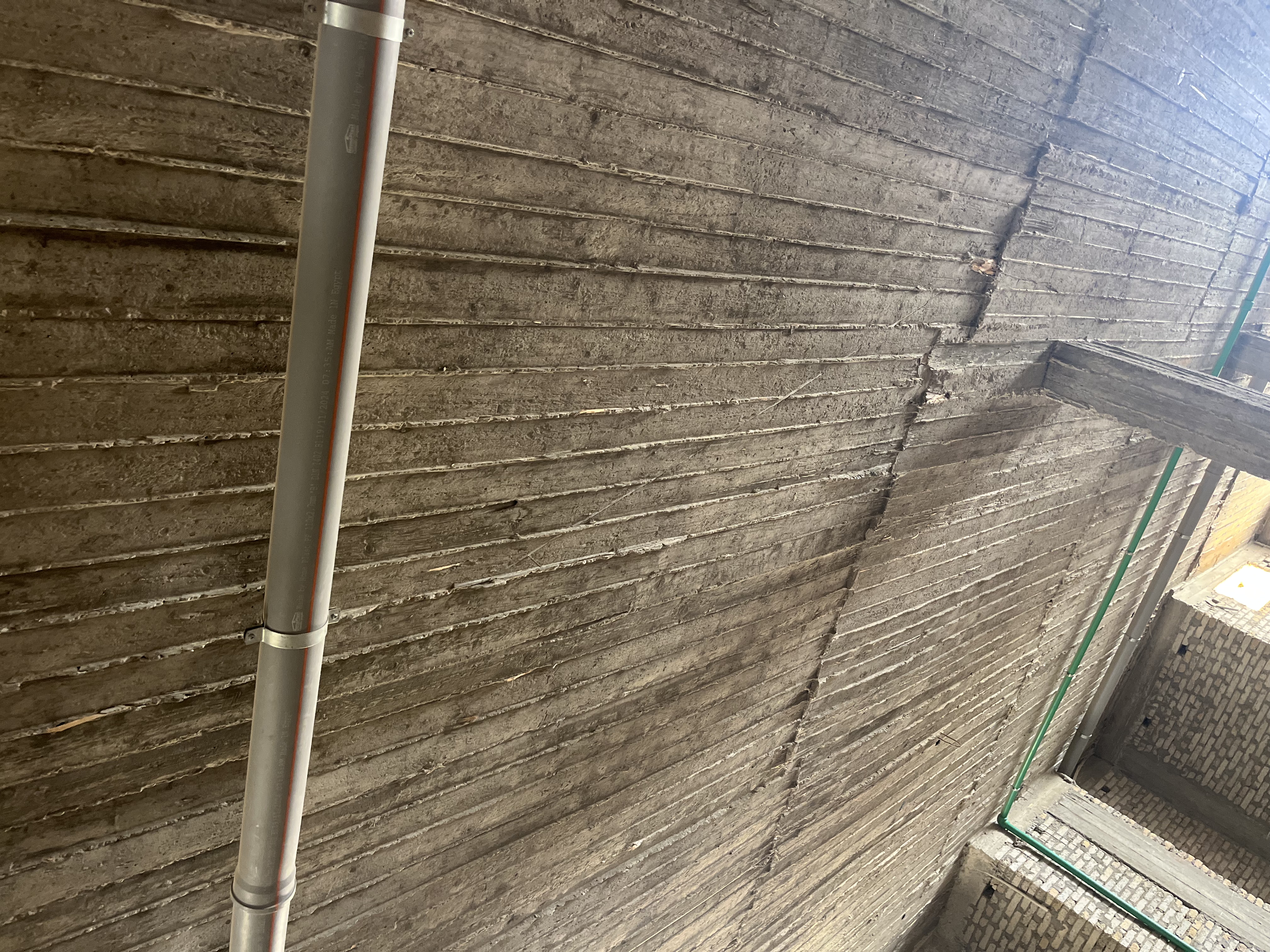

Basement slab
March 15, 2023

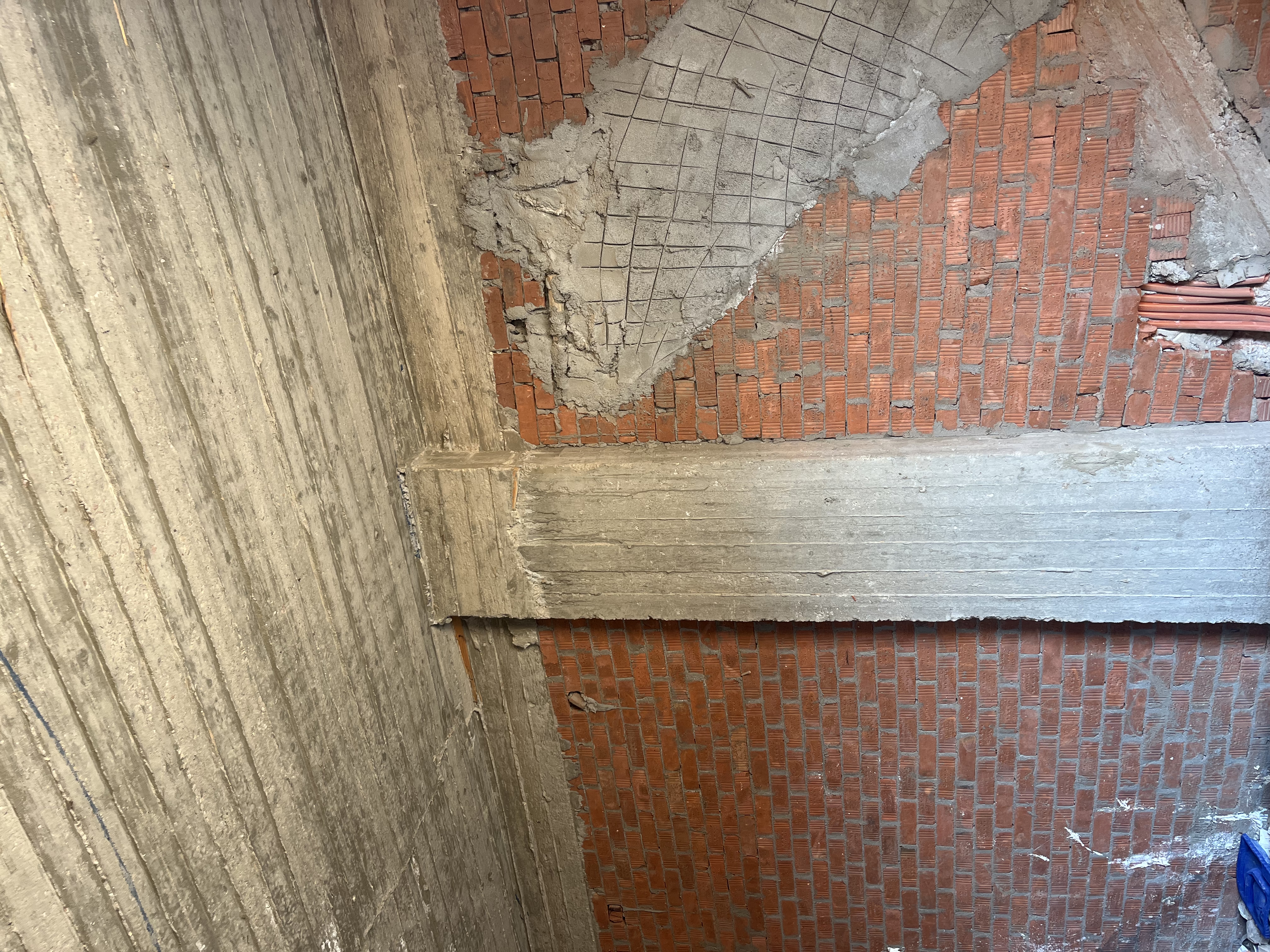

Ground floor columns
March 25, 2023

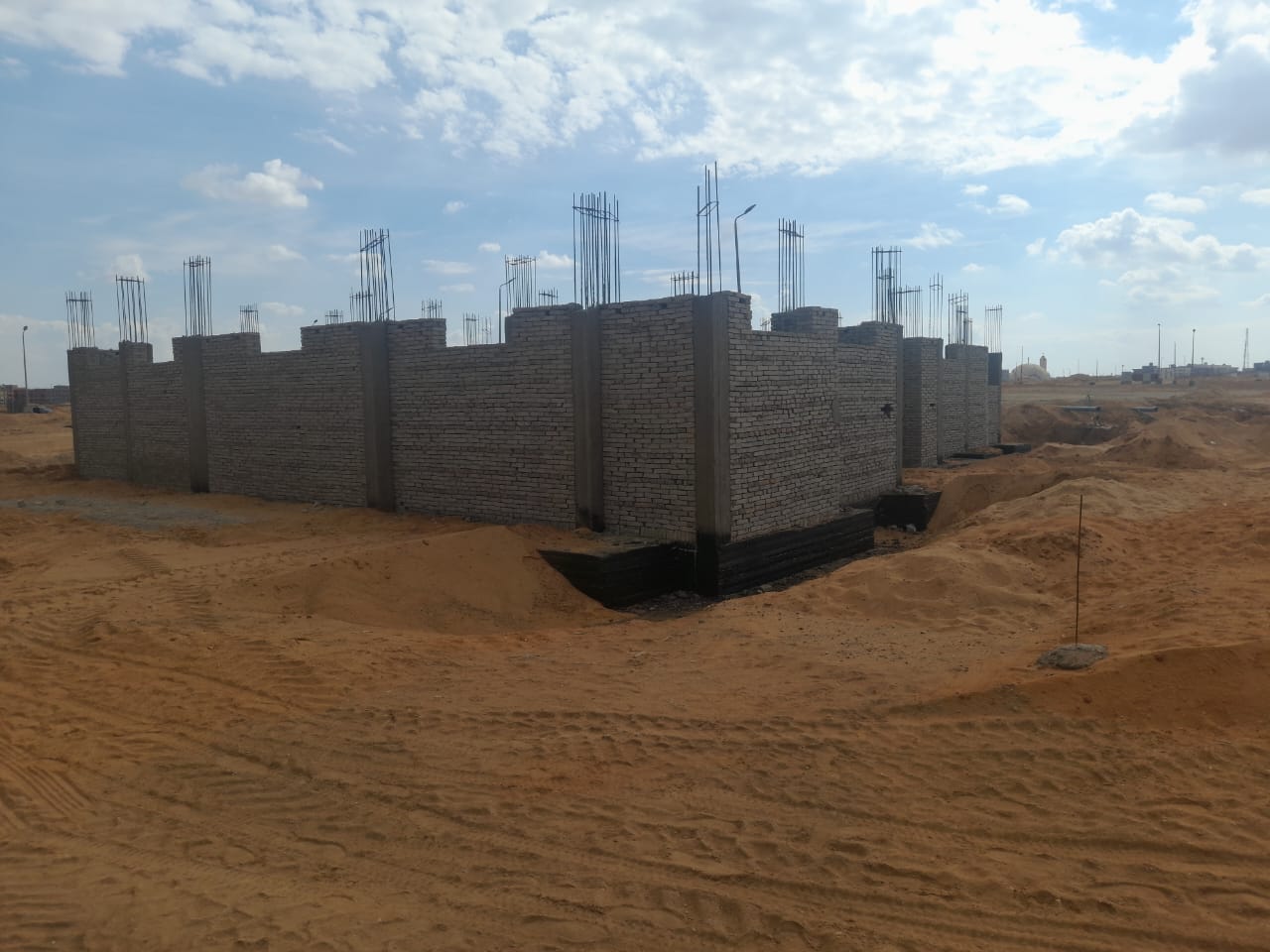

Basement walls

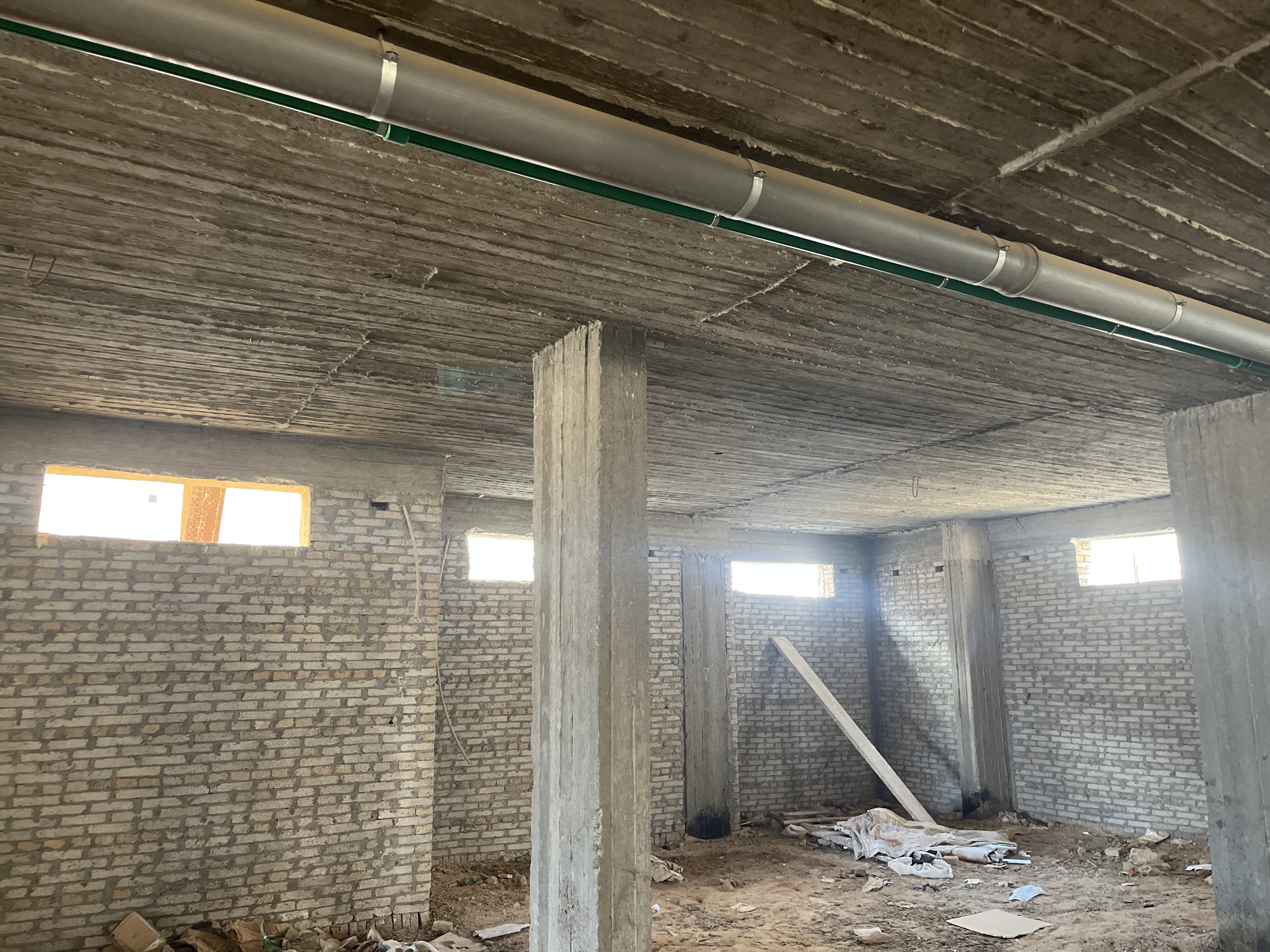

April 1, 2023

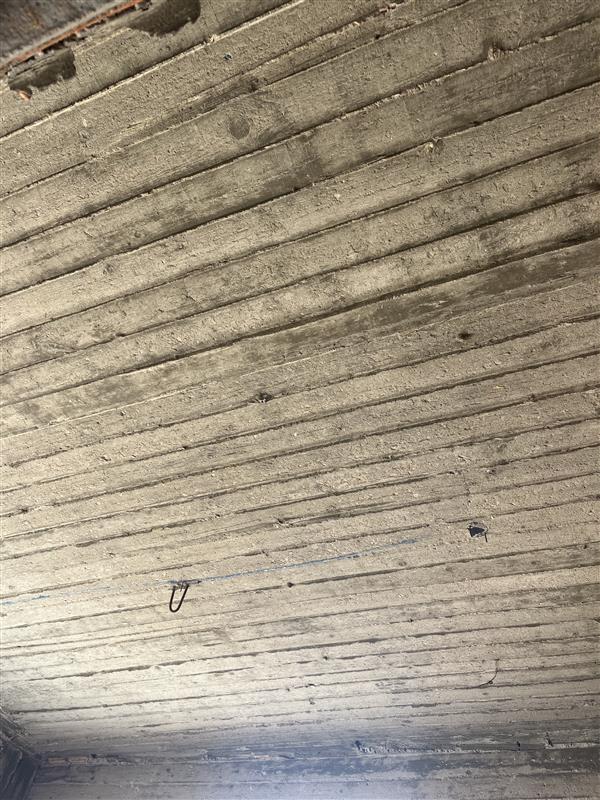

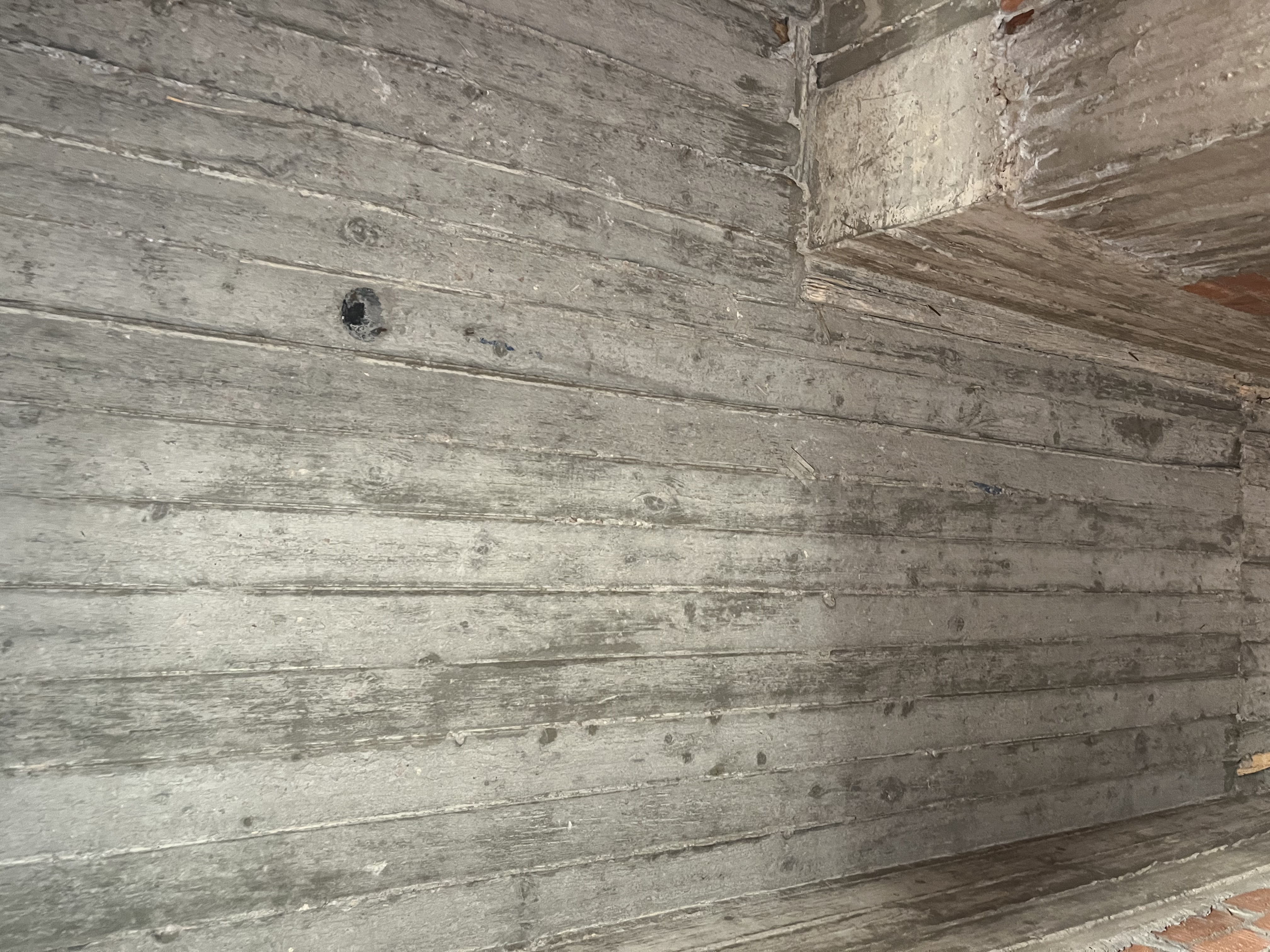

Ground floor slab
April 1, 2023

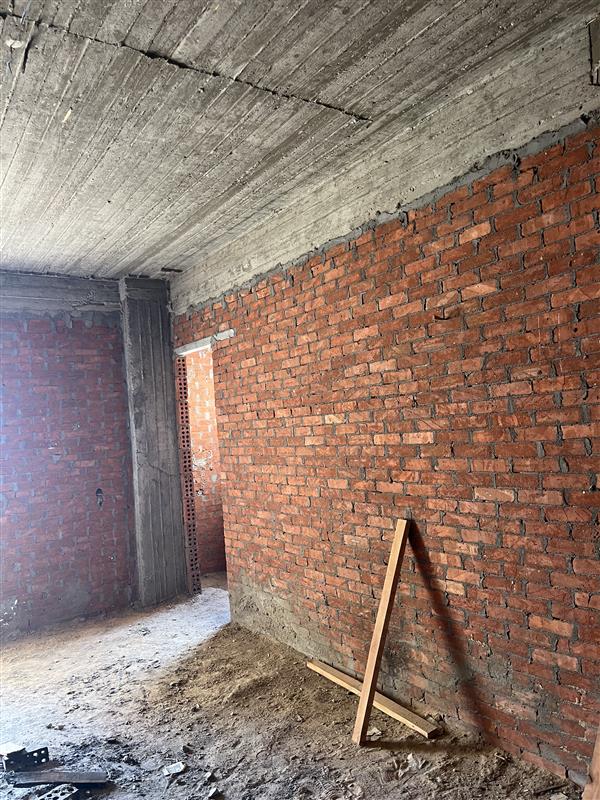

Ground floor walls
April 10, 2023

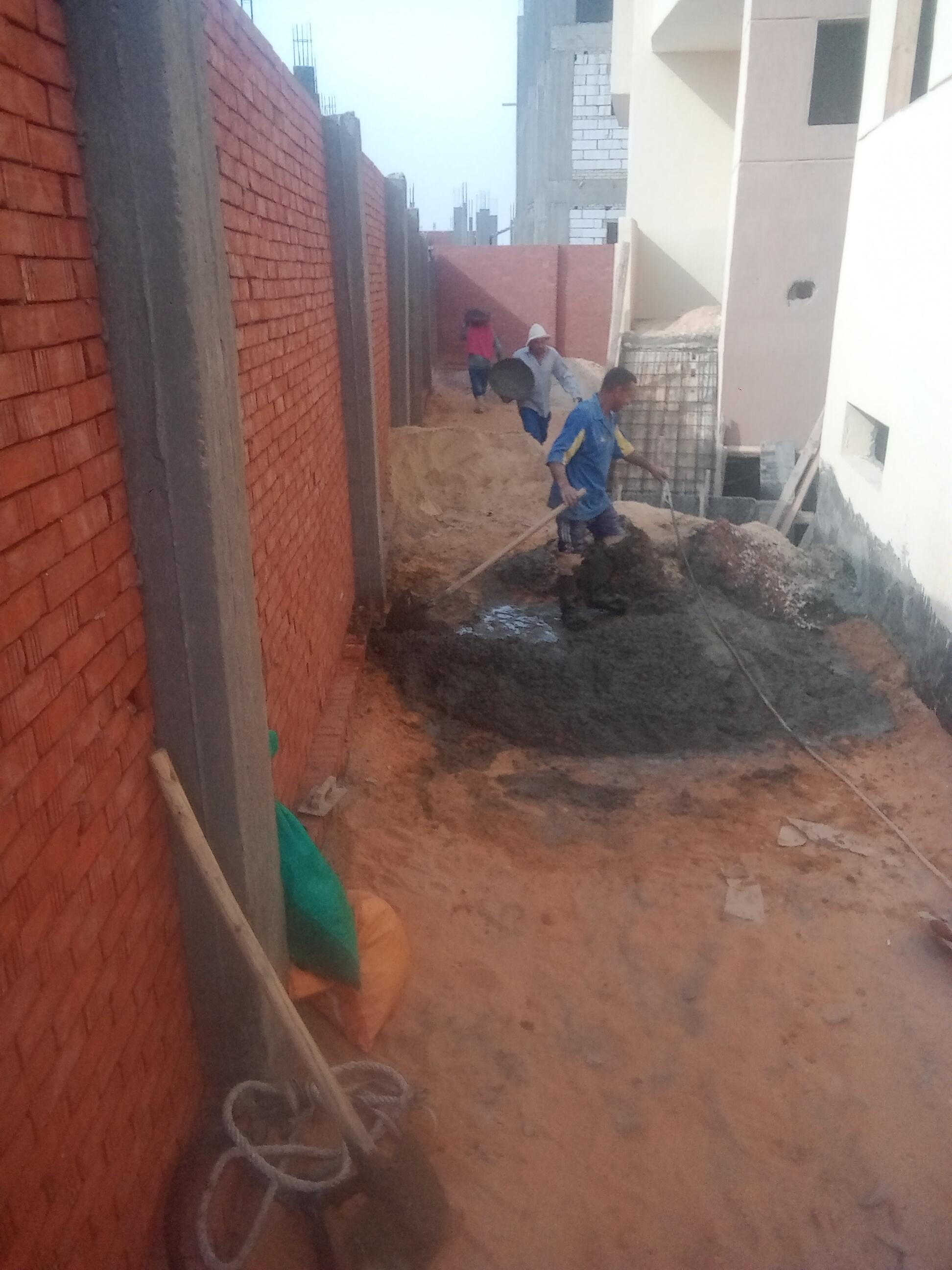

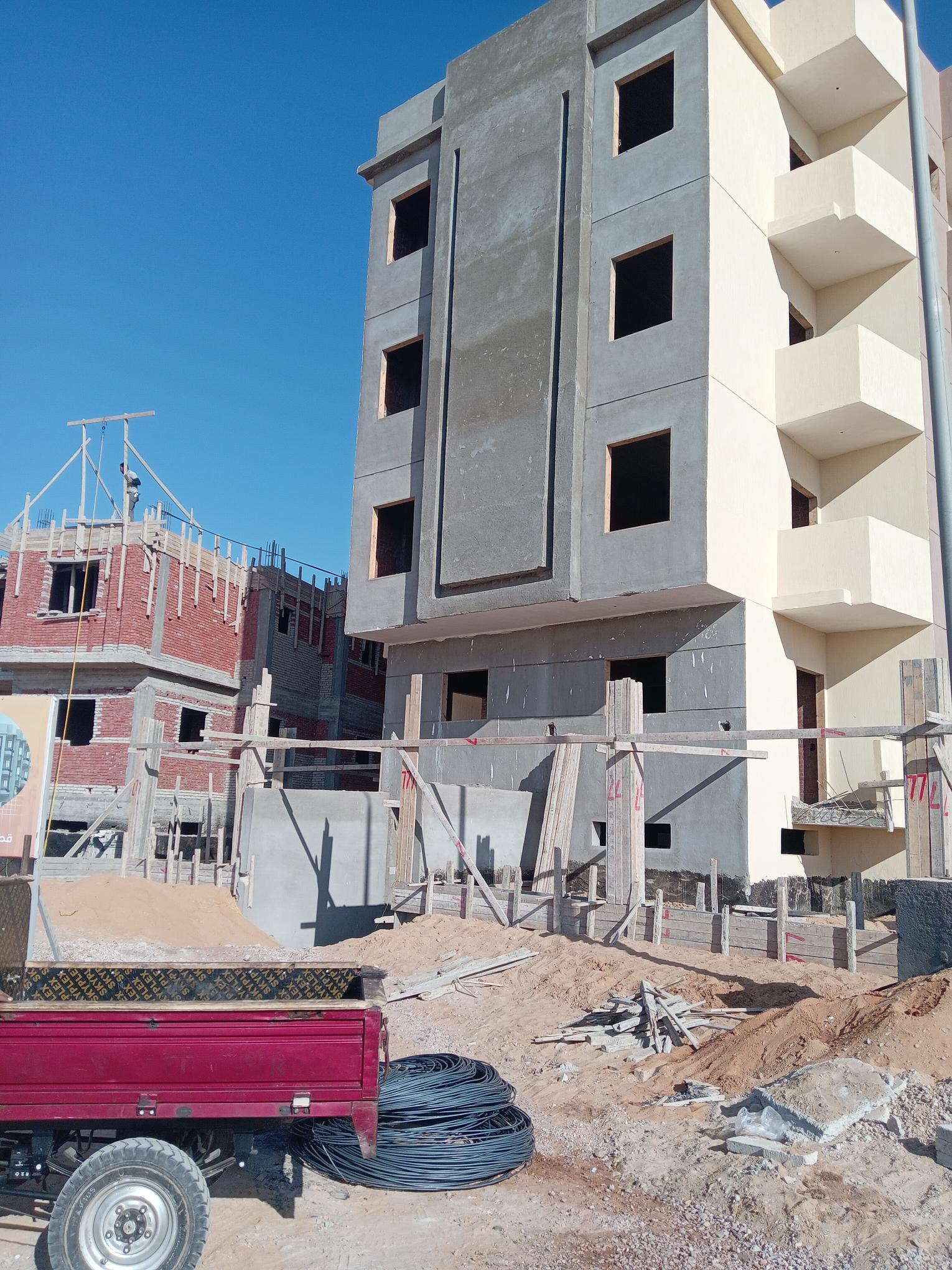

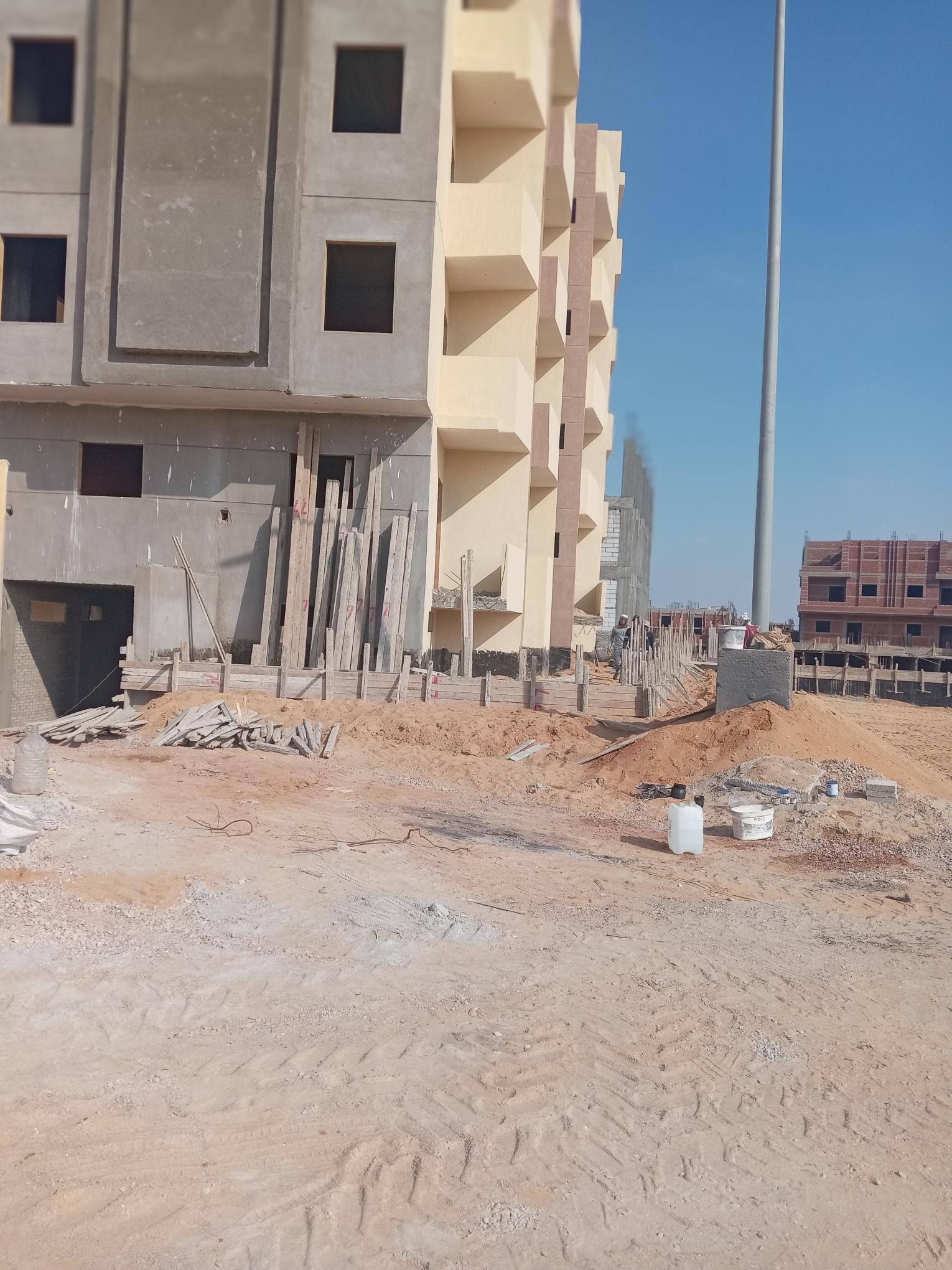

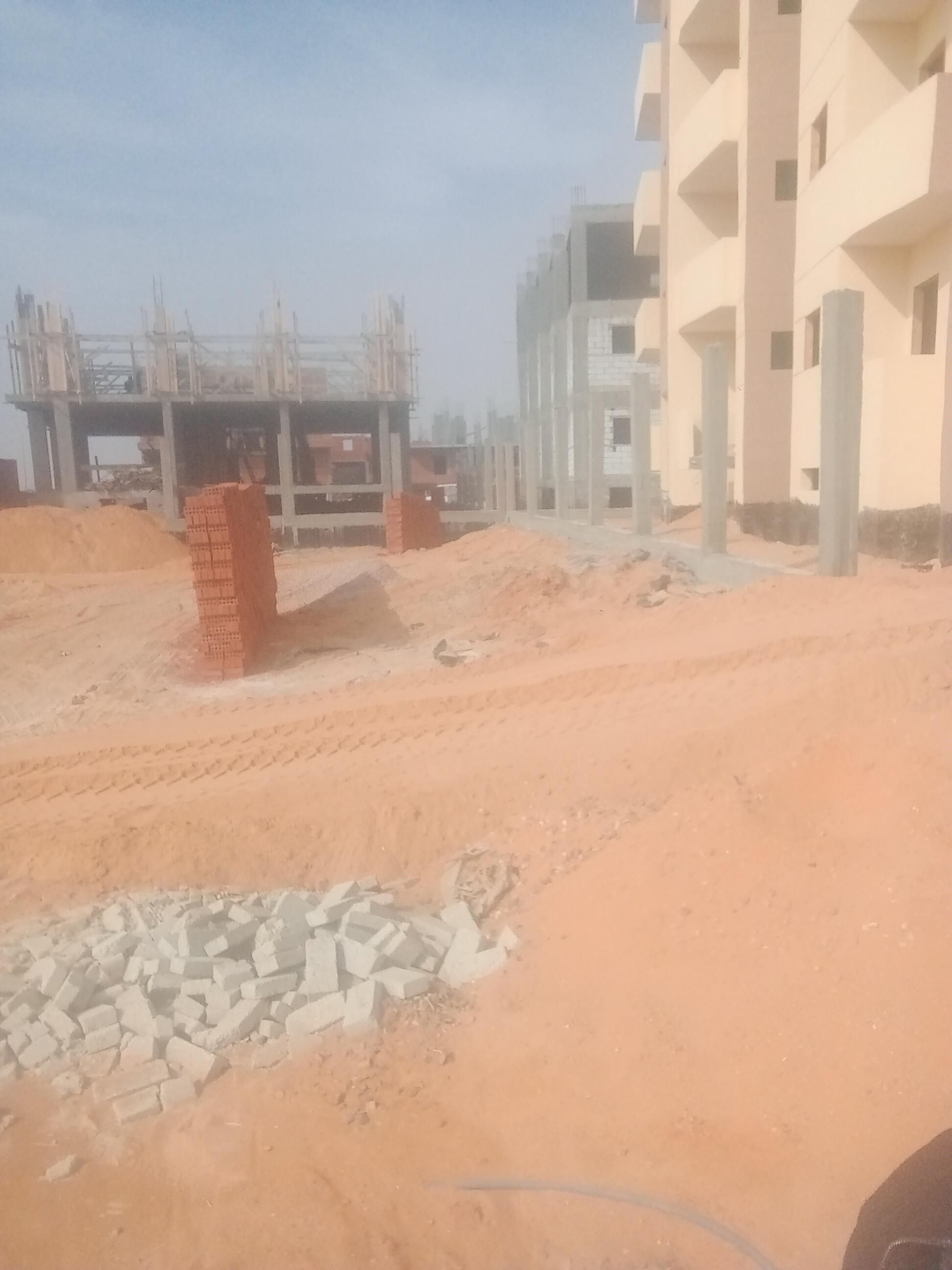

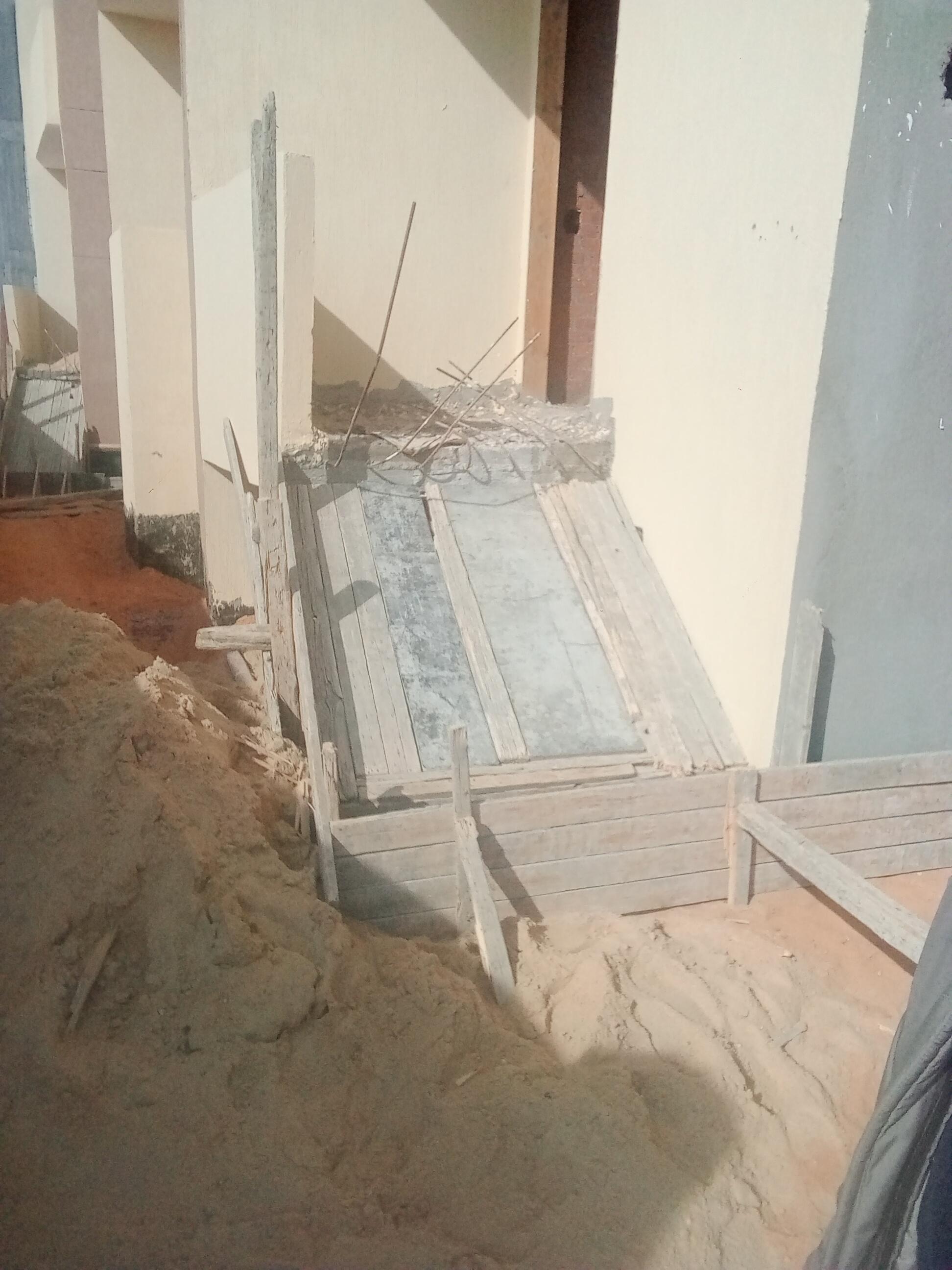

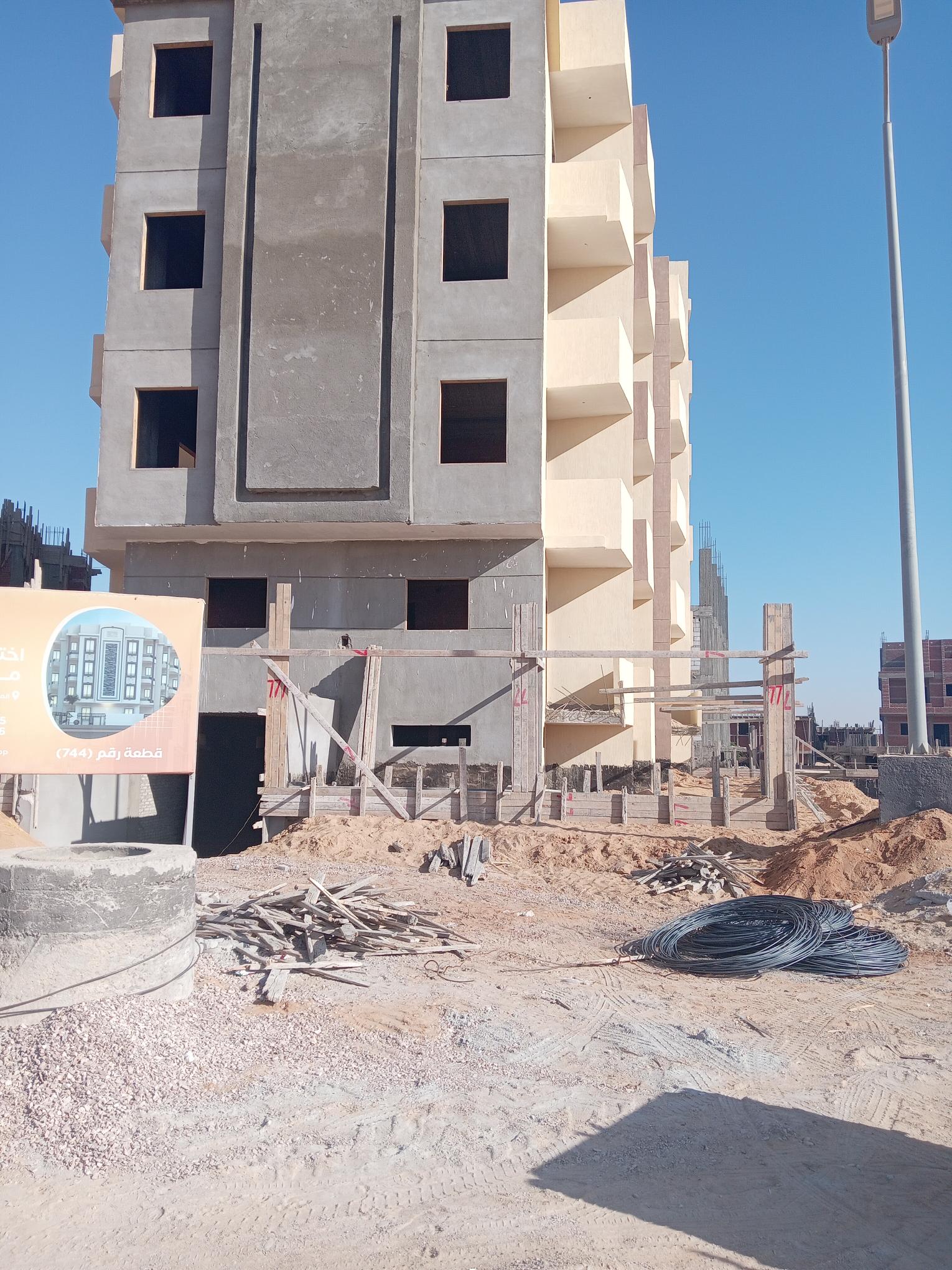

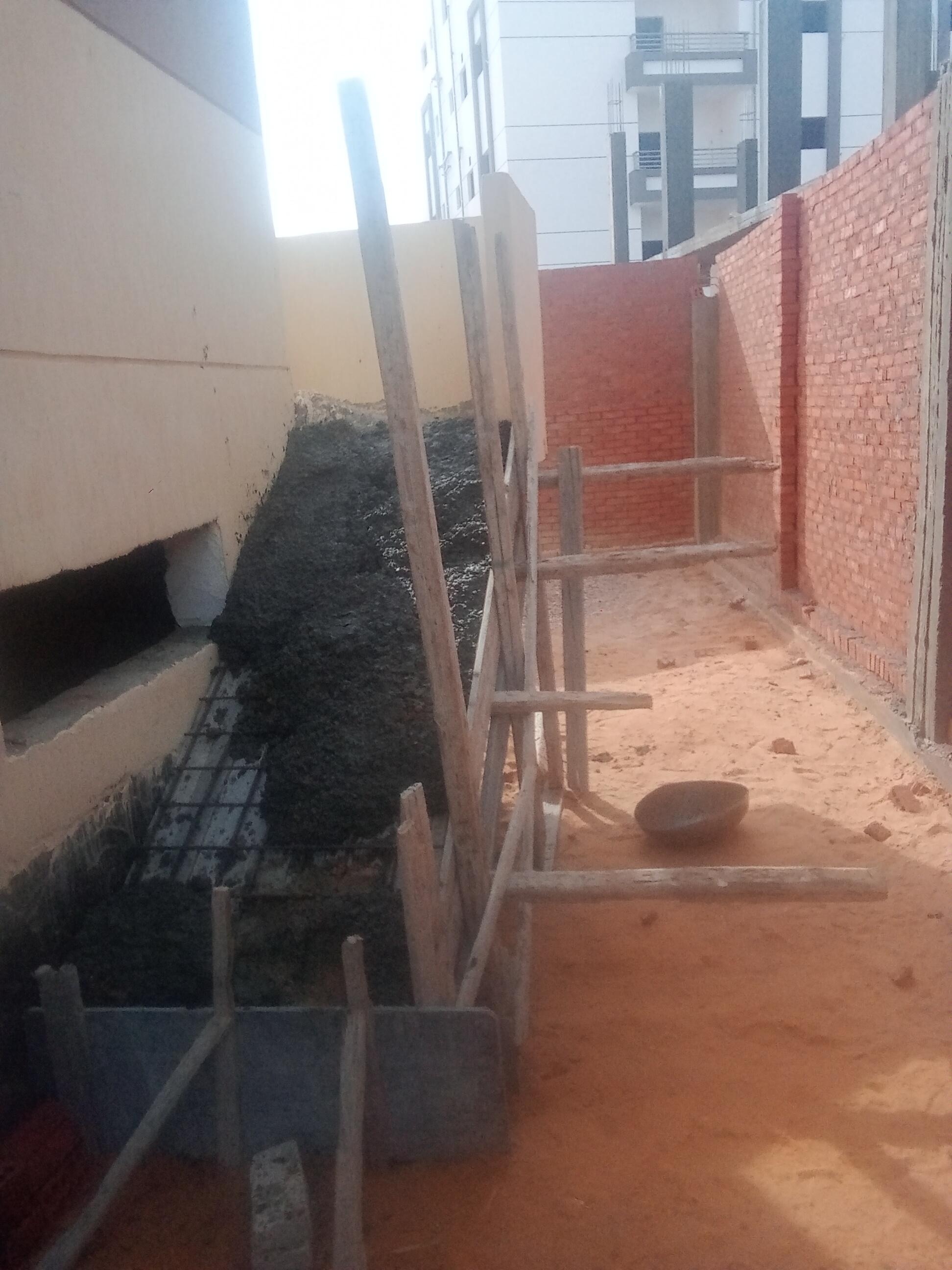

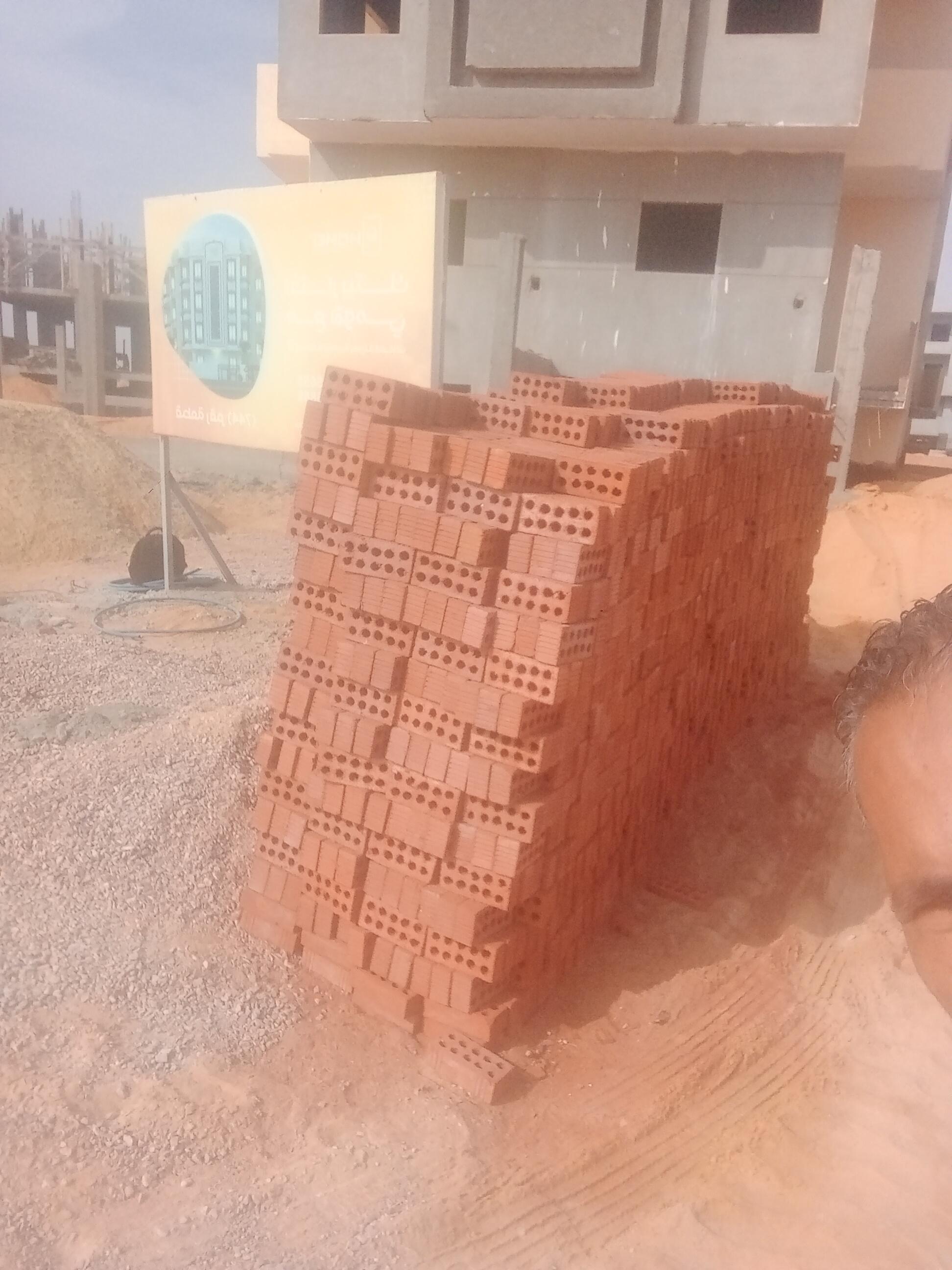

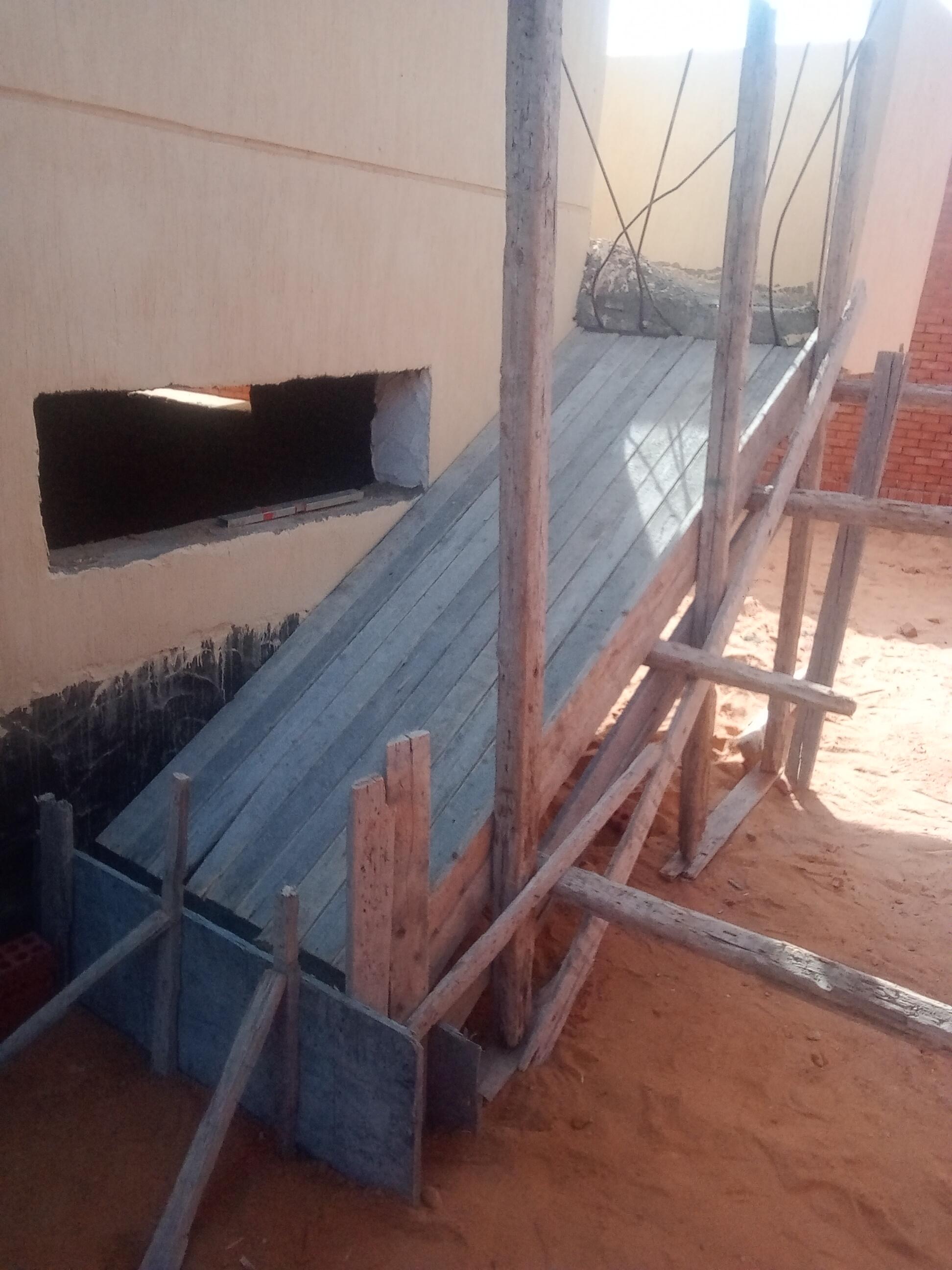

Concrete works for the external wall
April 15, 2023

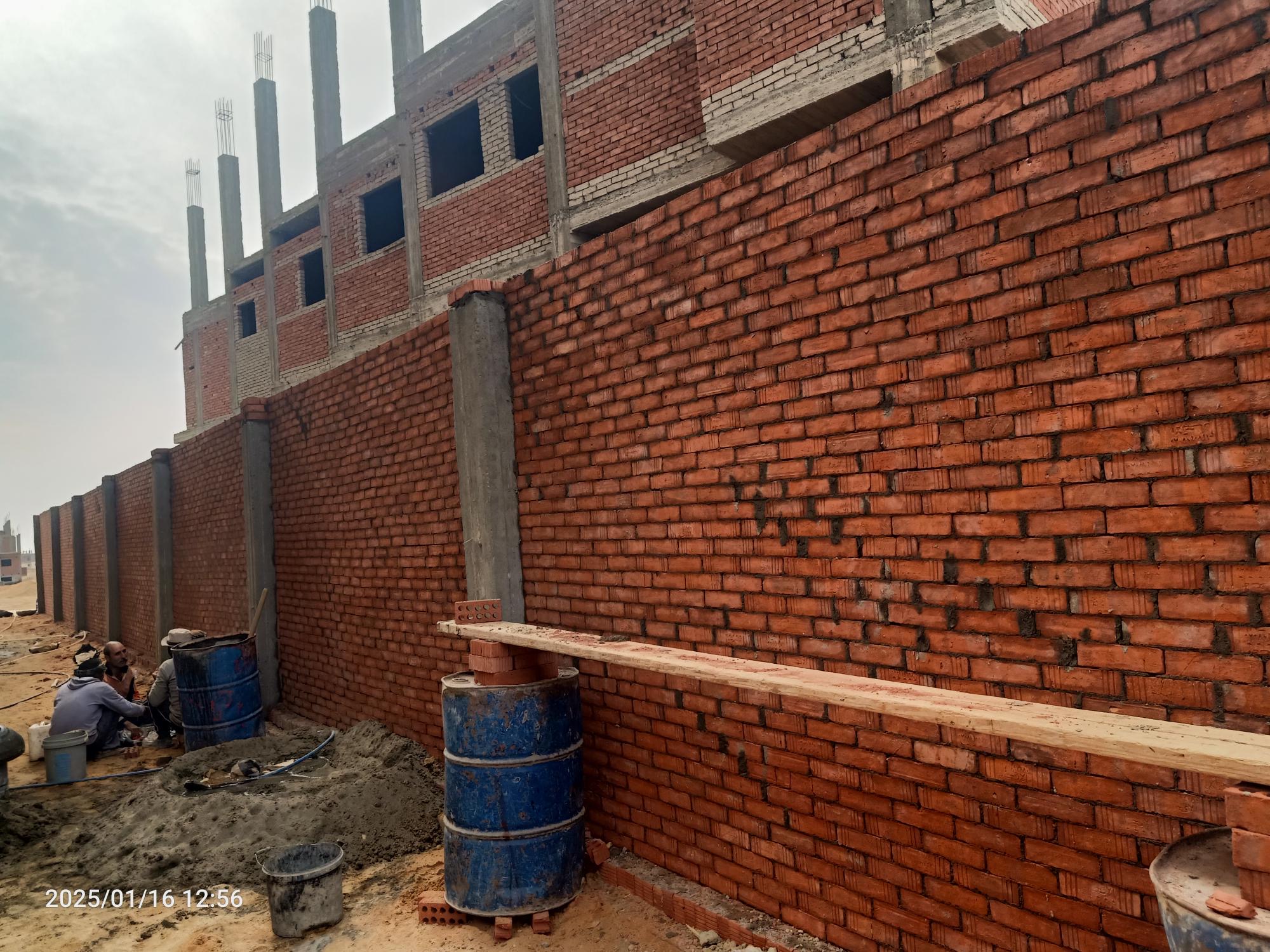

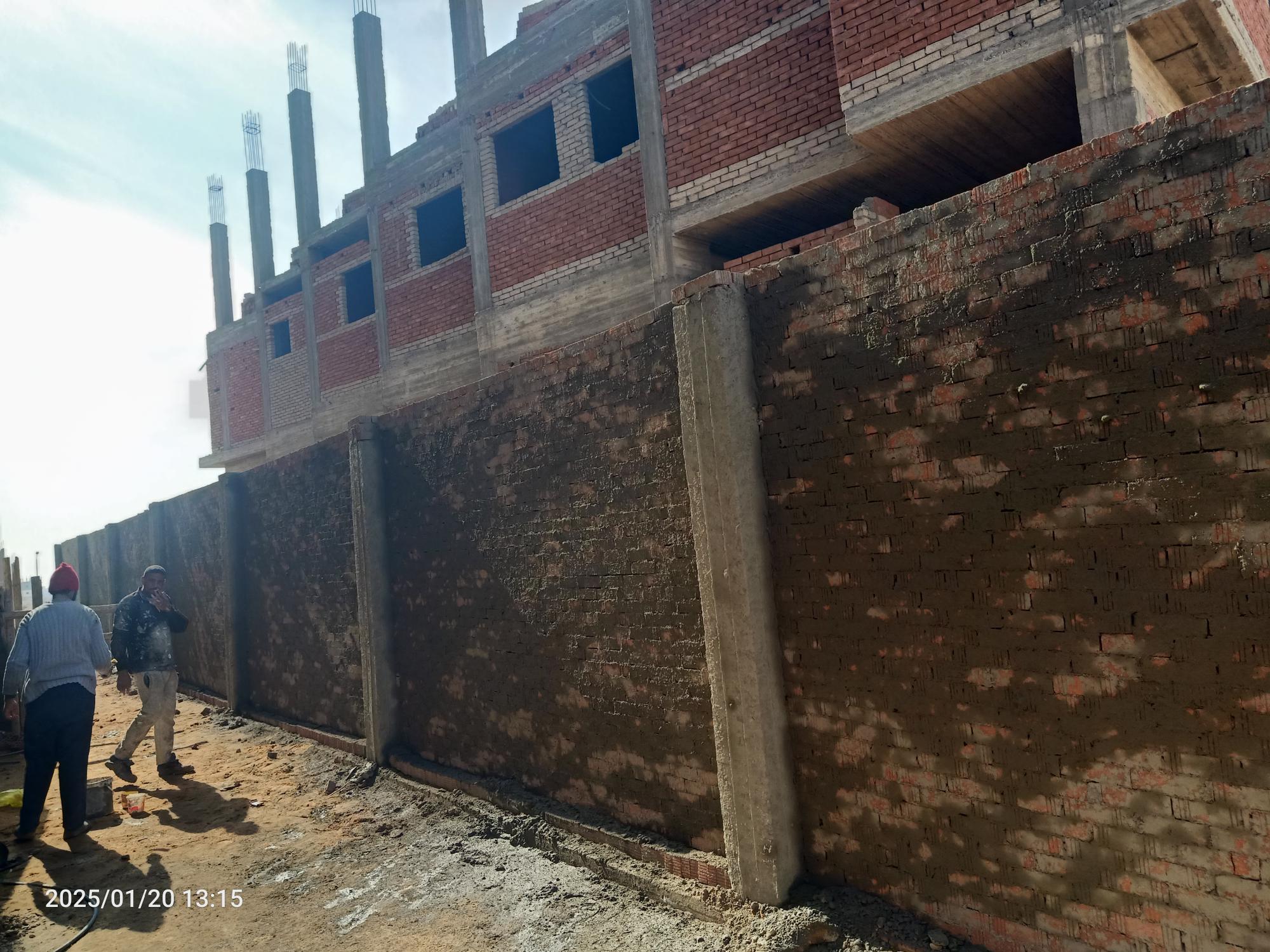

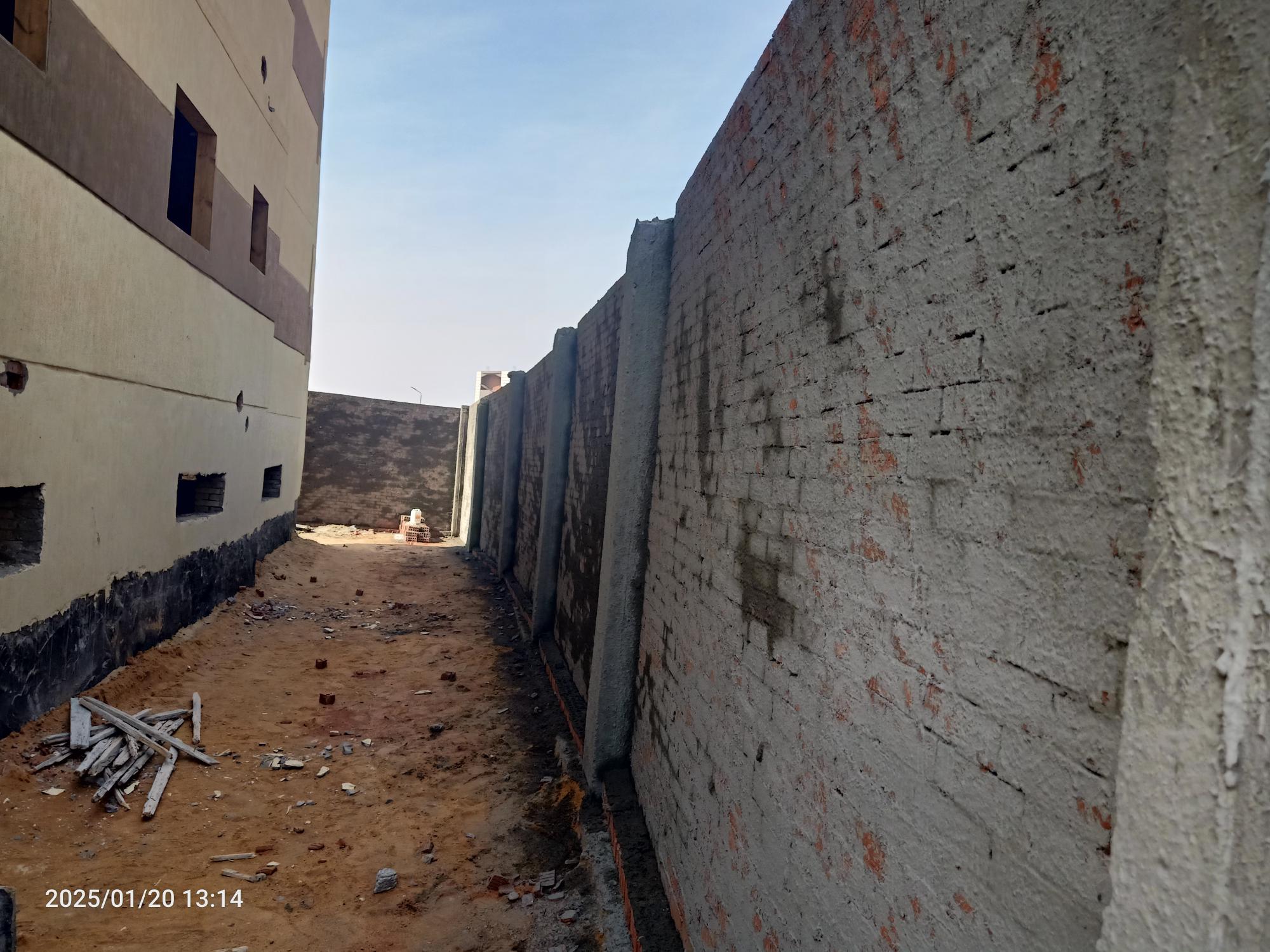

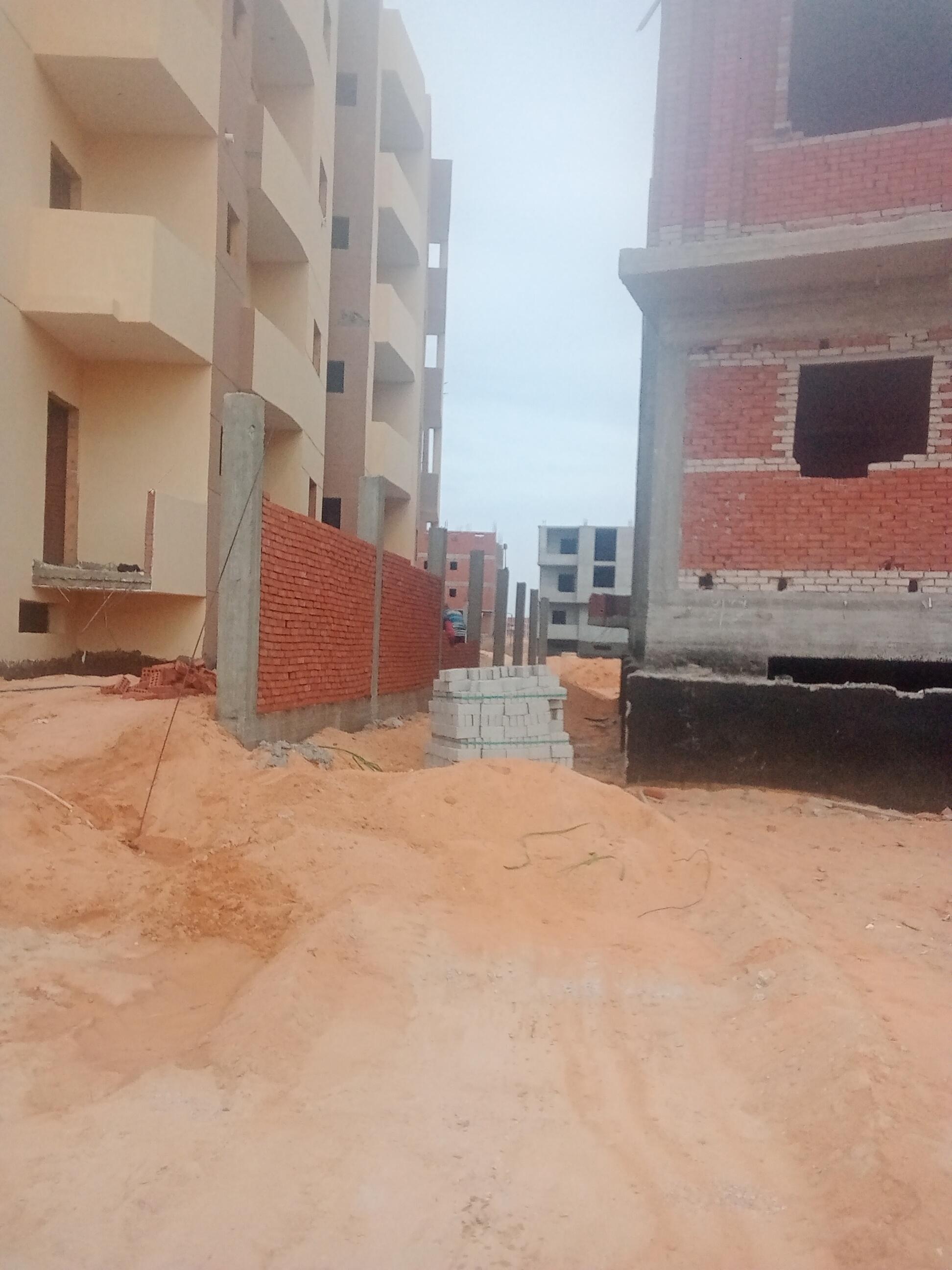

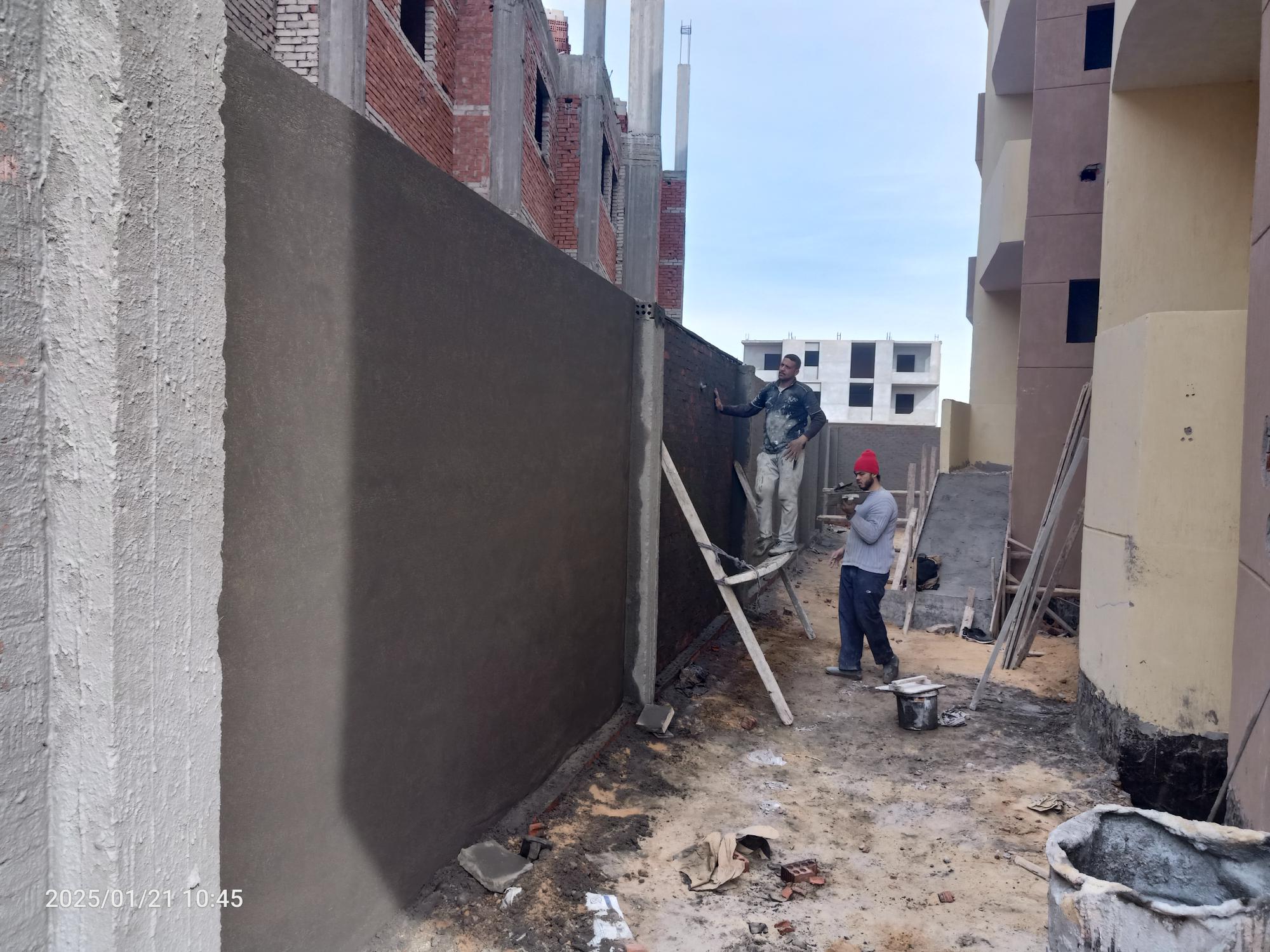

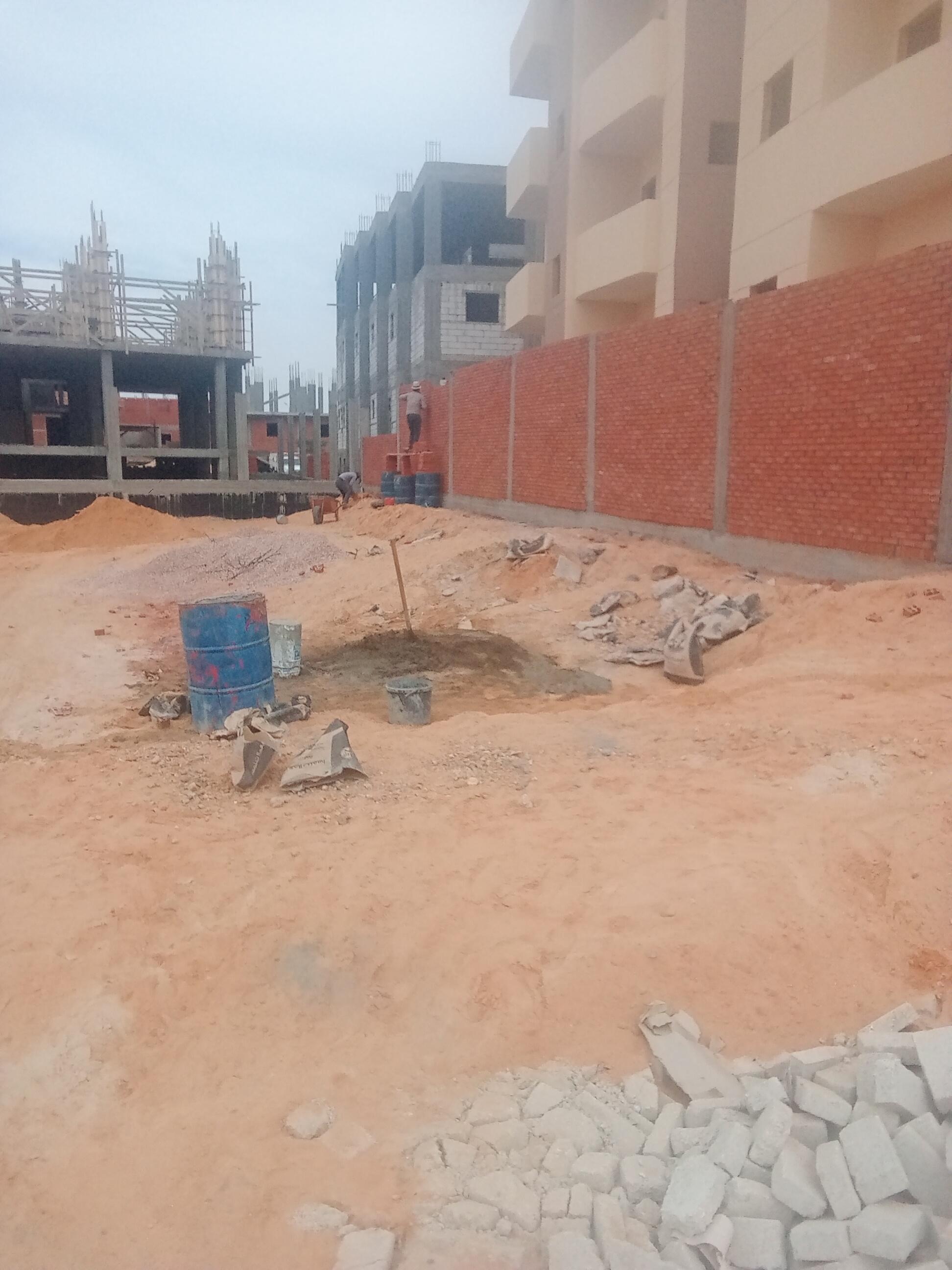

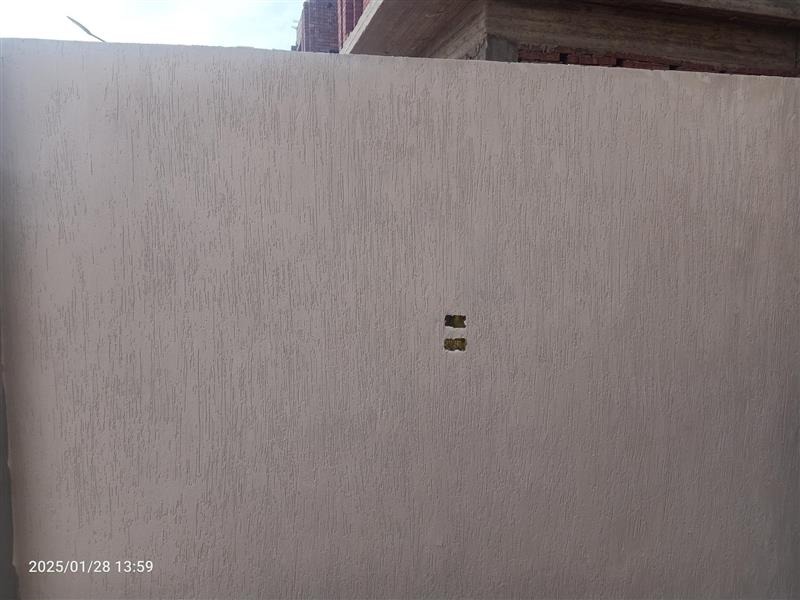

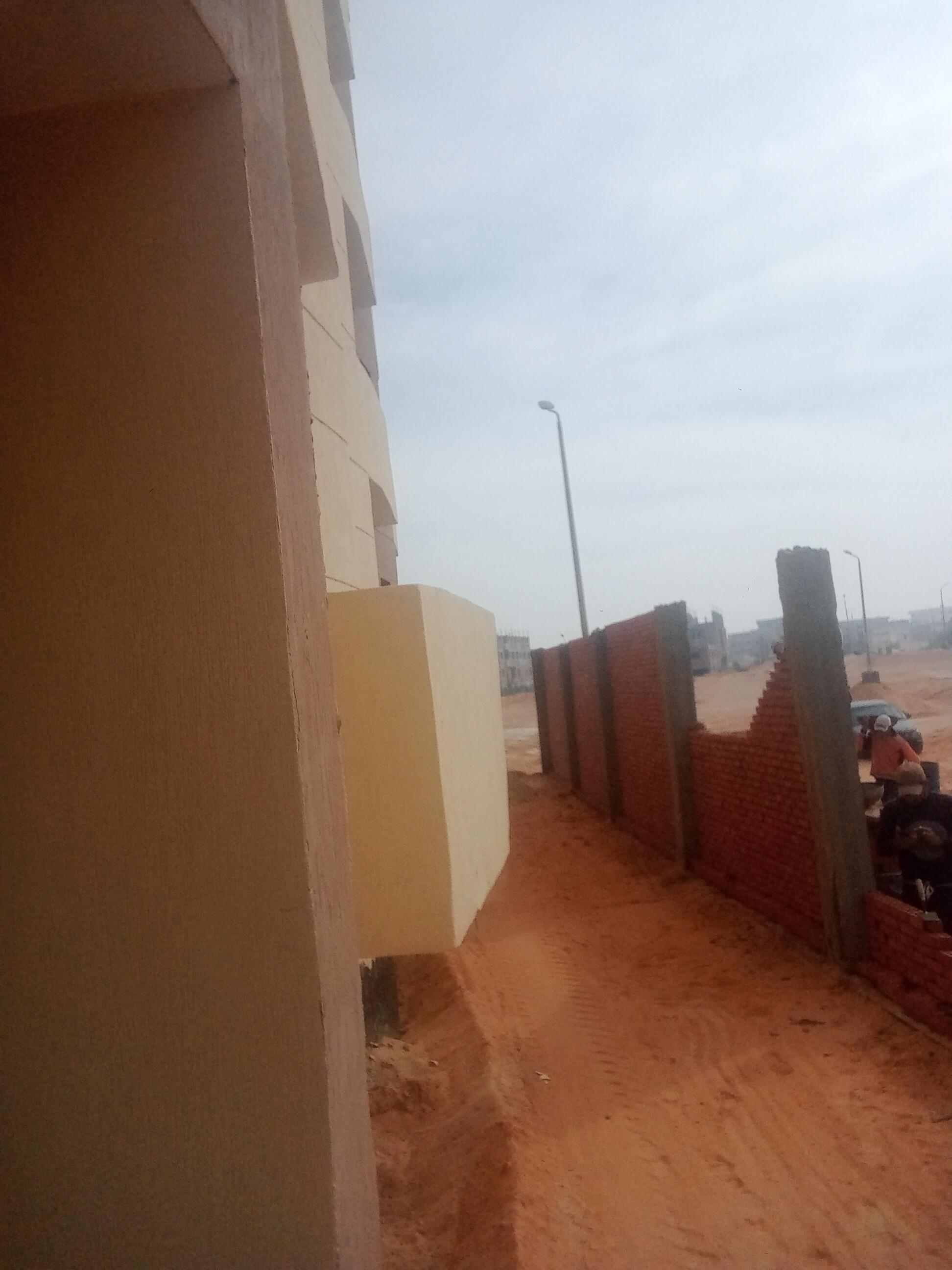

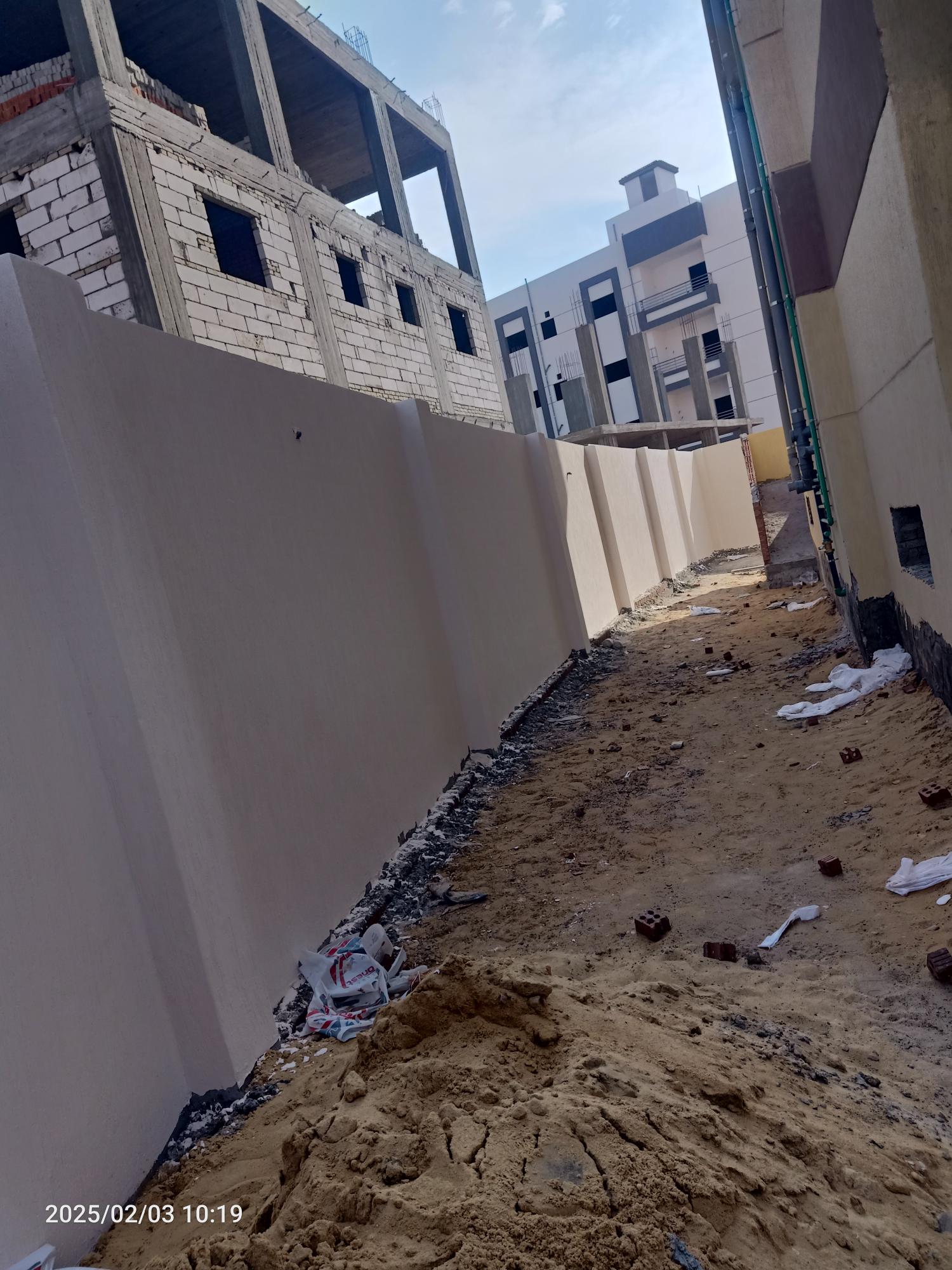

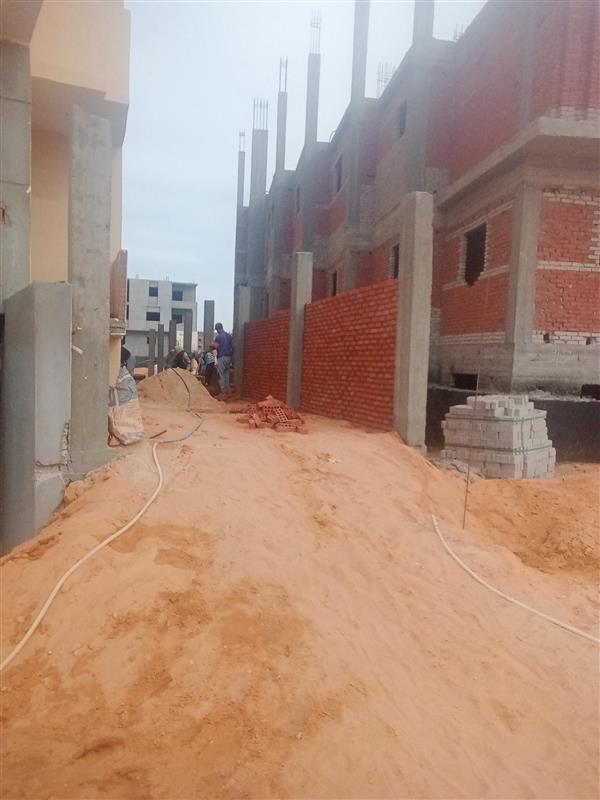

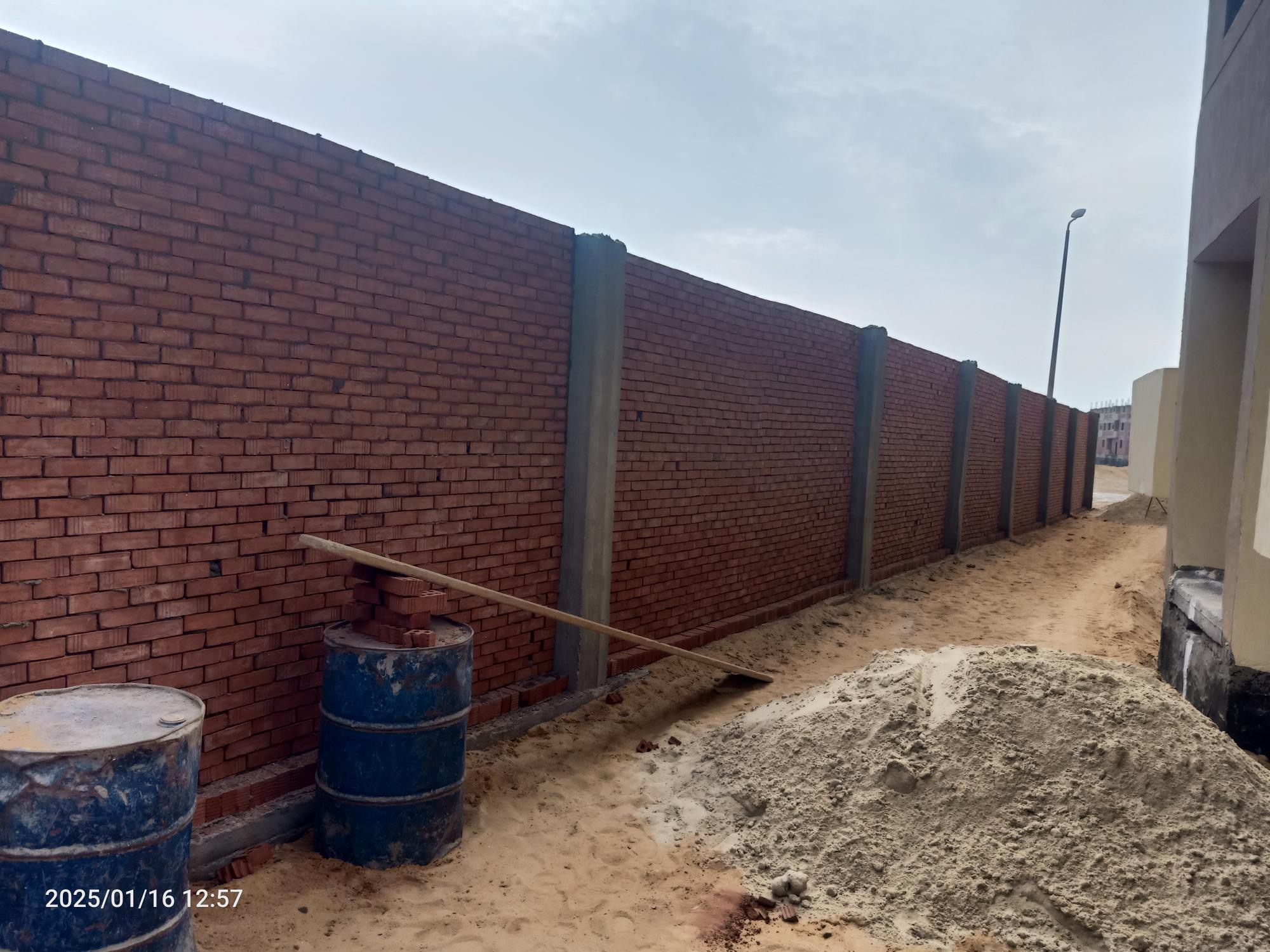

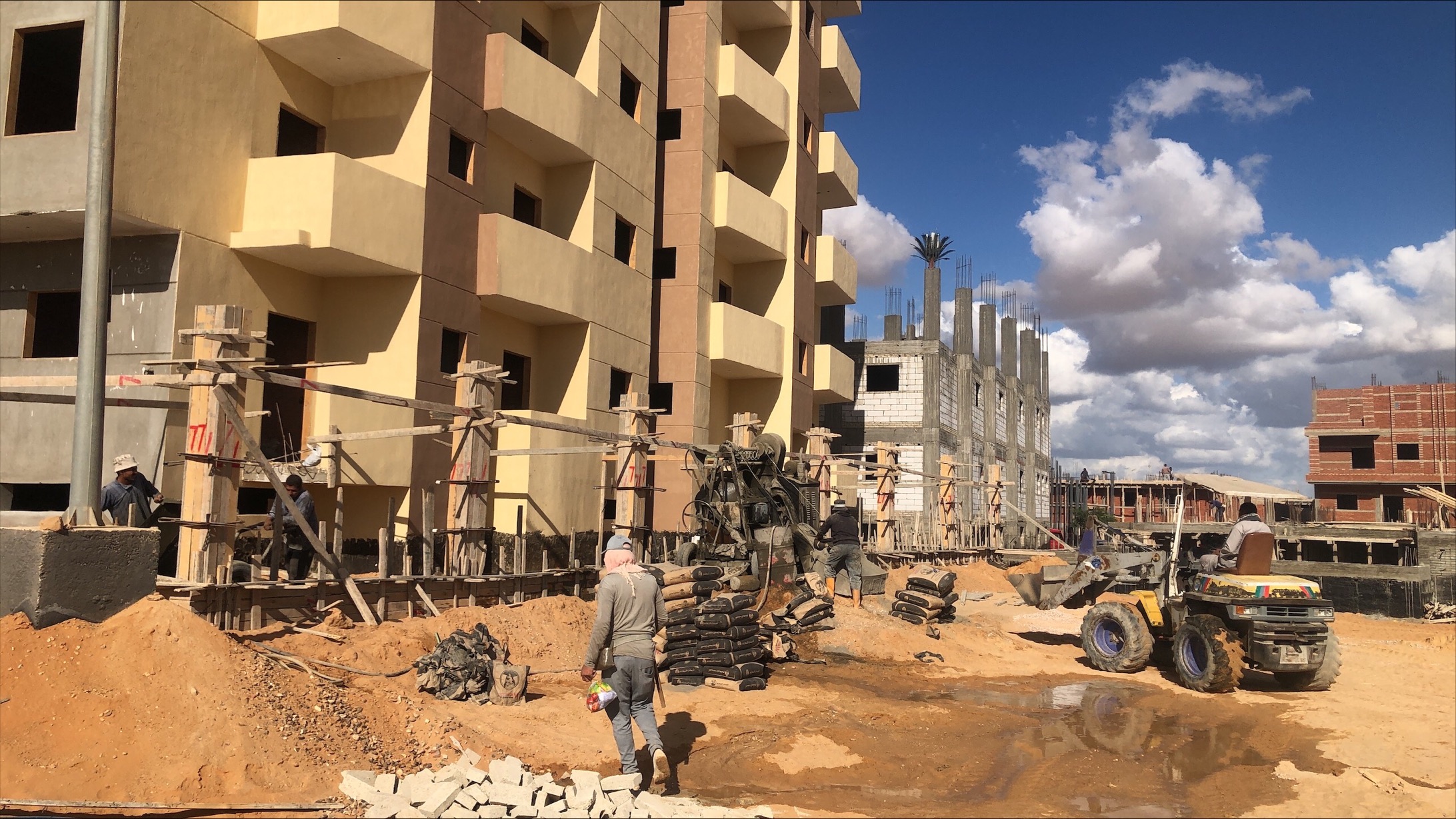

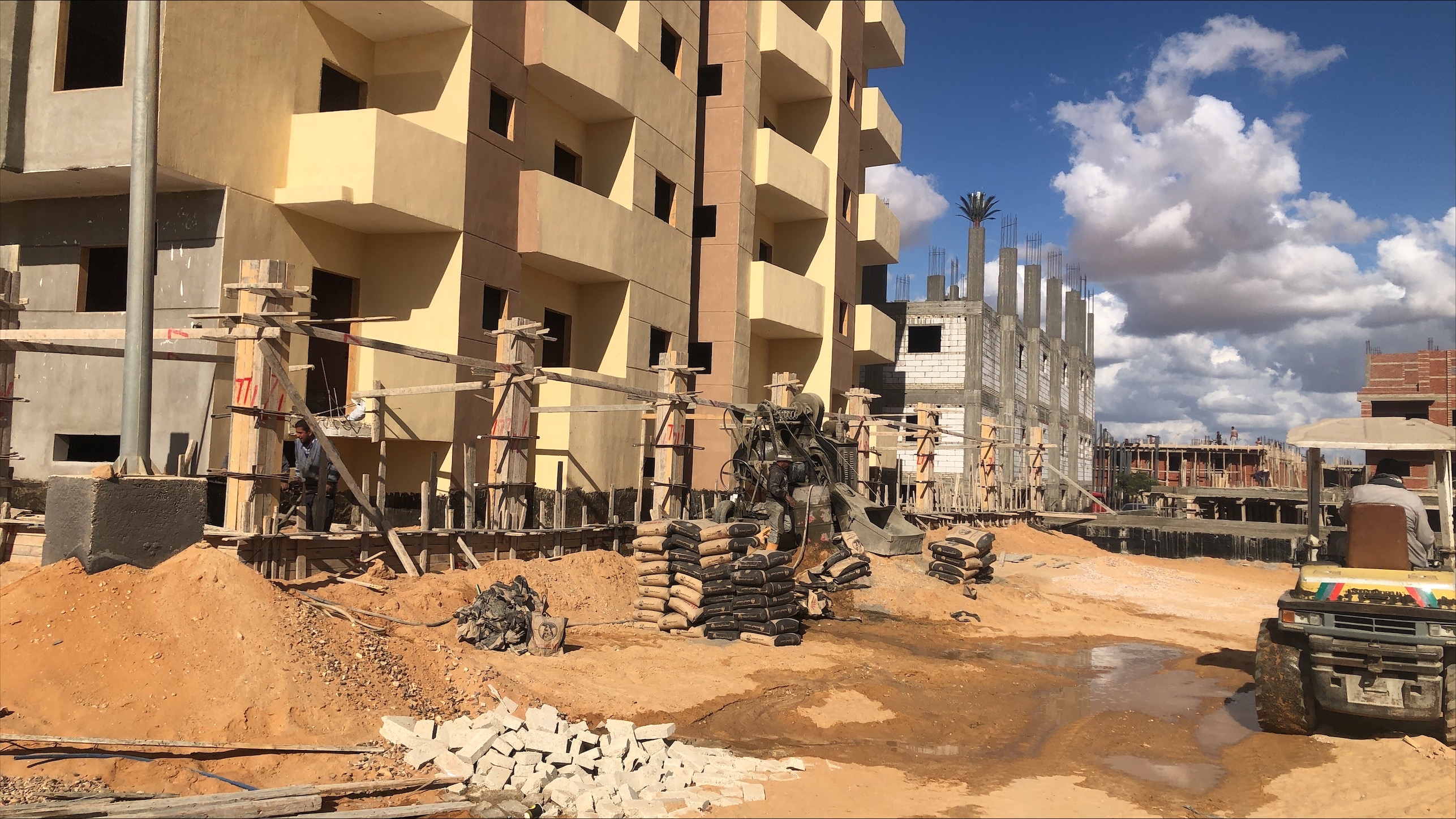

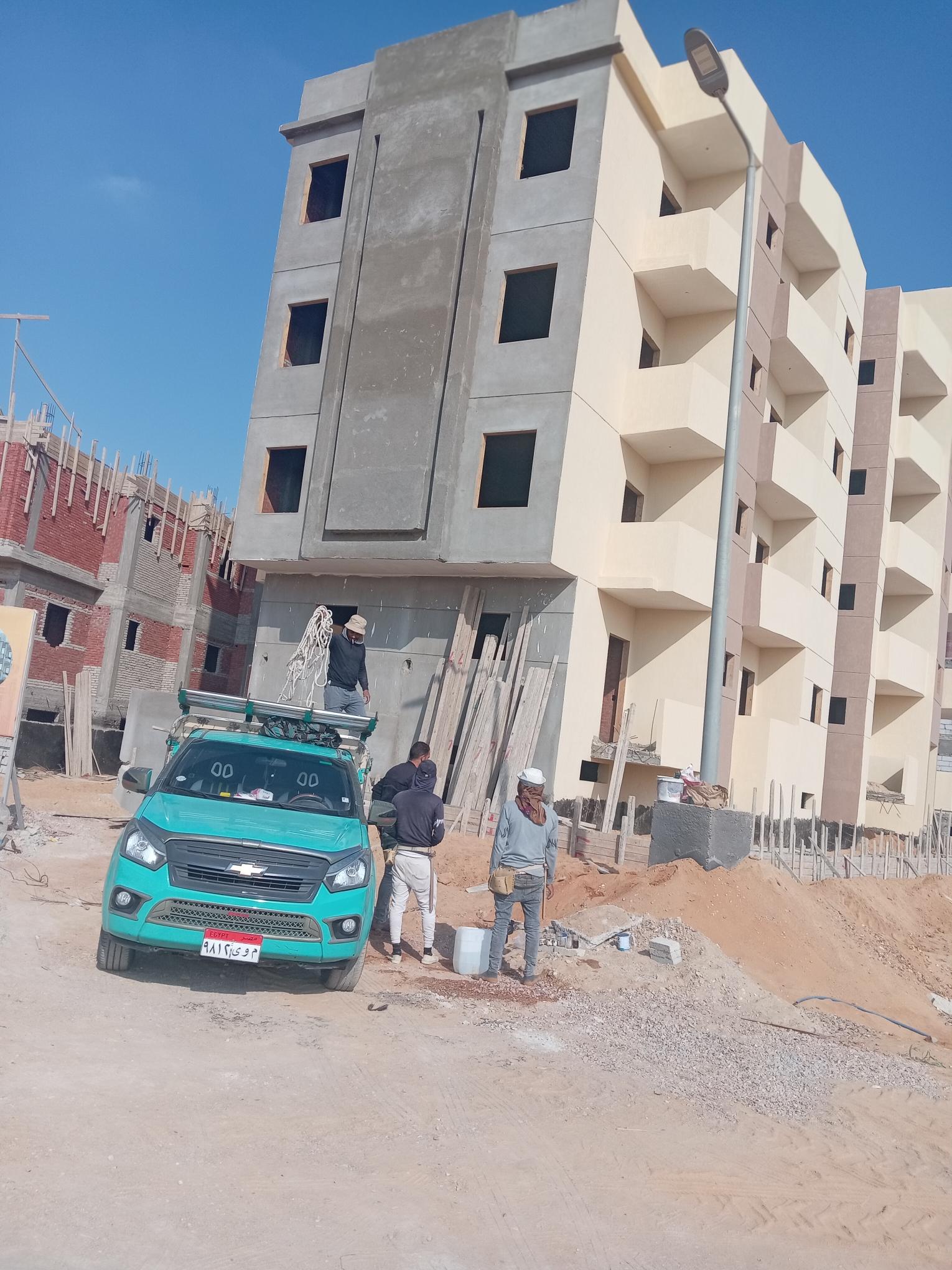

Wall Building works

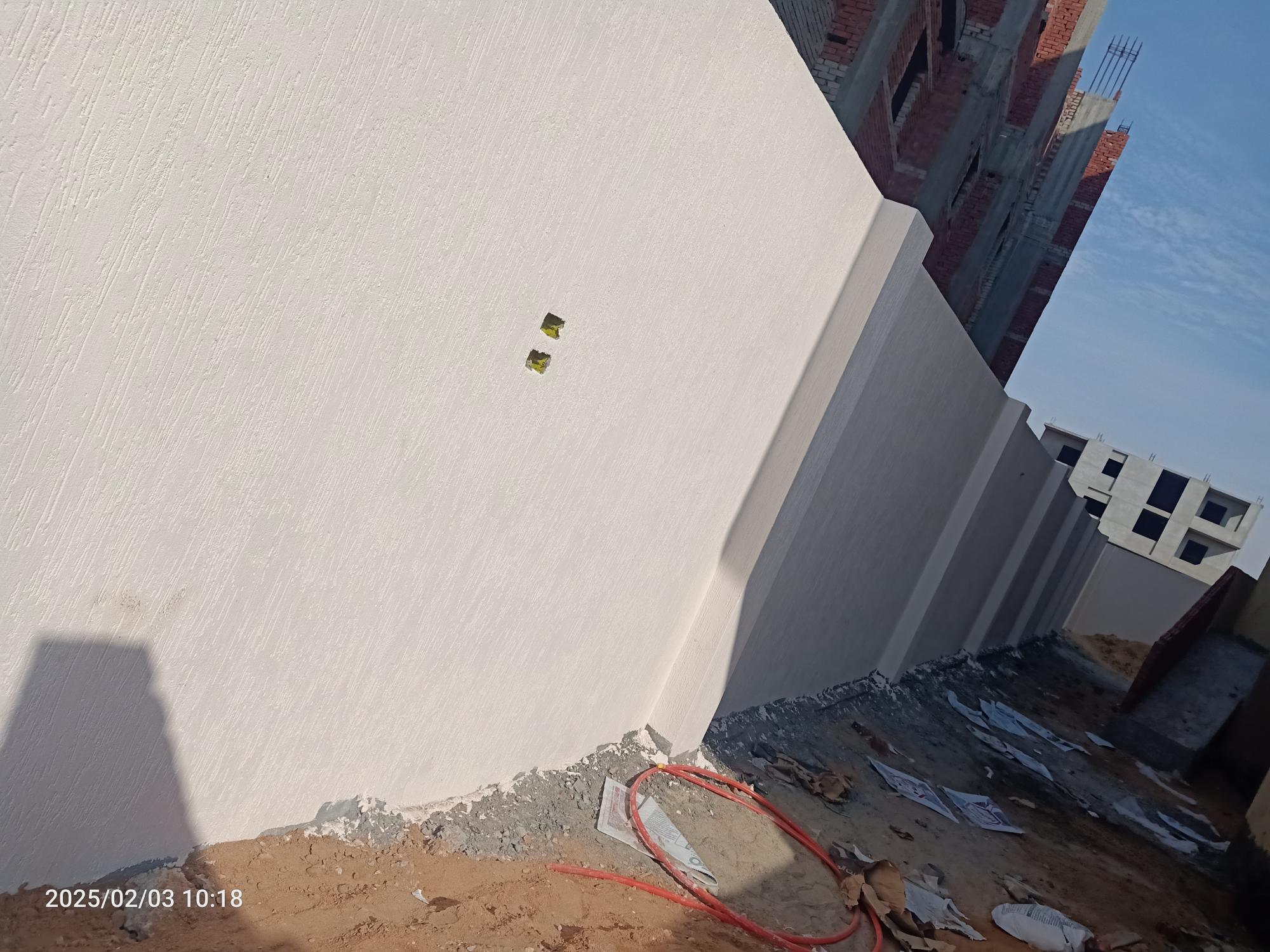

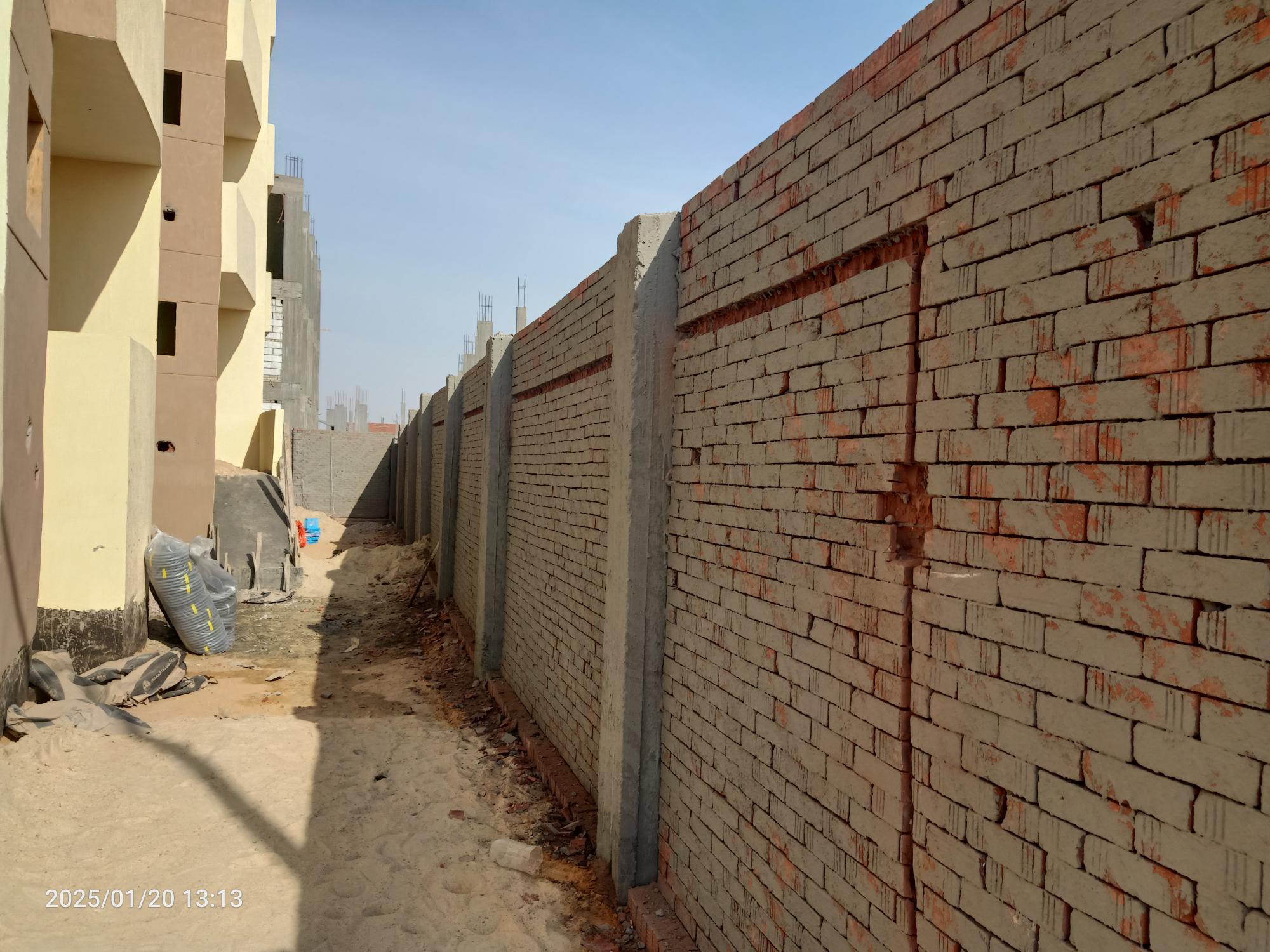

April 20, 2023

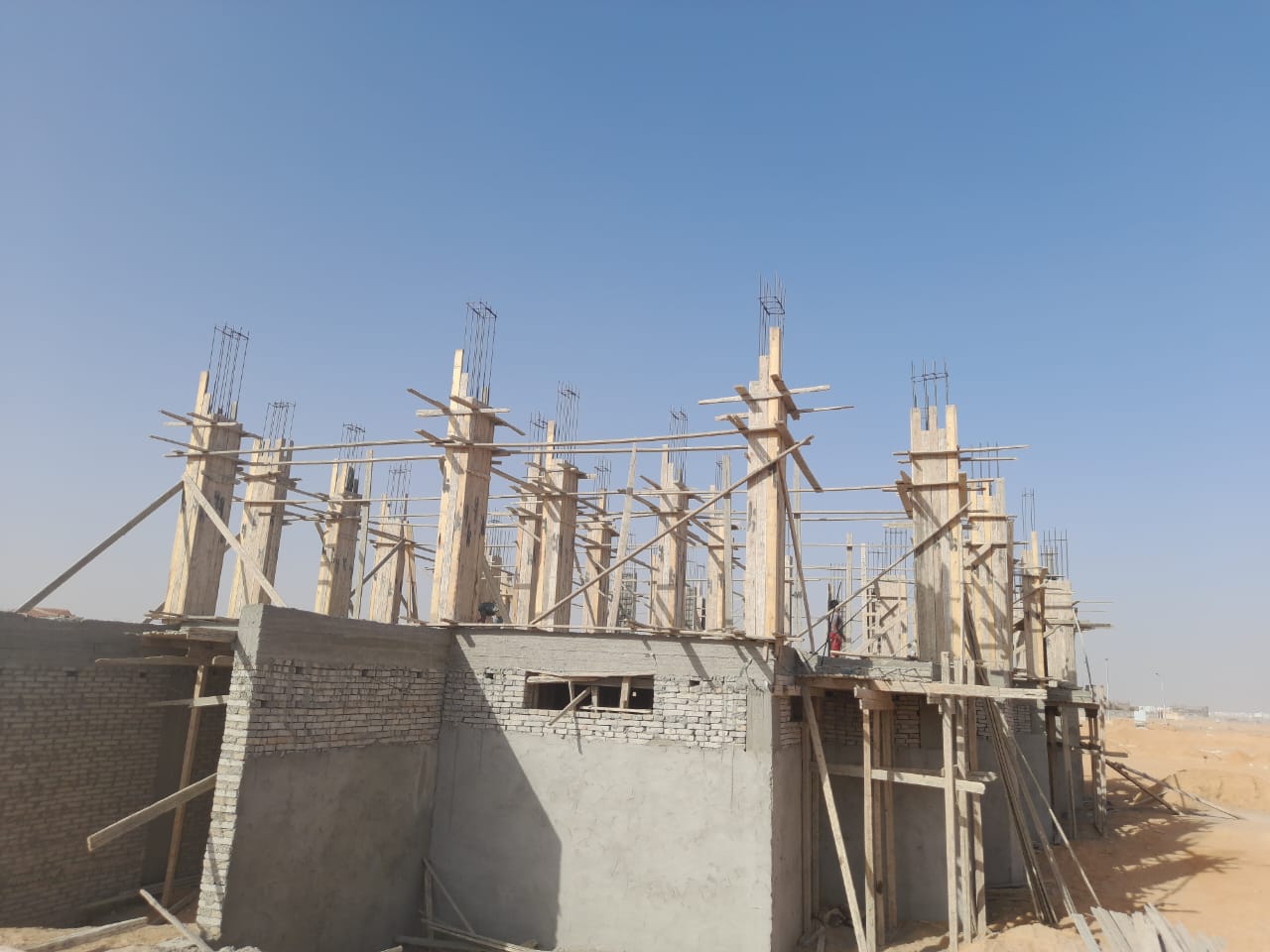

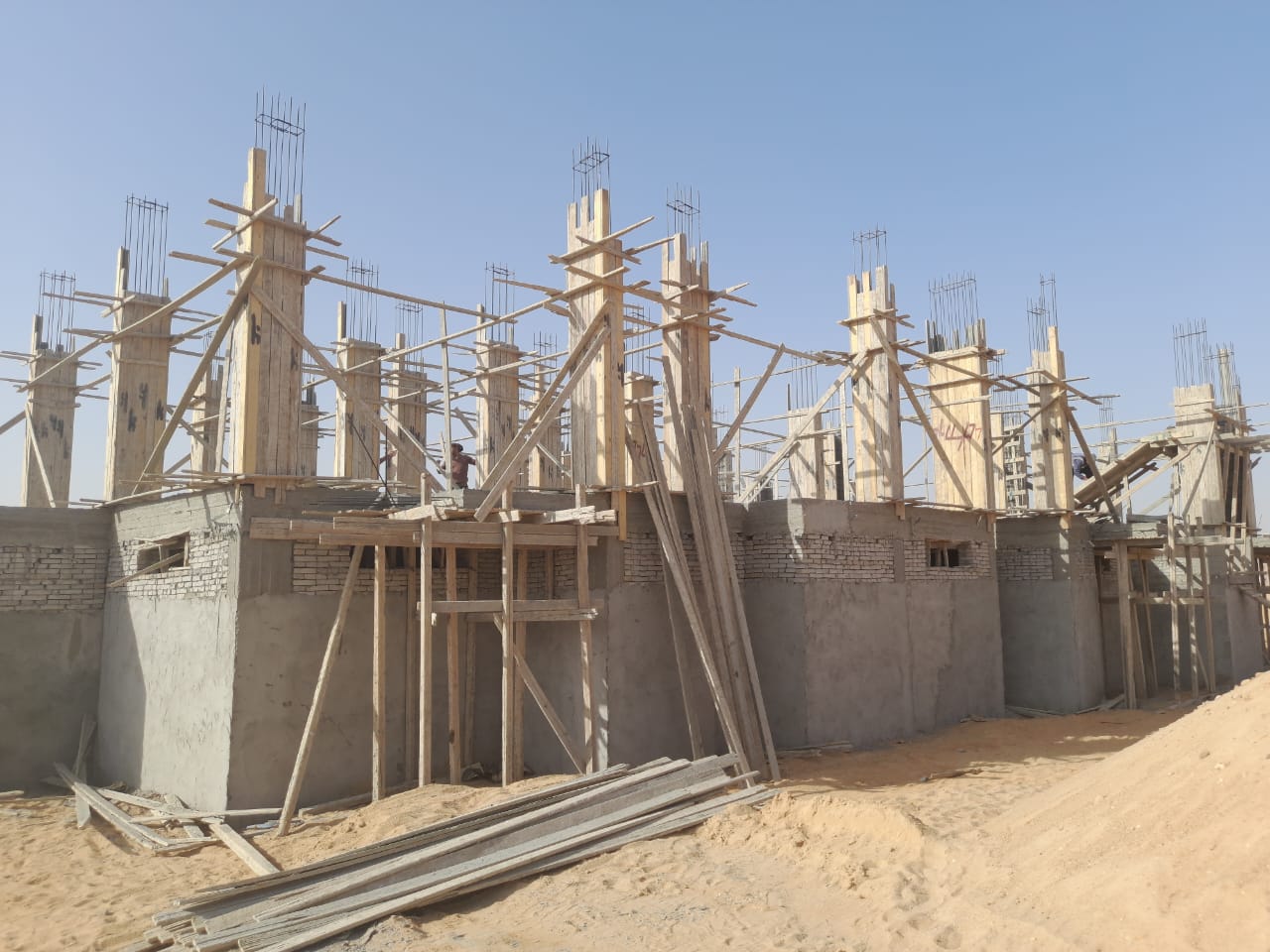

First floor columns
April 25, 2023

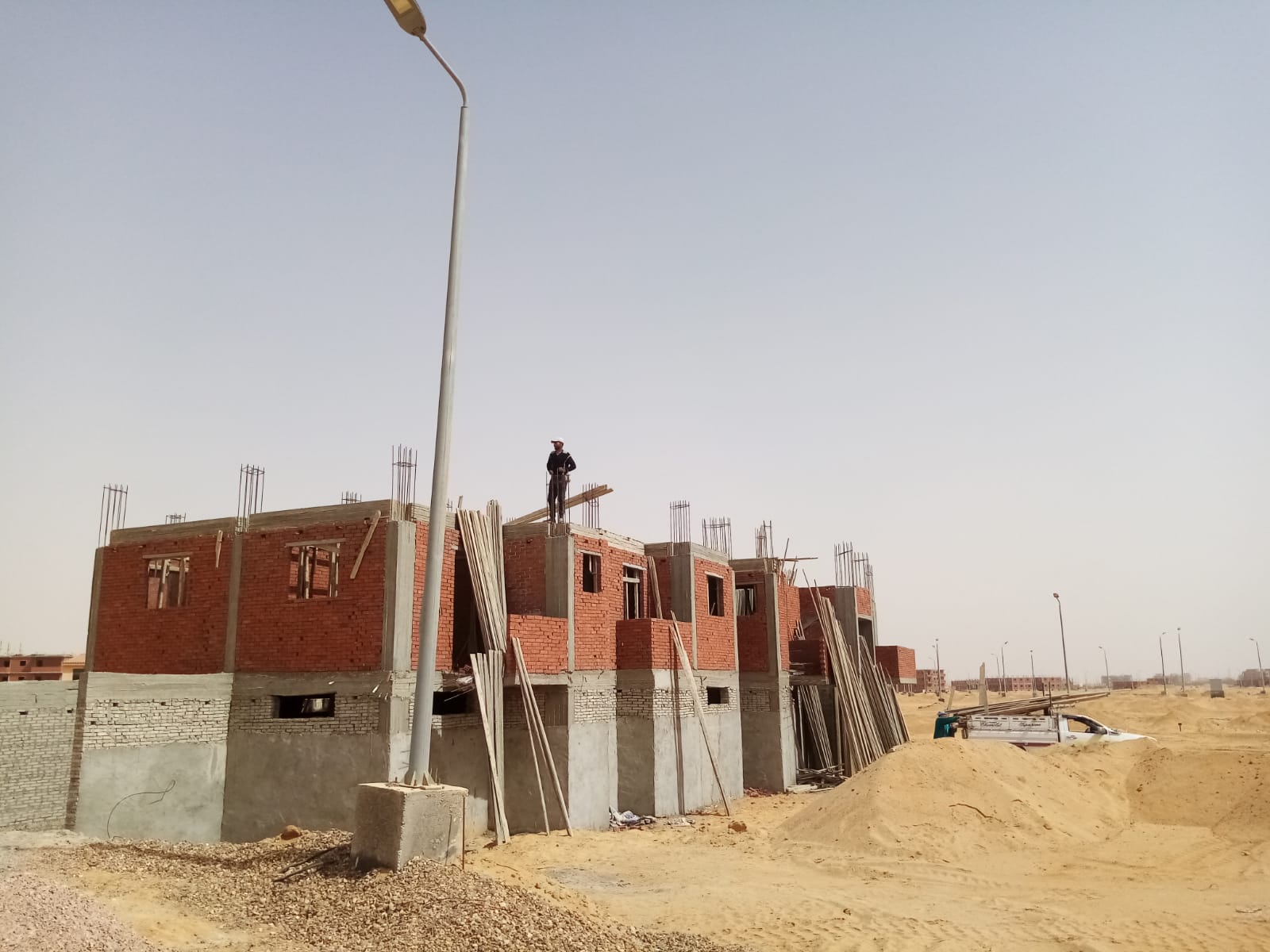

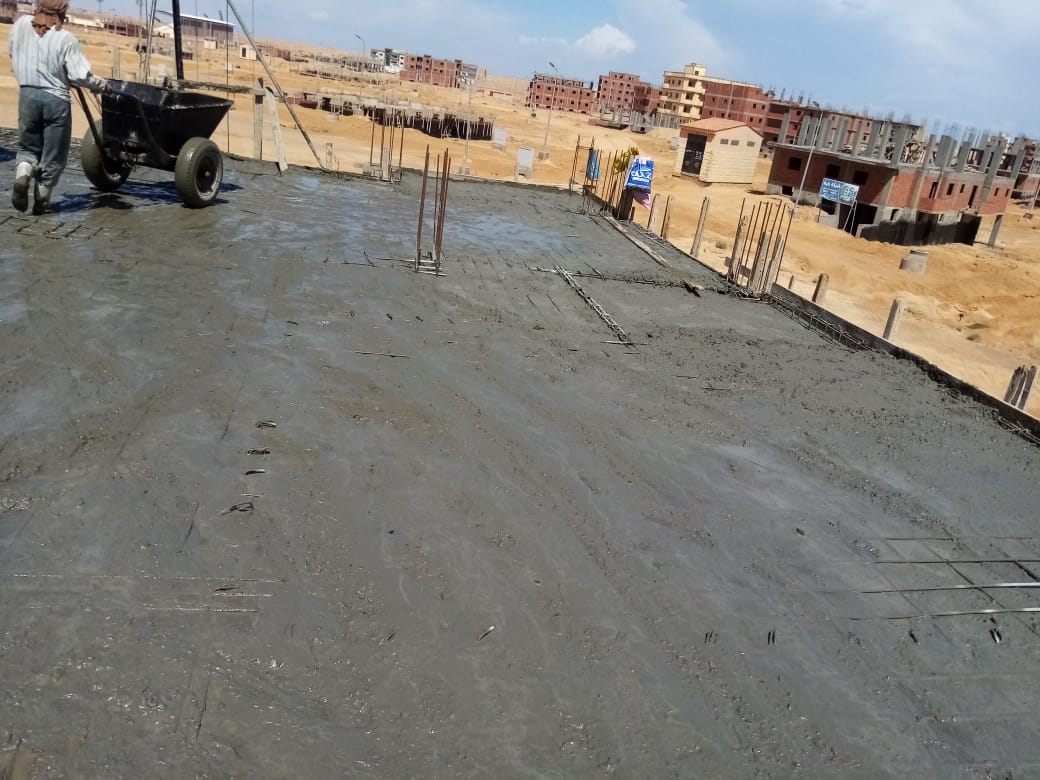

First floor slab

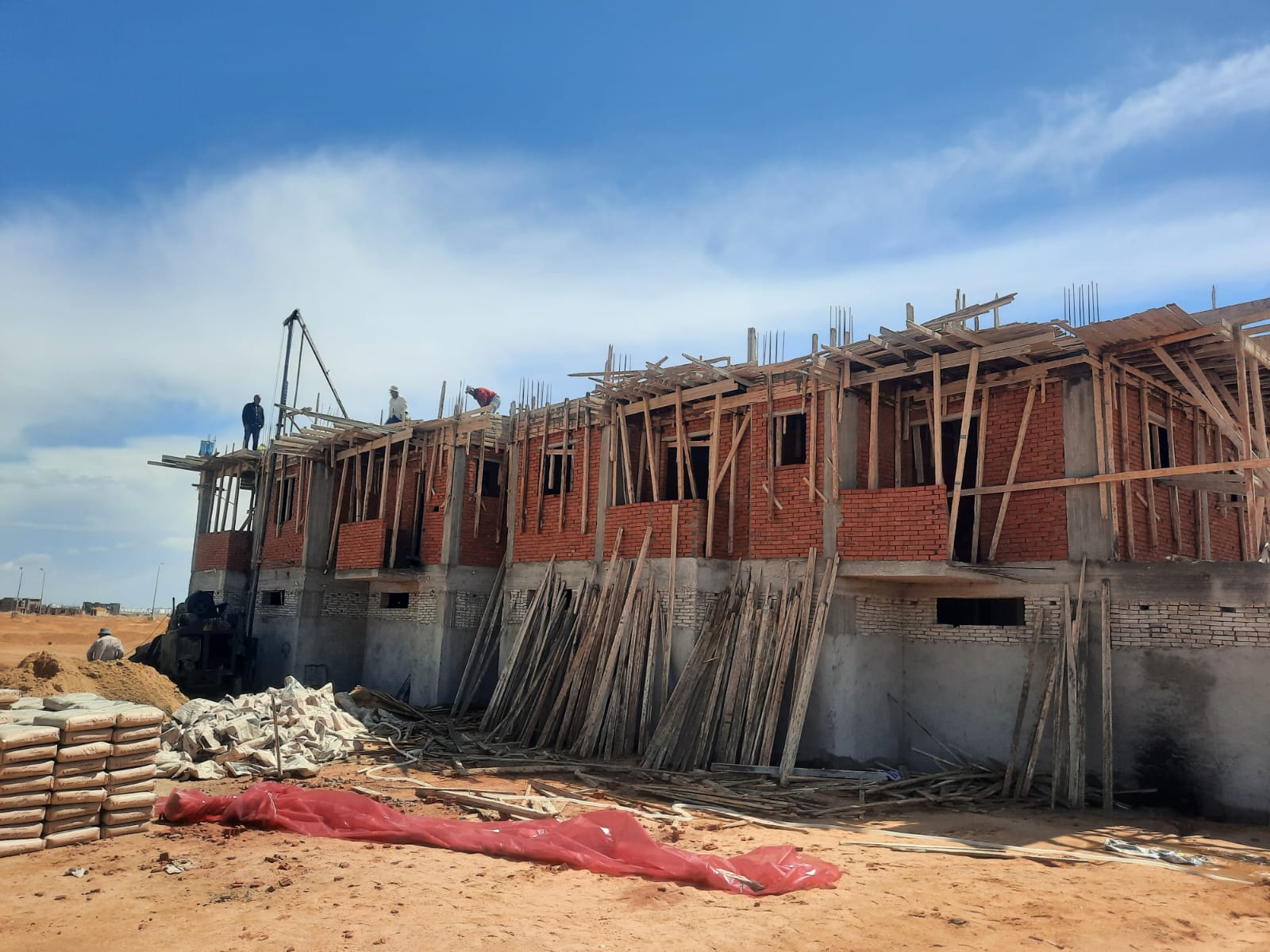

May 5, 2023

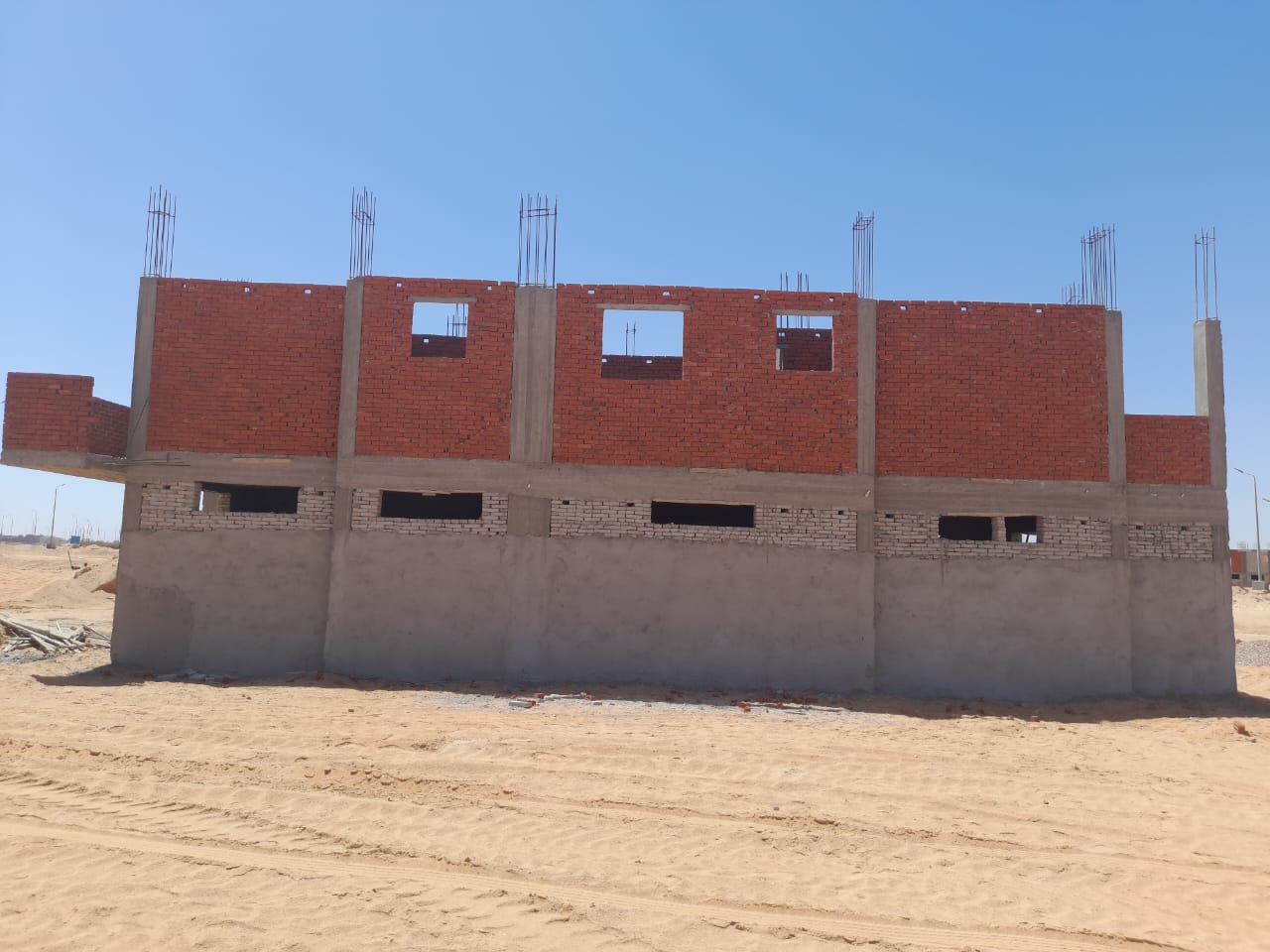

First floor walls

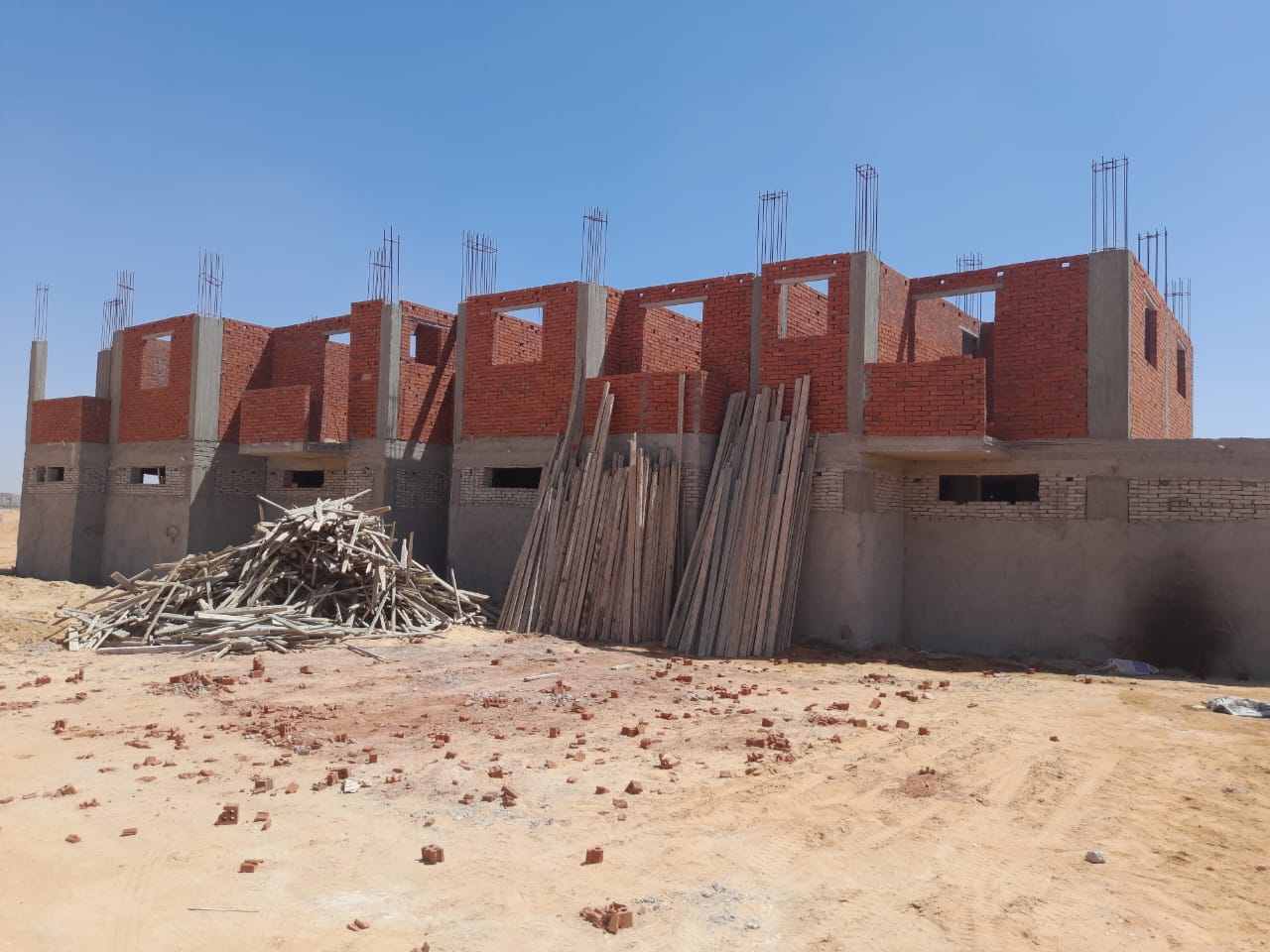

May 10, 2023

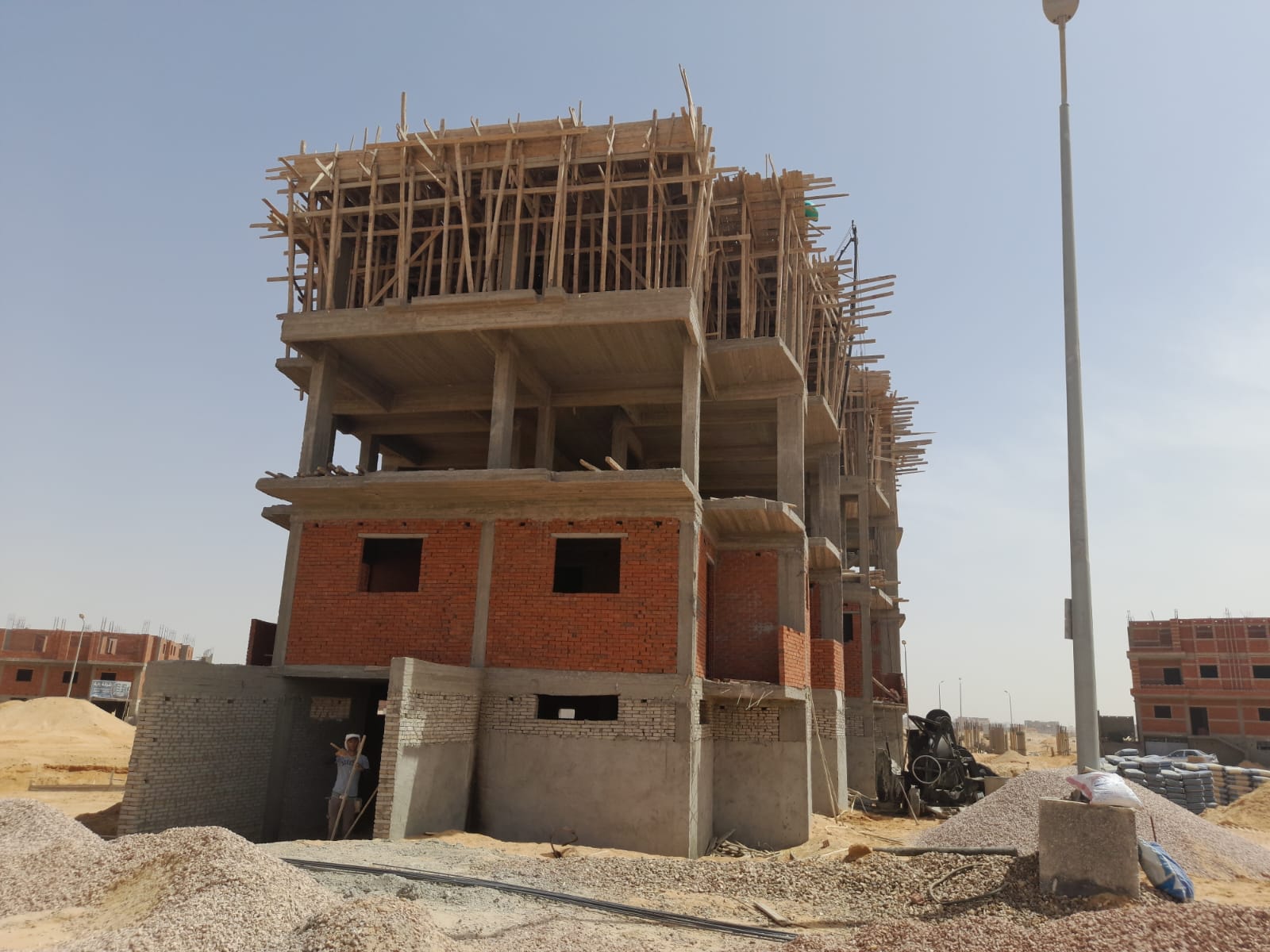

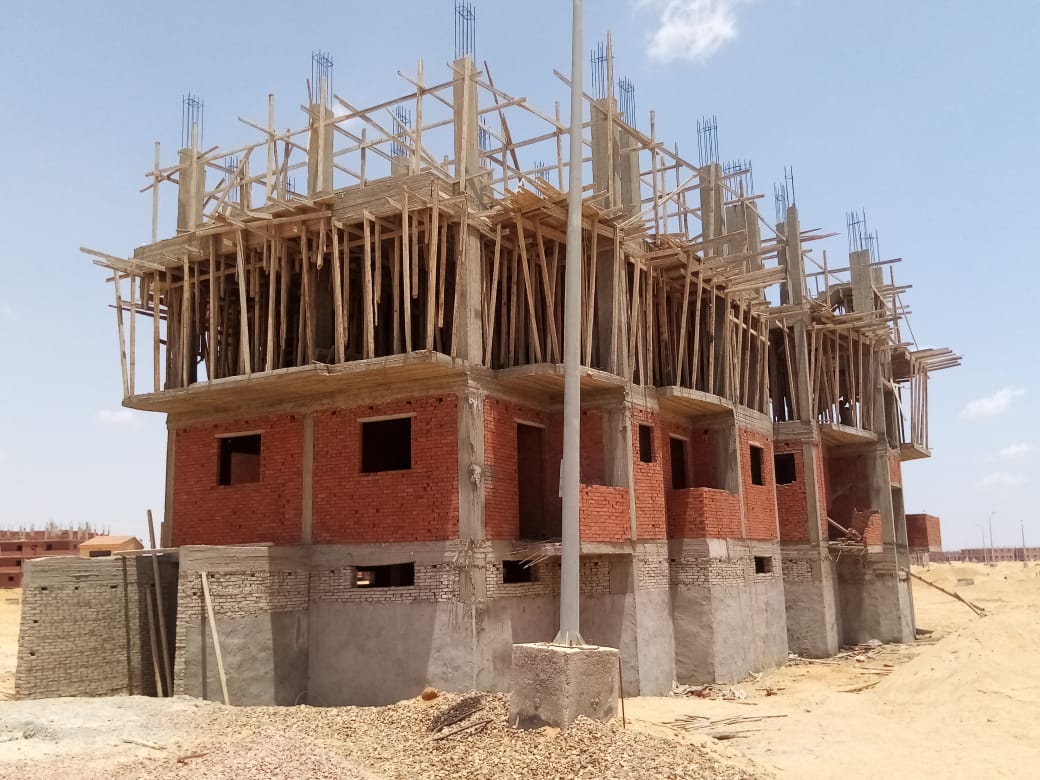

Second floor columns
May 15, 2023

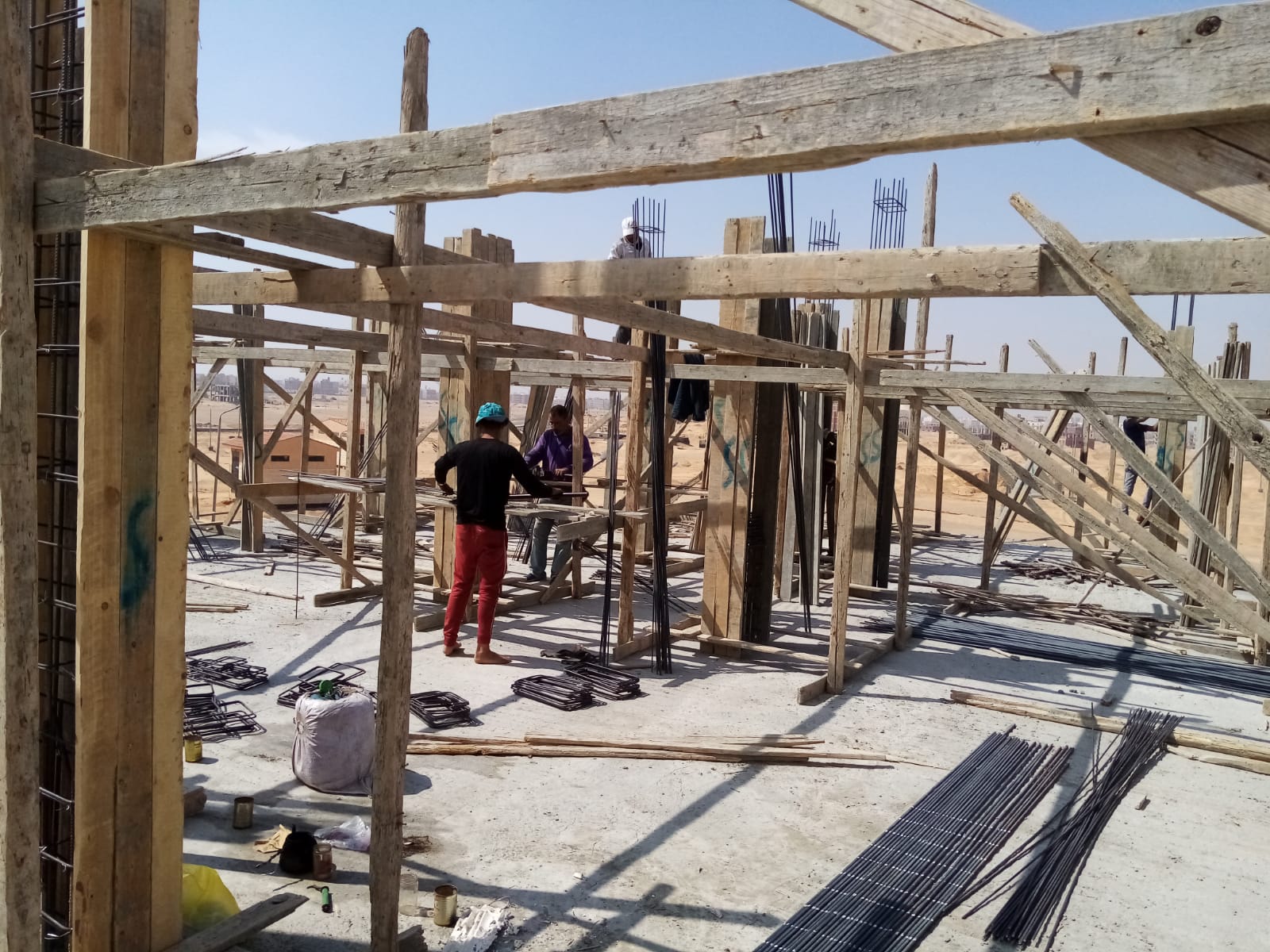

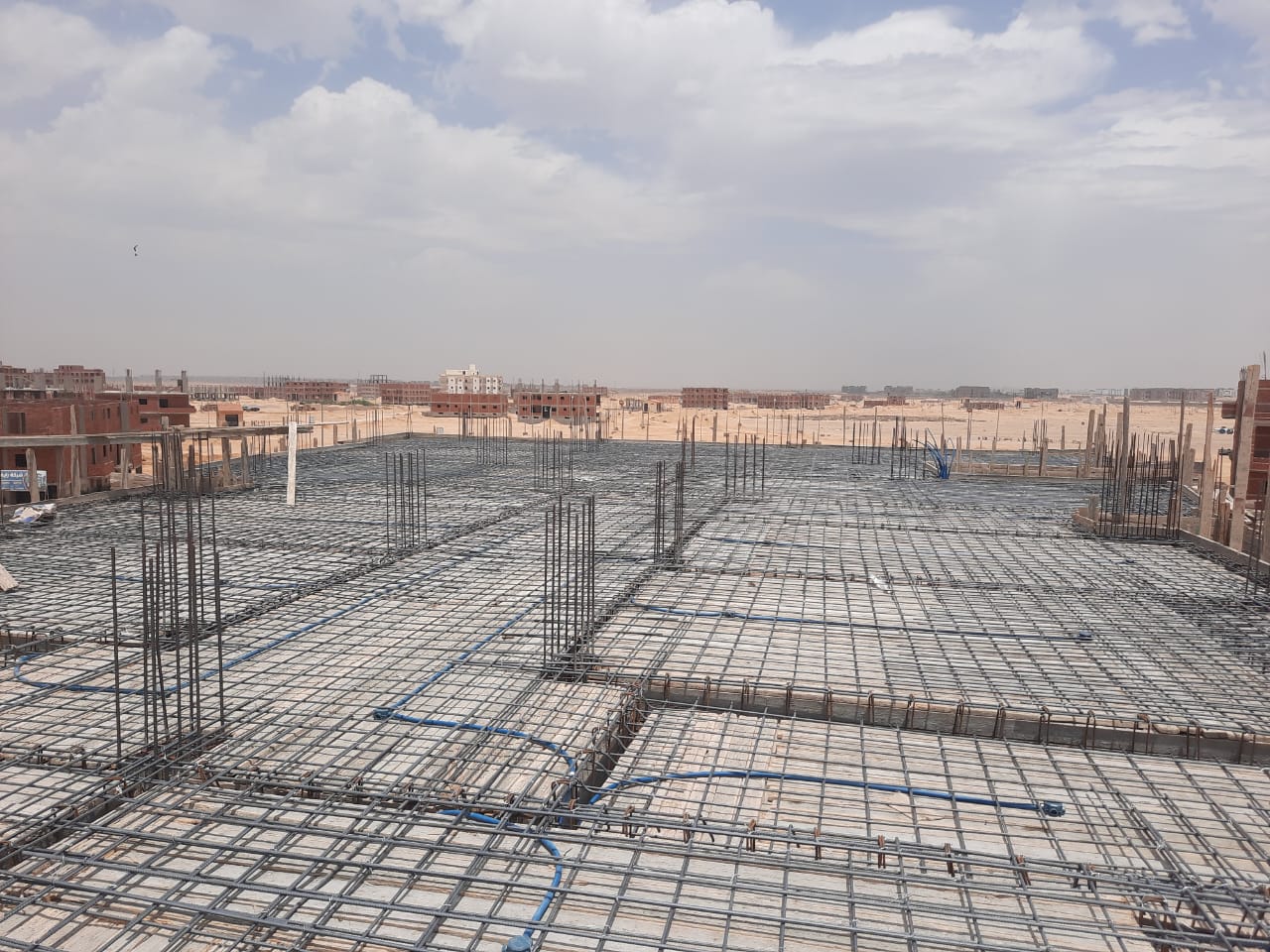

Second floor slab

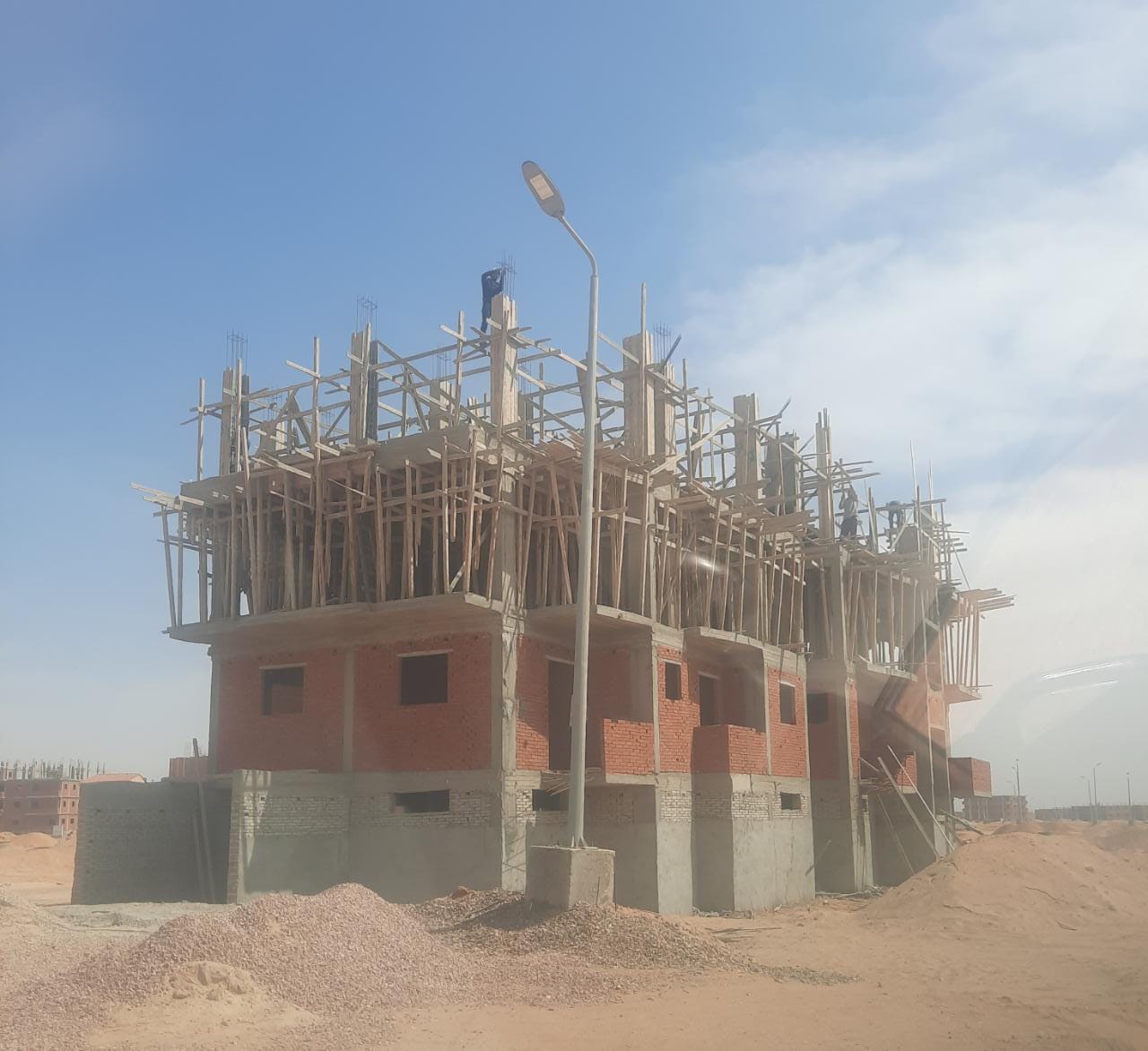

May 27, 2023
Second floor walls

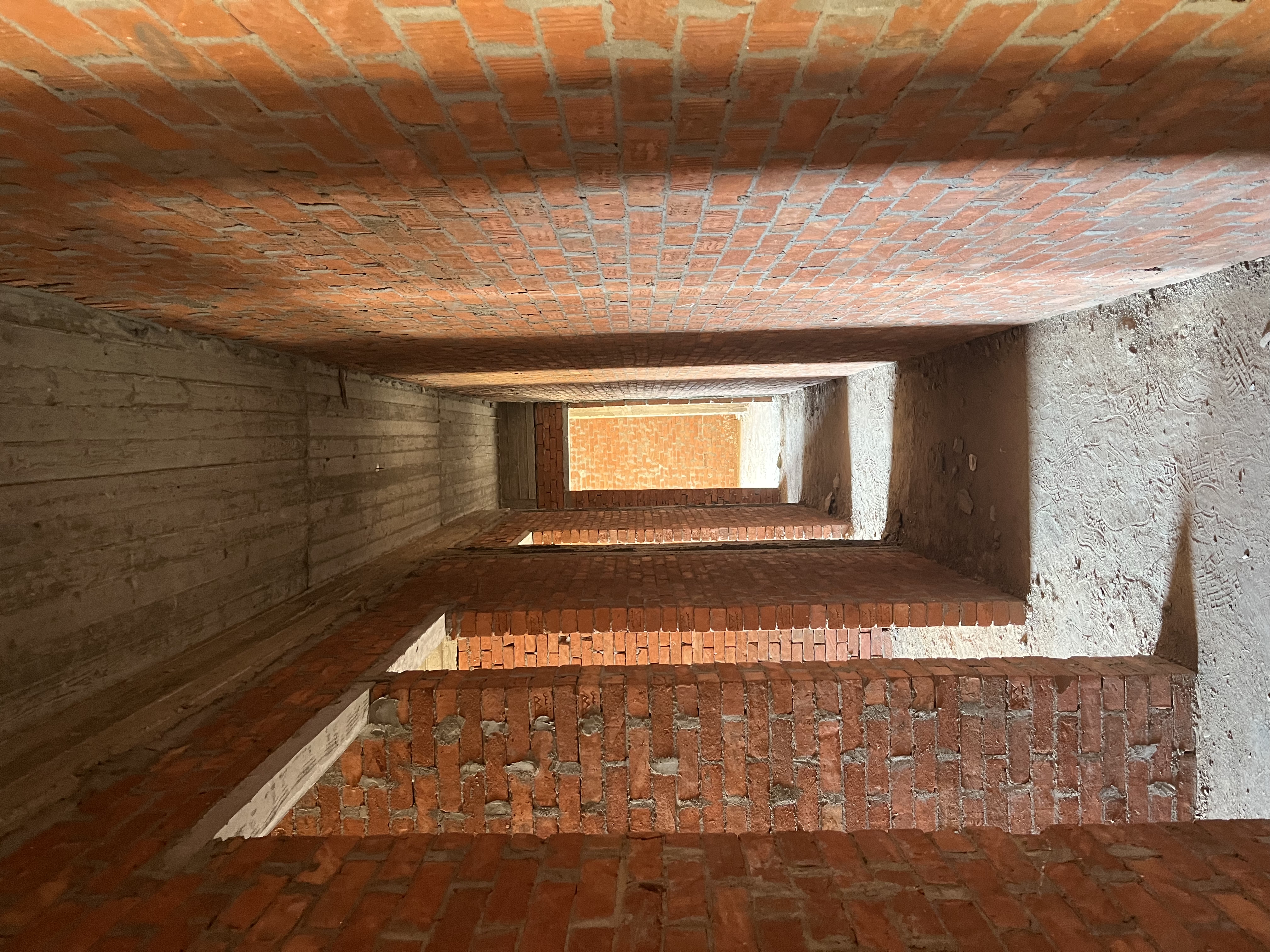

June 10, 2023

Third-floor addition permit
January 1, 2024
Obtaining an insurance certificate for a third-floor extension
January 5, 2024

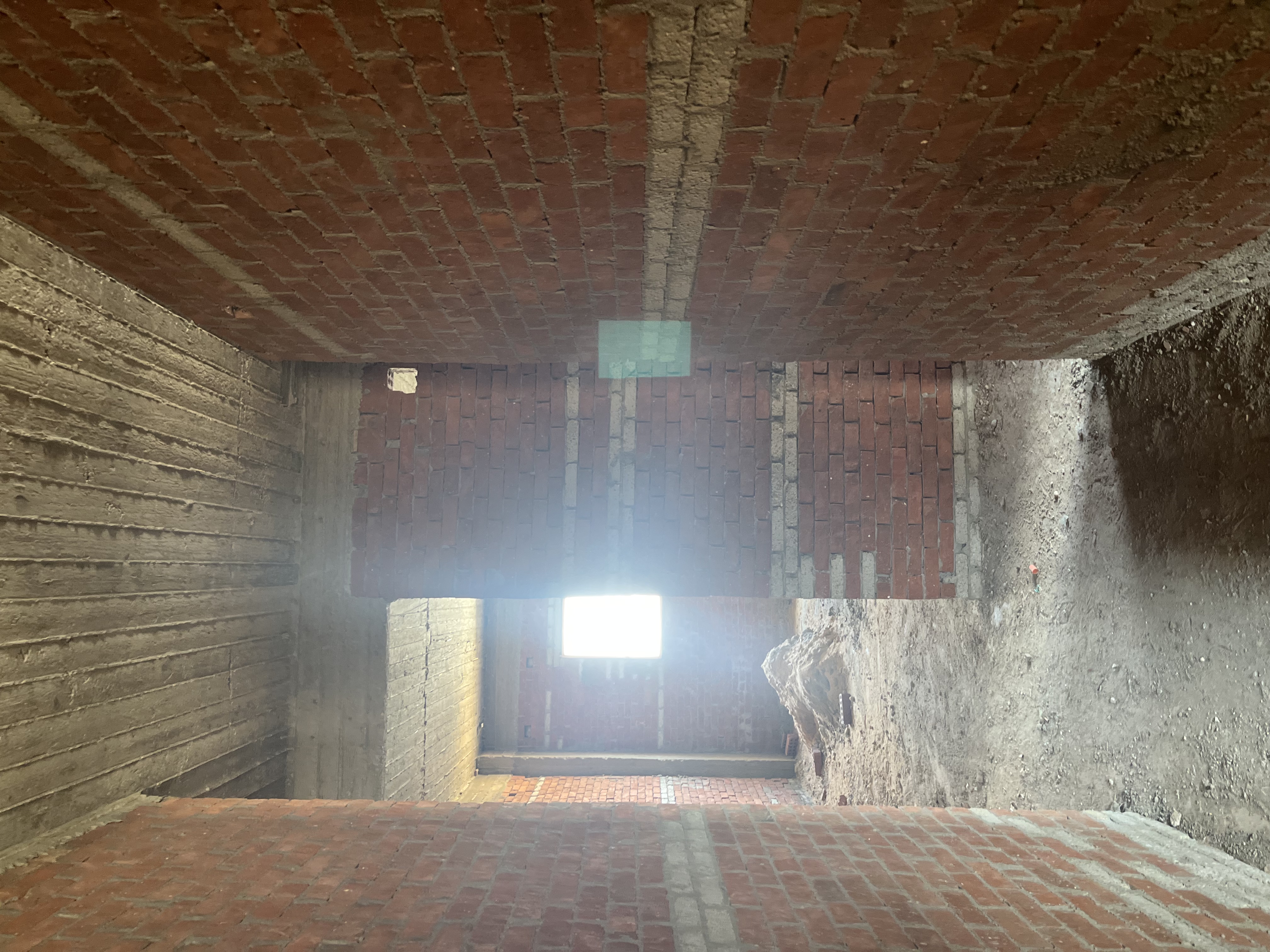

Third floor columns
January 10, 2024

Third floor slab
January 25, 2024

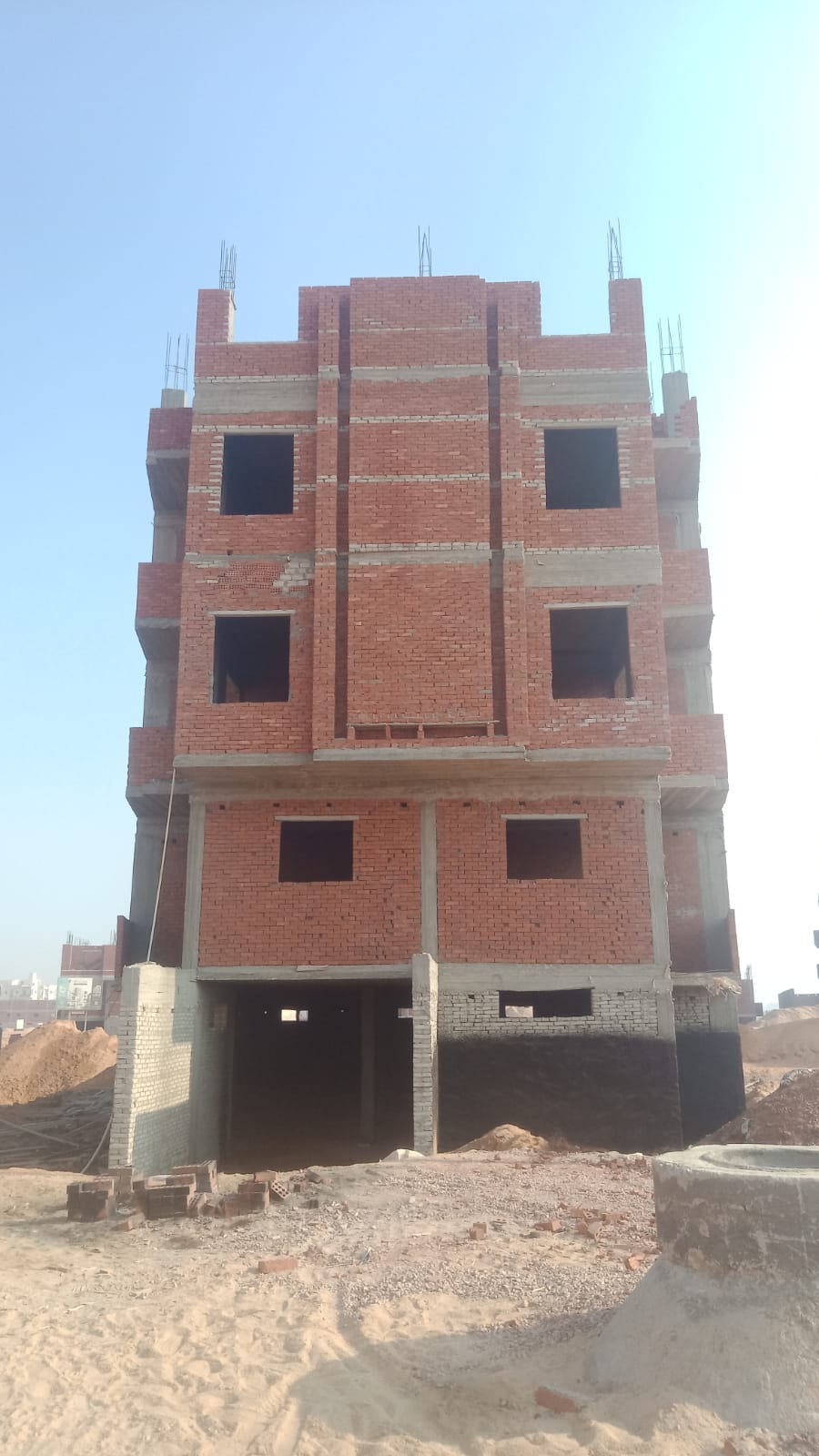

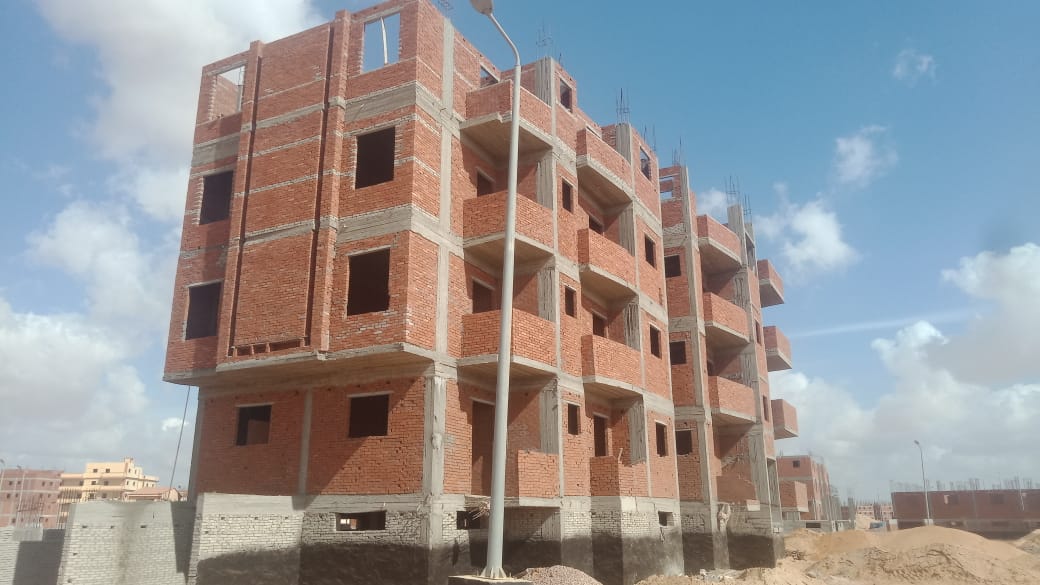

Third floor walls
February 5, 2024
Roof extension license
February 25, 2024
Obtaining a roof insurance certificate
March 1, 2024

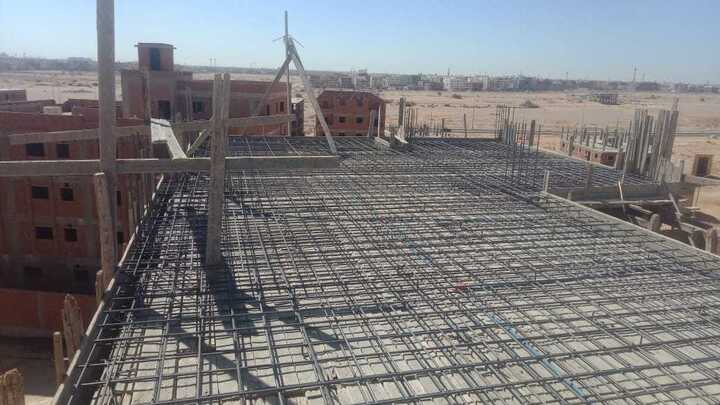

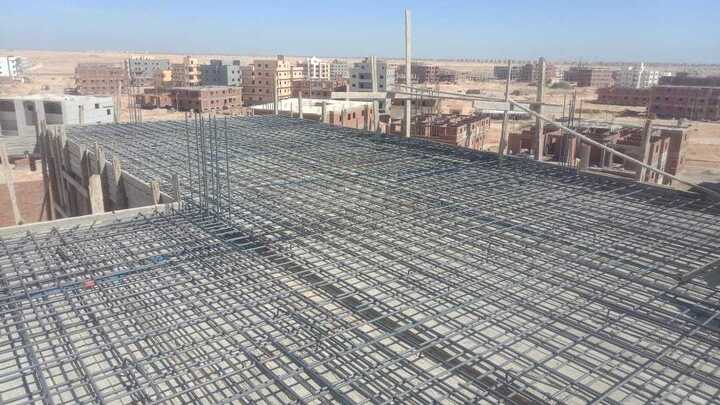

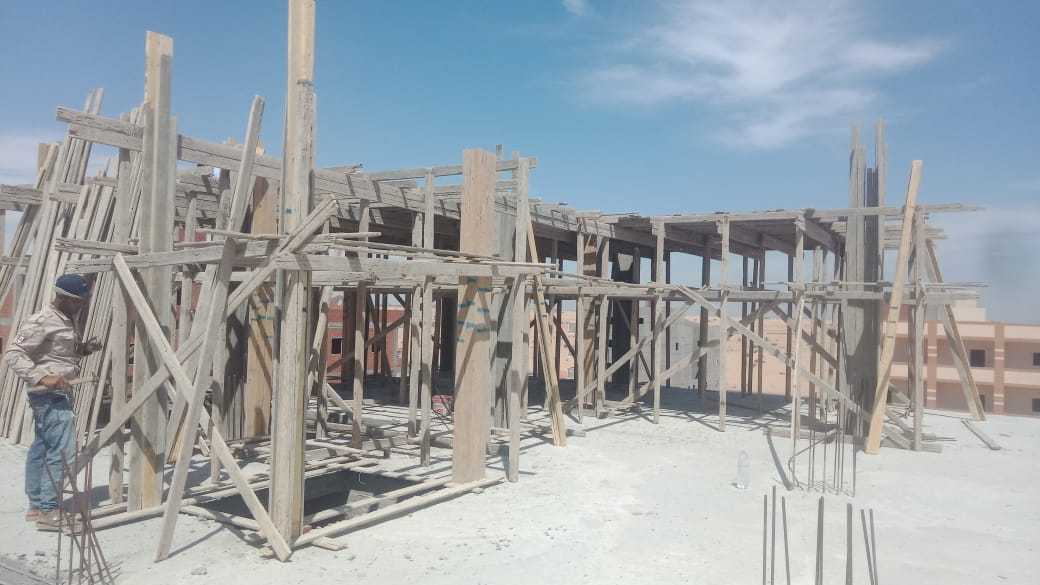

Roof concrete works
March 5, 2024

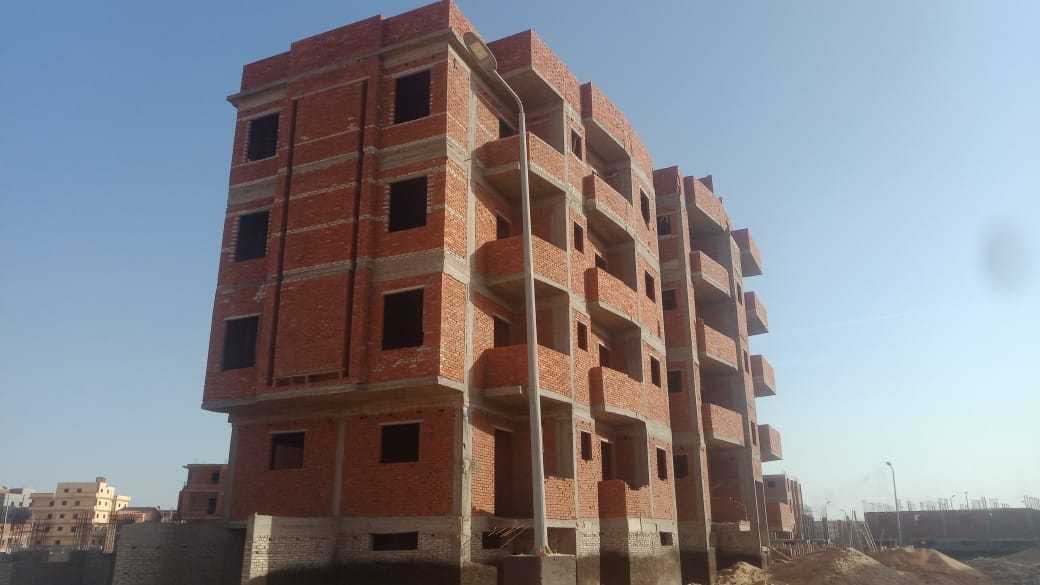

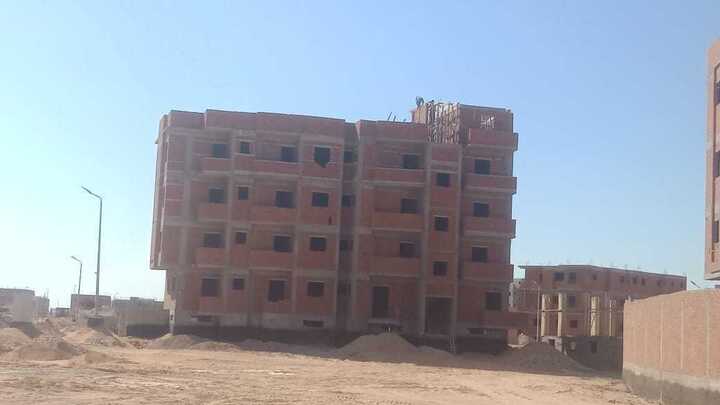

Roof walls

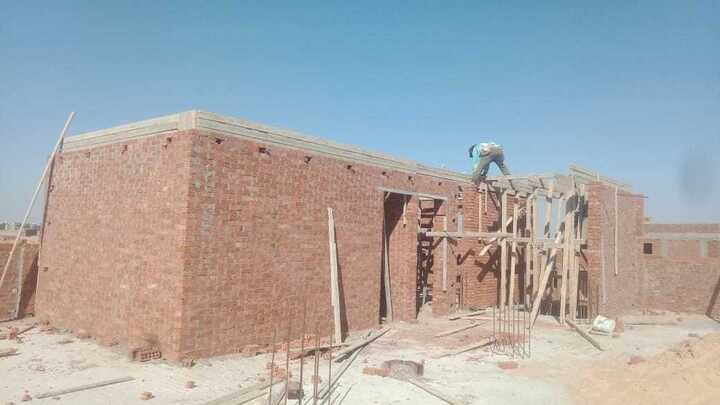

March 20, 2024

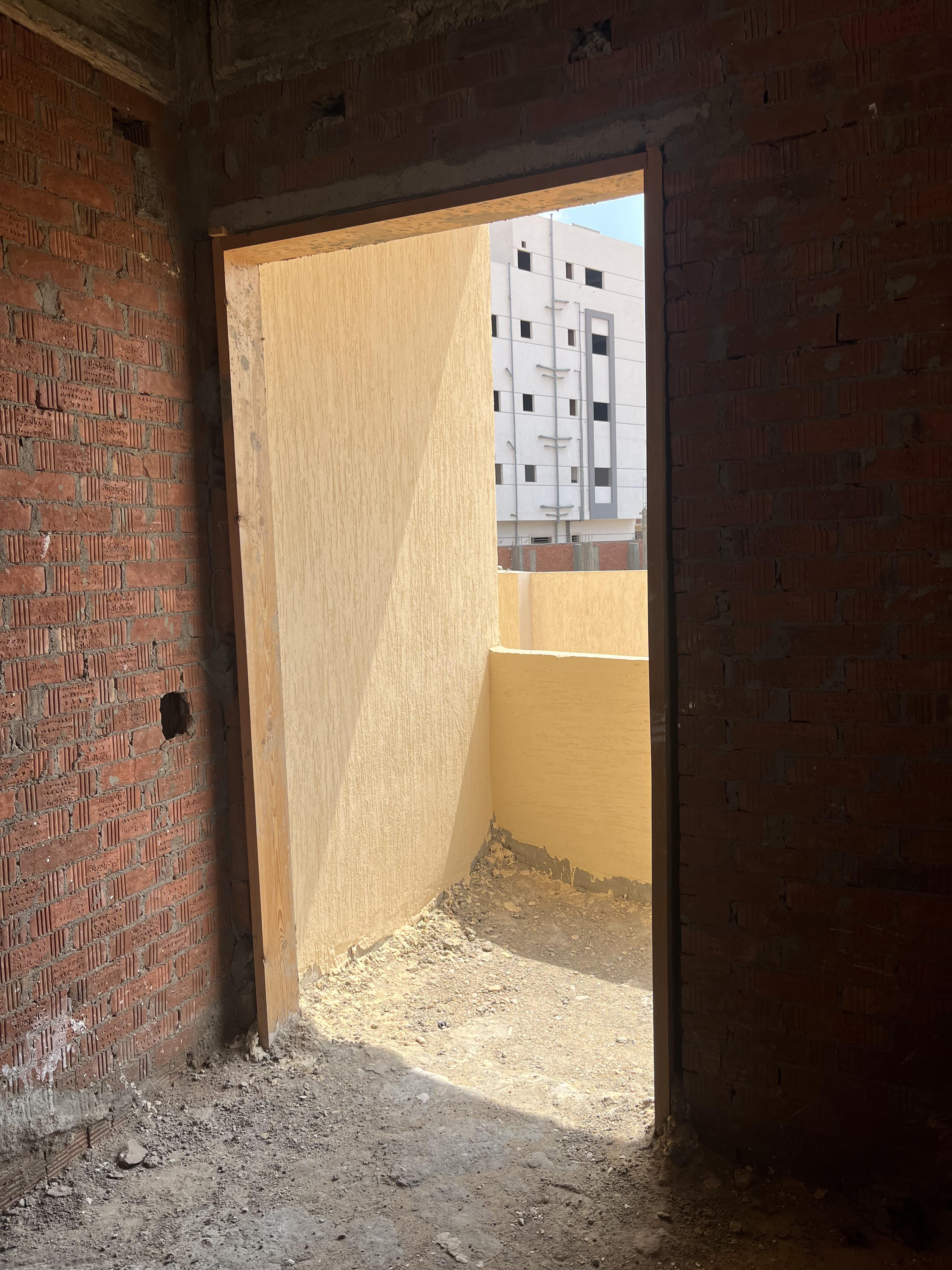

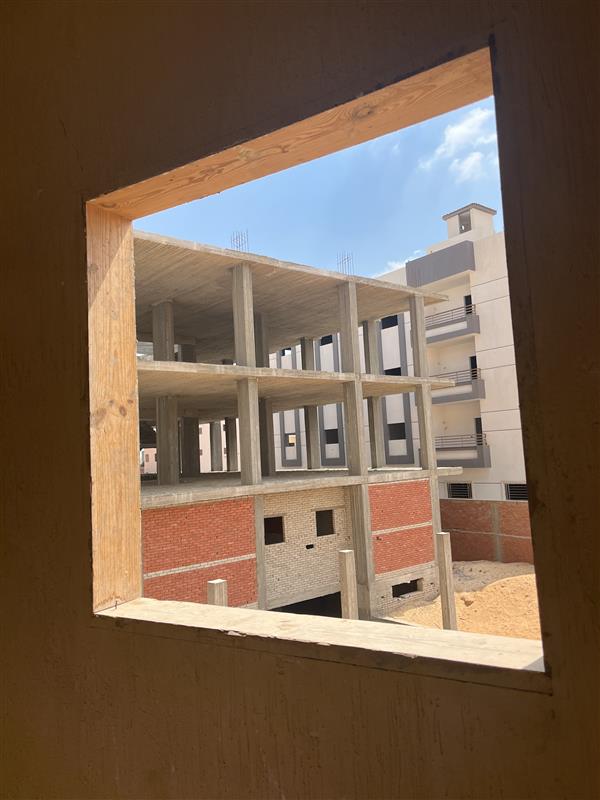

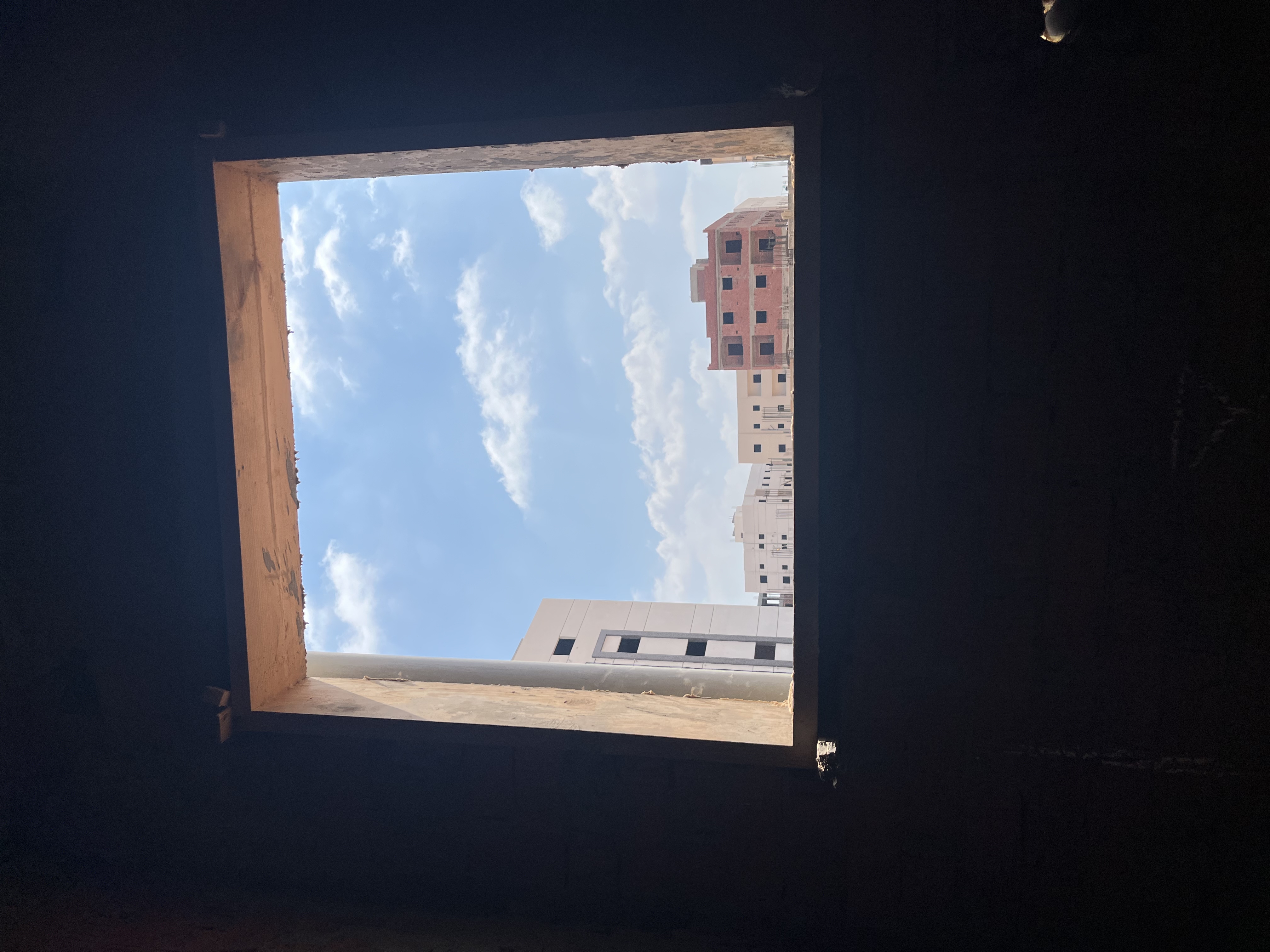

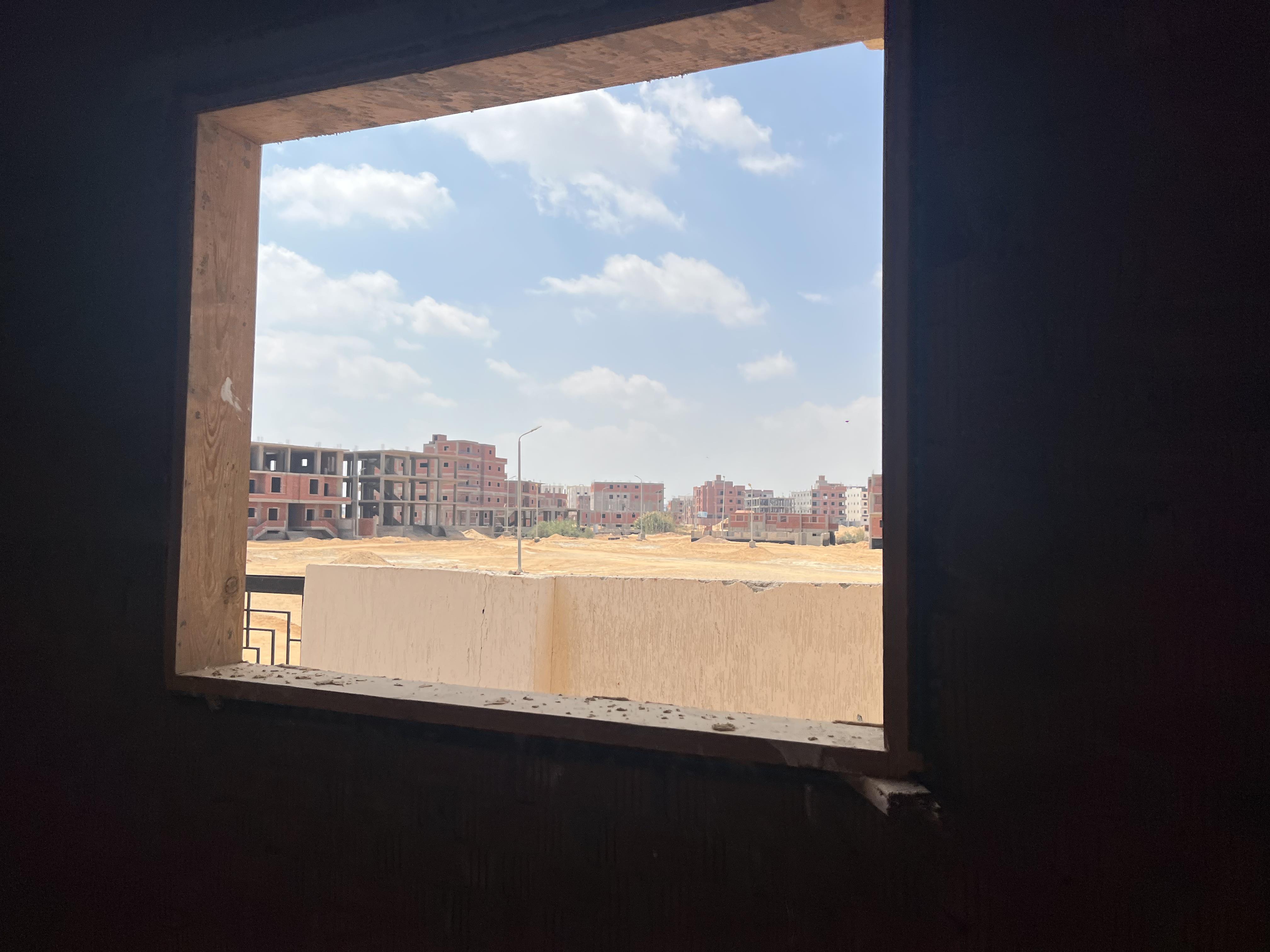

Wooden door frames

April 1, 2024

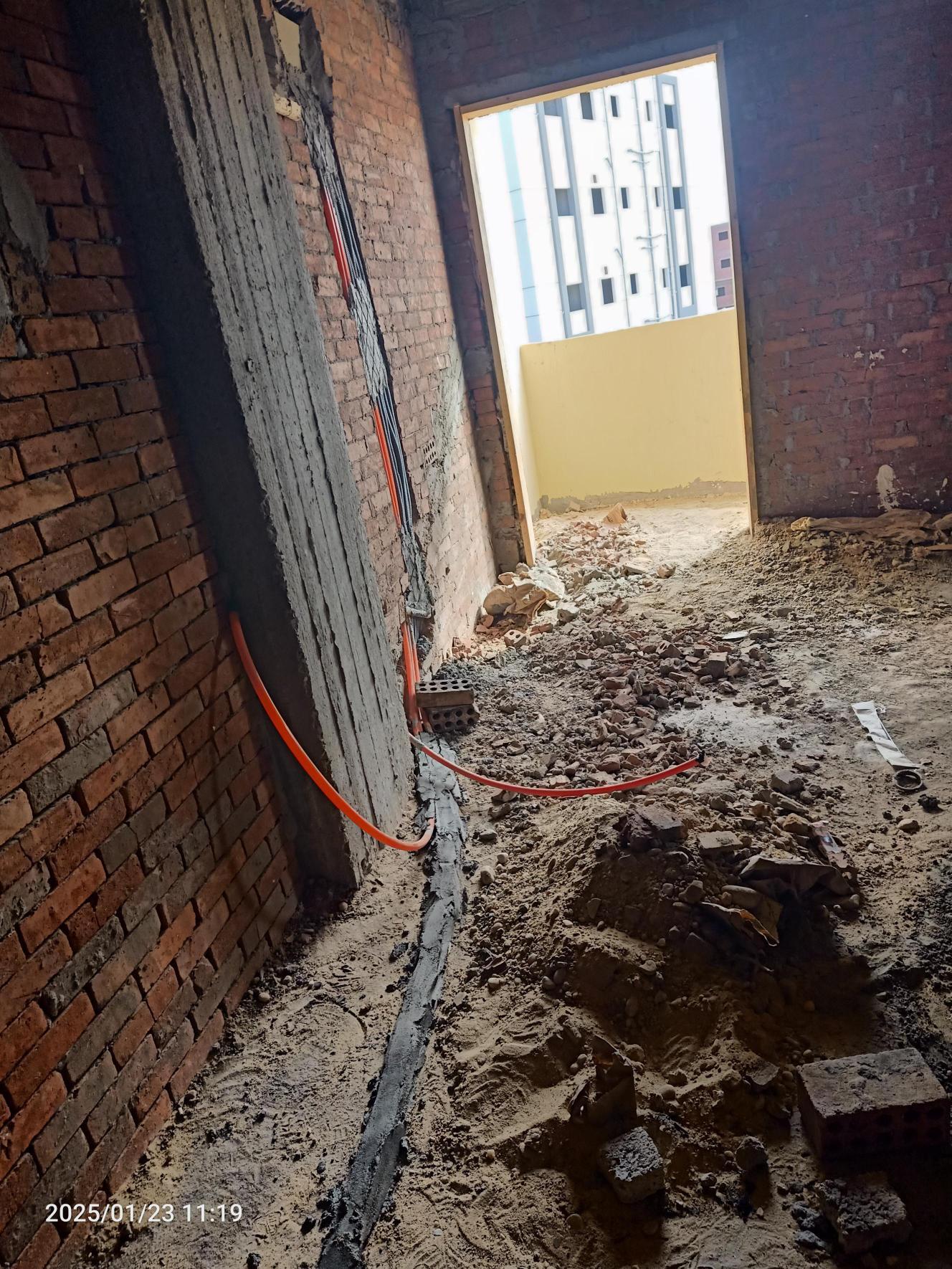

Electrical works

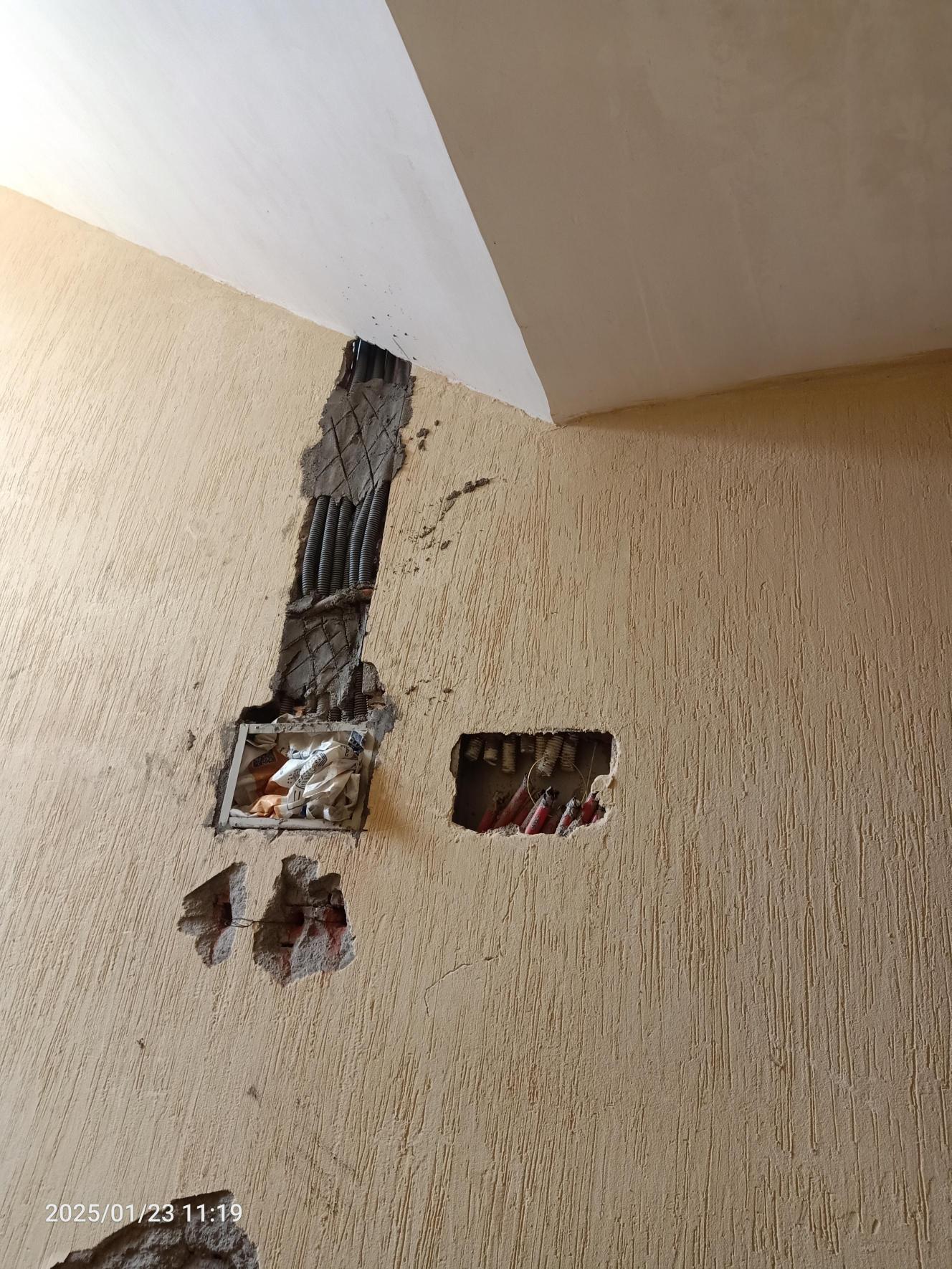

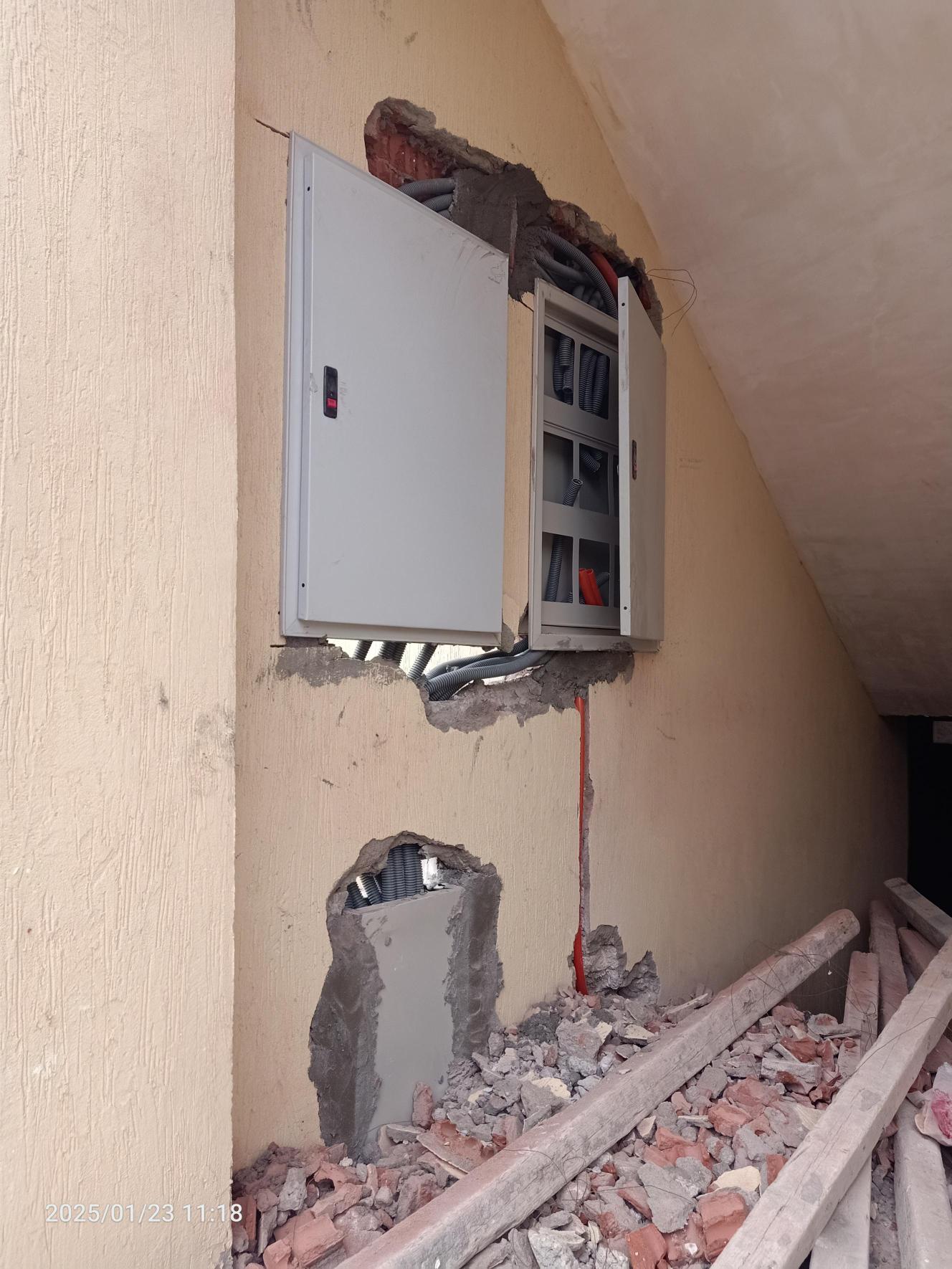

April 15, 2024

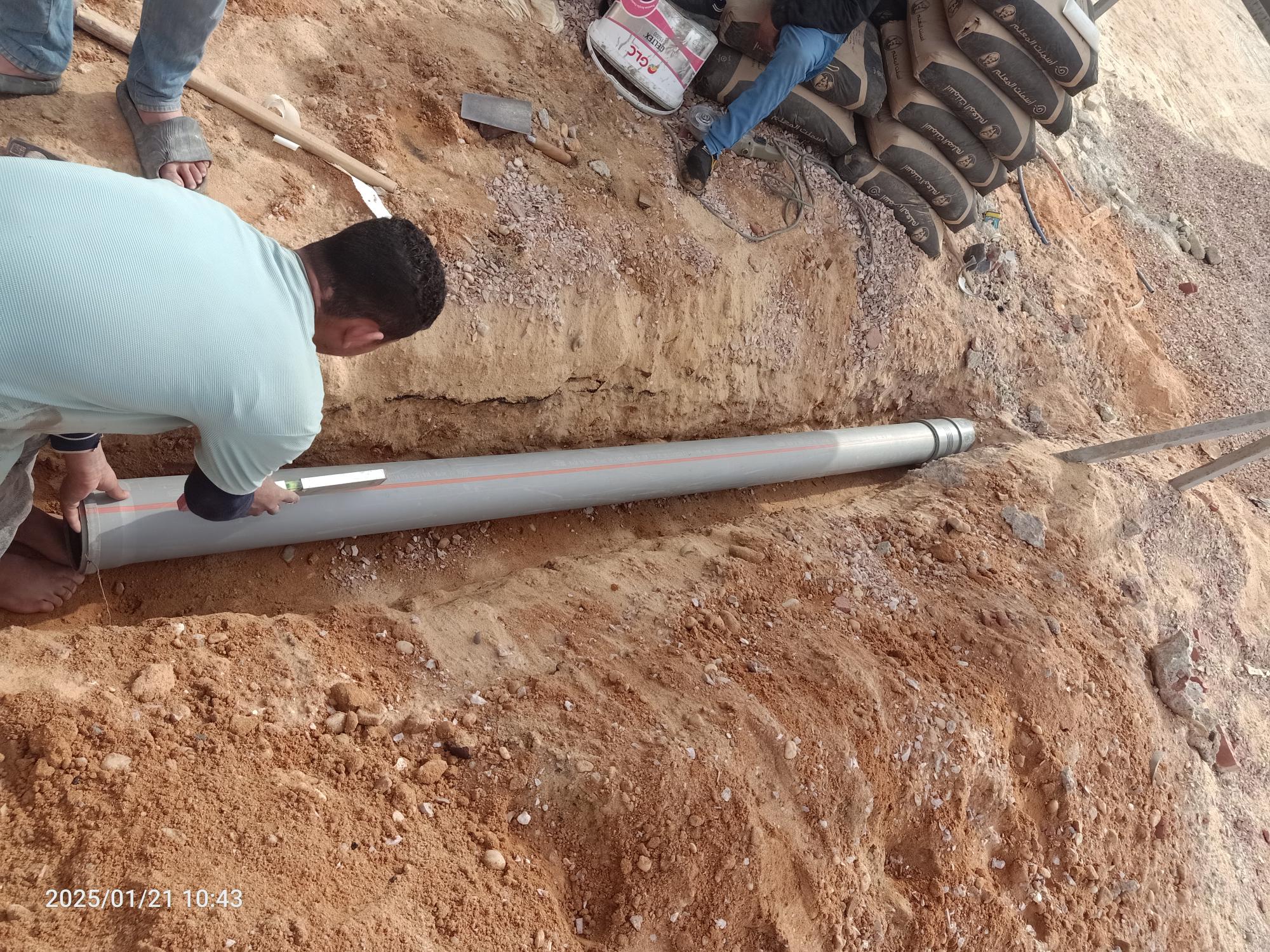

Plumbing works
April 20, 2024

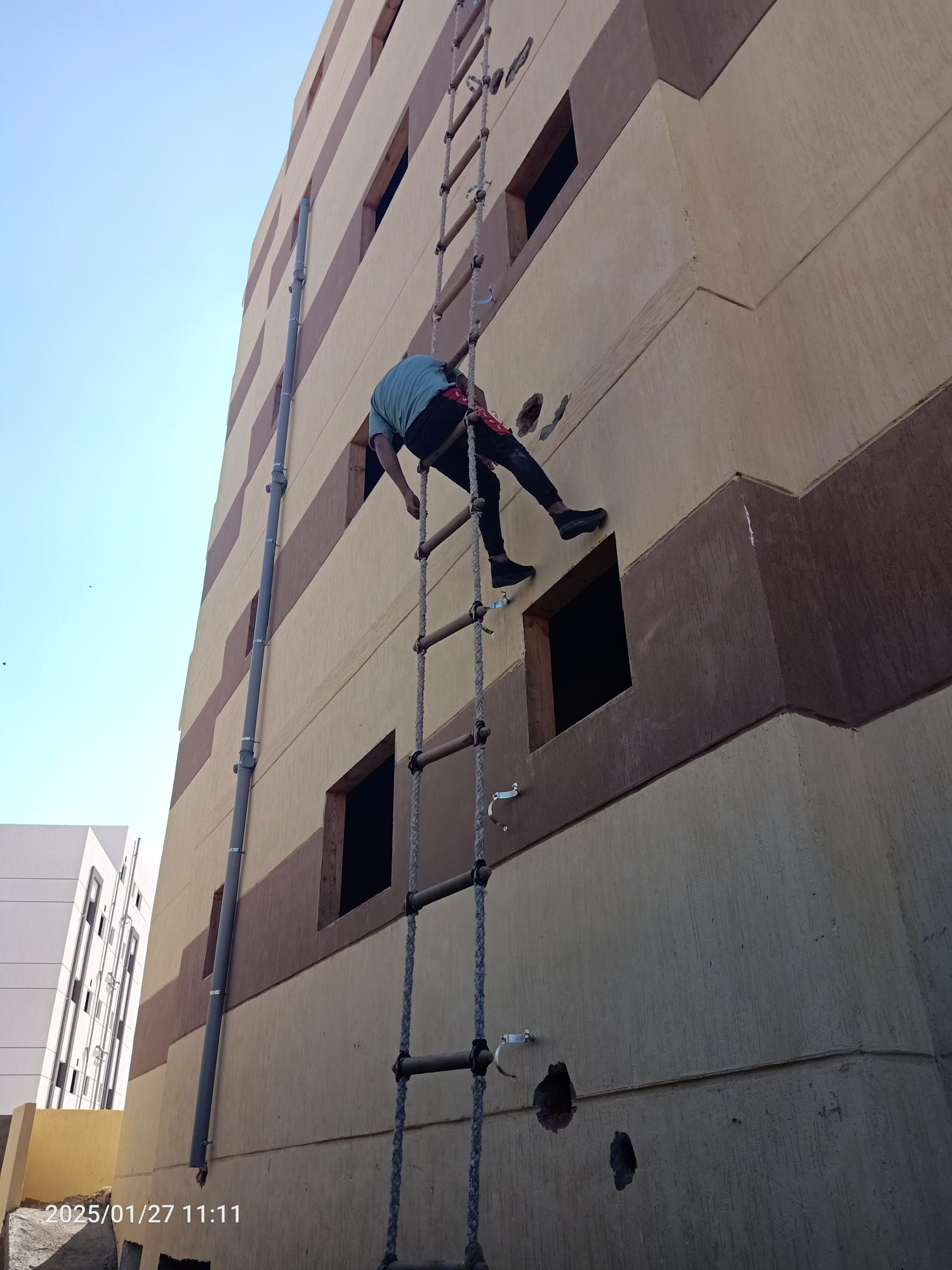

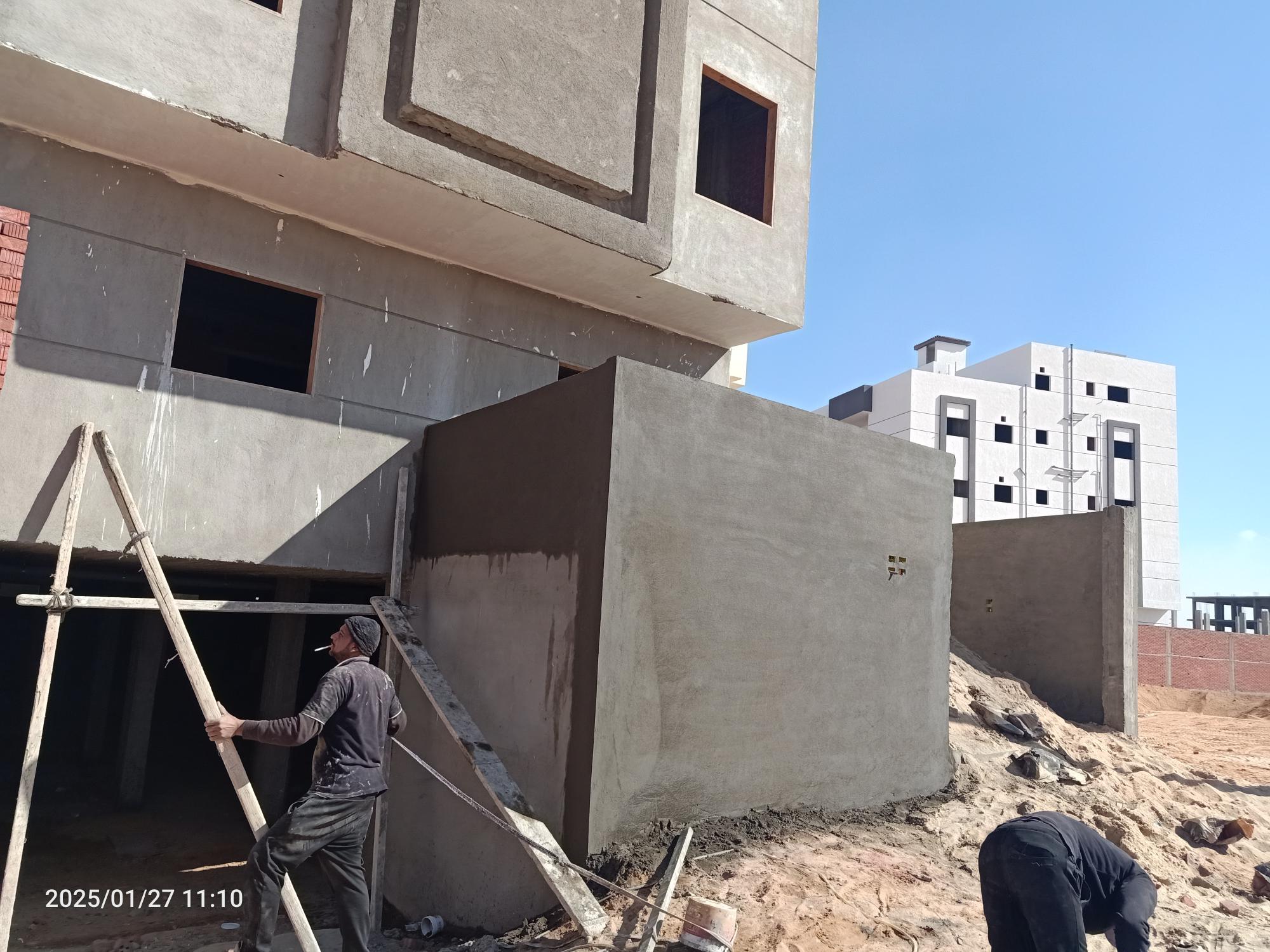

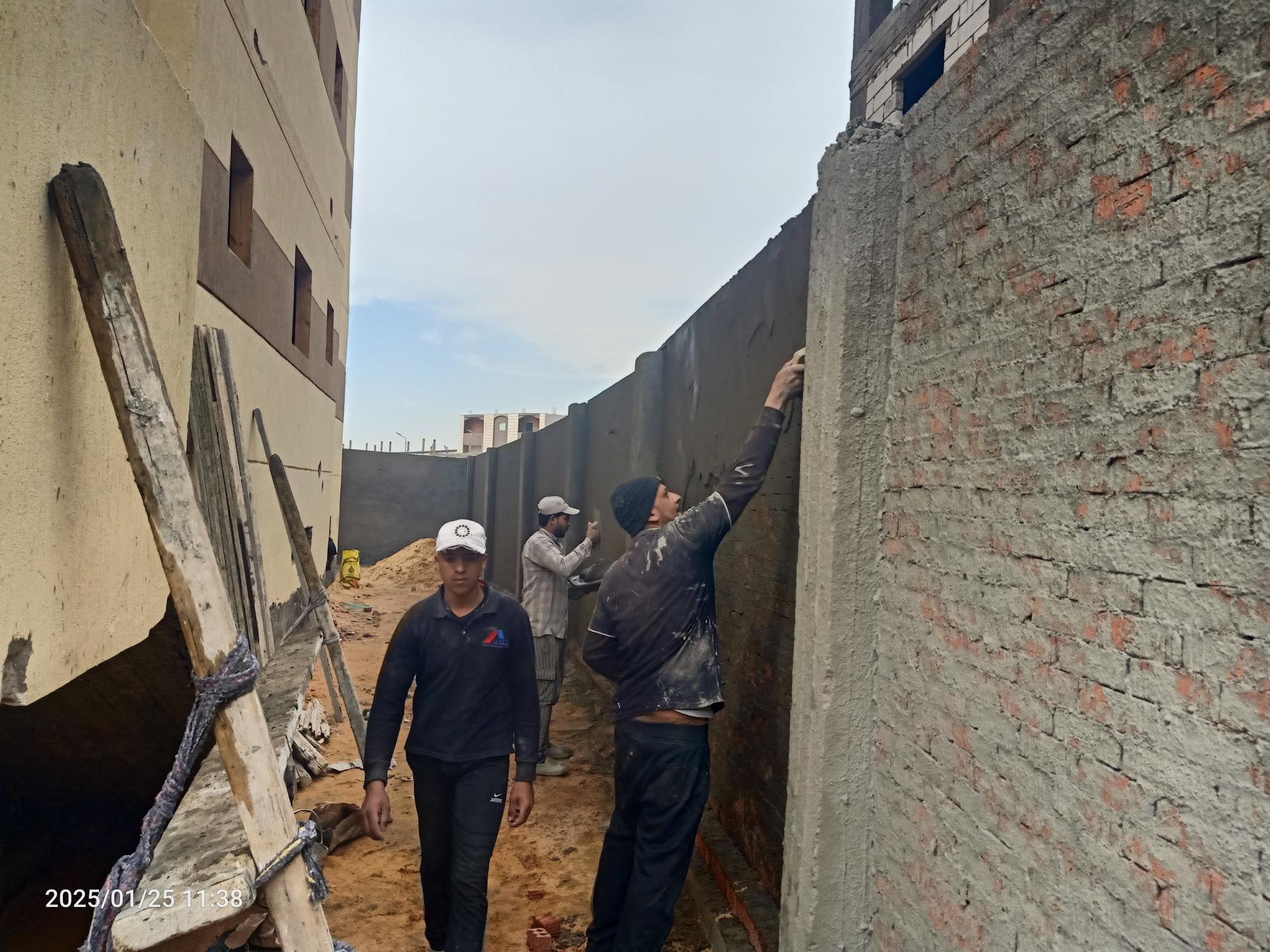

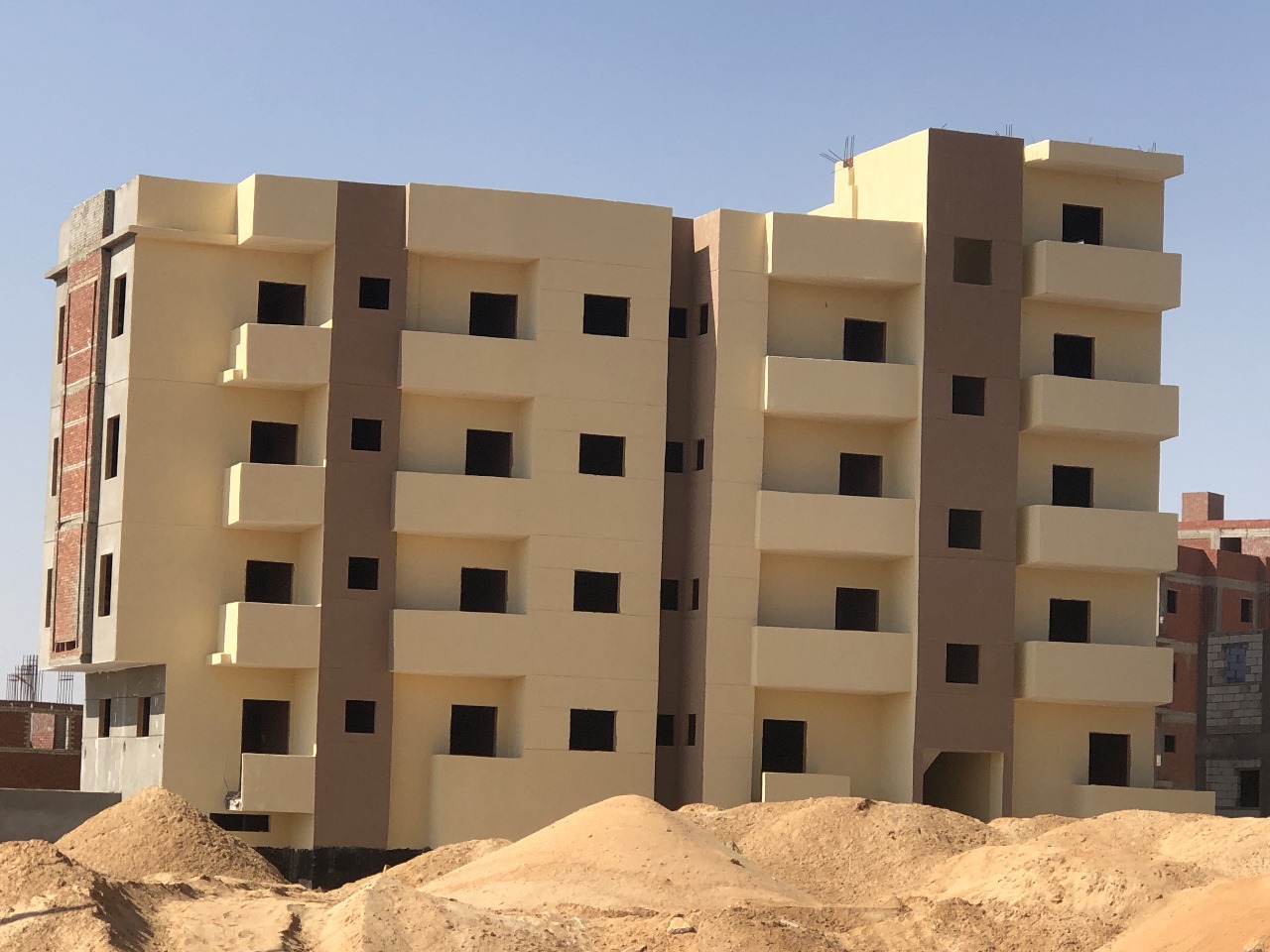

Plaster and putty

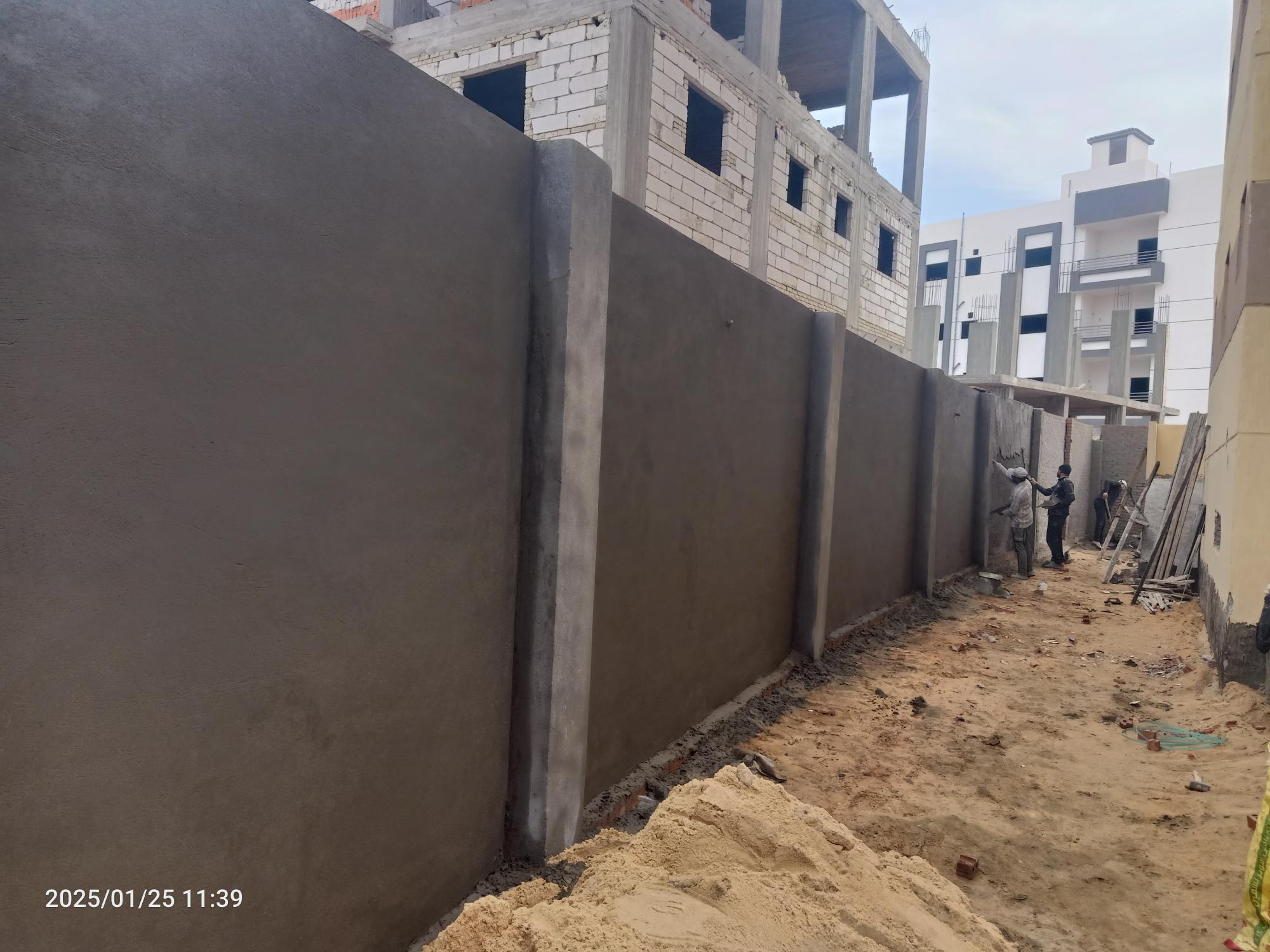

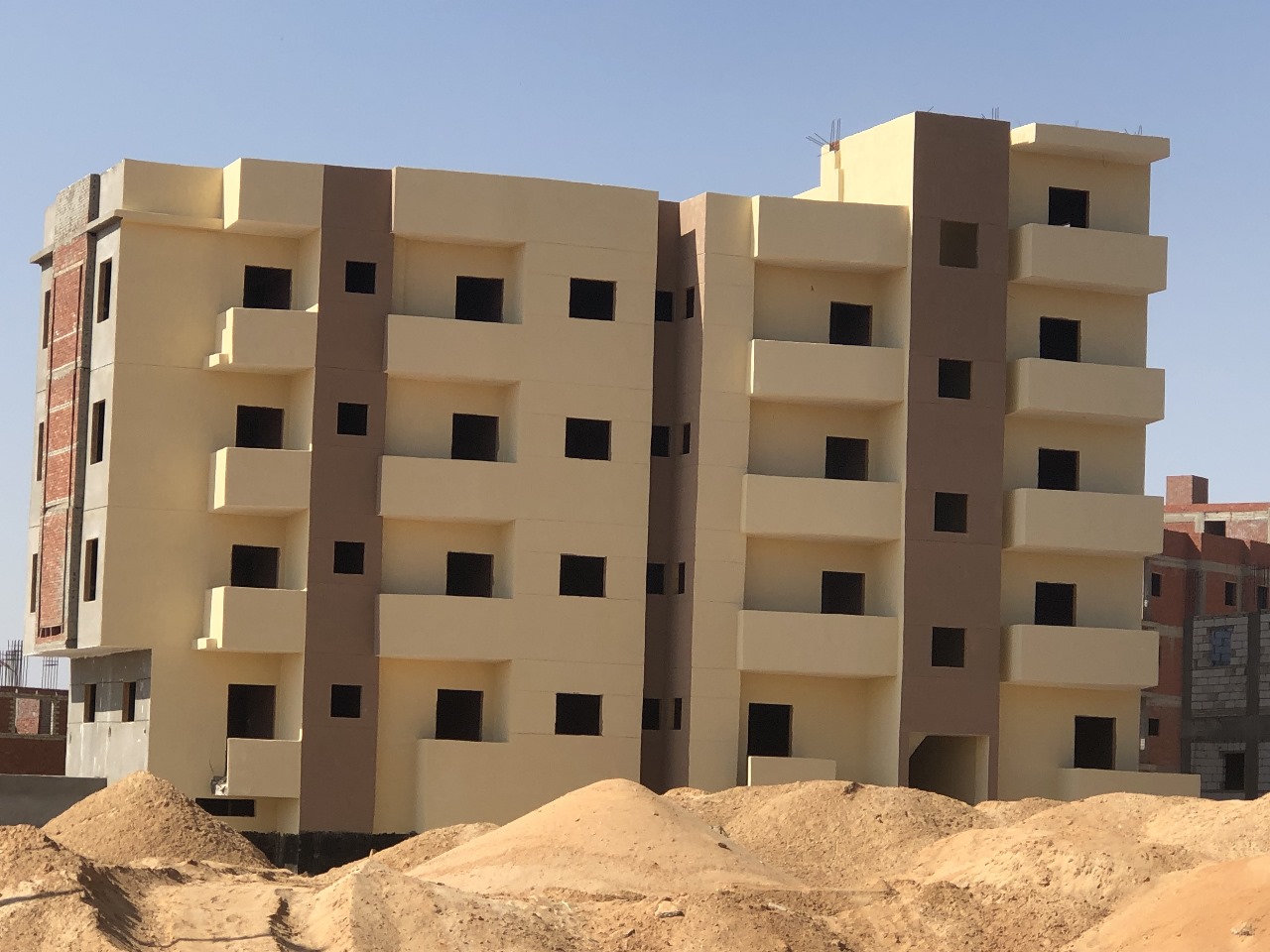

May 1, 2024

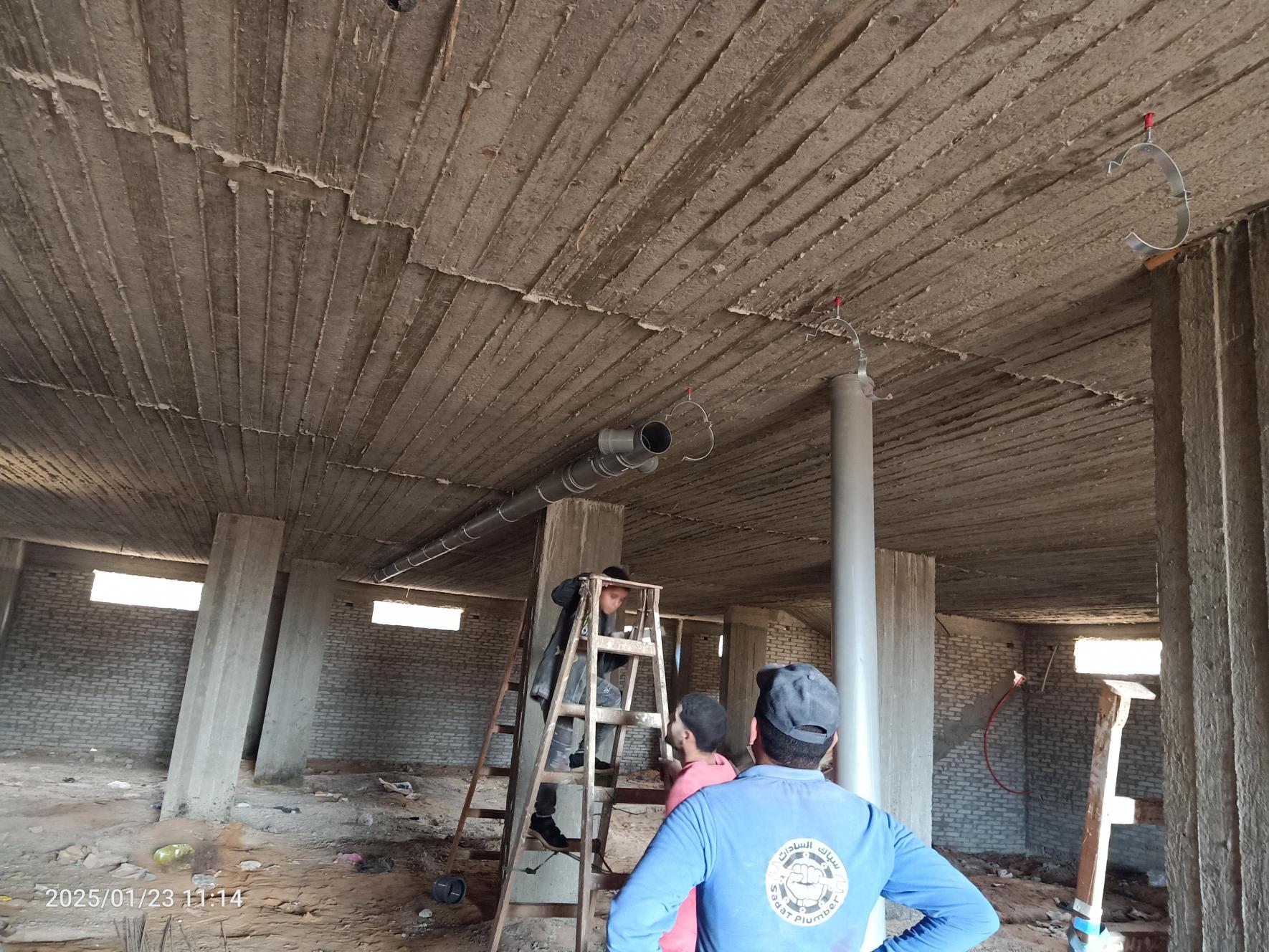

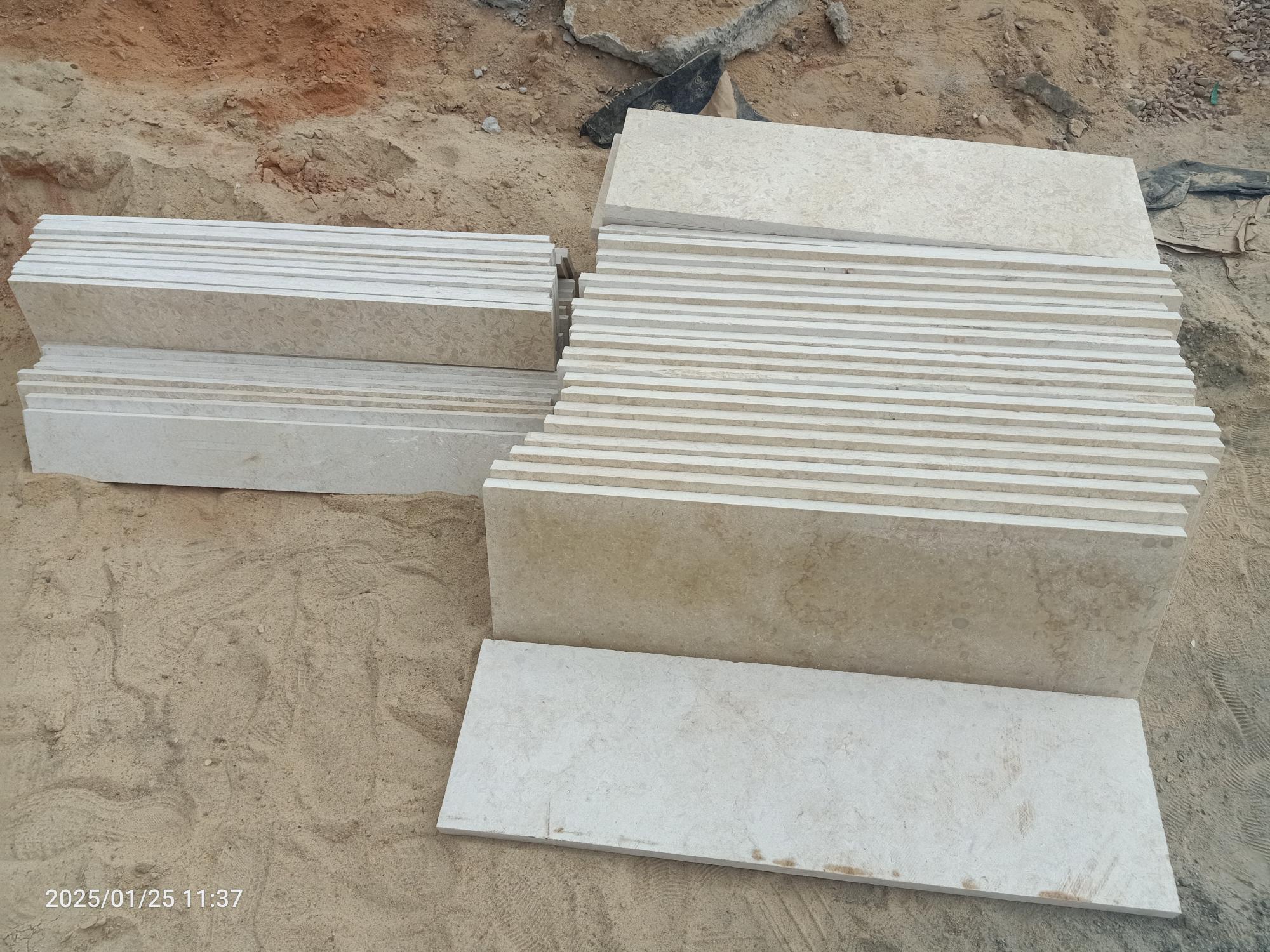

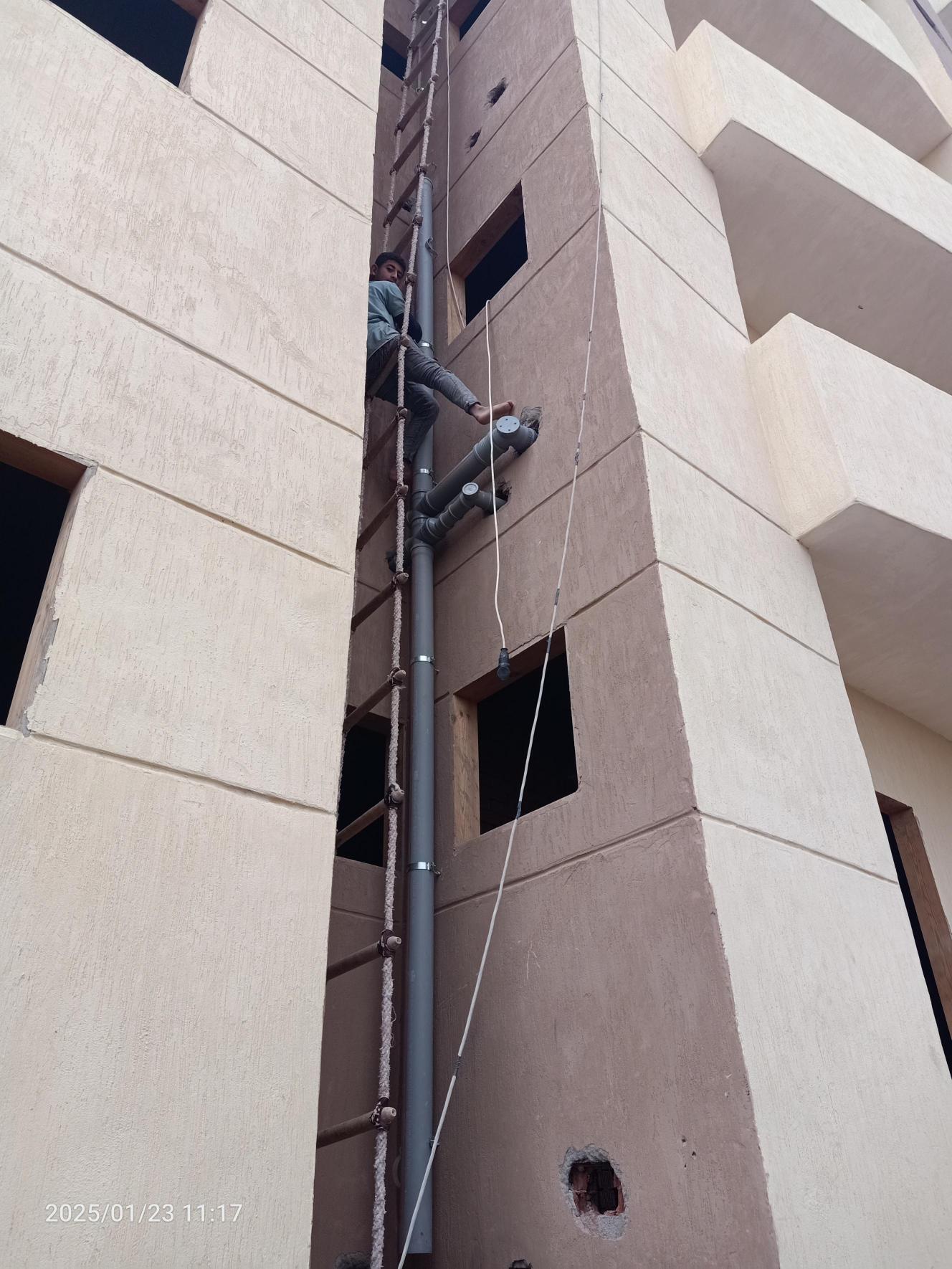

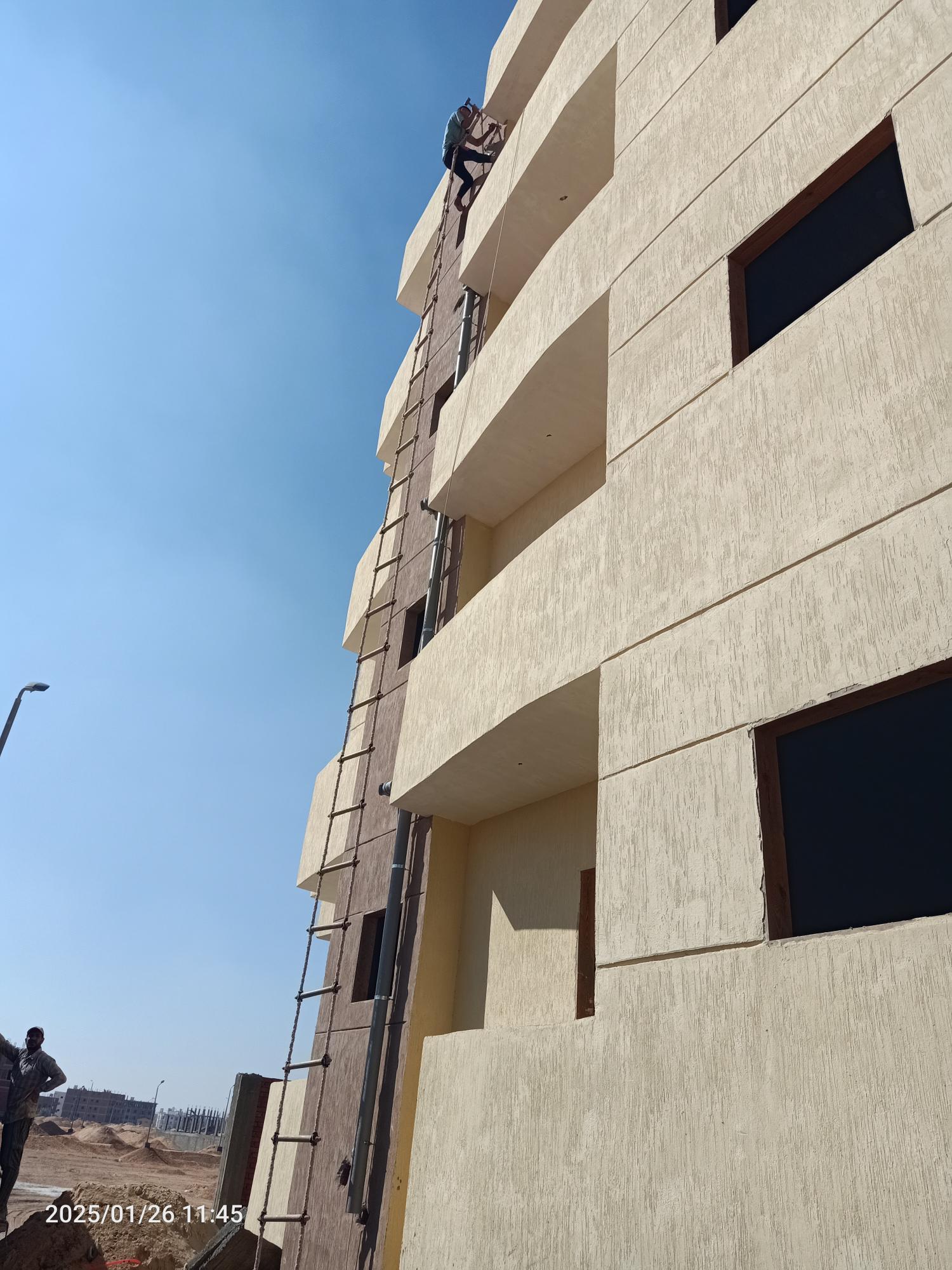

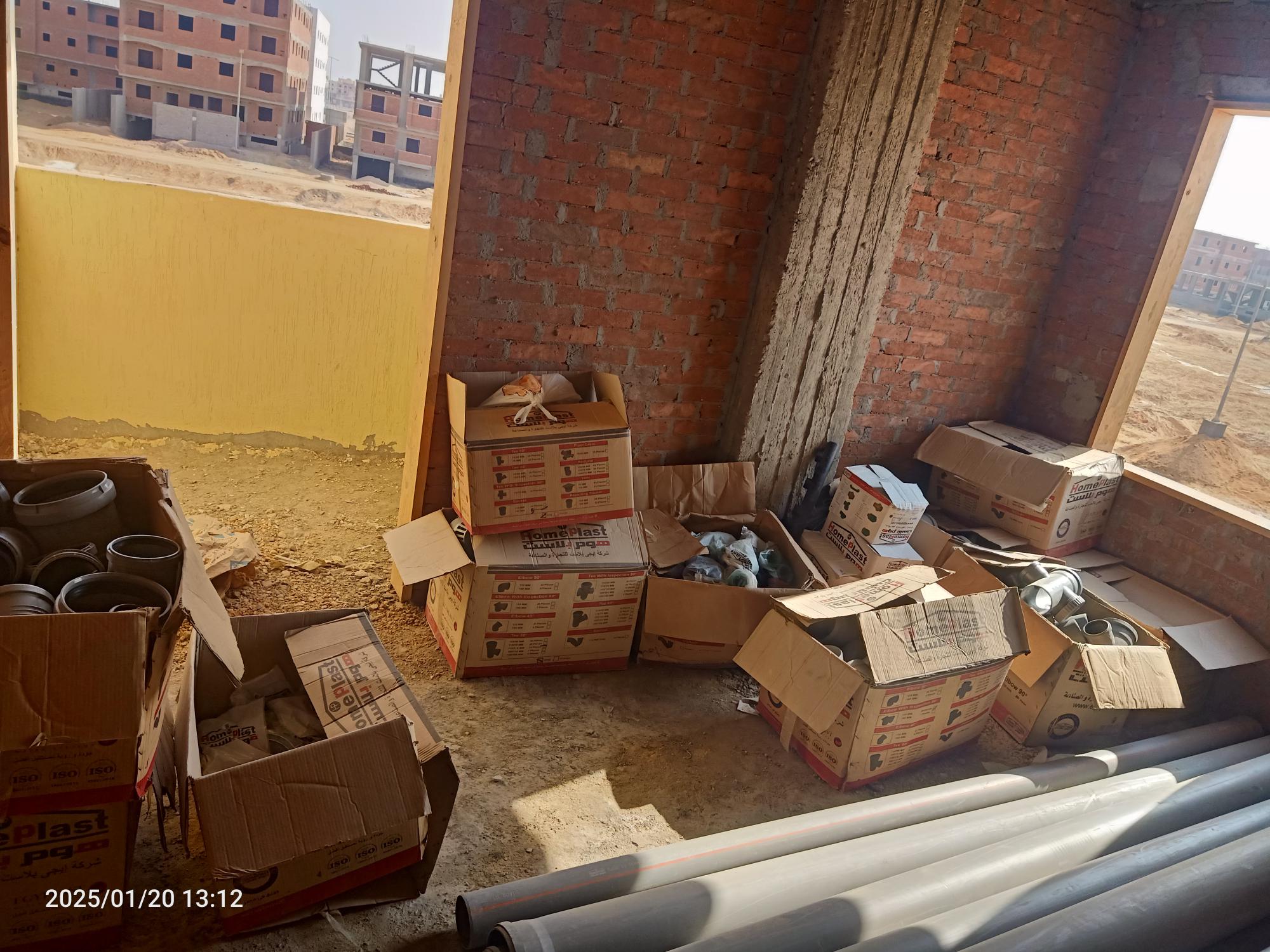

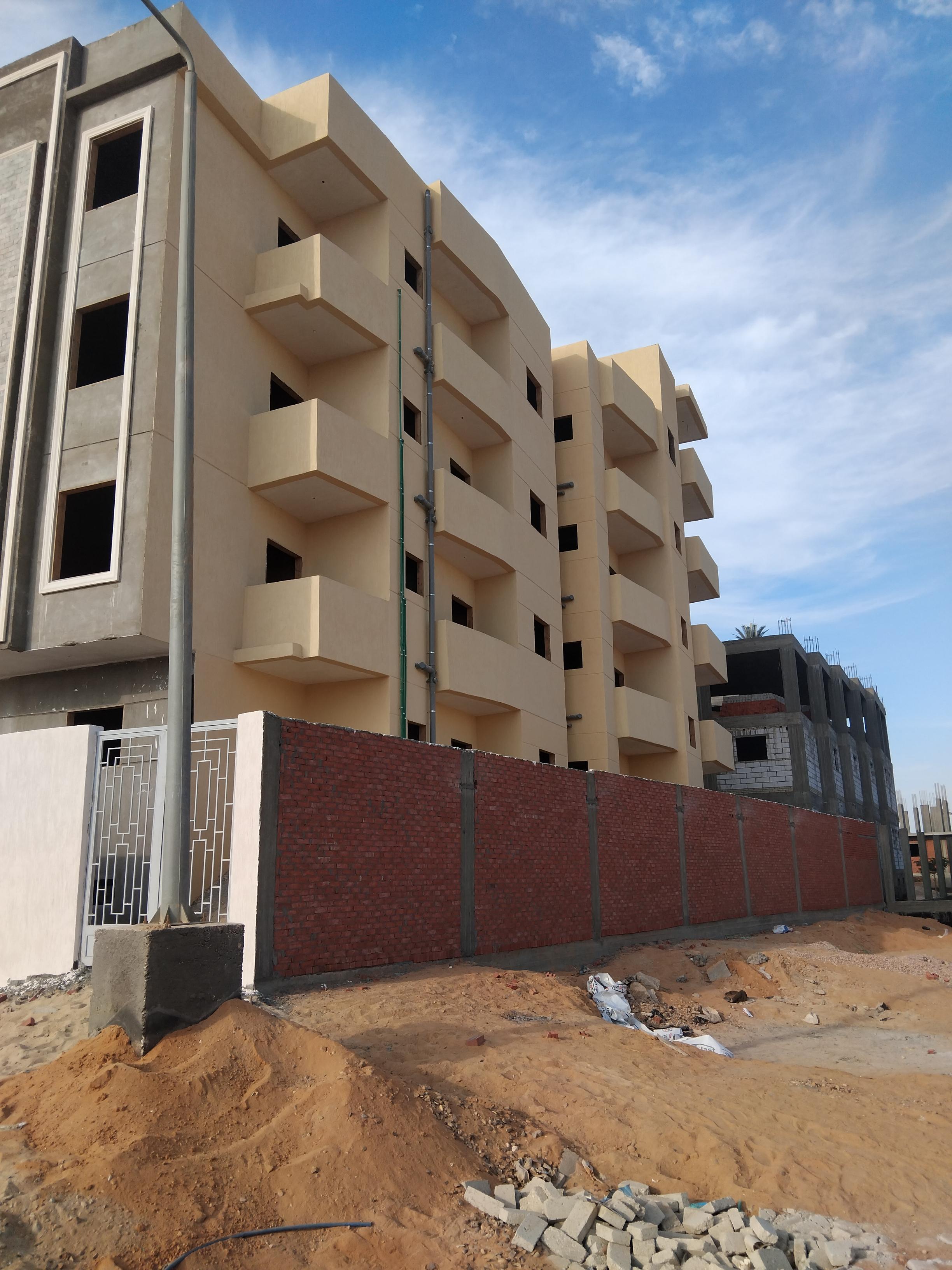

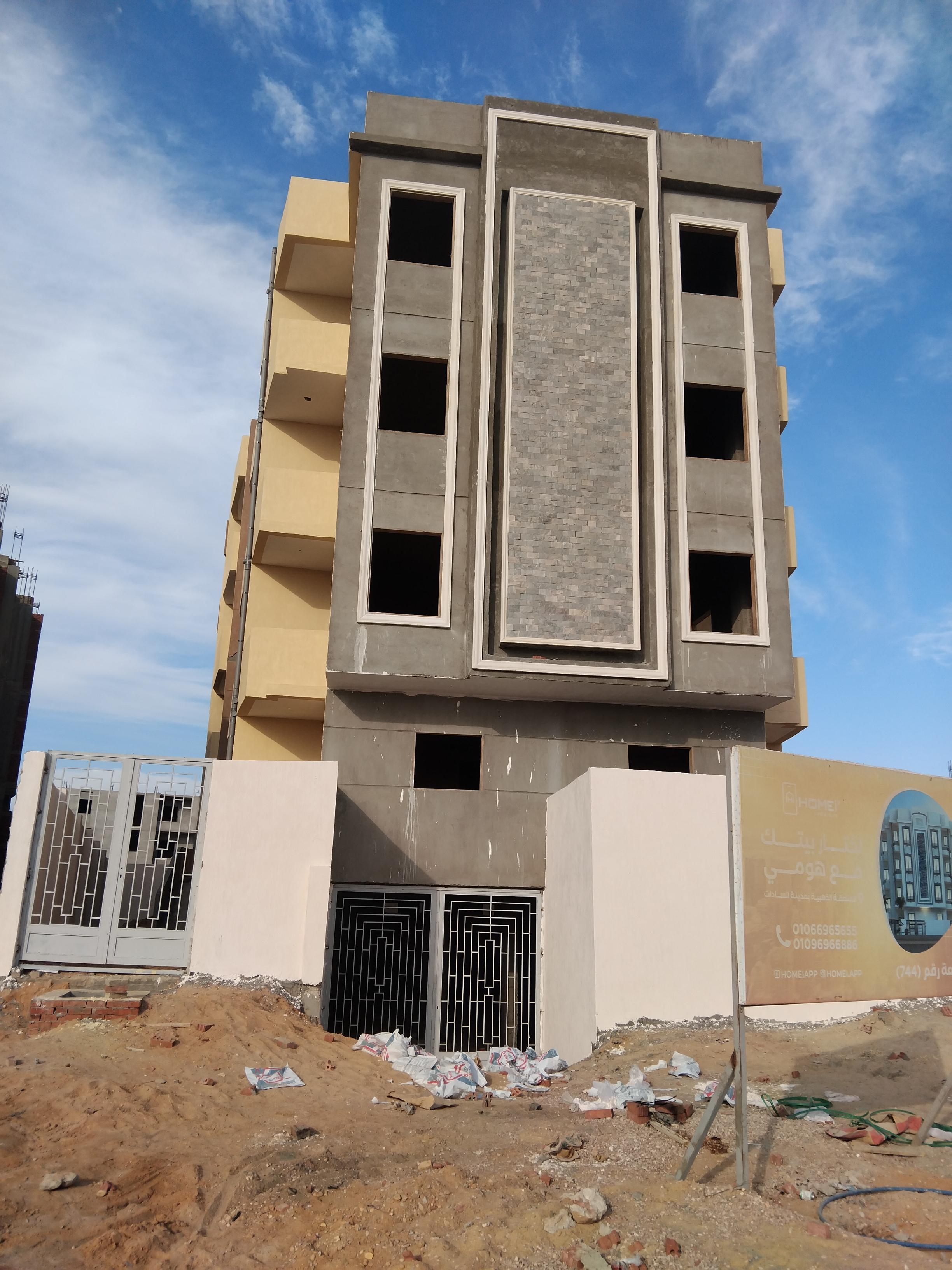

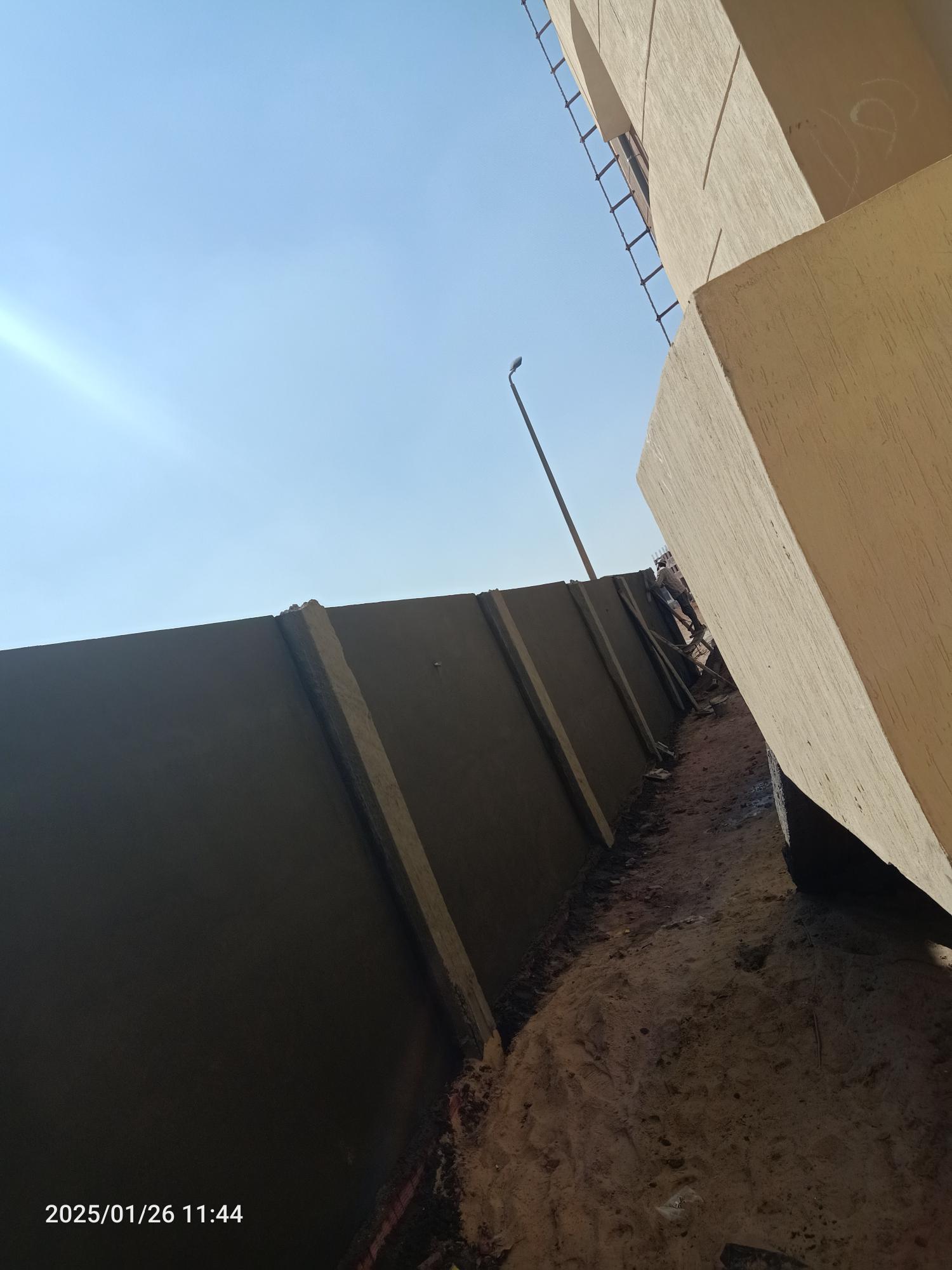

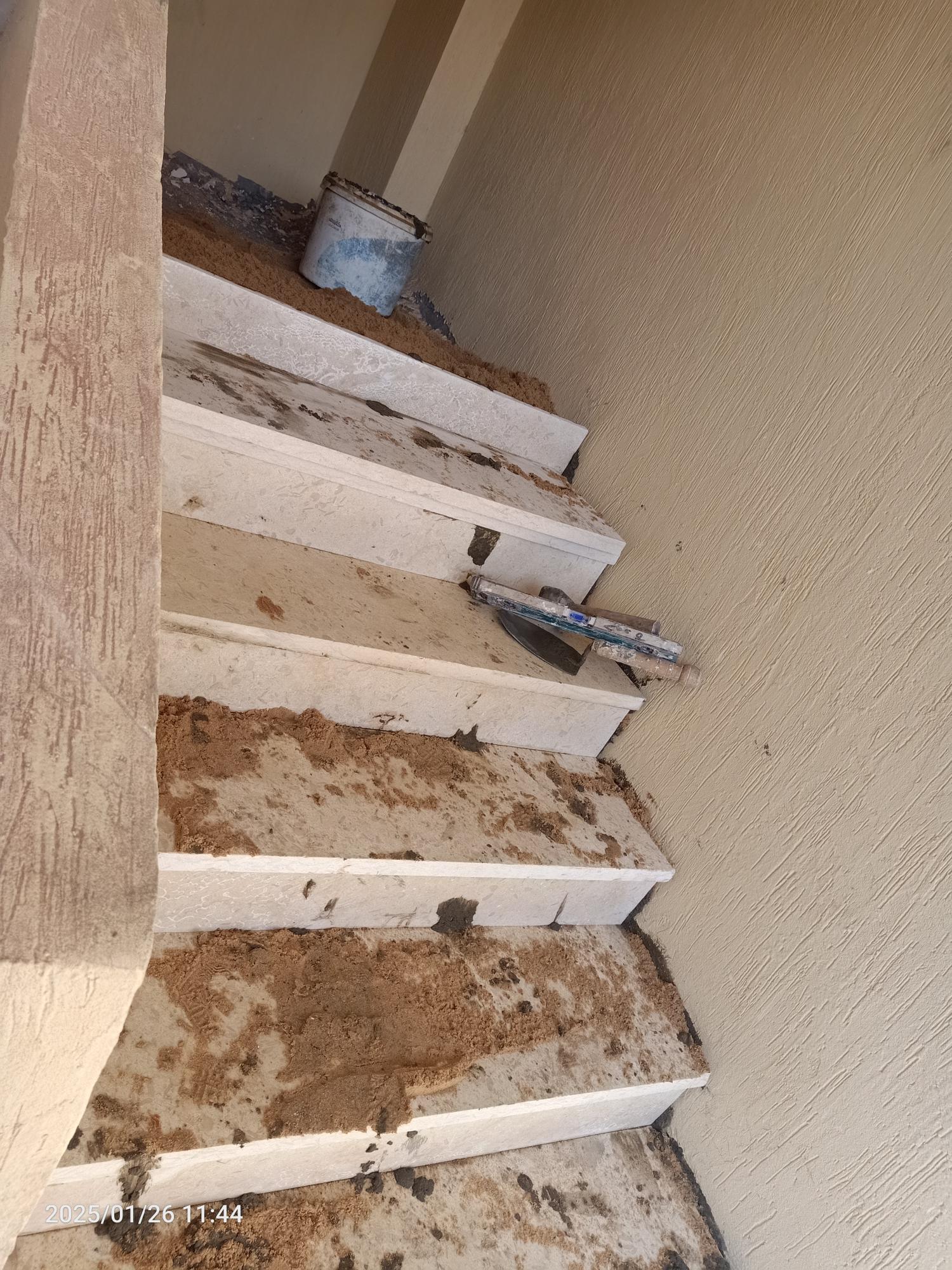

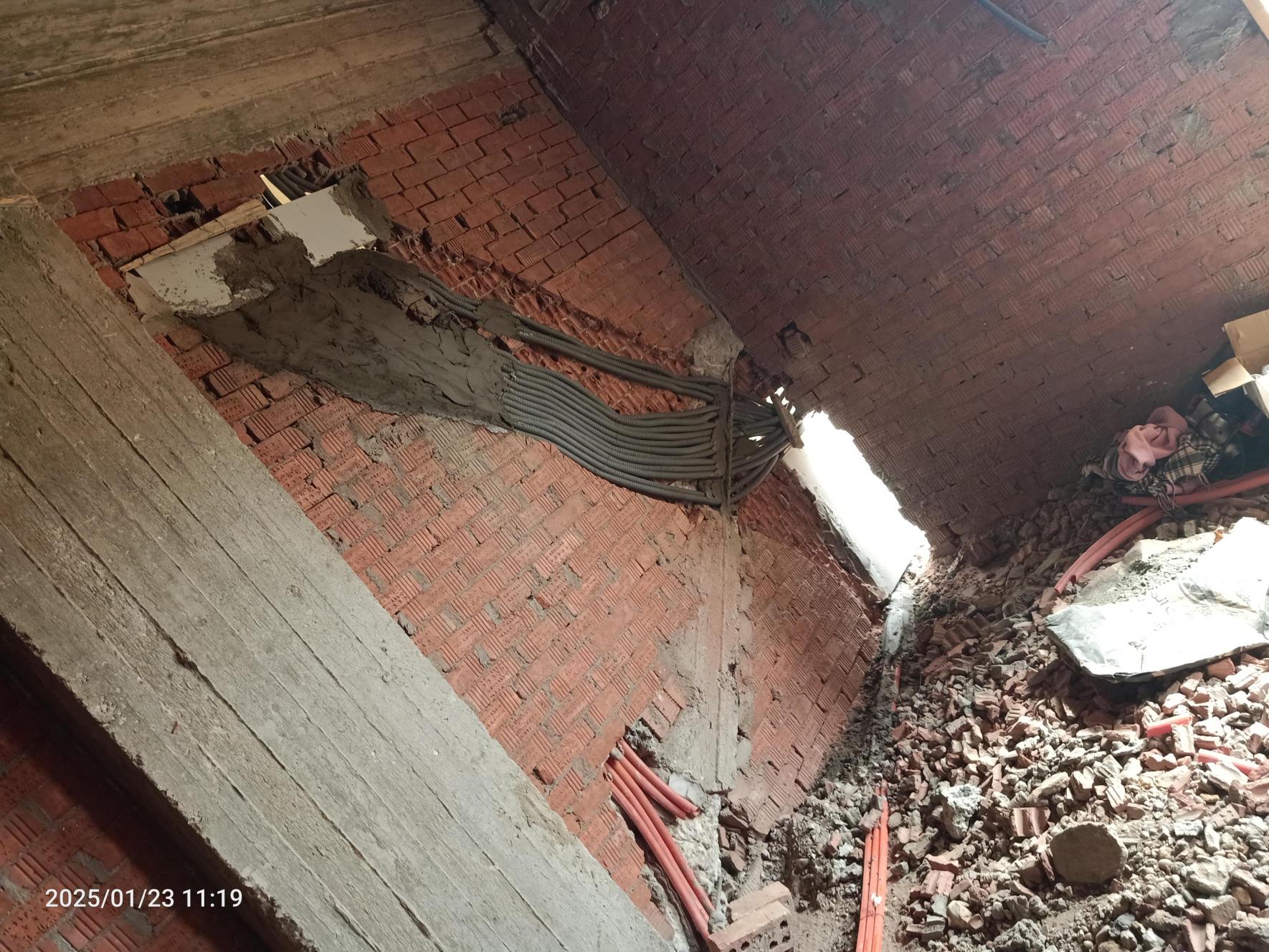

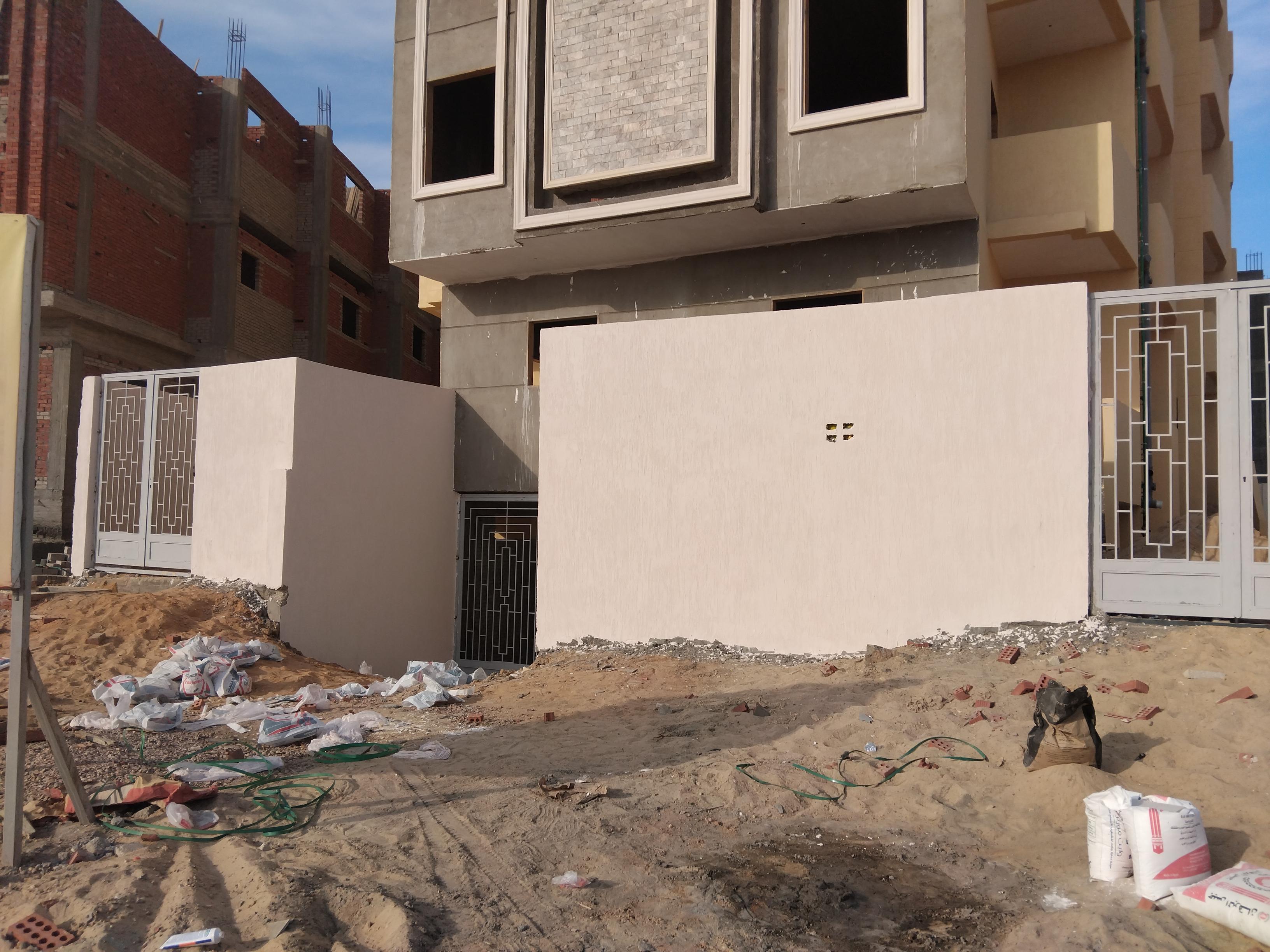

Finishing works

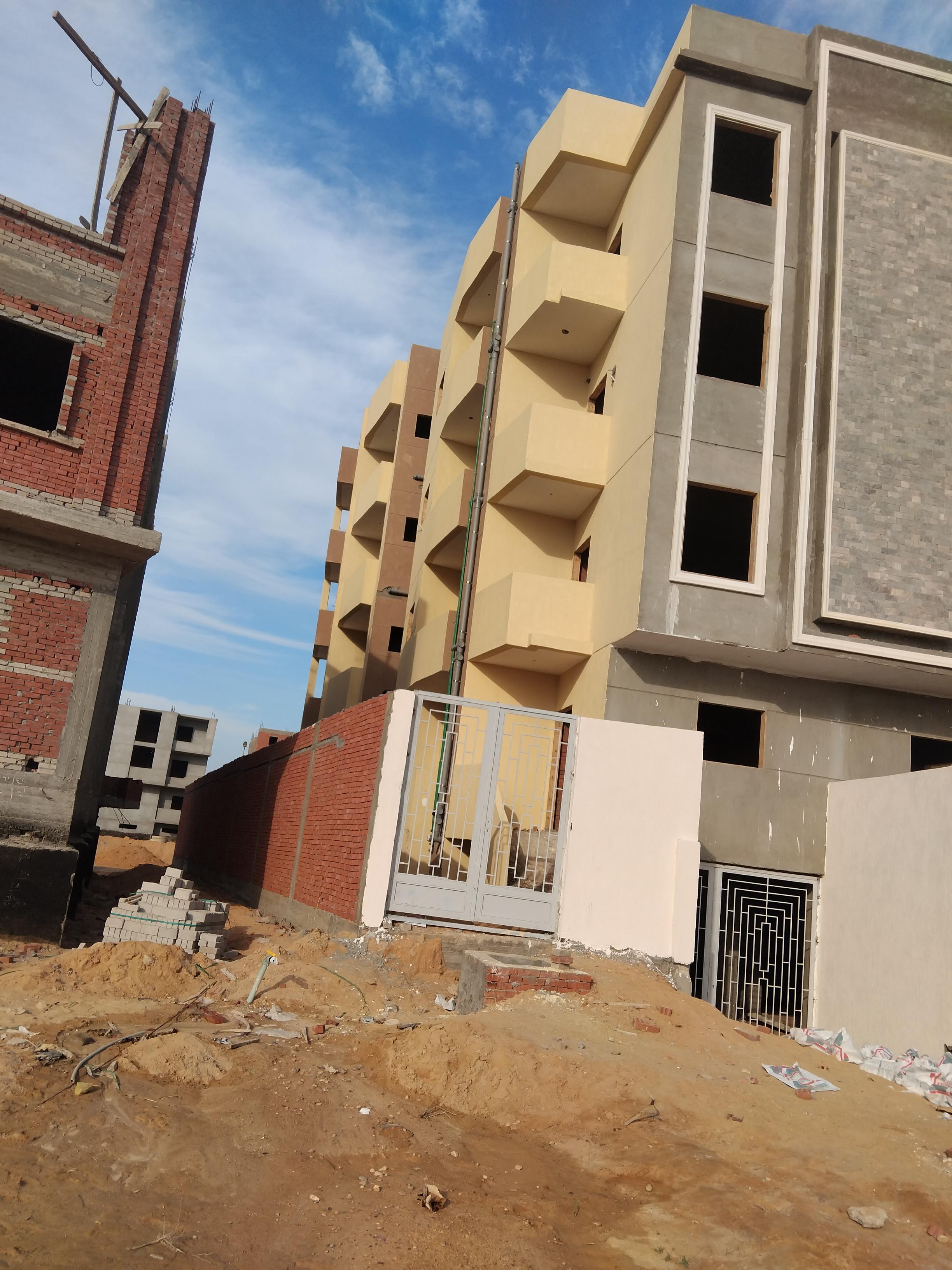

January 20, 2025

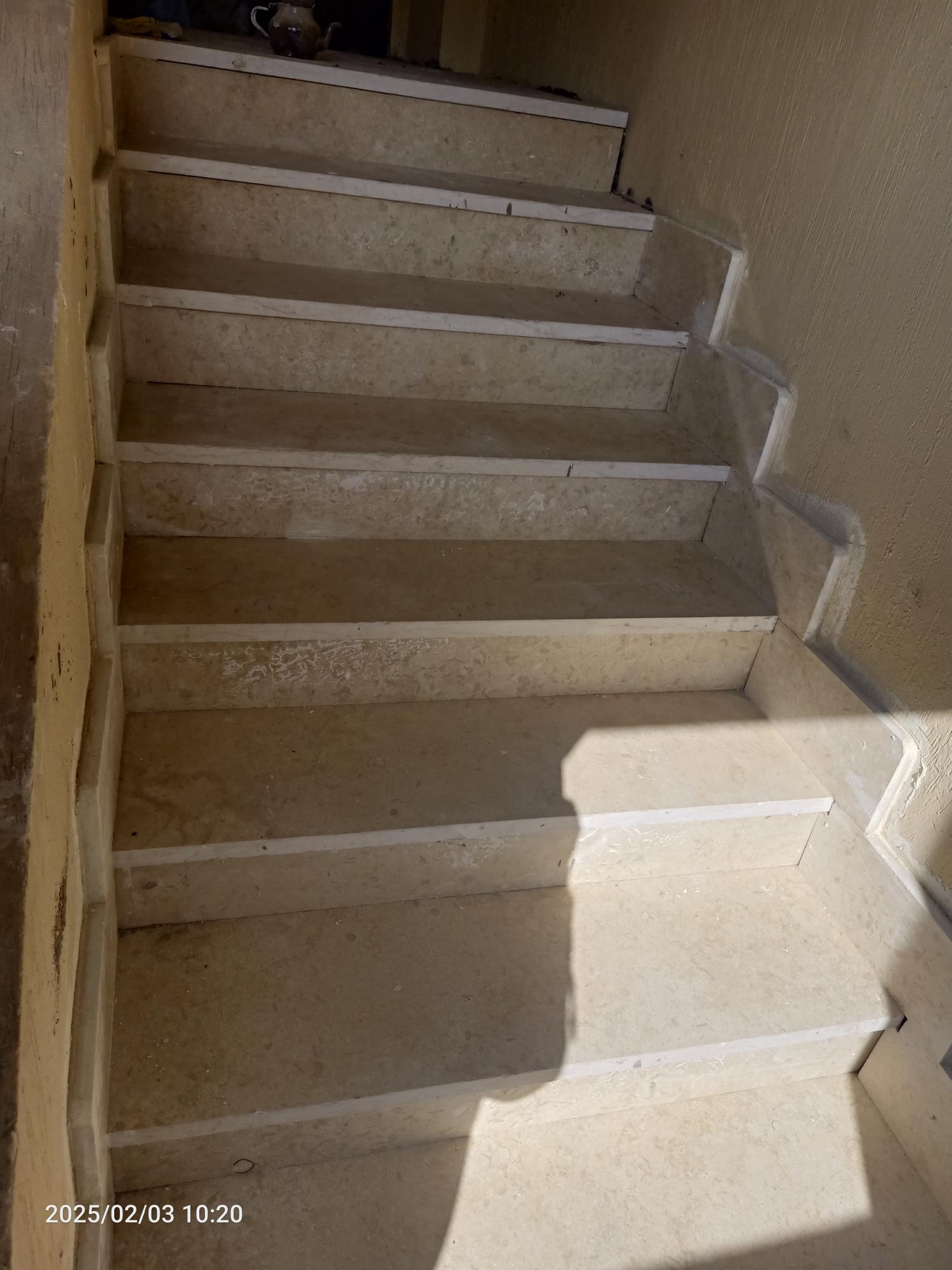

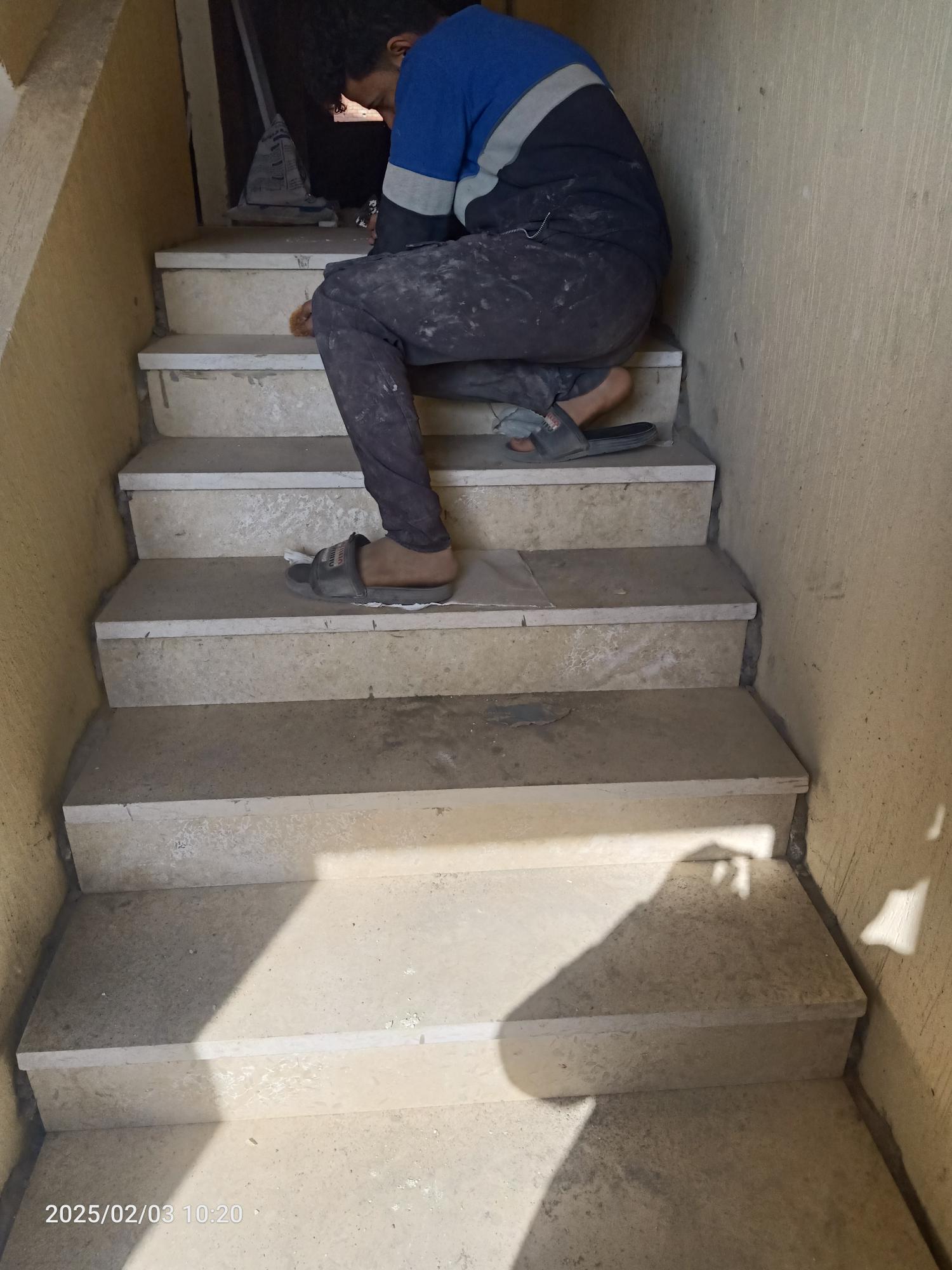

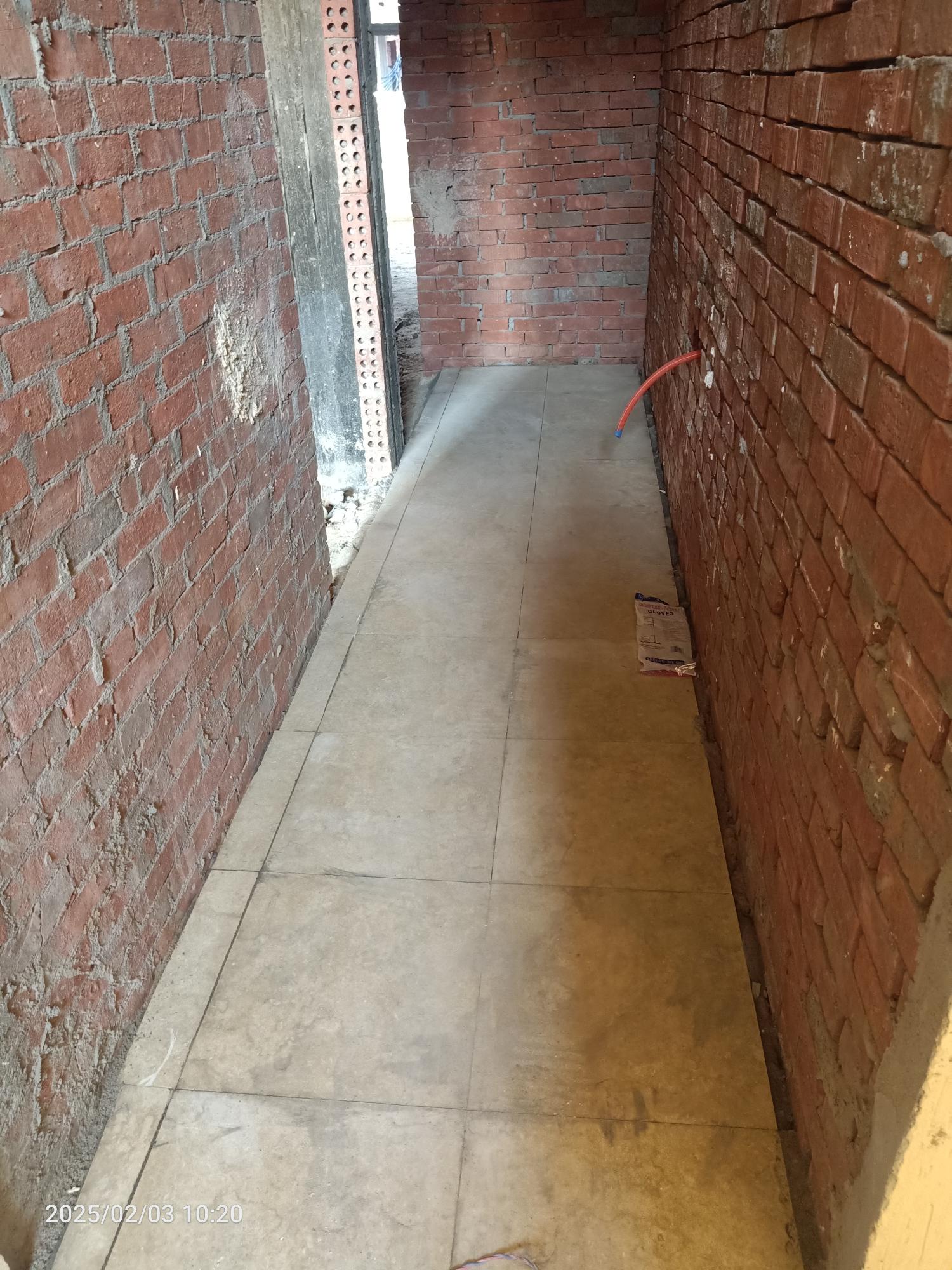

Marble works

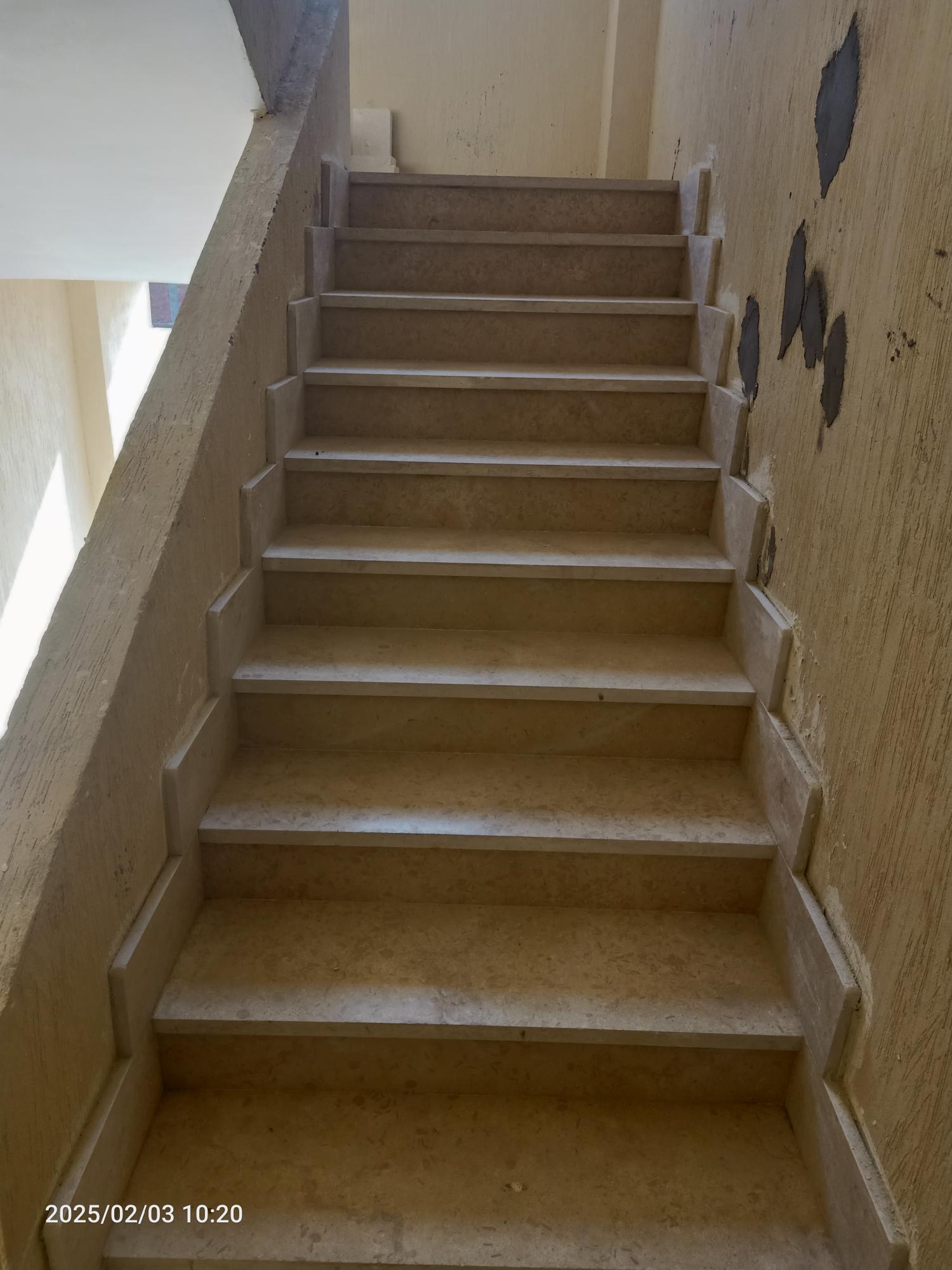

January 25, 2025

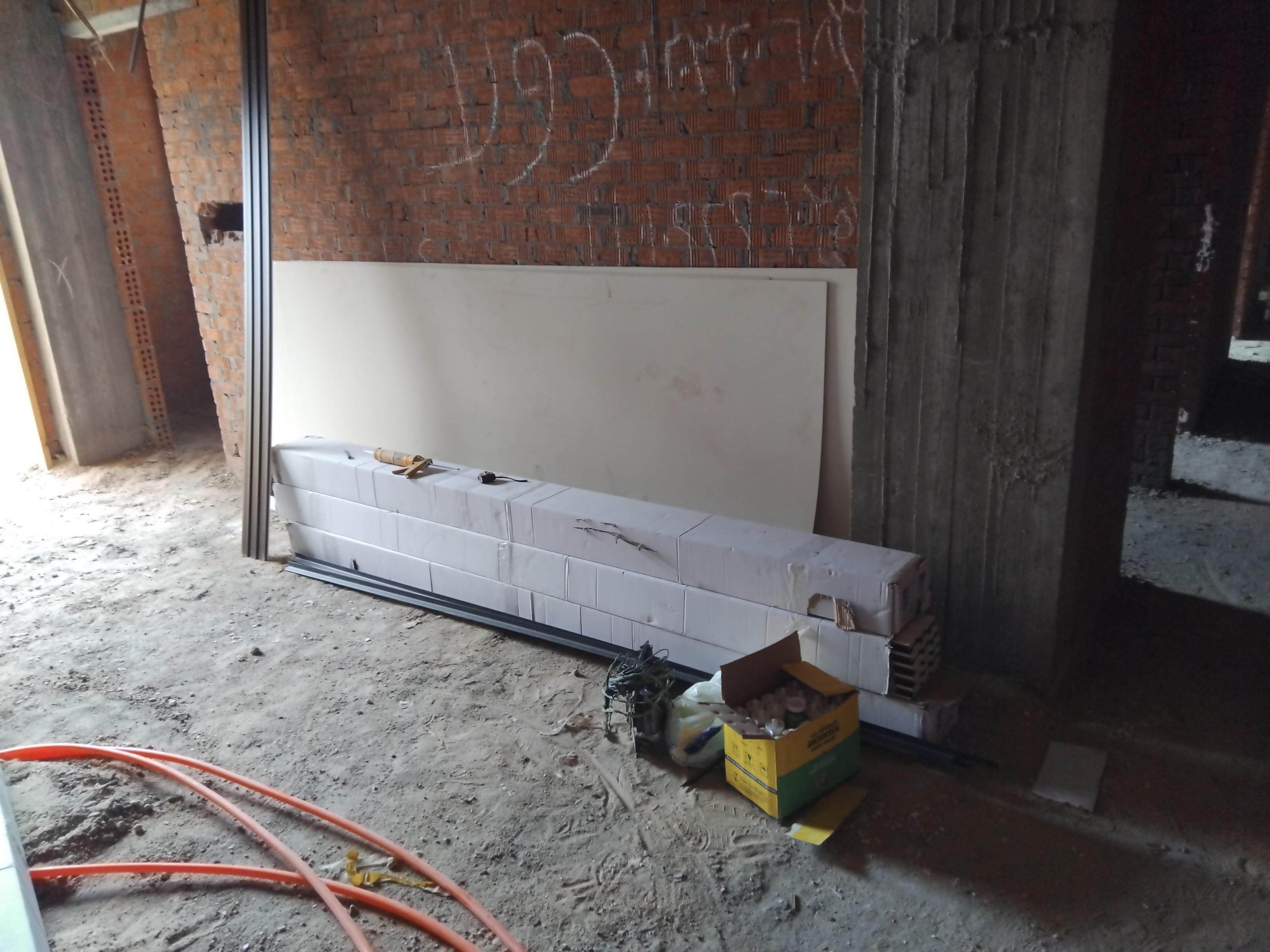

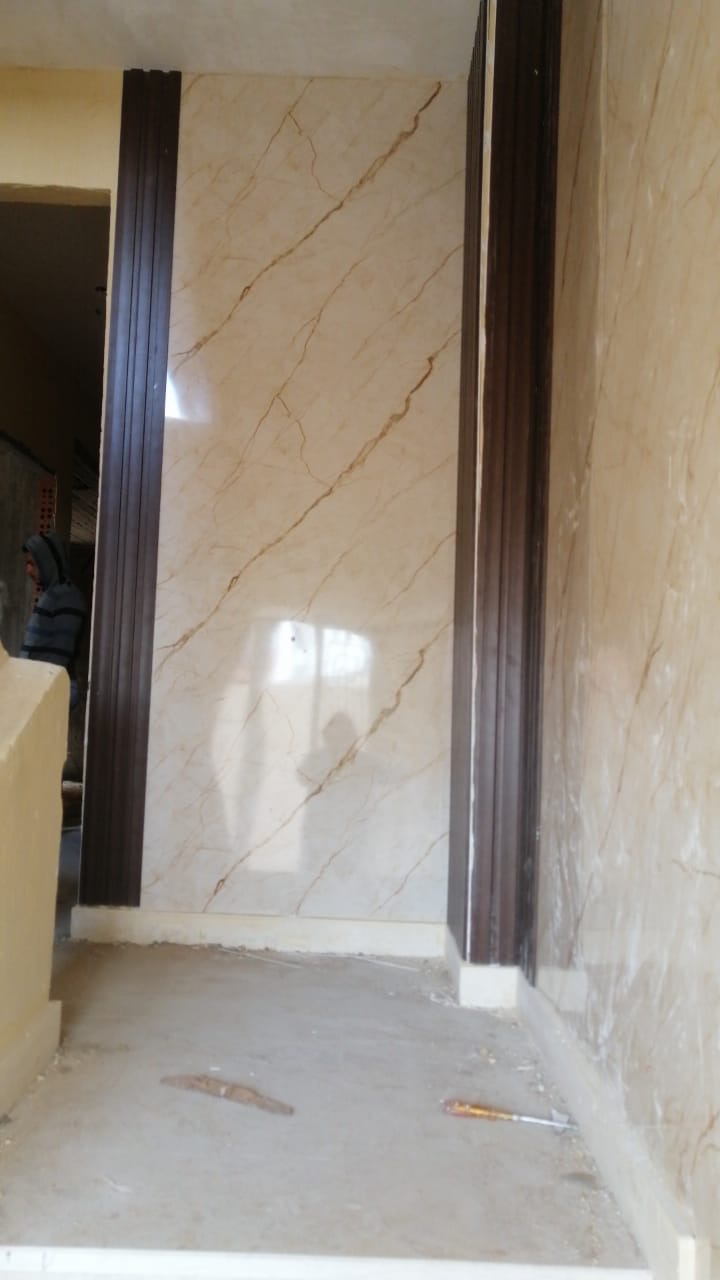

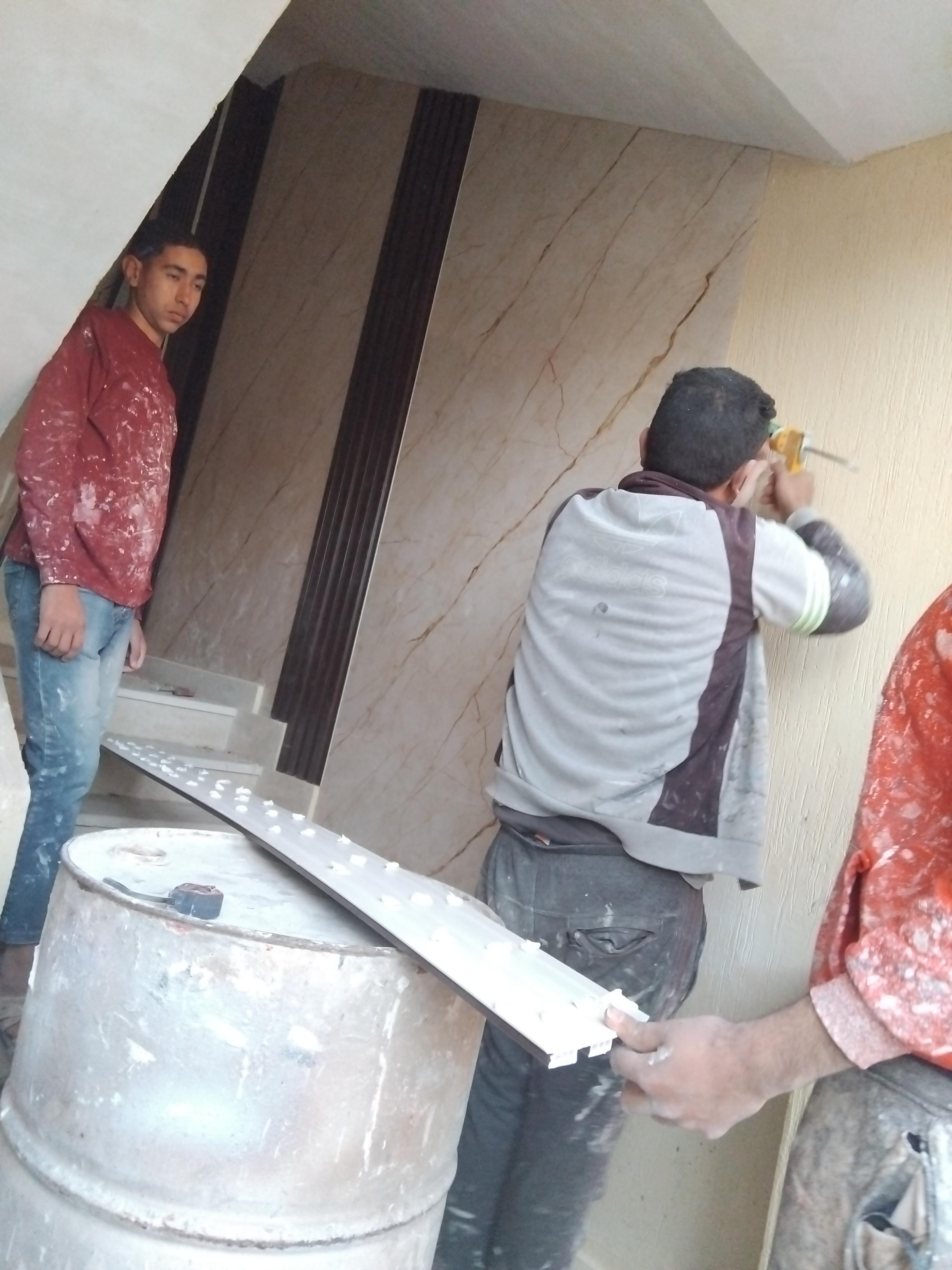

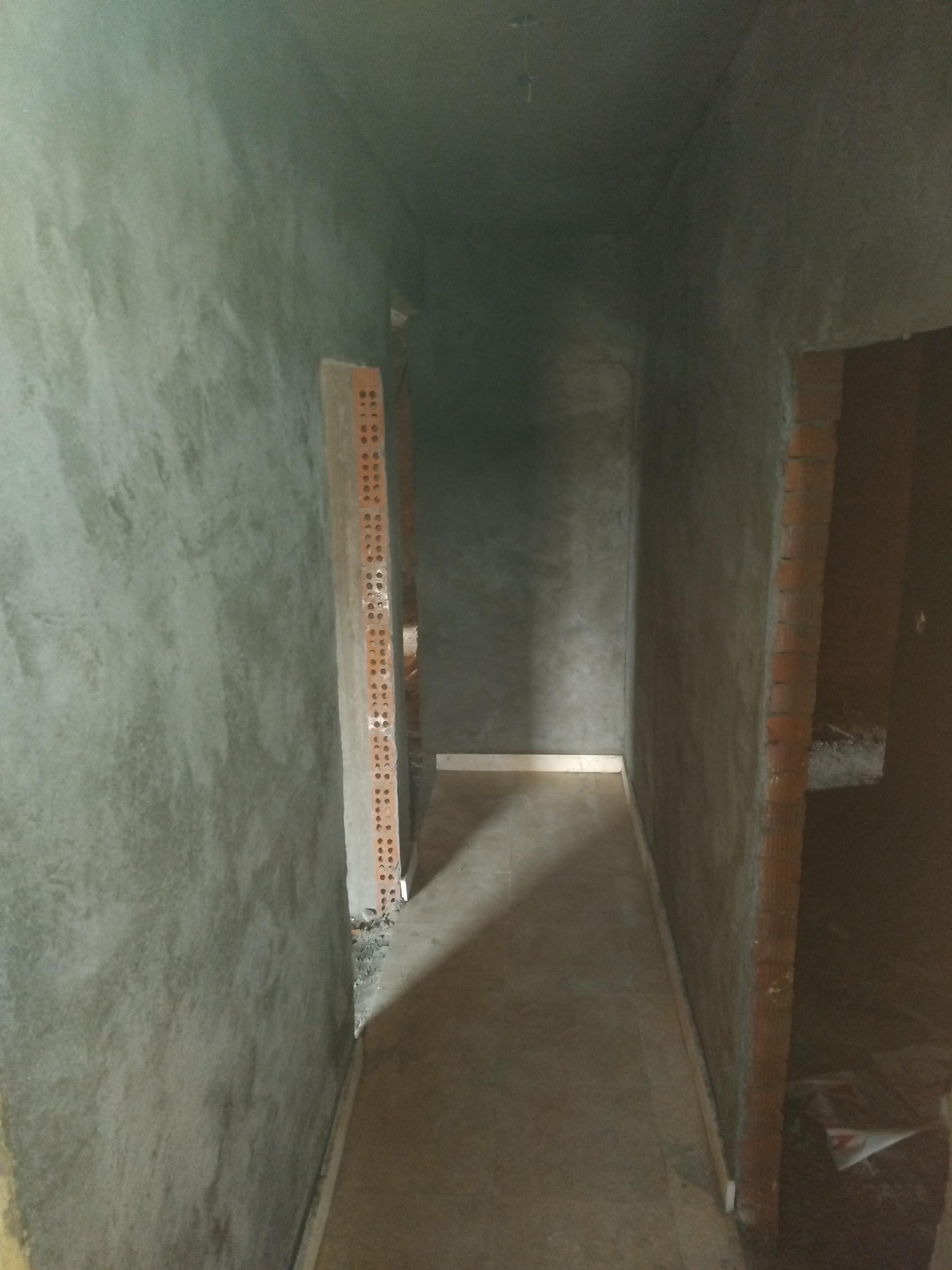

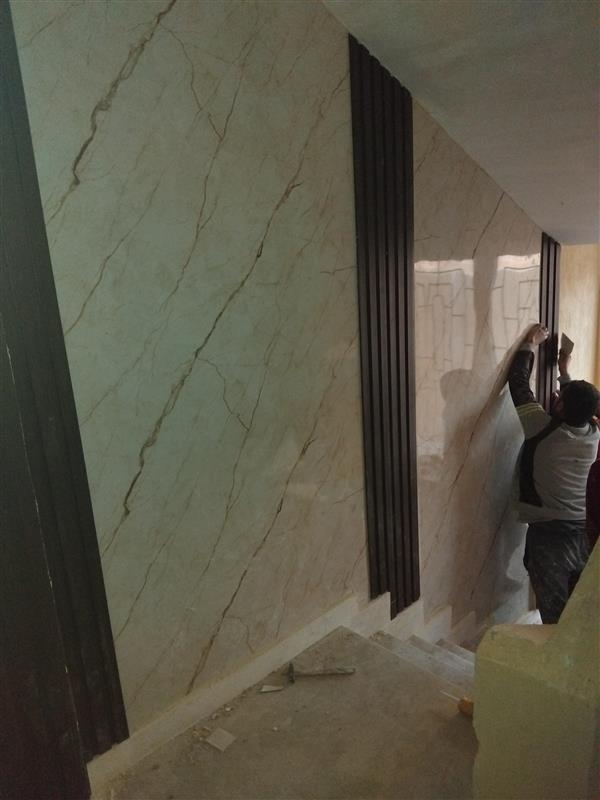

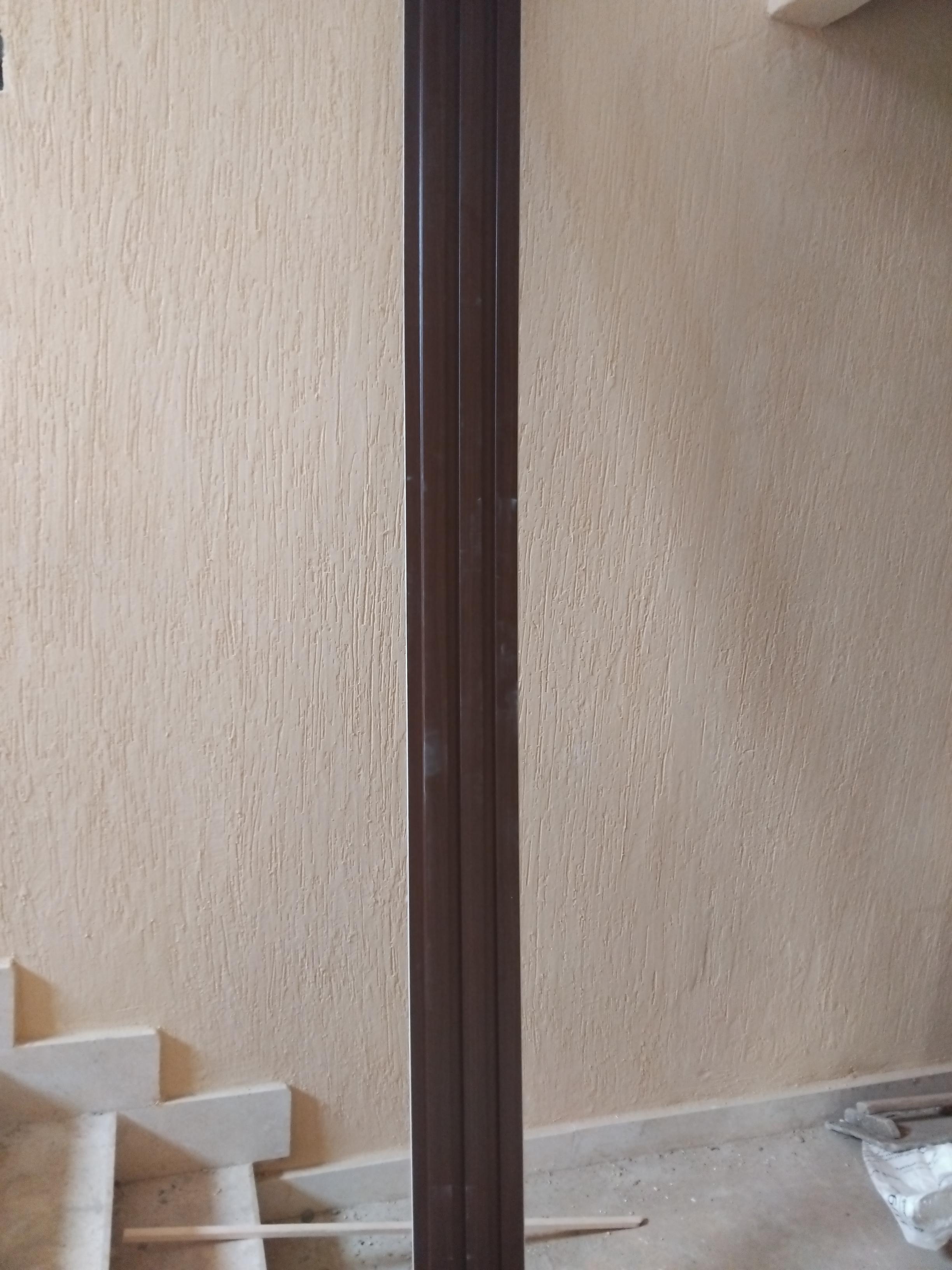

Entrance finishing

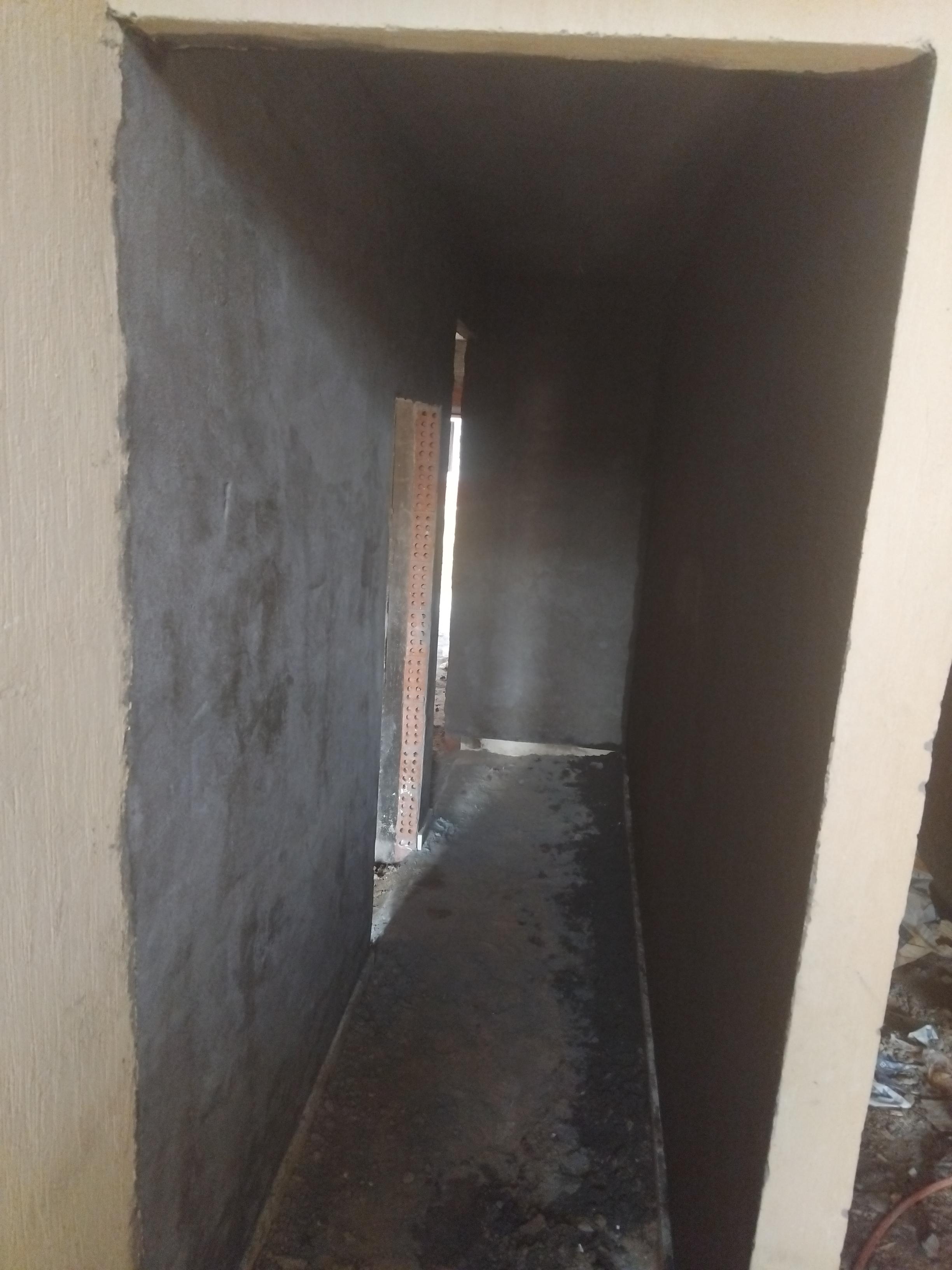

February 8, 2025

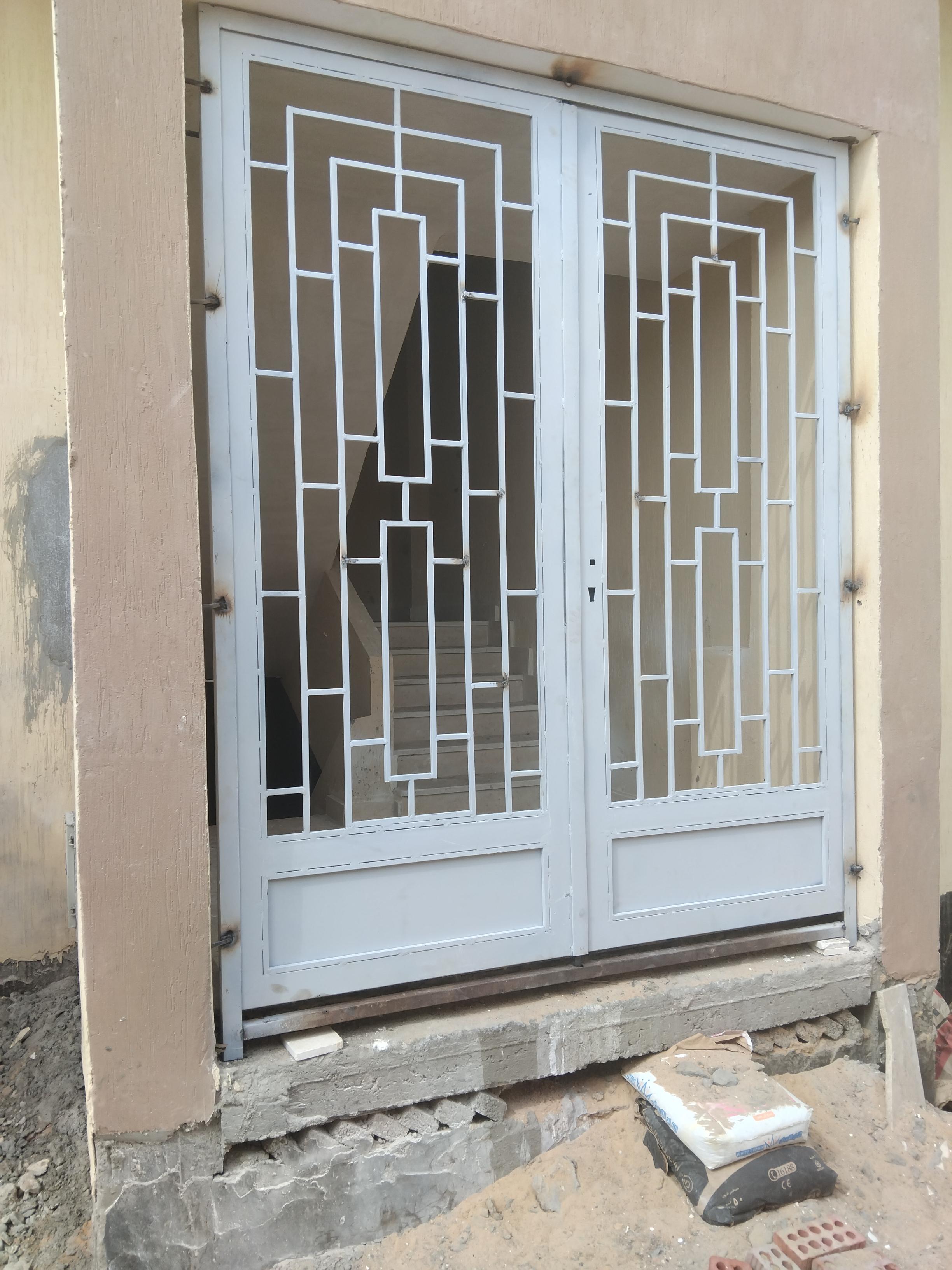

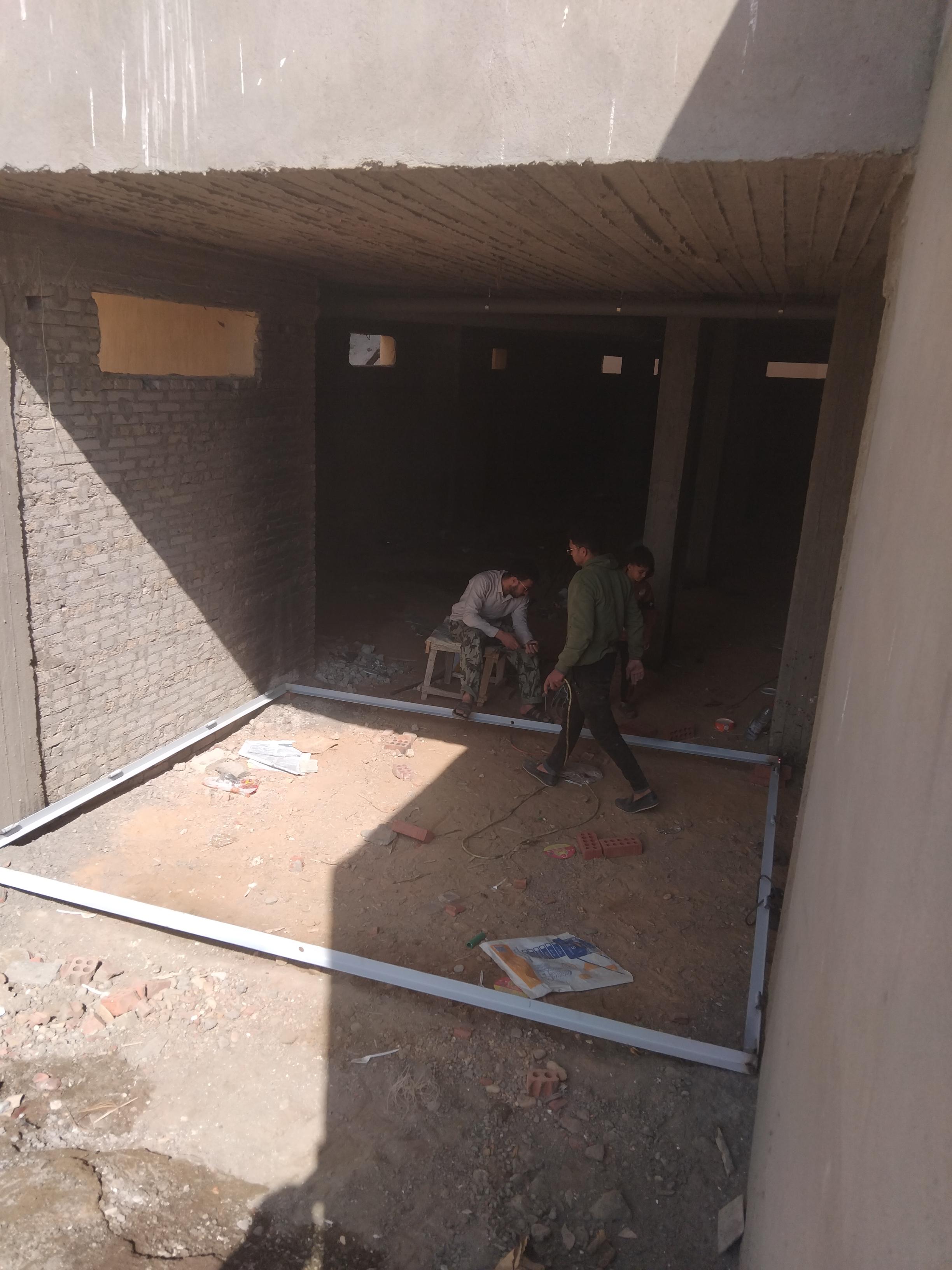

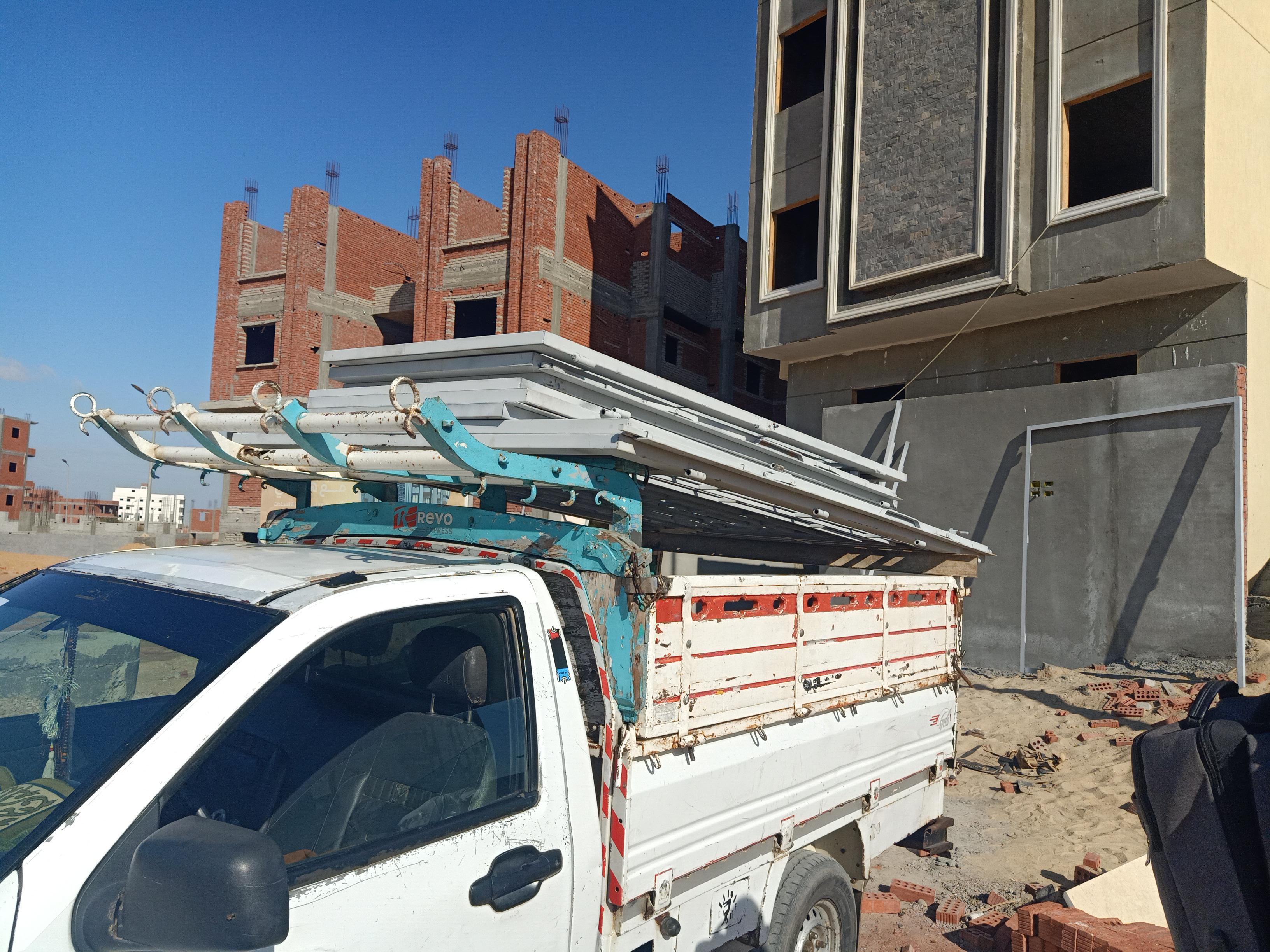

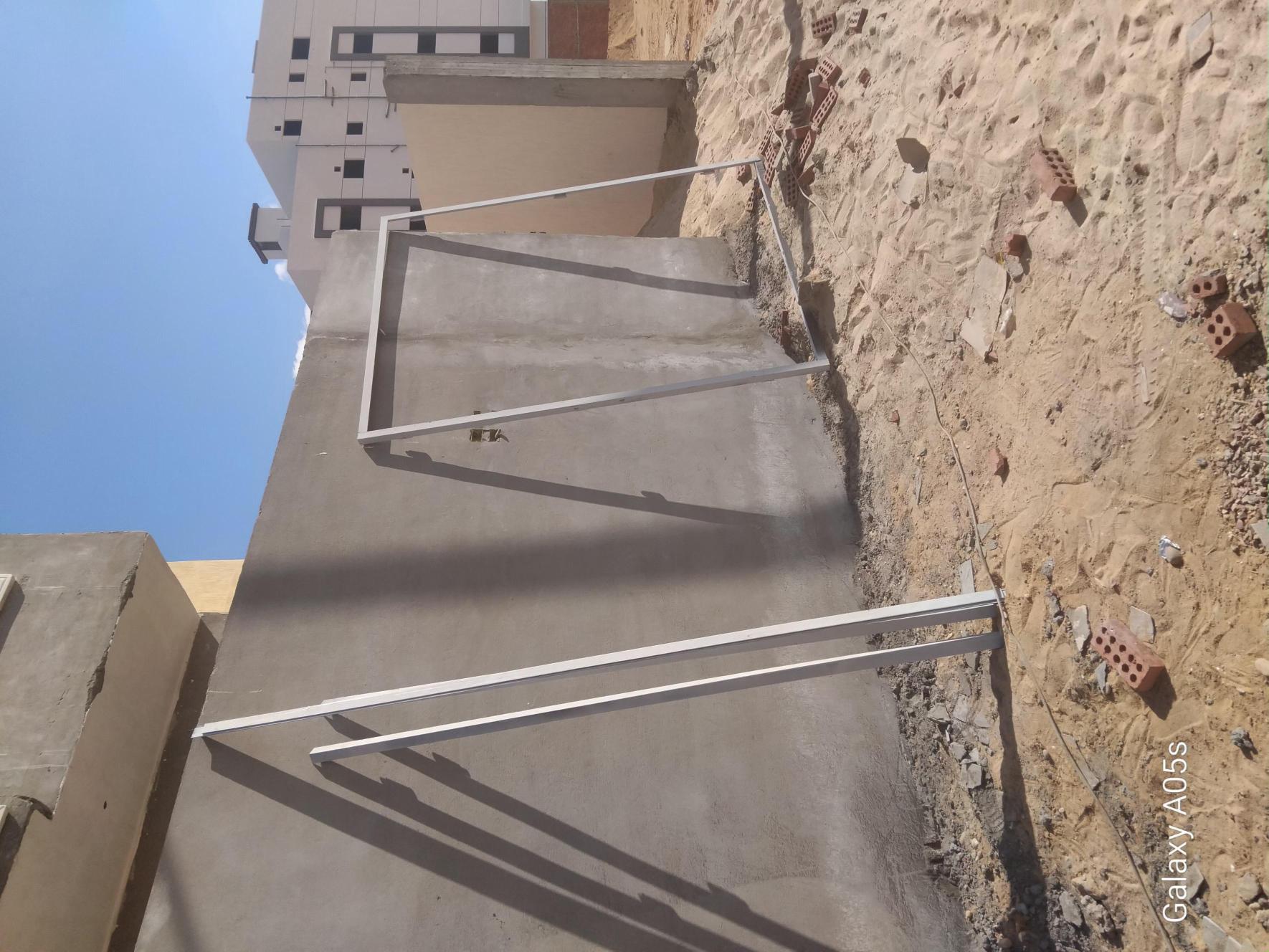

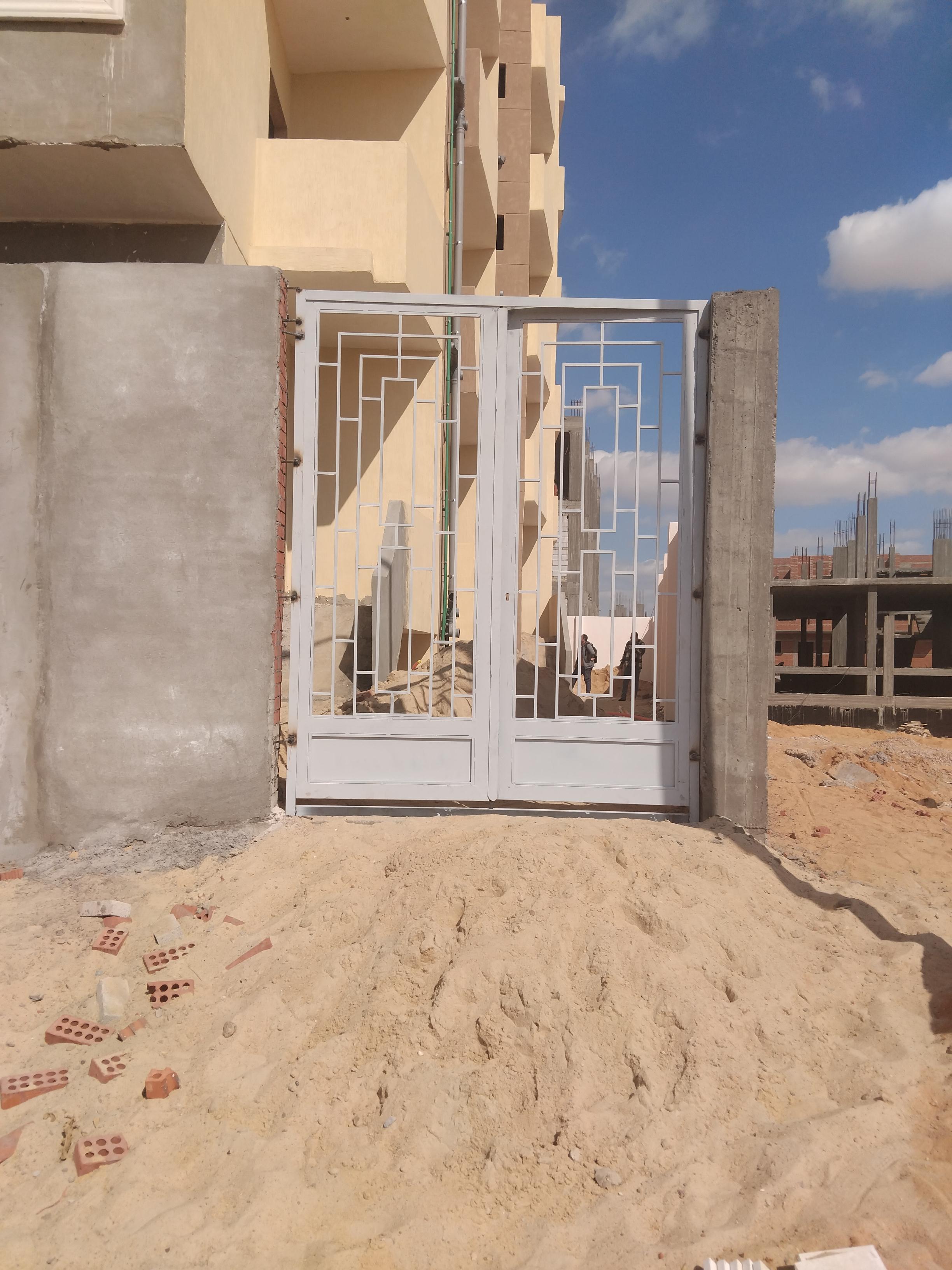

Aluminum & glass works (Krital)
February 9, 2025

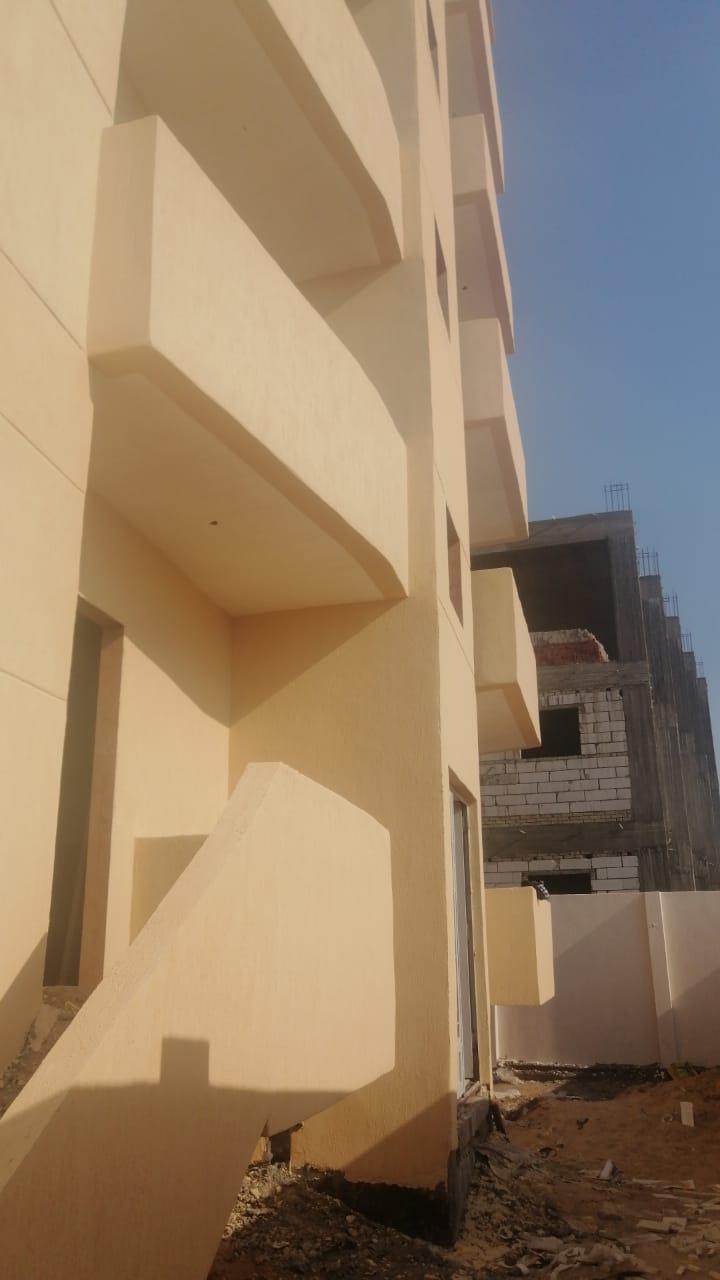

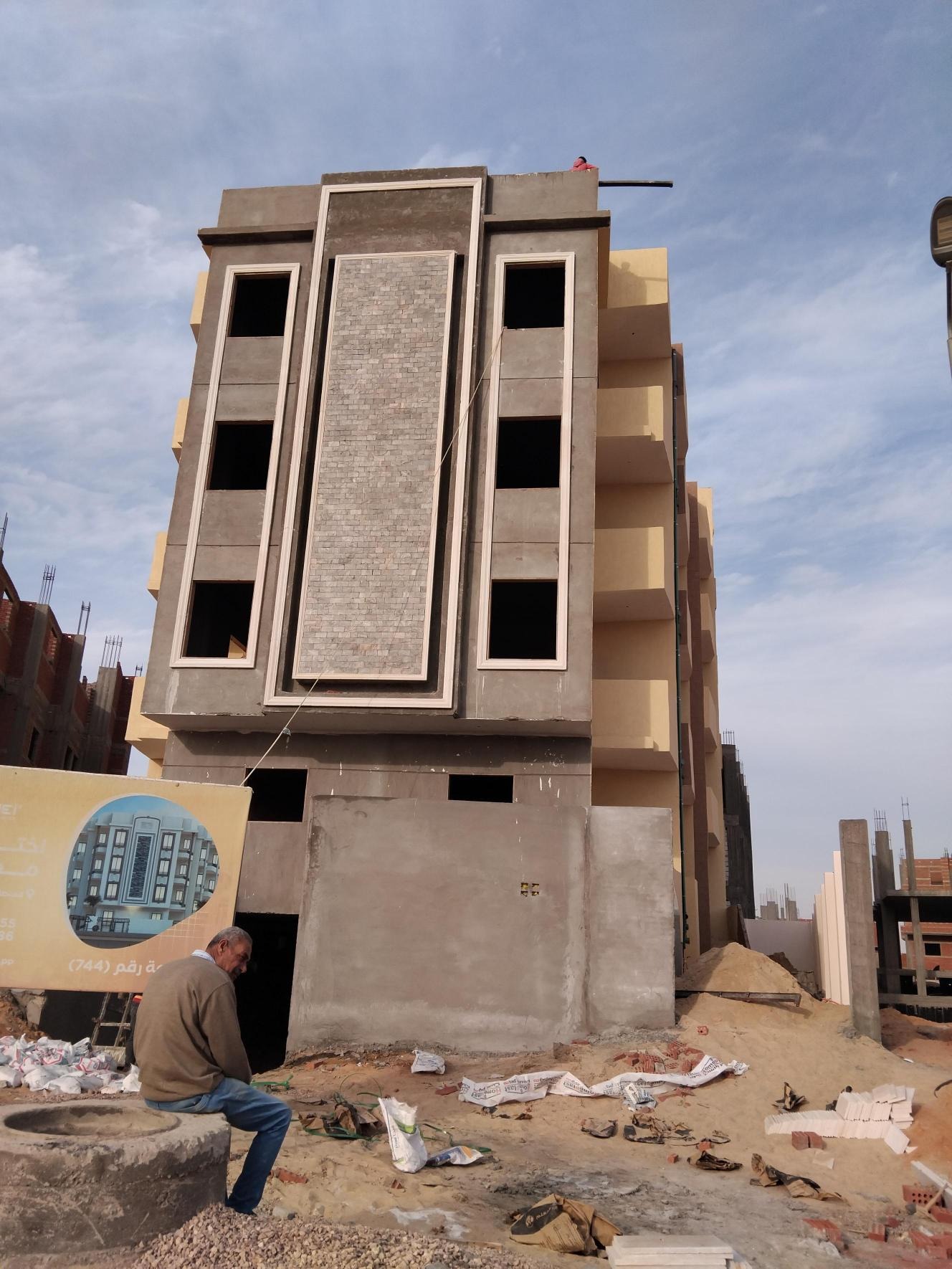

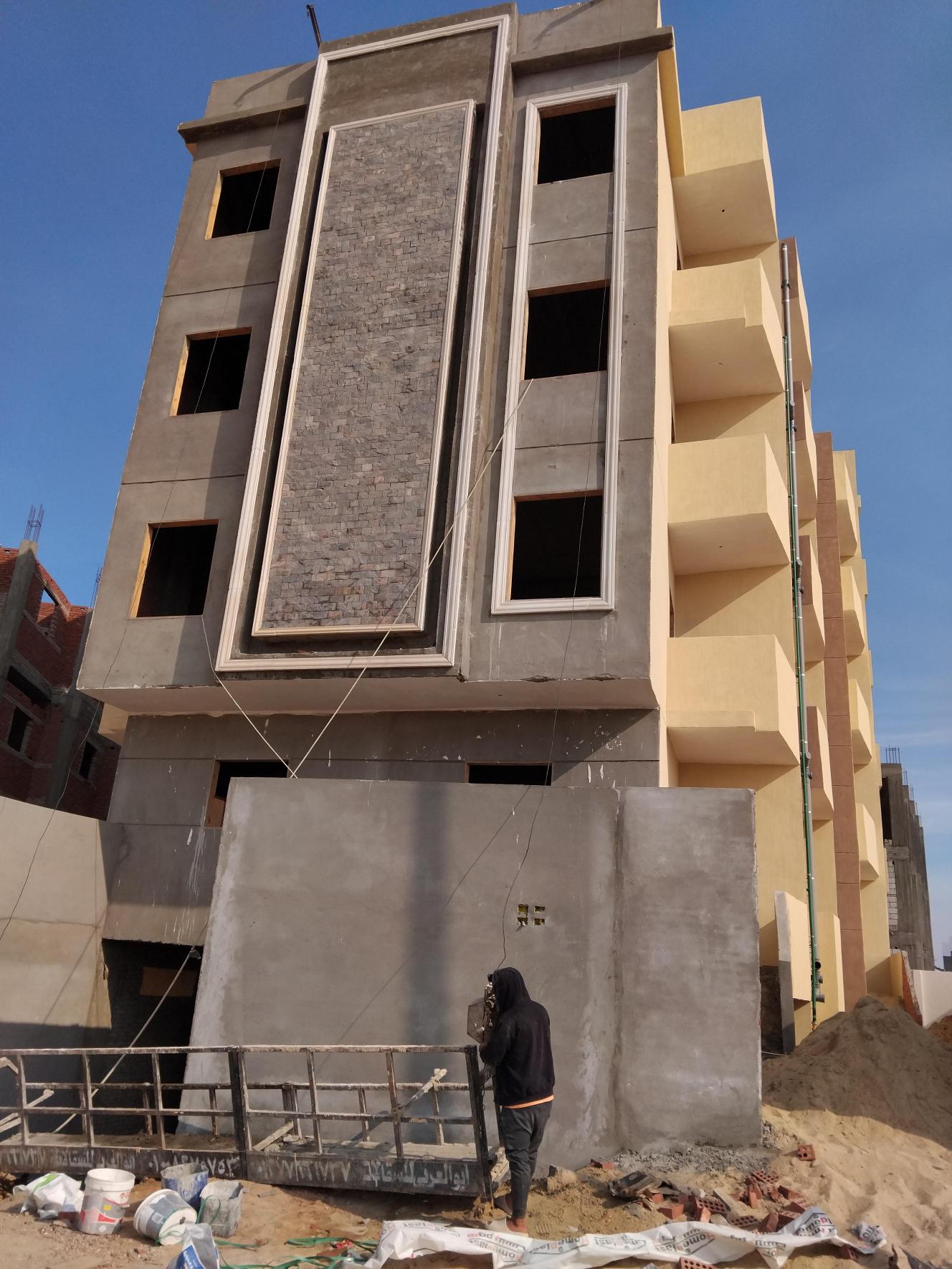

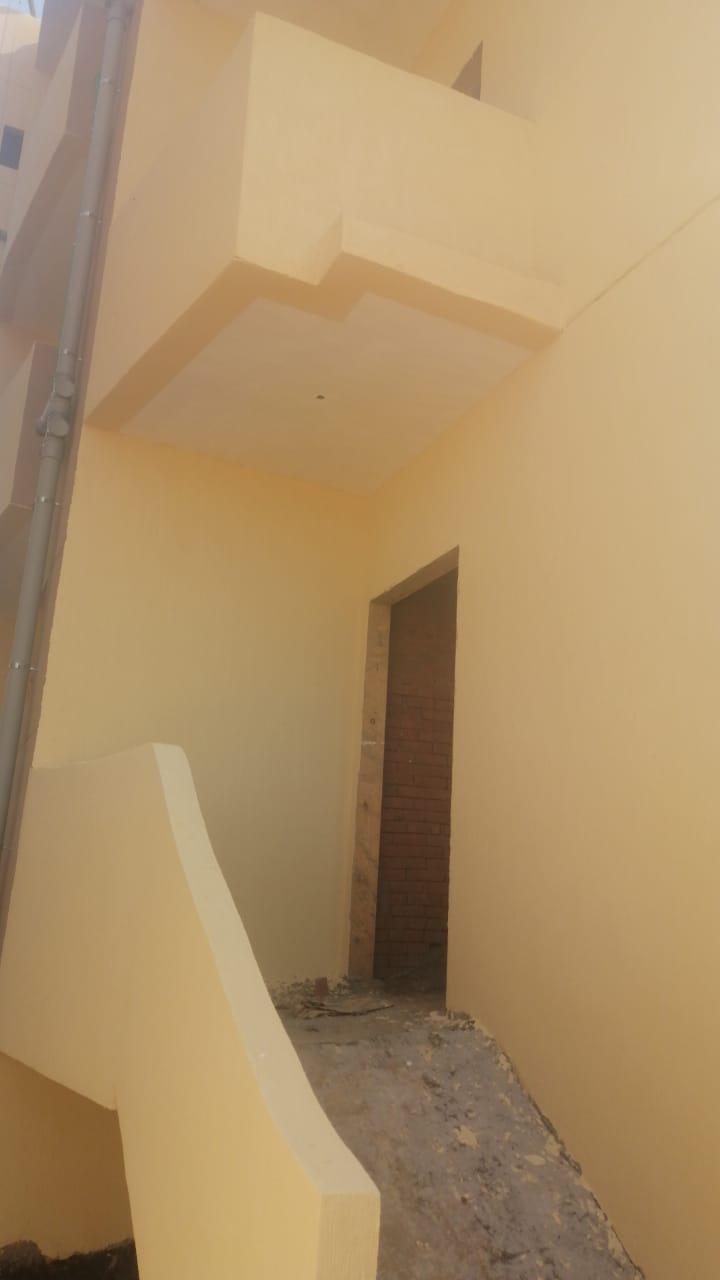

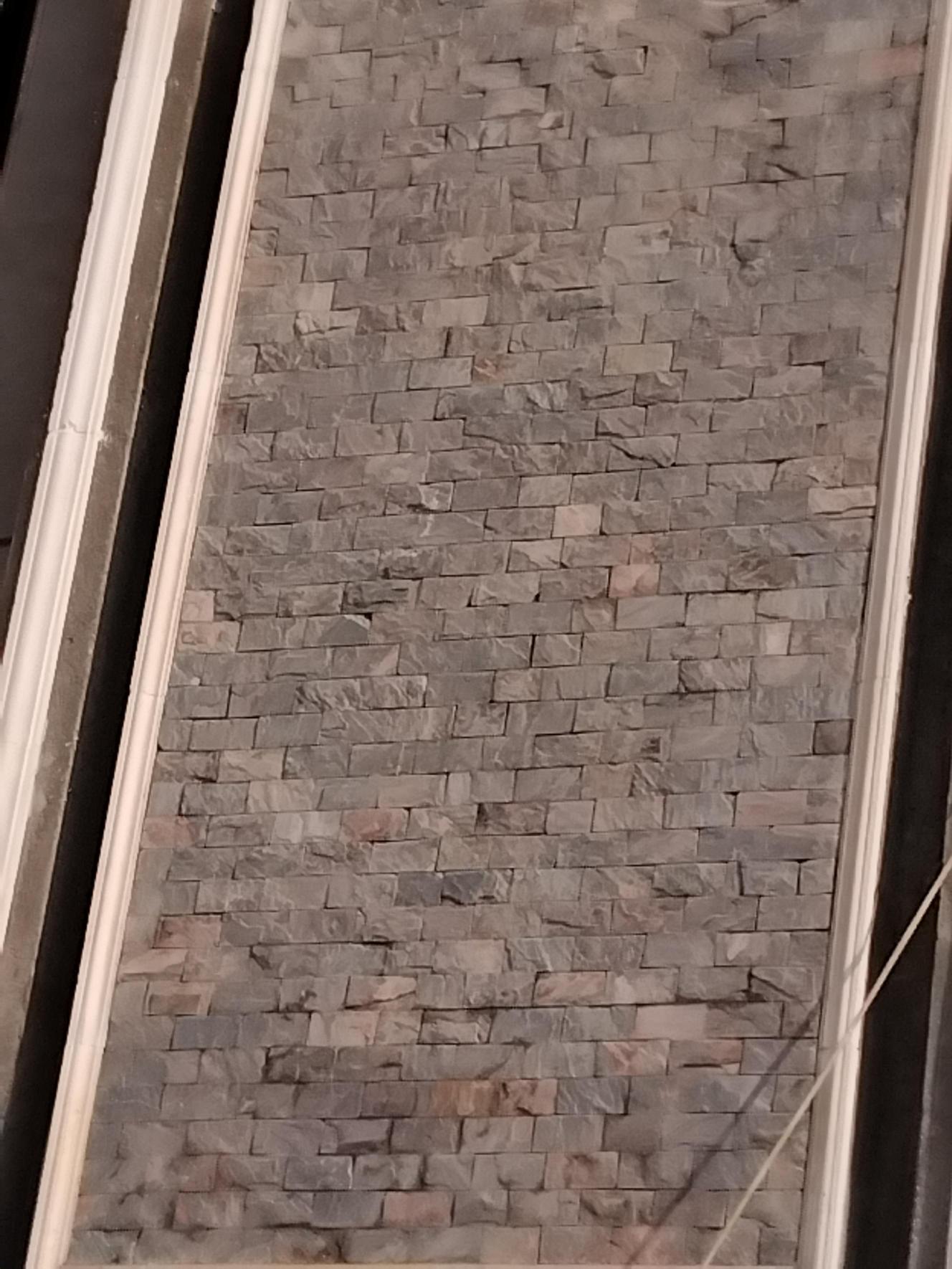

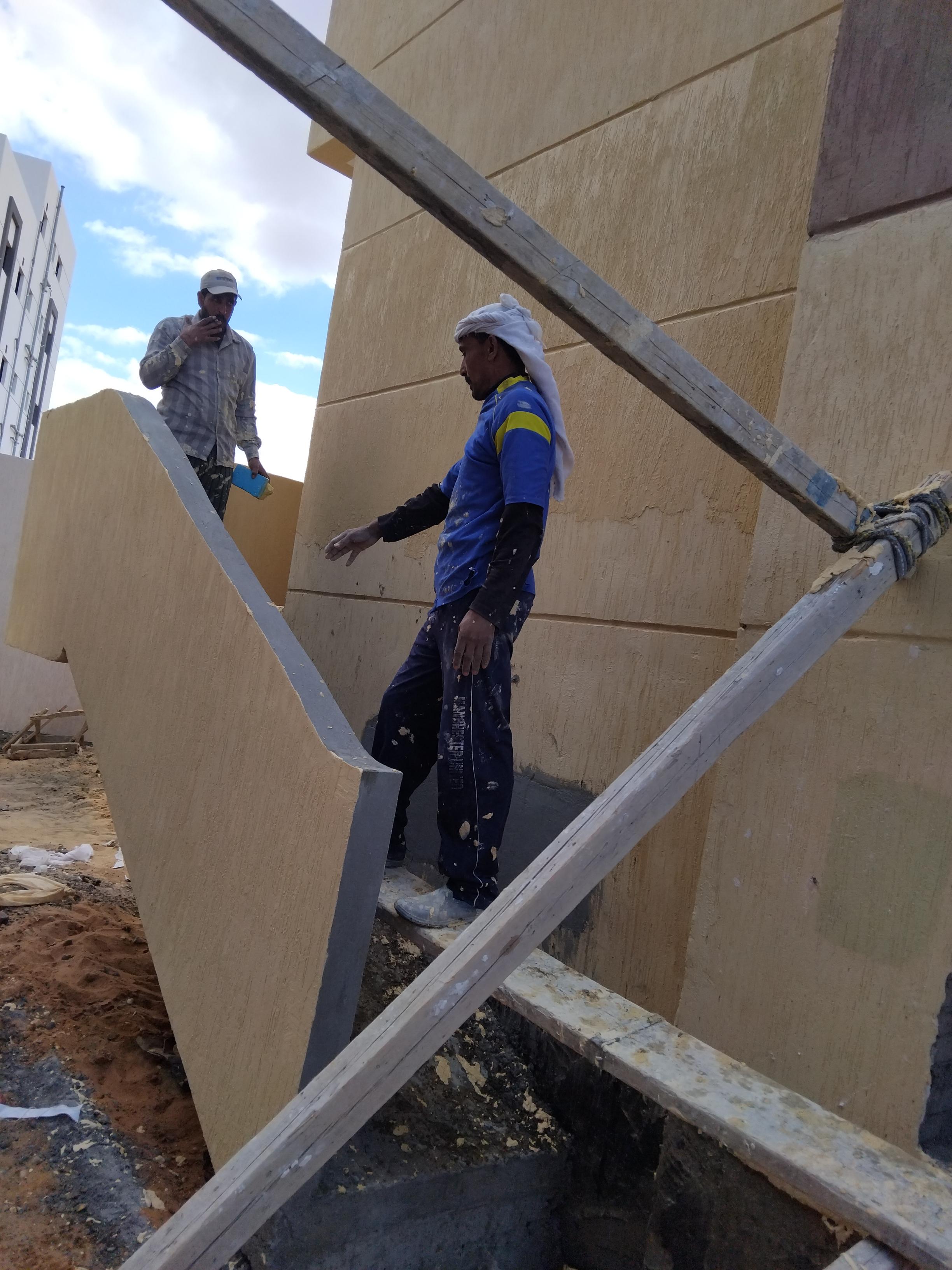

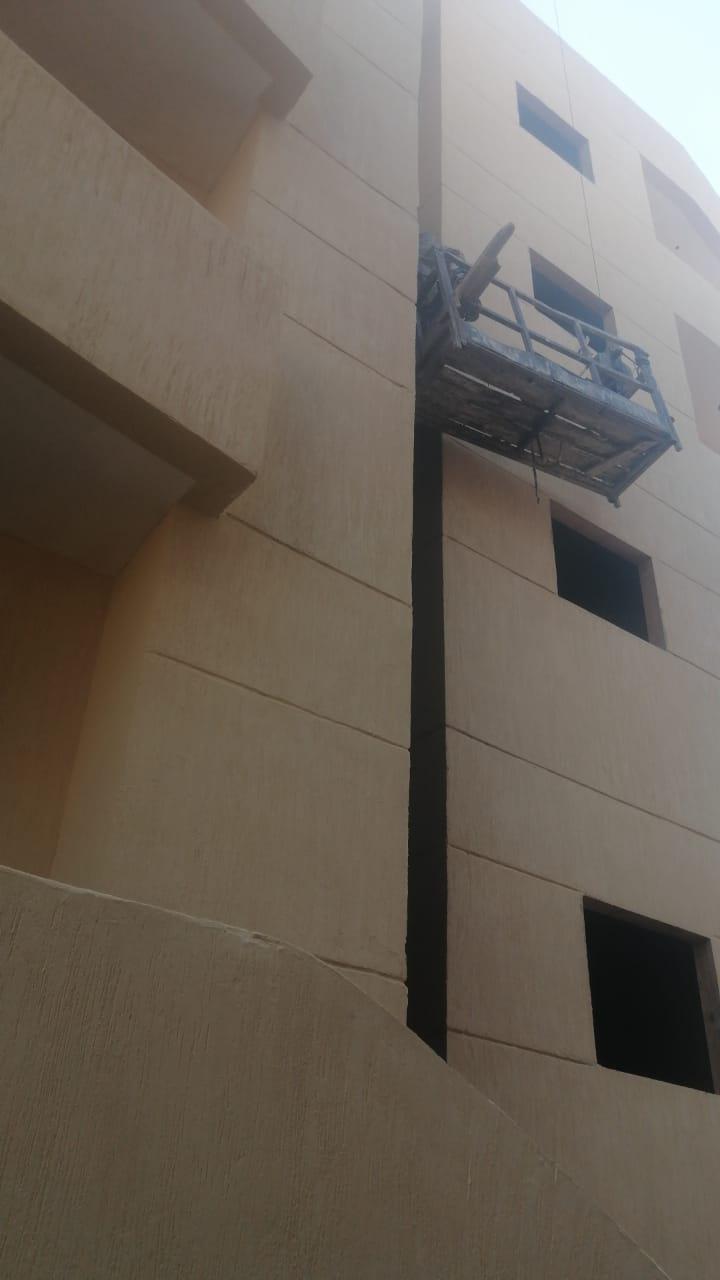

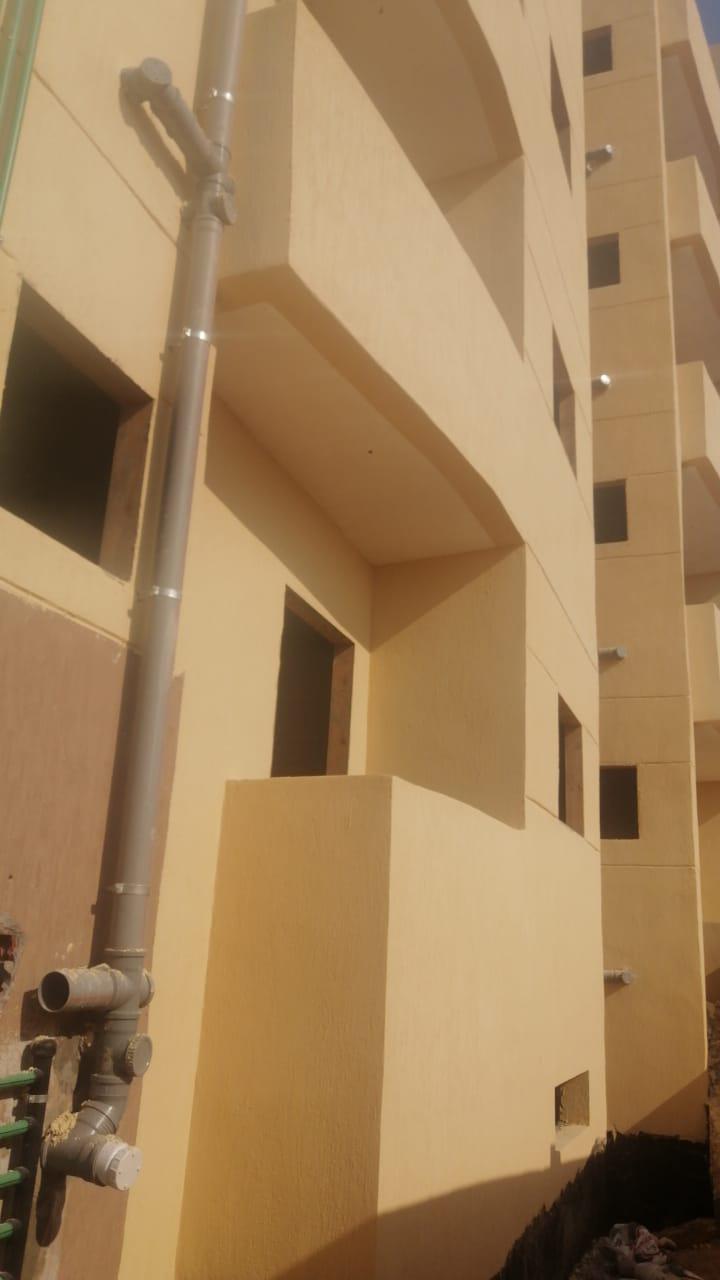

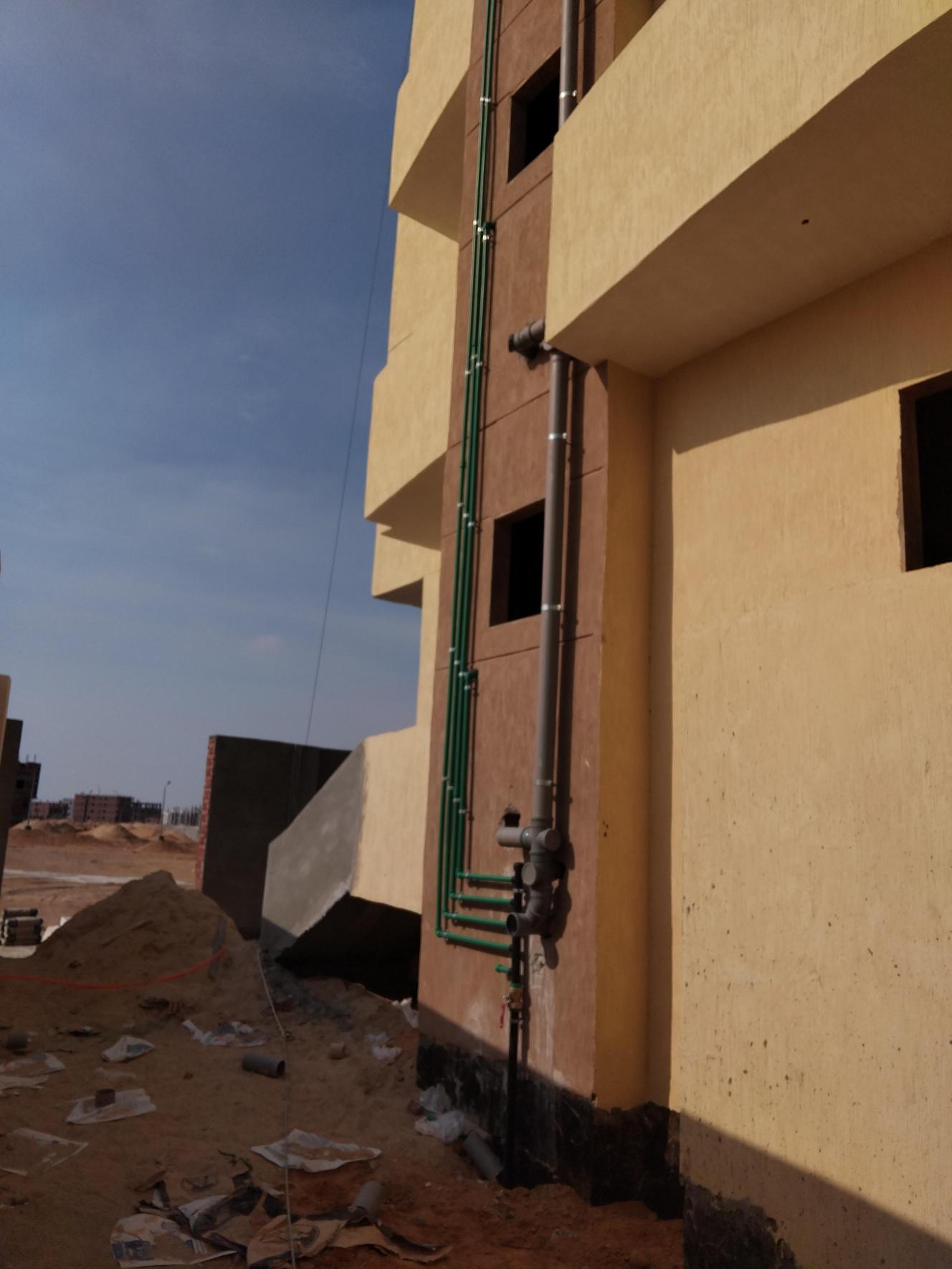

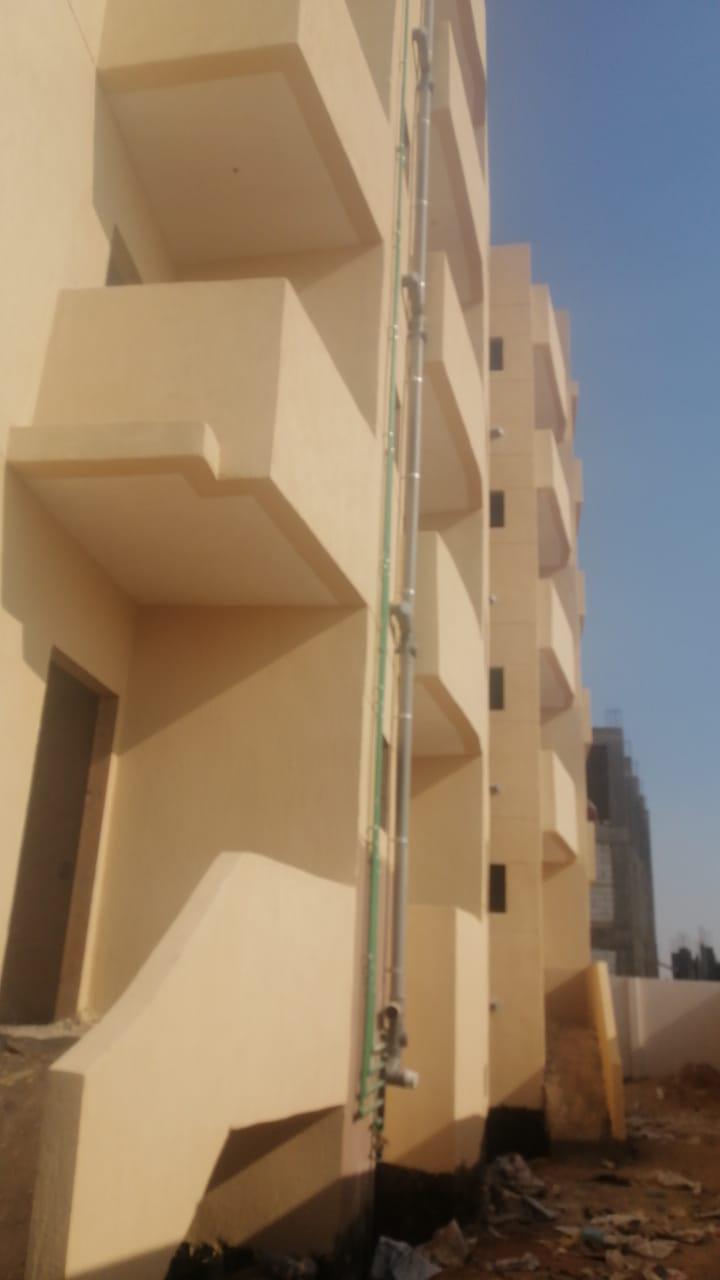

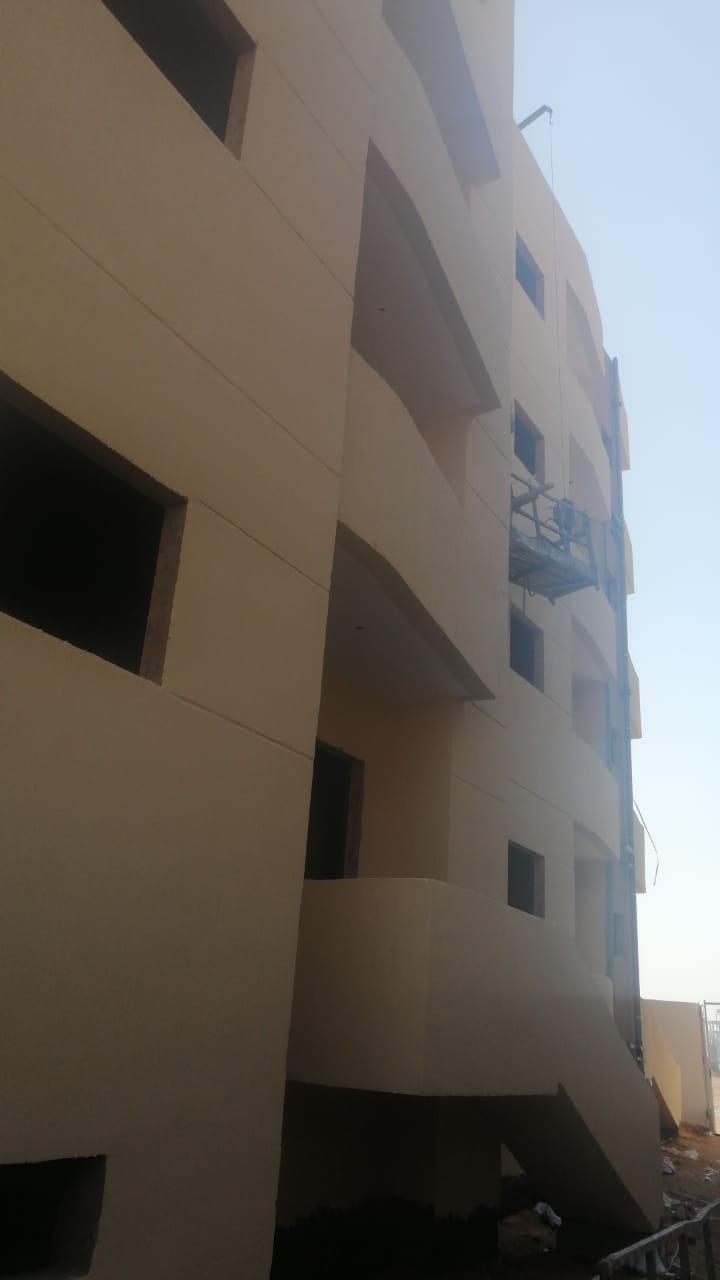

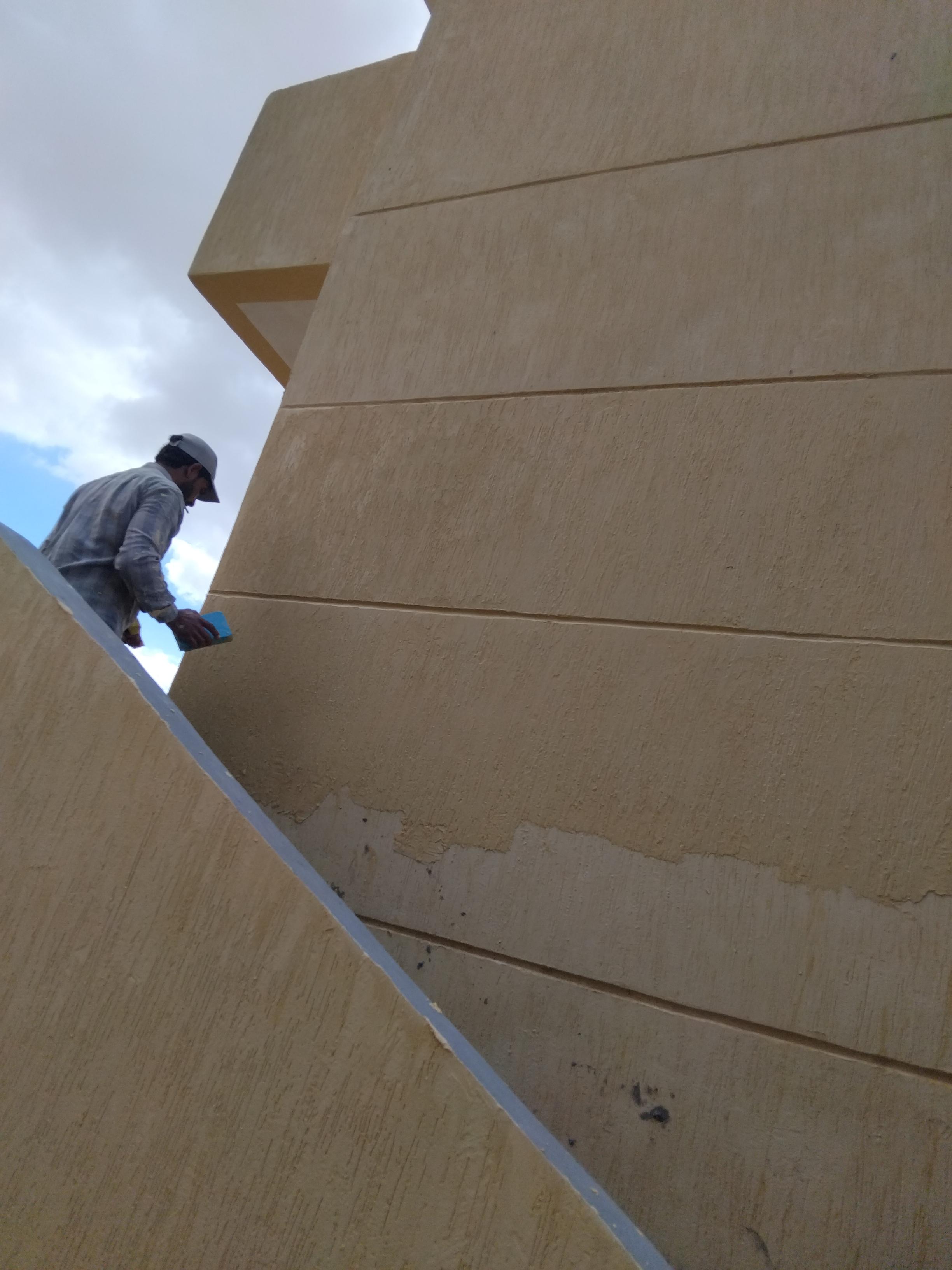

Façades

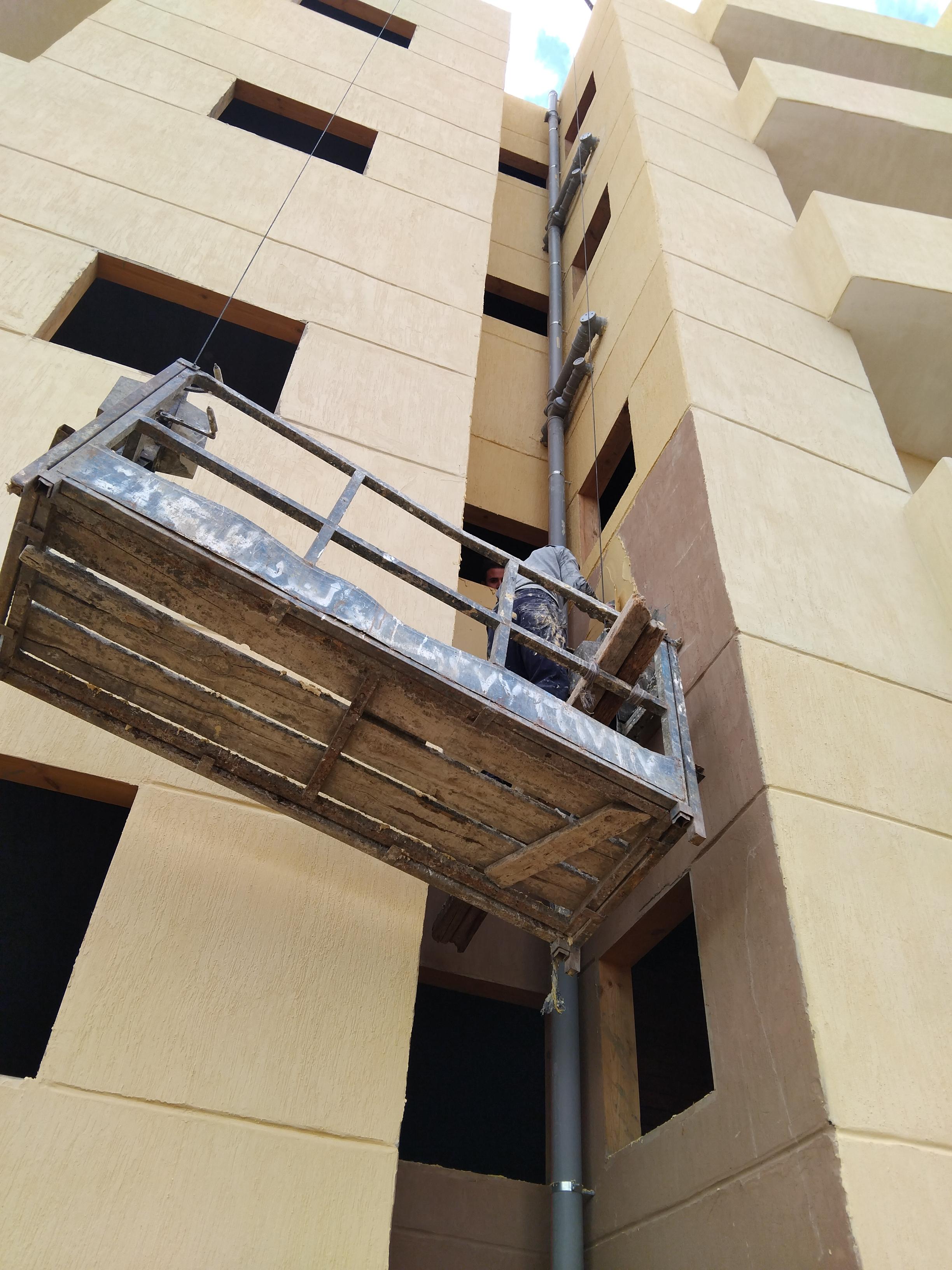

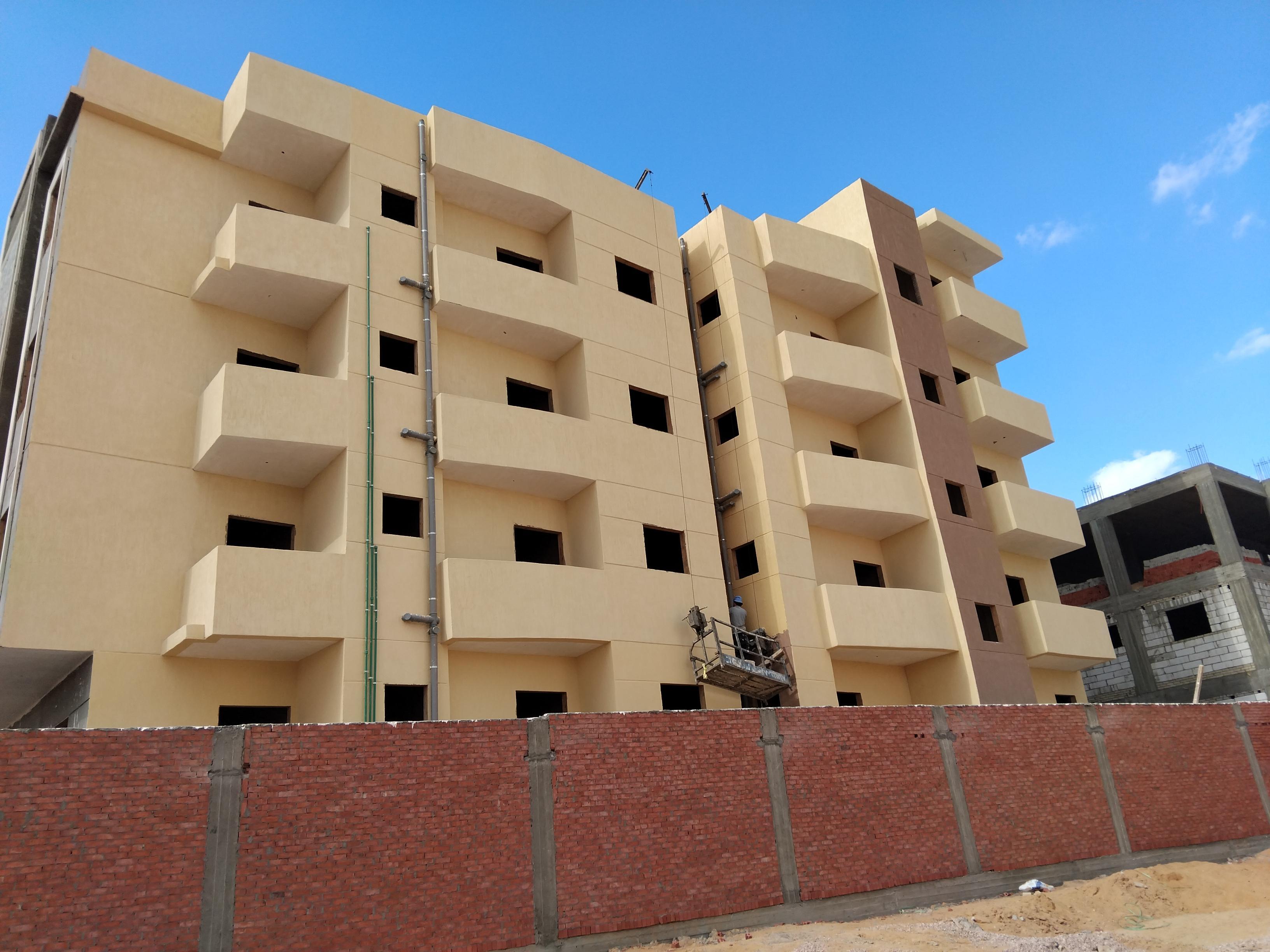

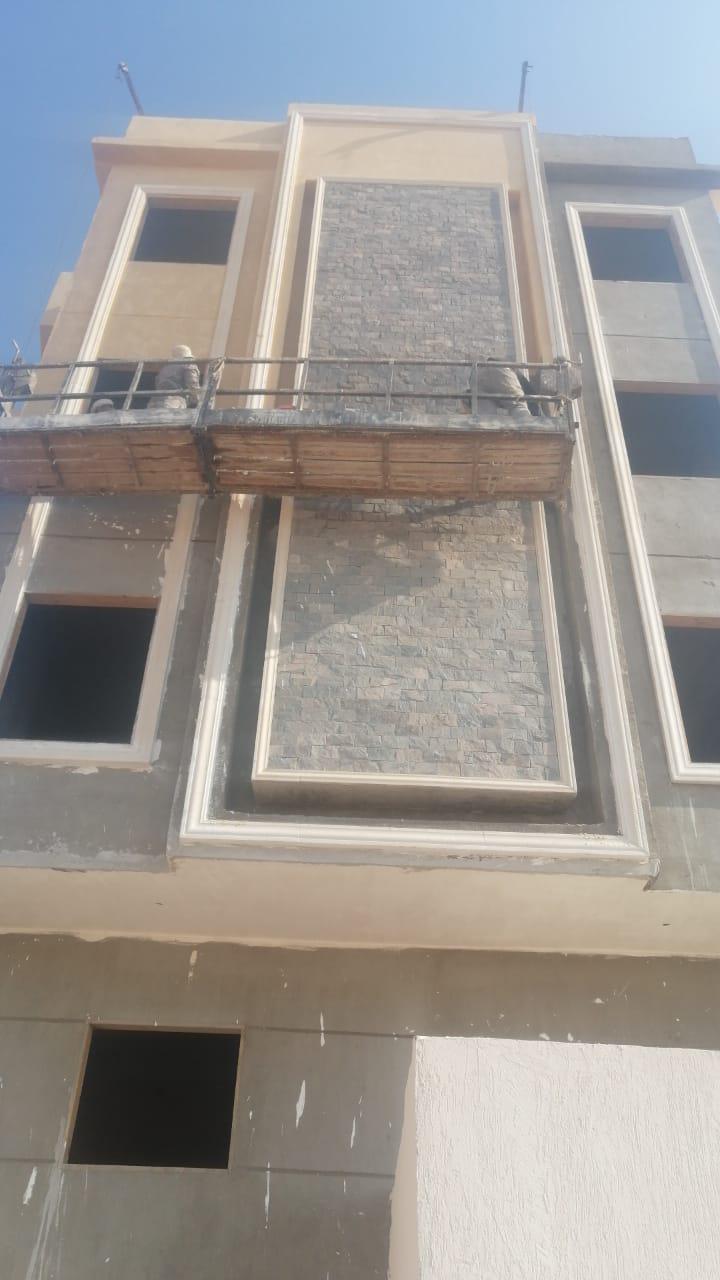

February 17, 2025
Elevator
February 18, 2025
Project handover to the authority
March 23, 2025
Utilities meter installation
April 1, 2025
