Project Details
Land Number
1475
Region
The Area 29, El Sadat City
HOMEi Price
8,300.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 10% |
| 3 | During Construction | 10% |
| 4 | During Construction | 10% |
| 5 | During Construction | 5% |
| 6 | During Construction | 5% |
| 7 | During Construction | 5% |
| 8 | During Construction | 5% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
173 m²
Delivery
Unit Delivery Date
October 2026
Average Unit Price
1,137,375 EGP
Project Location
Map View
The Area 29, El Sadat City
HOMEi Timeline
License office contract
January 20, 2025
Receiving the license
March 25, 2025

Submitting the license
January 25, 2025
Excavation permit
April 20, 2025
Mining permit
April 22, 2025
Construction contract in progress
April 25, 2025
Construction contract signed
April 30, 2025

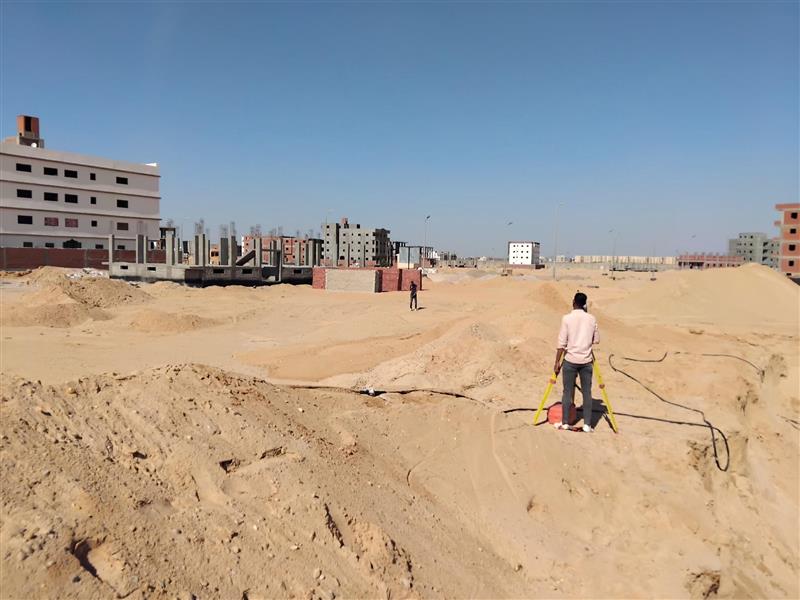

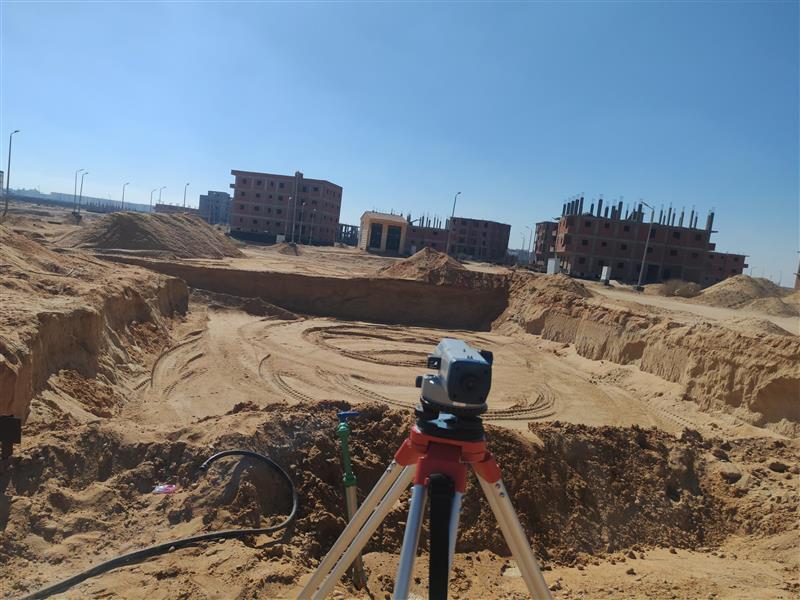

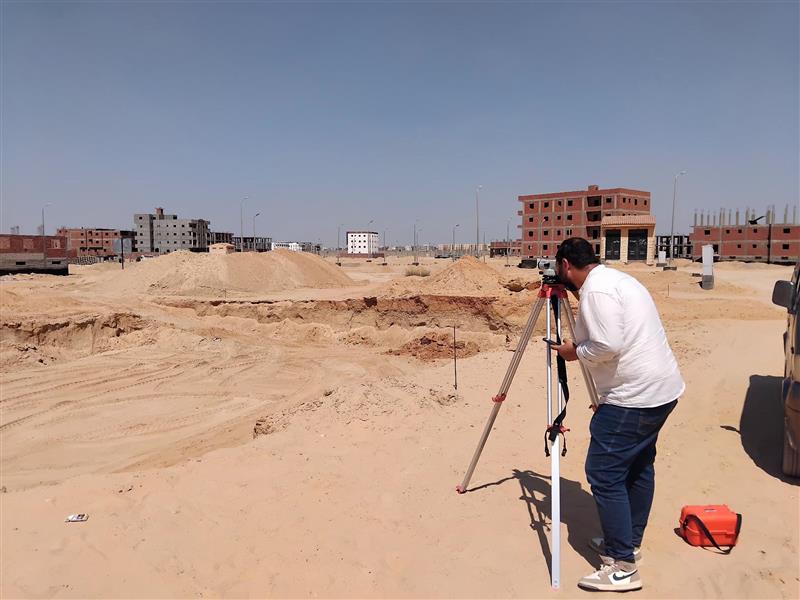

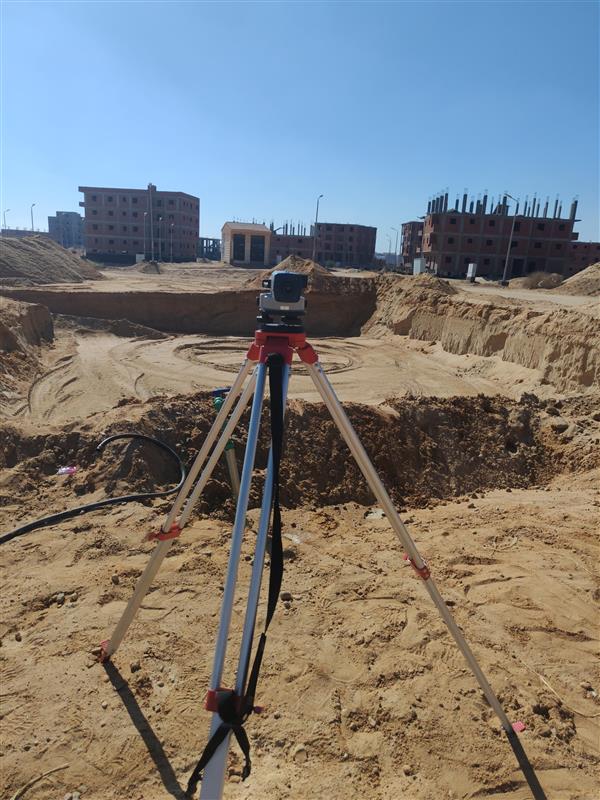

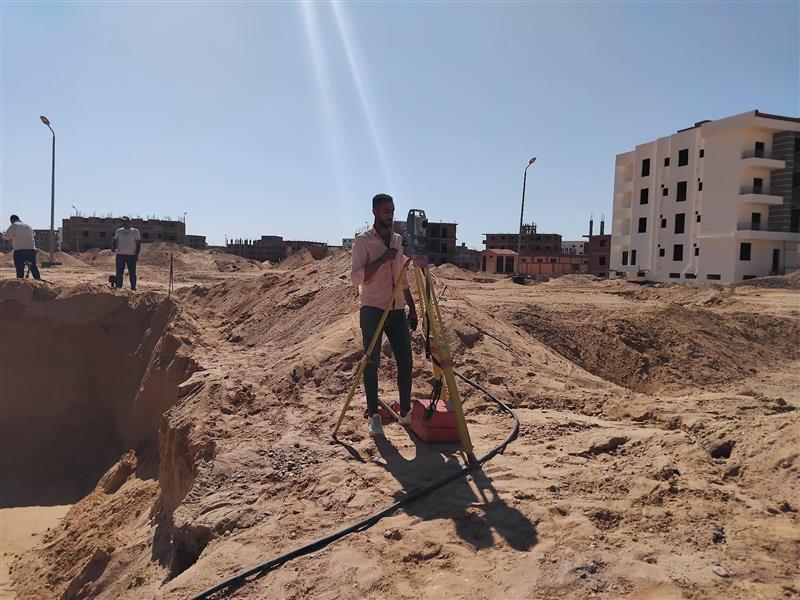

Excavation
May 4, 2025

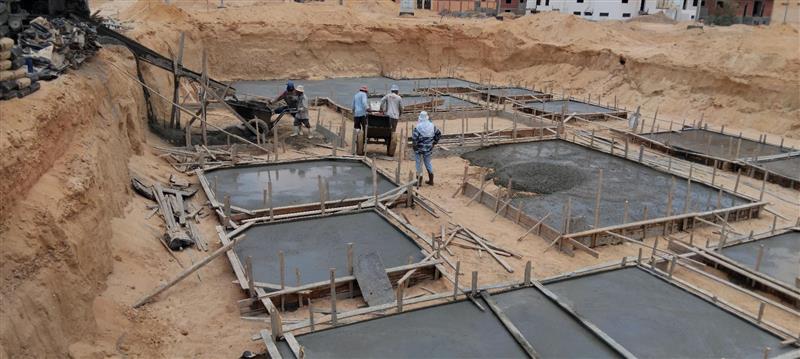

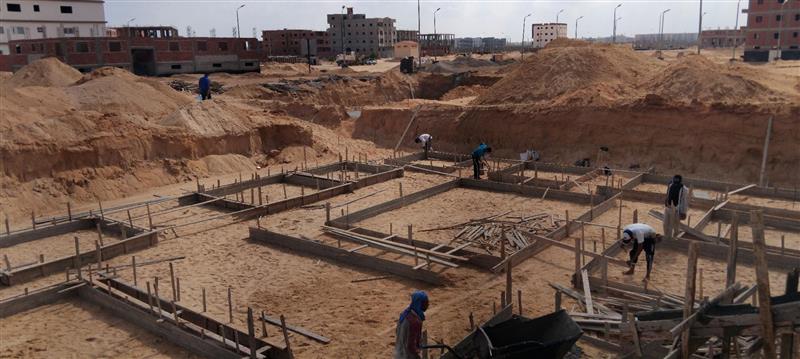

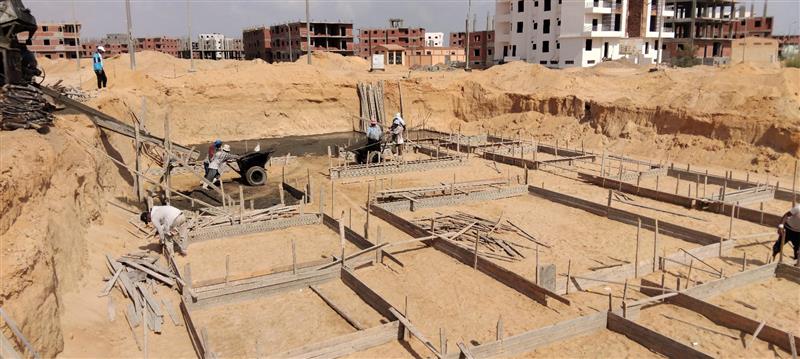

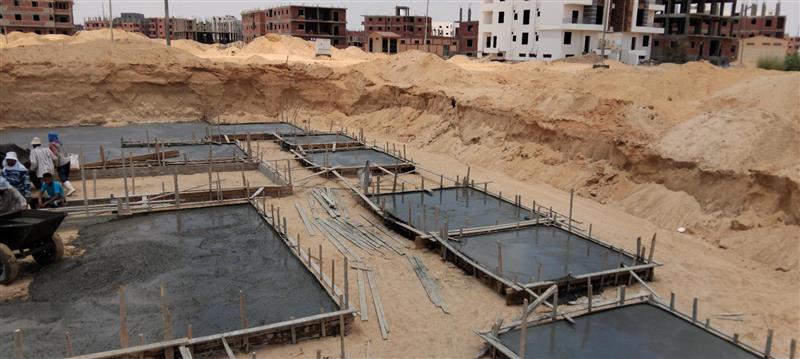

Plain foundations
May 4, 2025

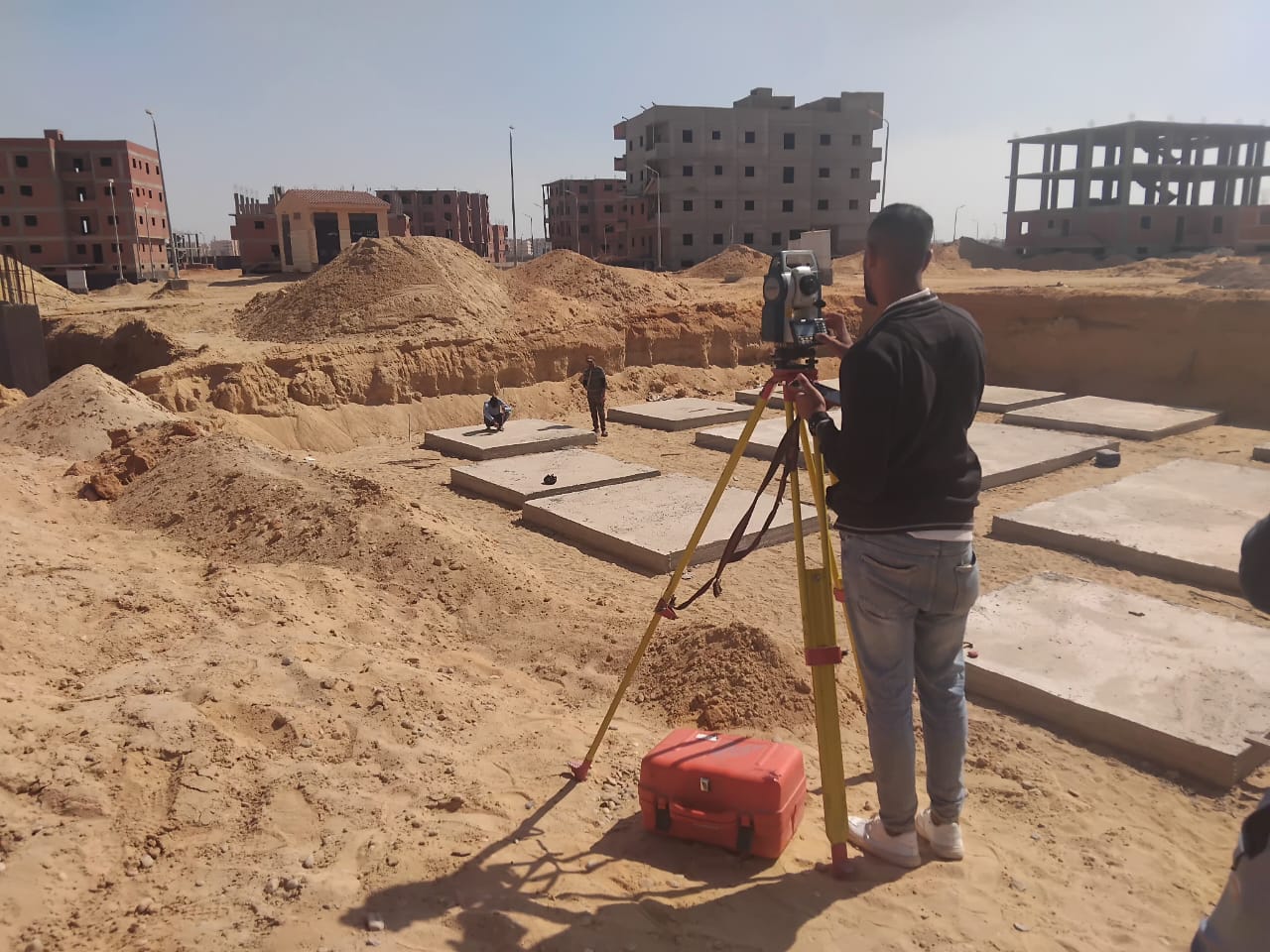

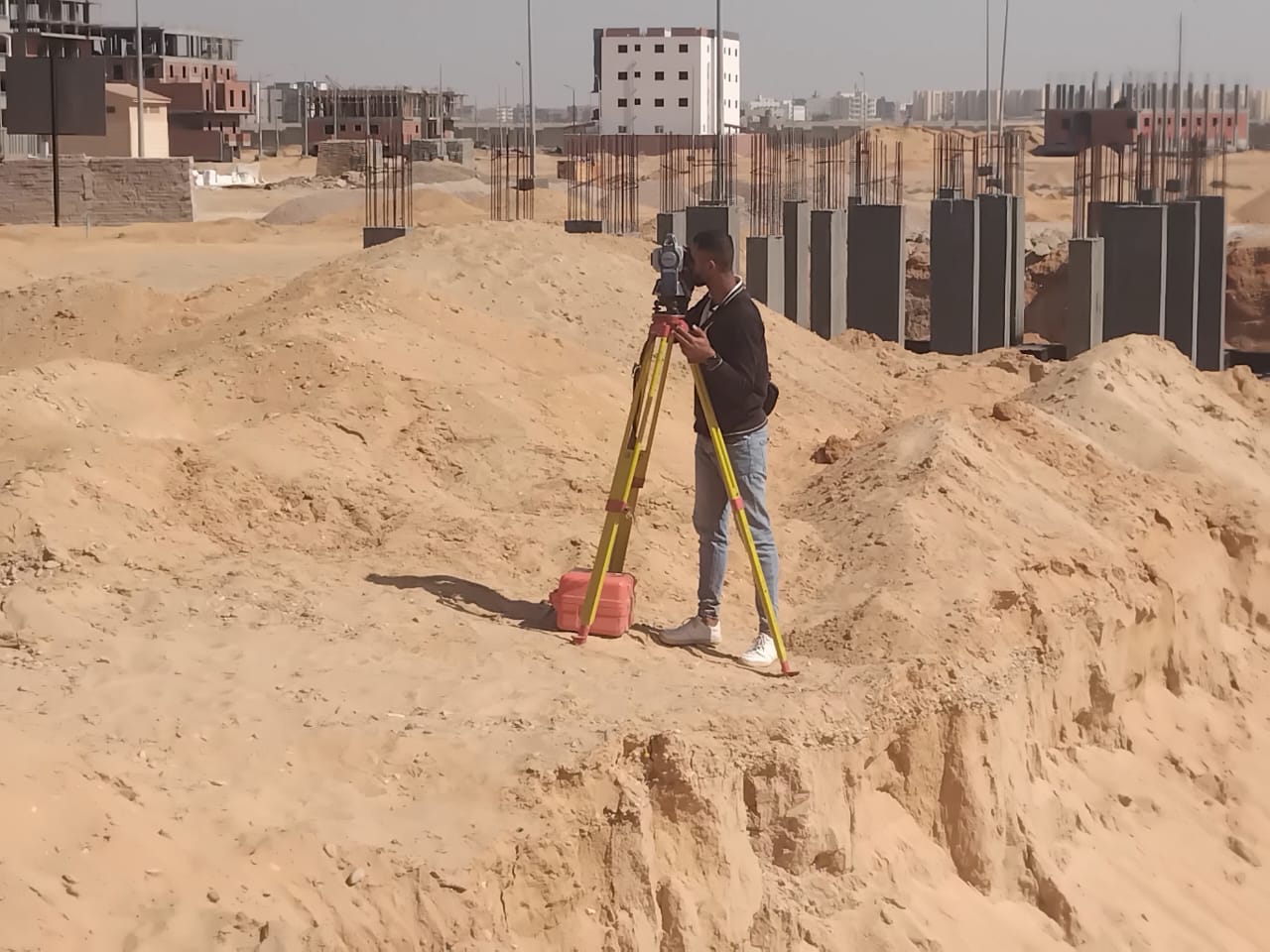

Reinforced foundations
May 5, 2025

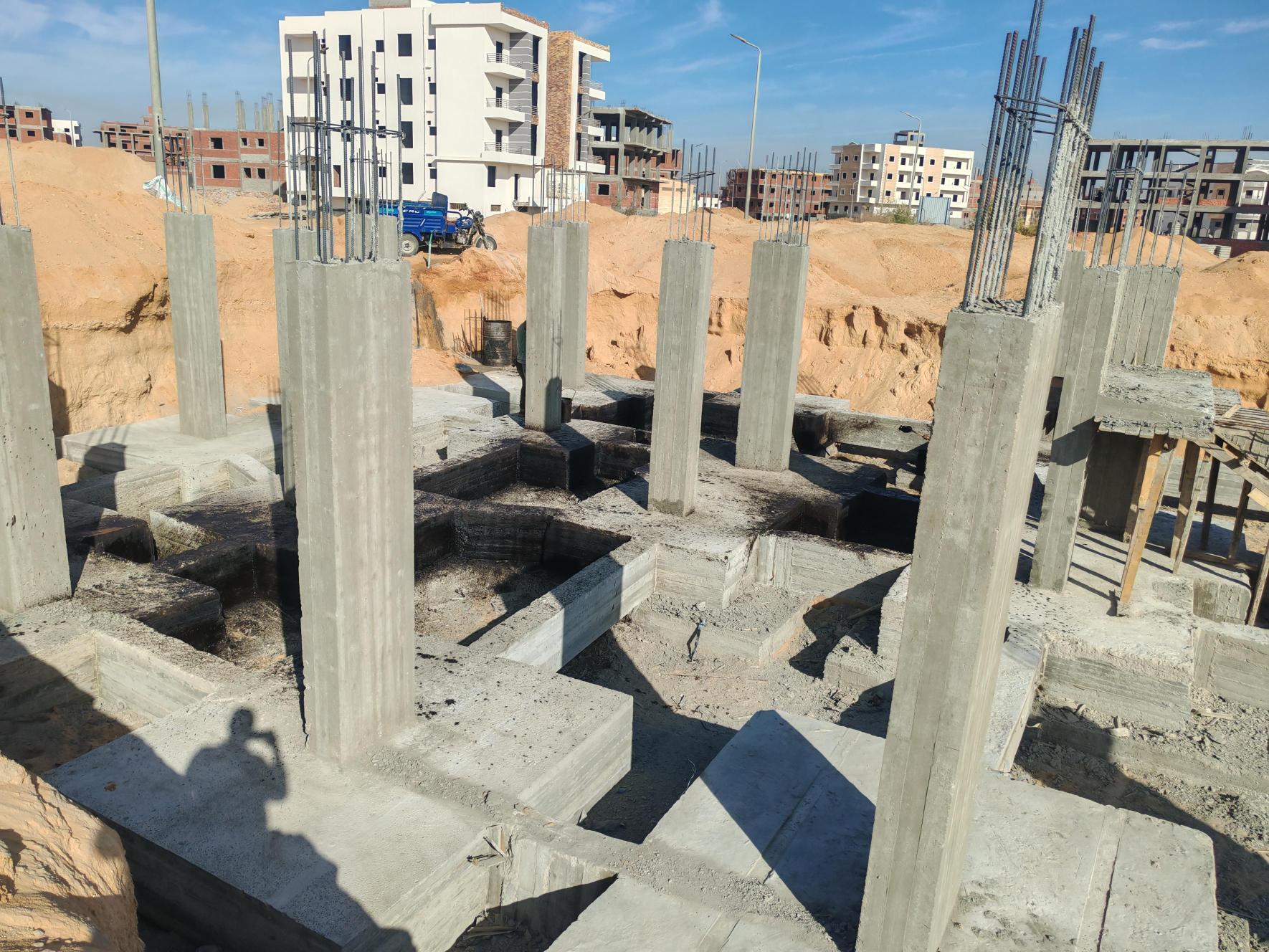

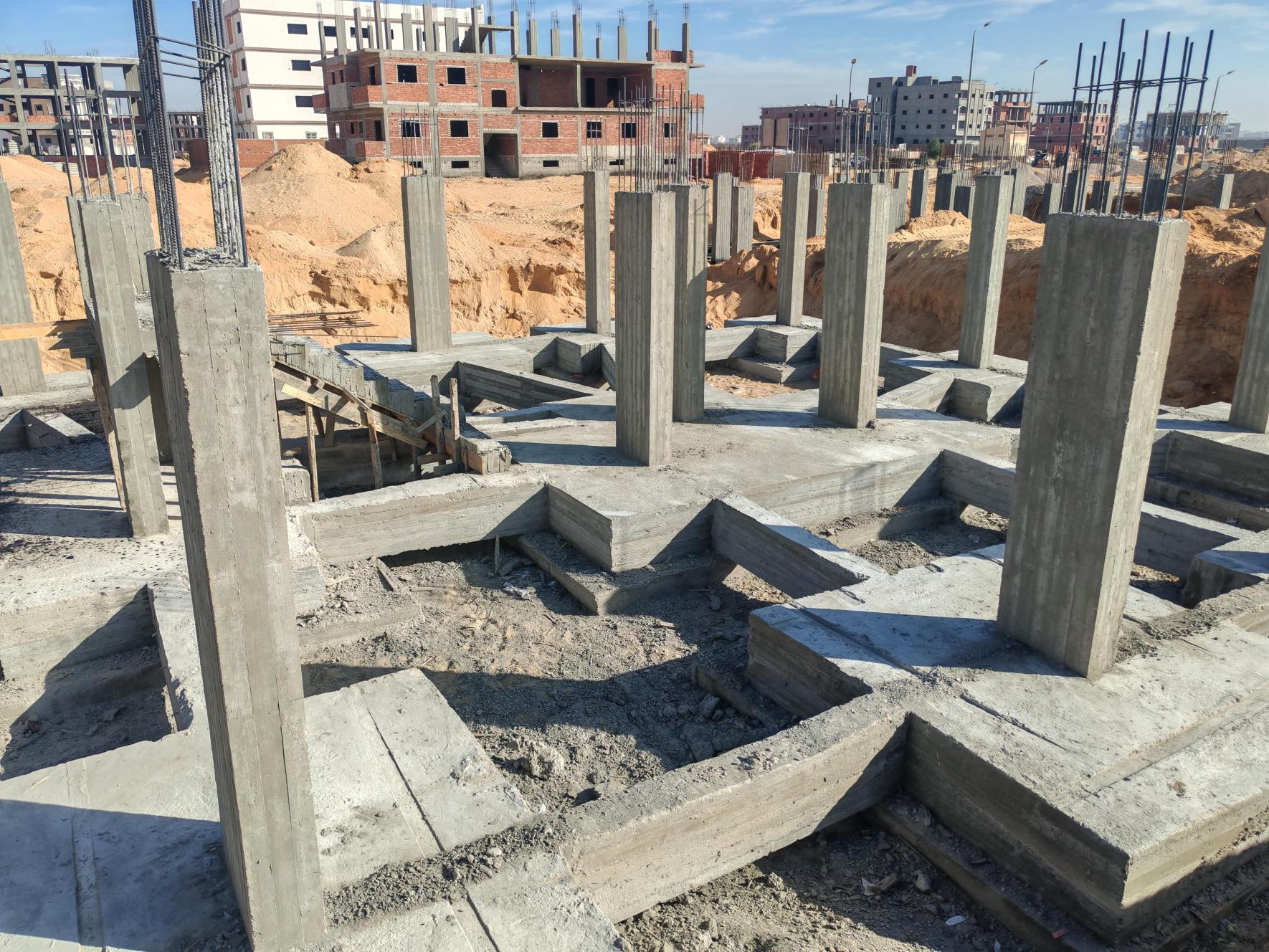

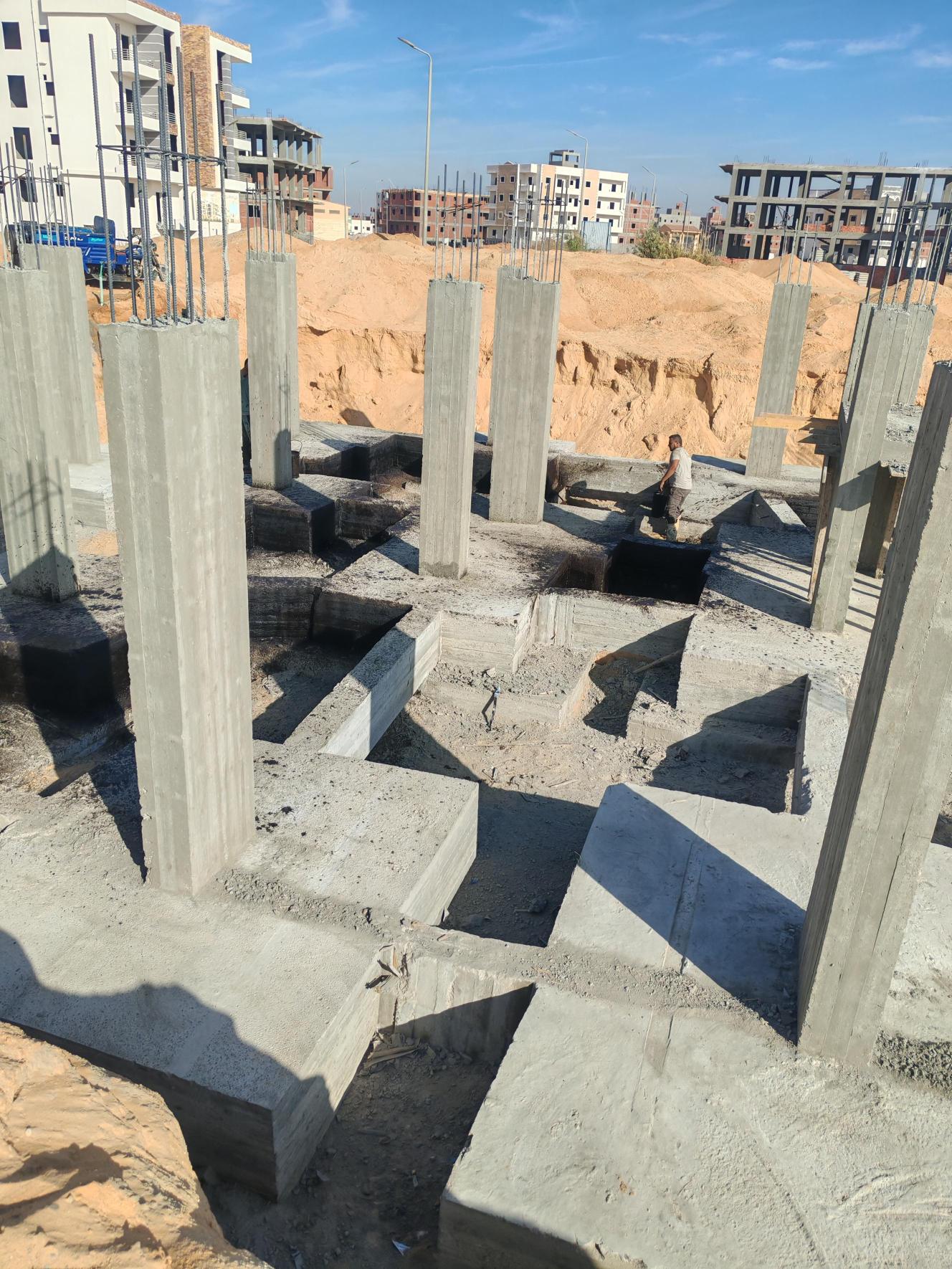

Footings insulation
May 6, 2025

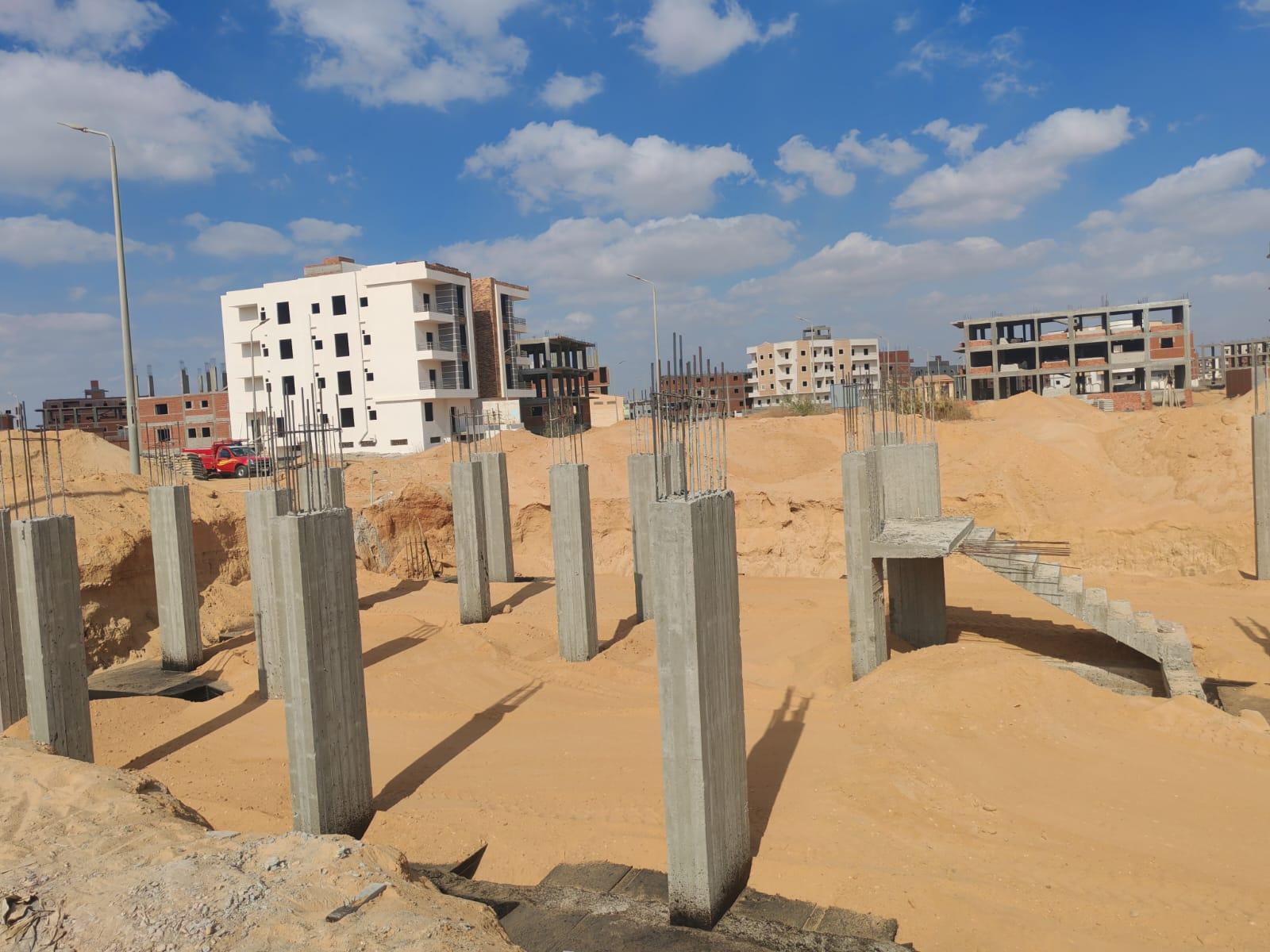

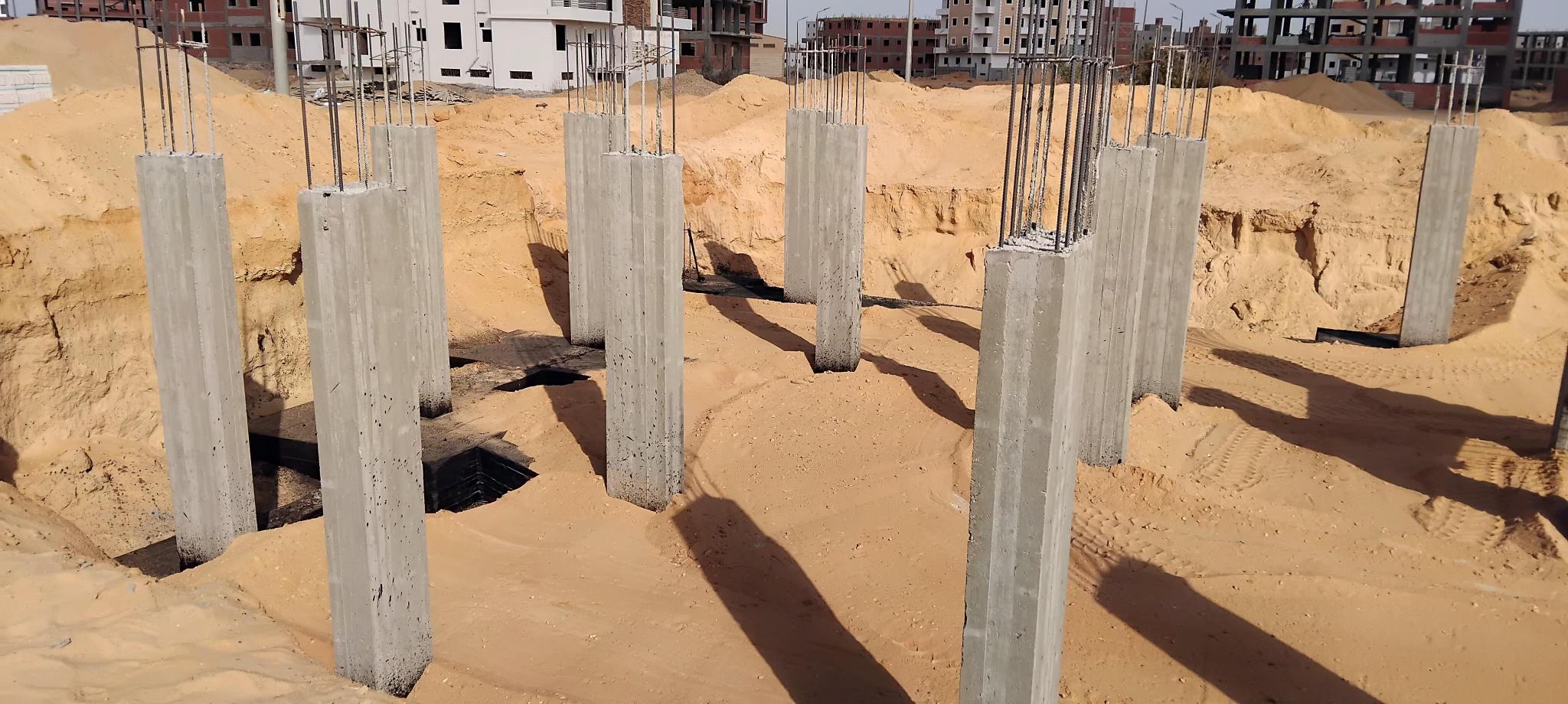

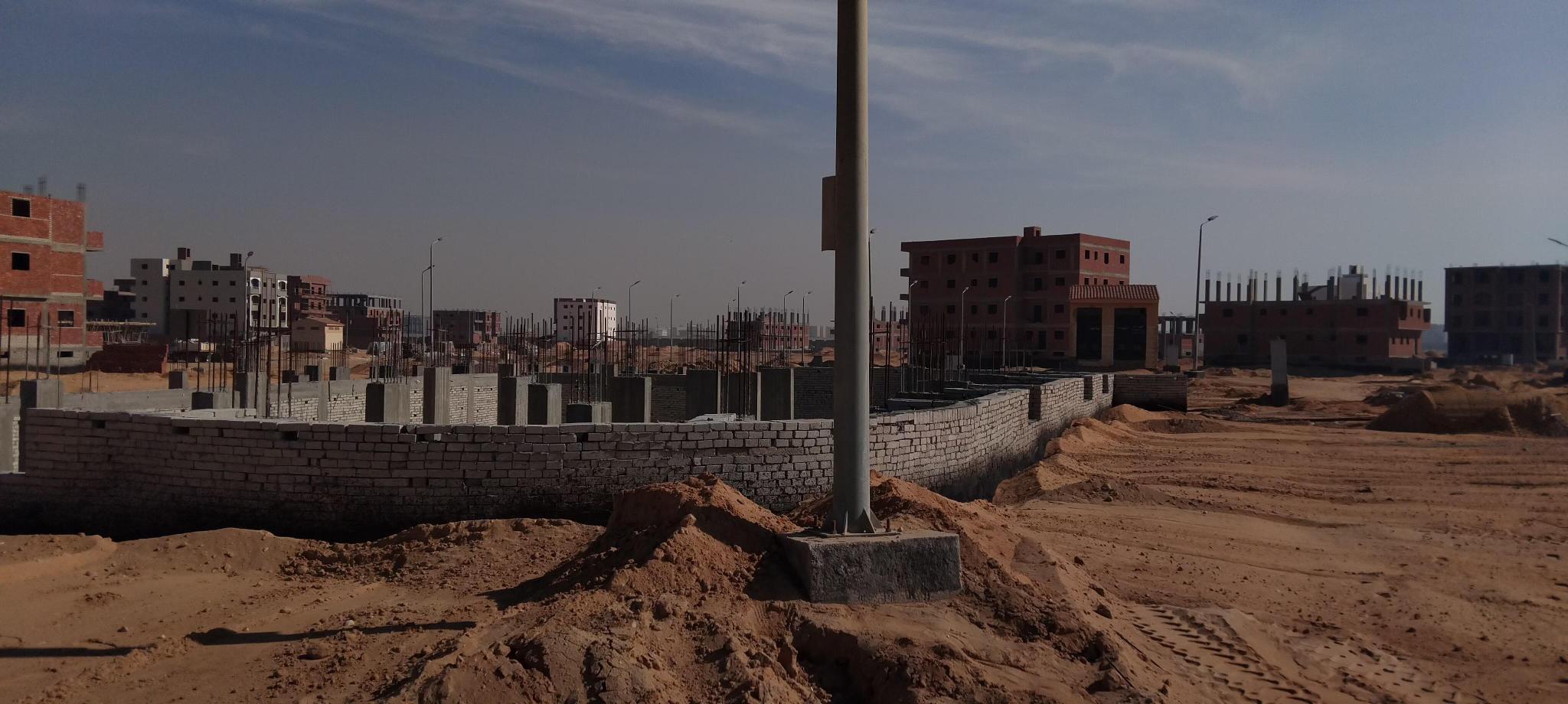

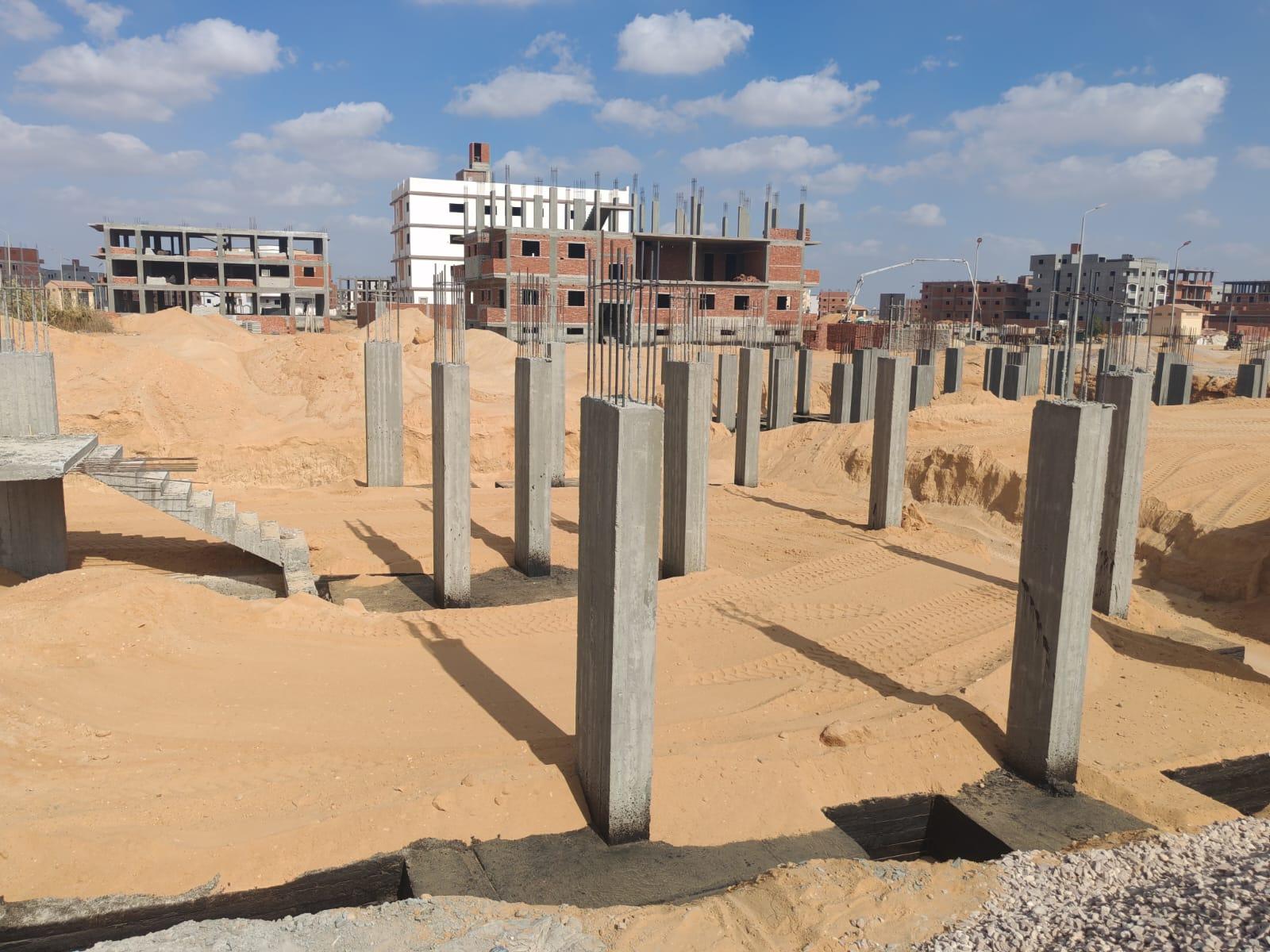

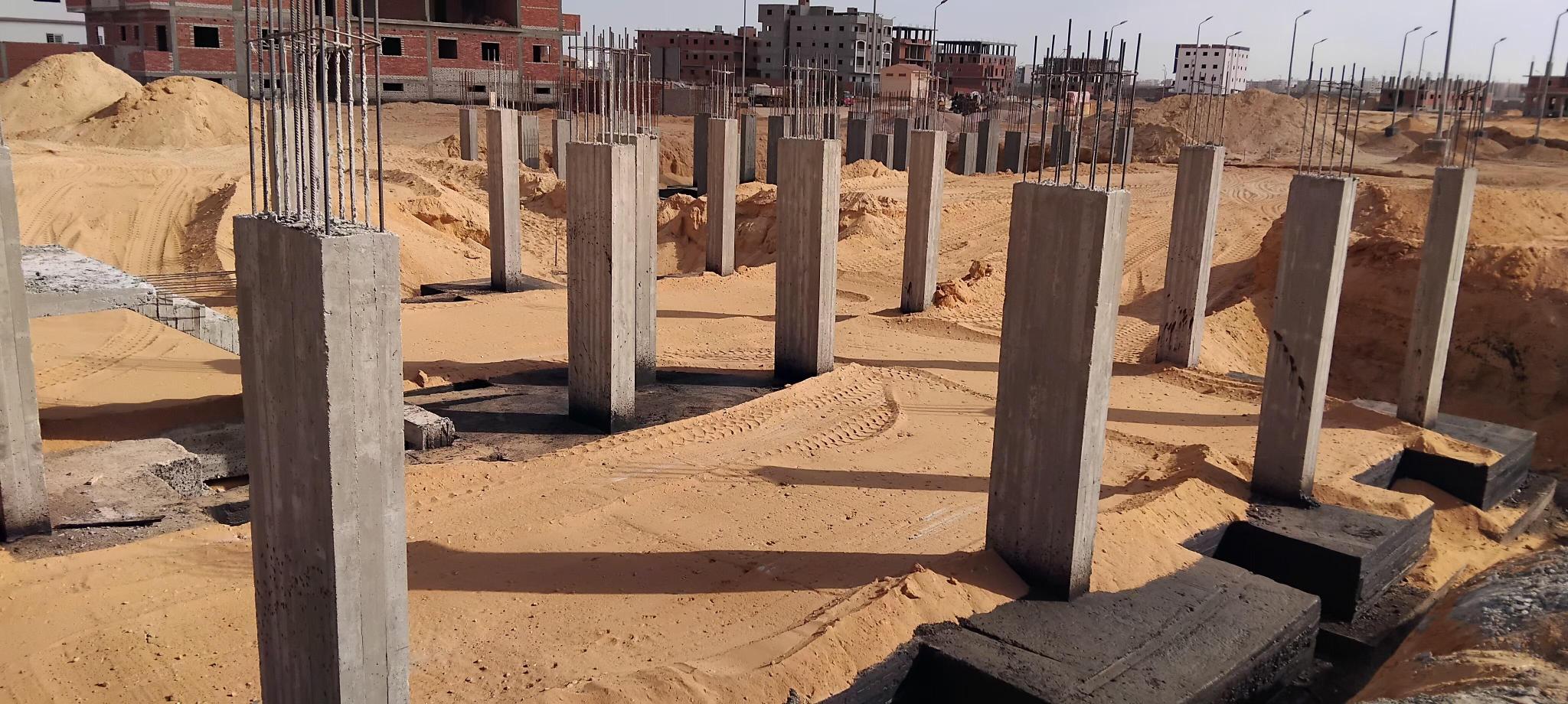

Backfilling around foundations
May 23, 2025

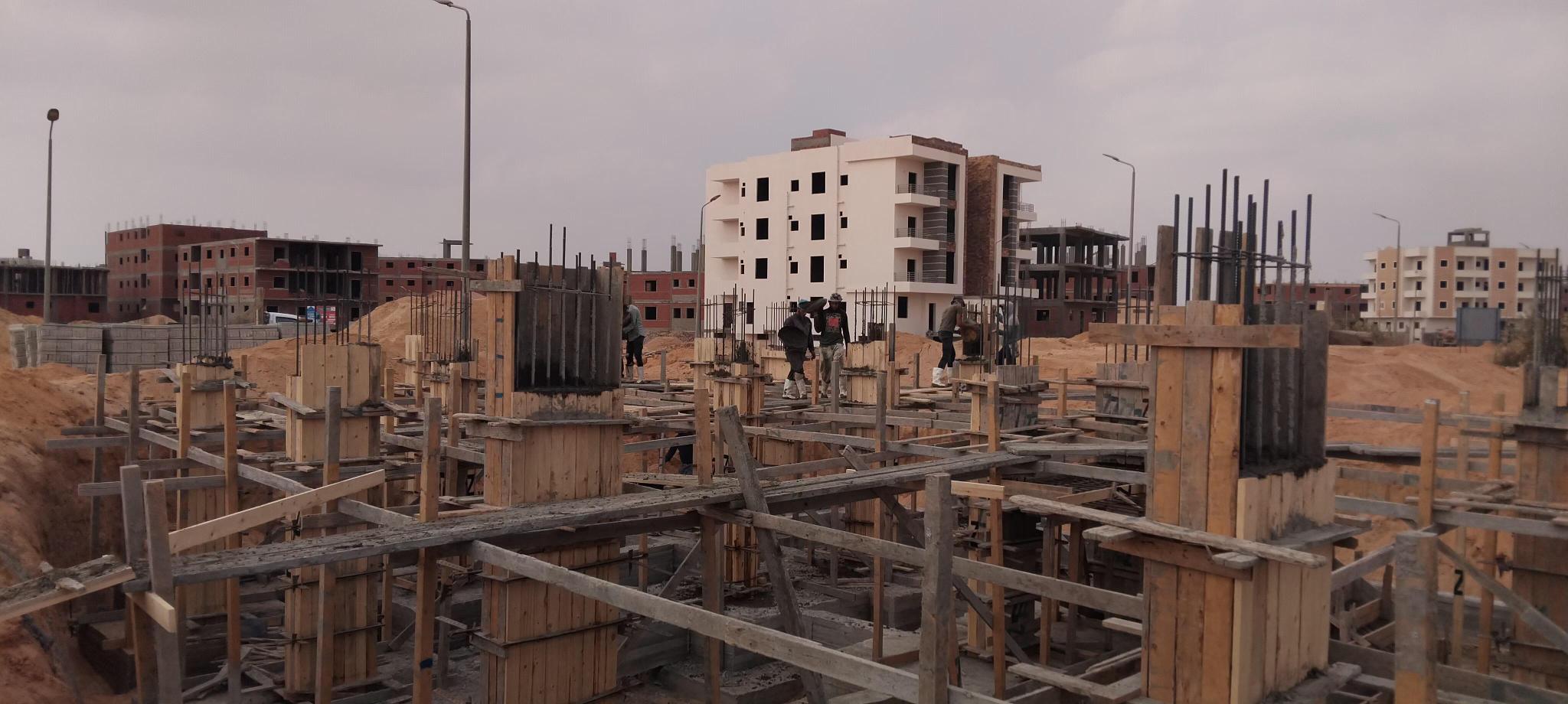

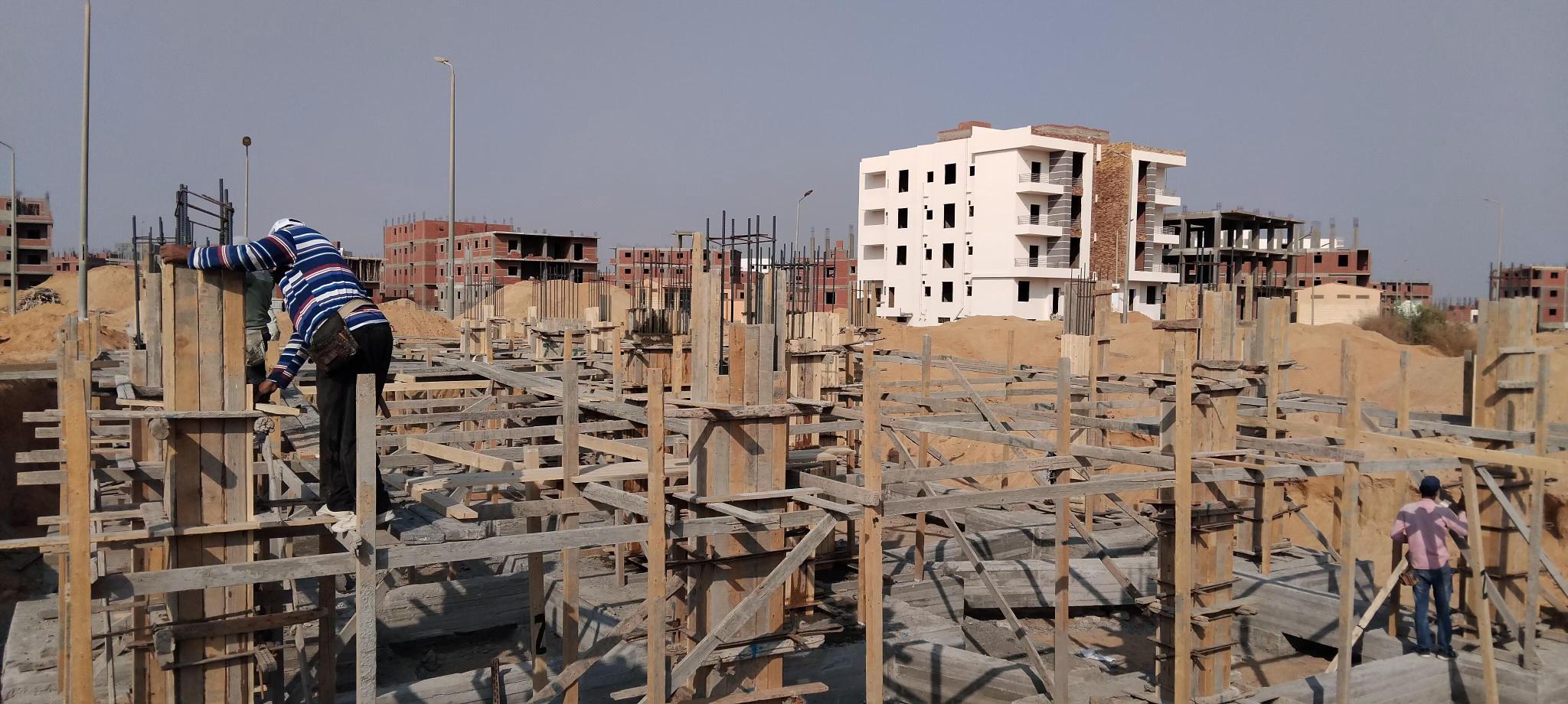

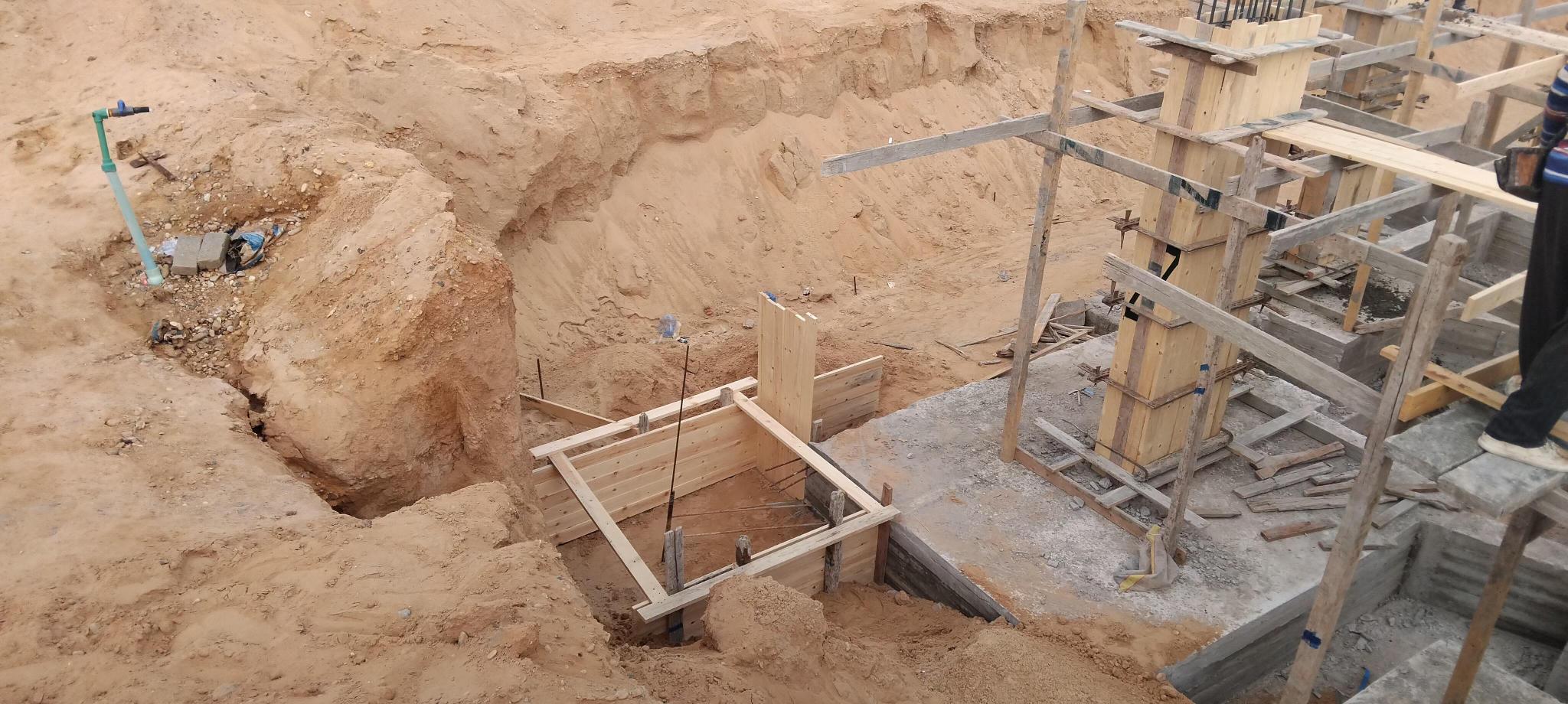

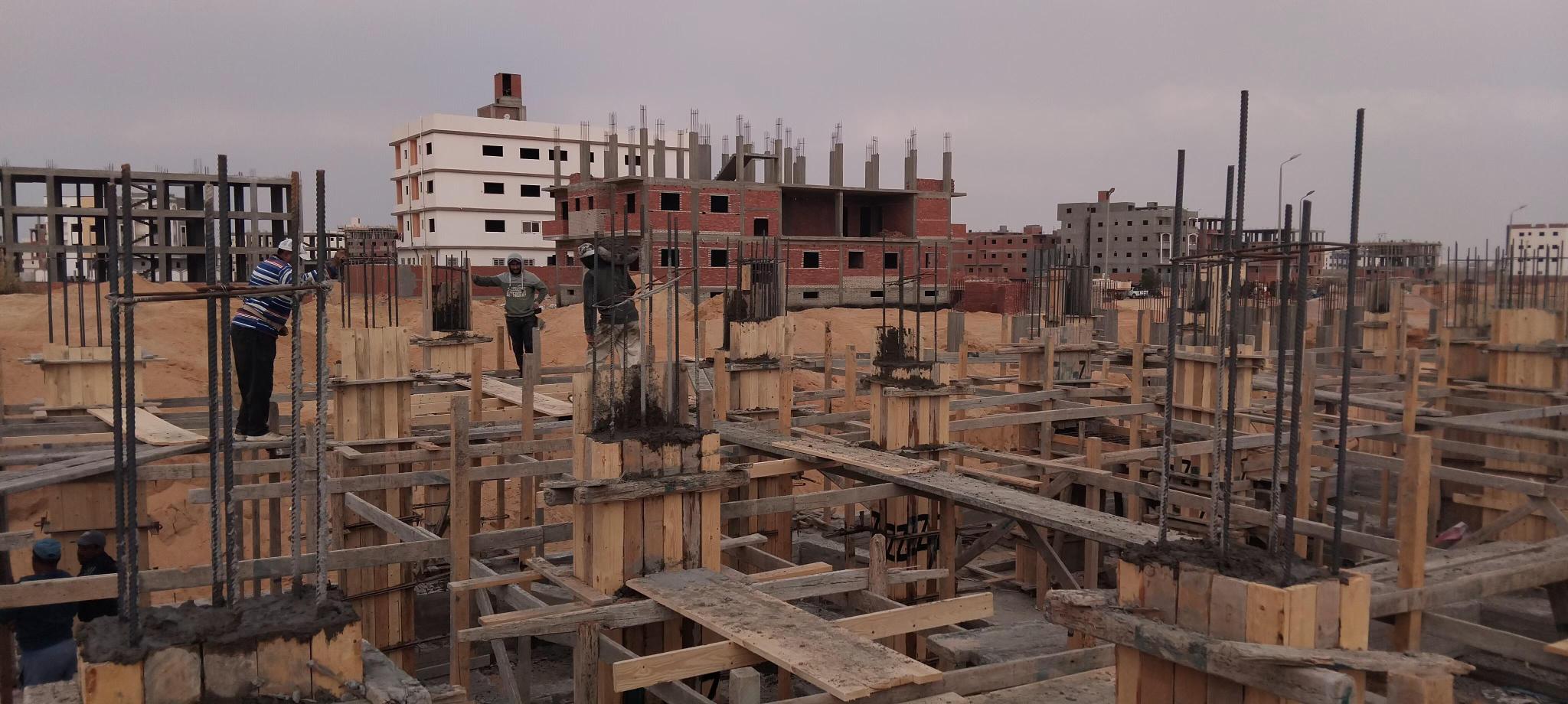

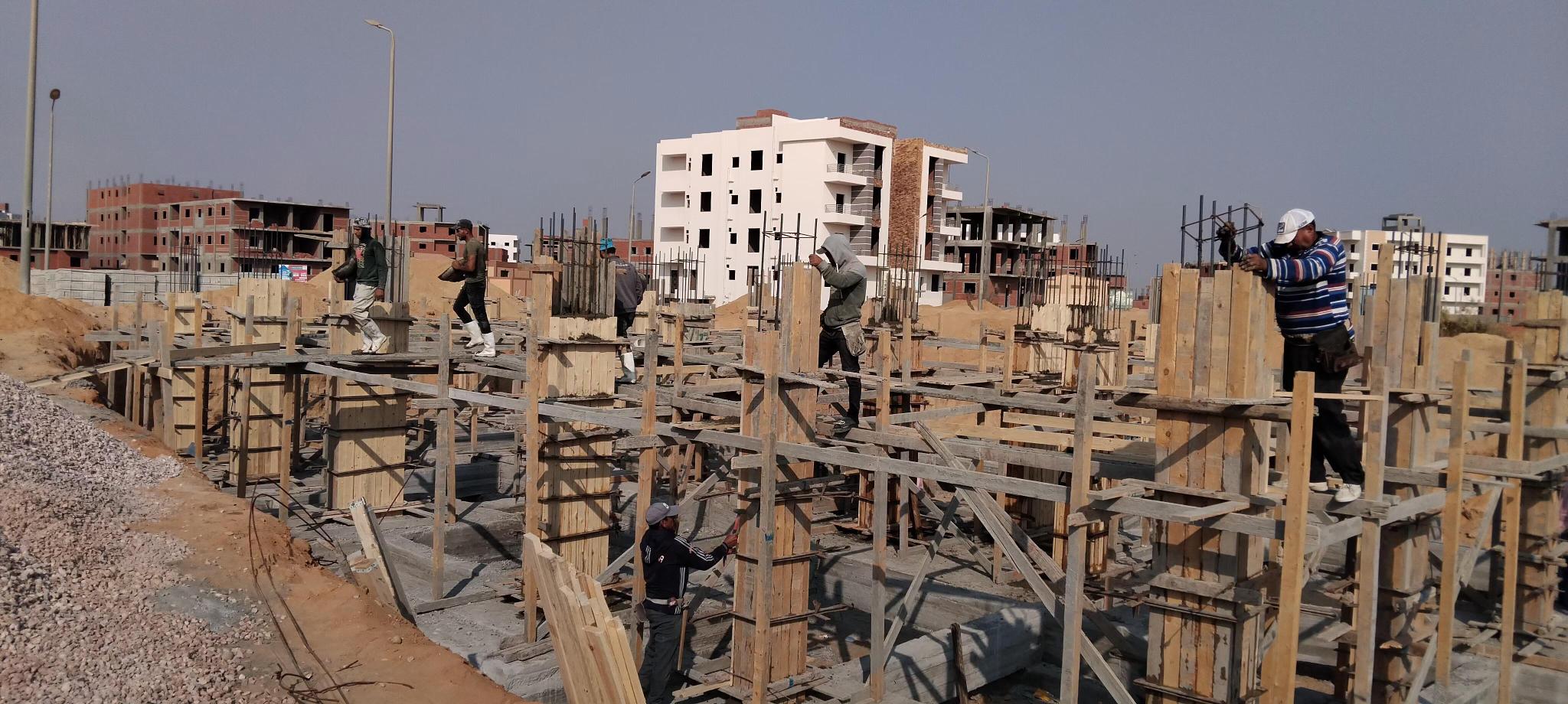

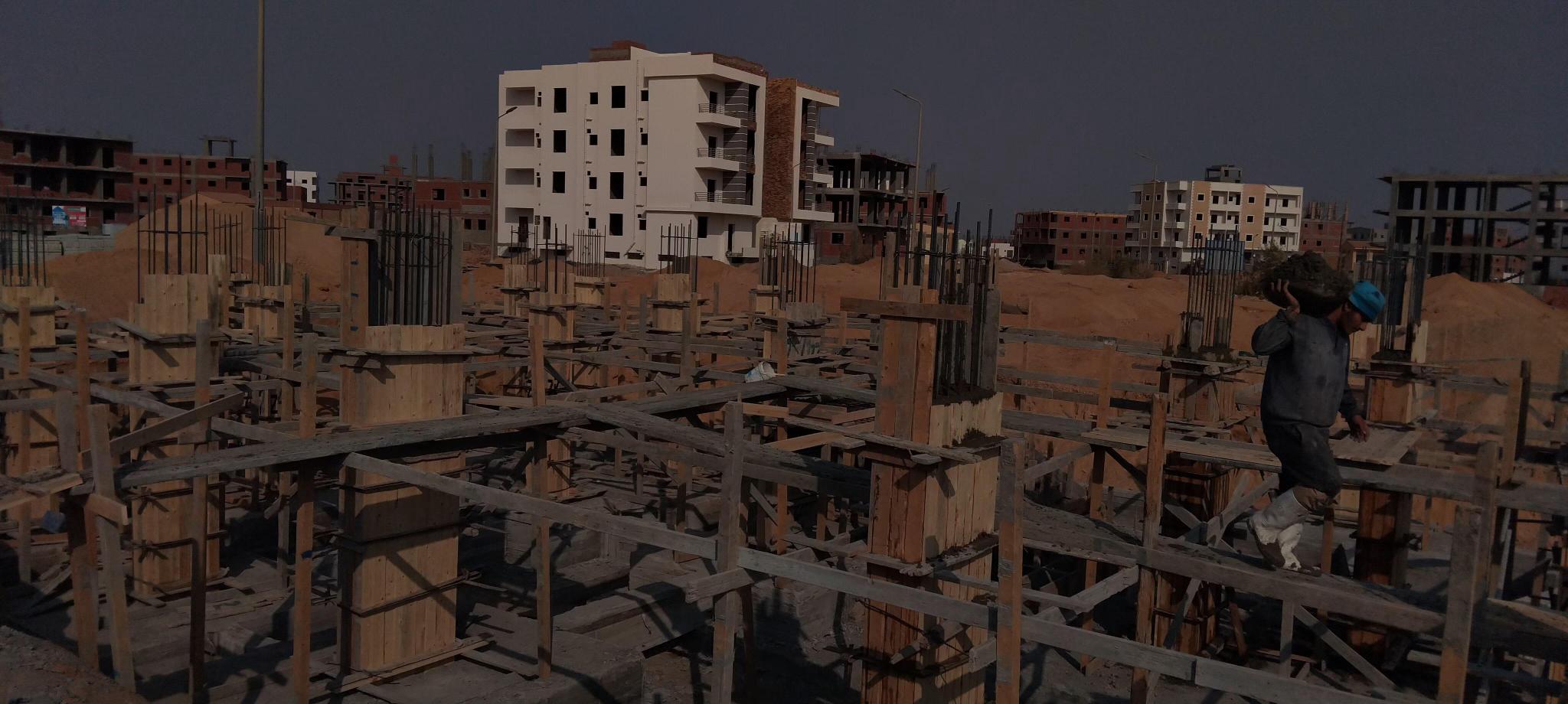

Basement columns
May 24, 2025

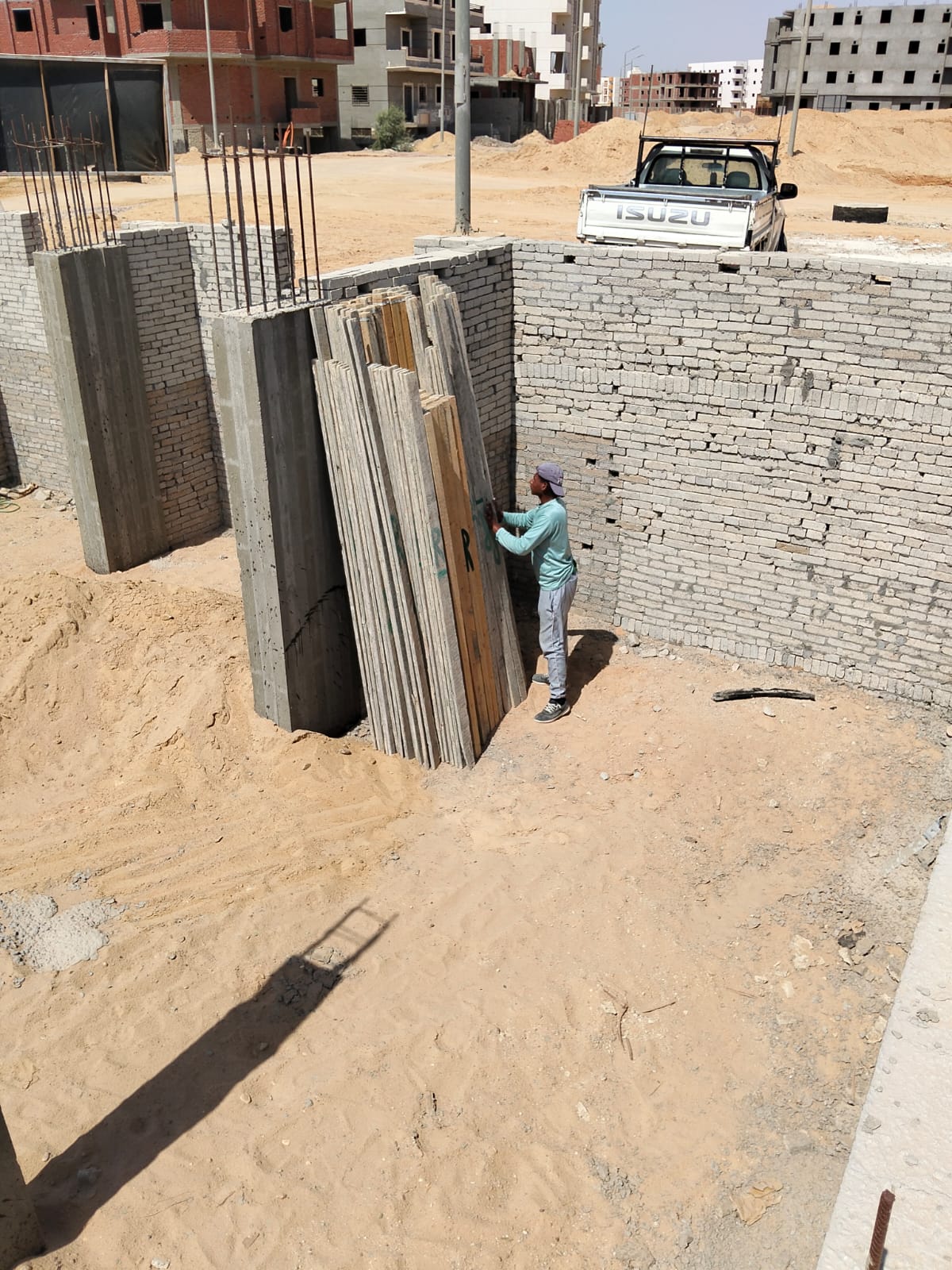

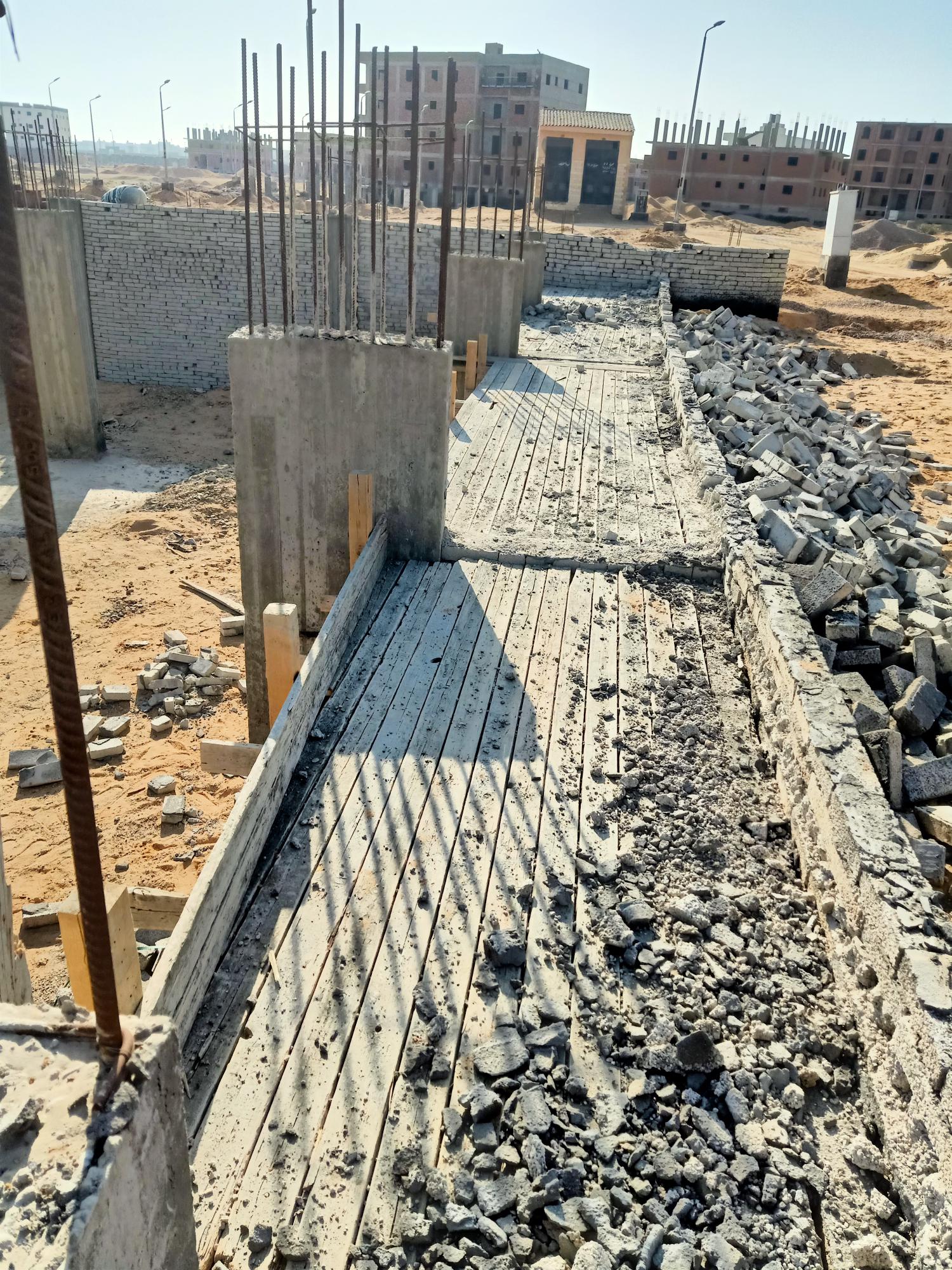

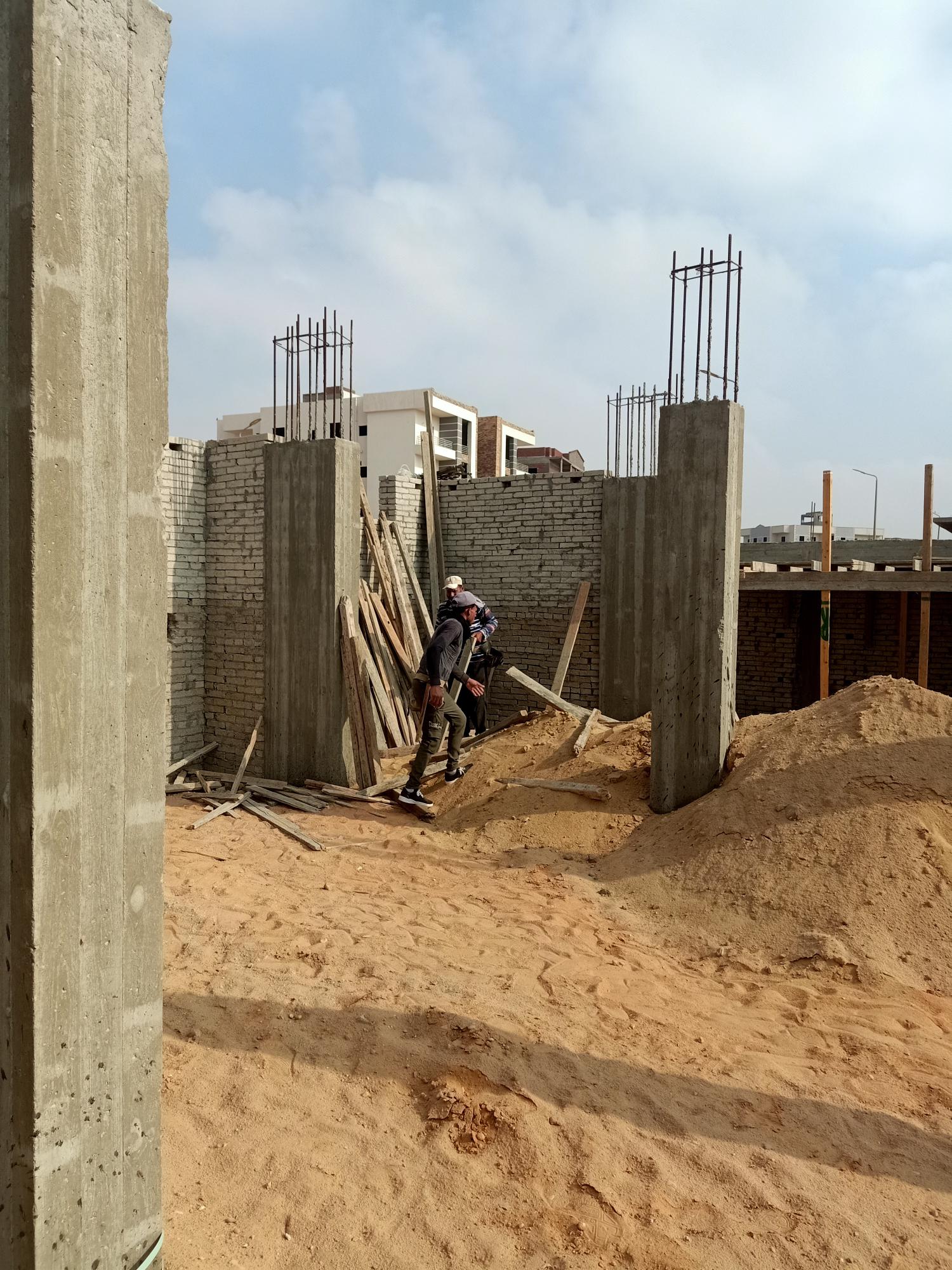

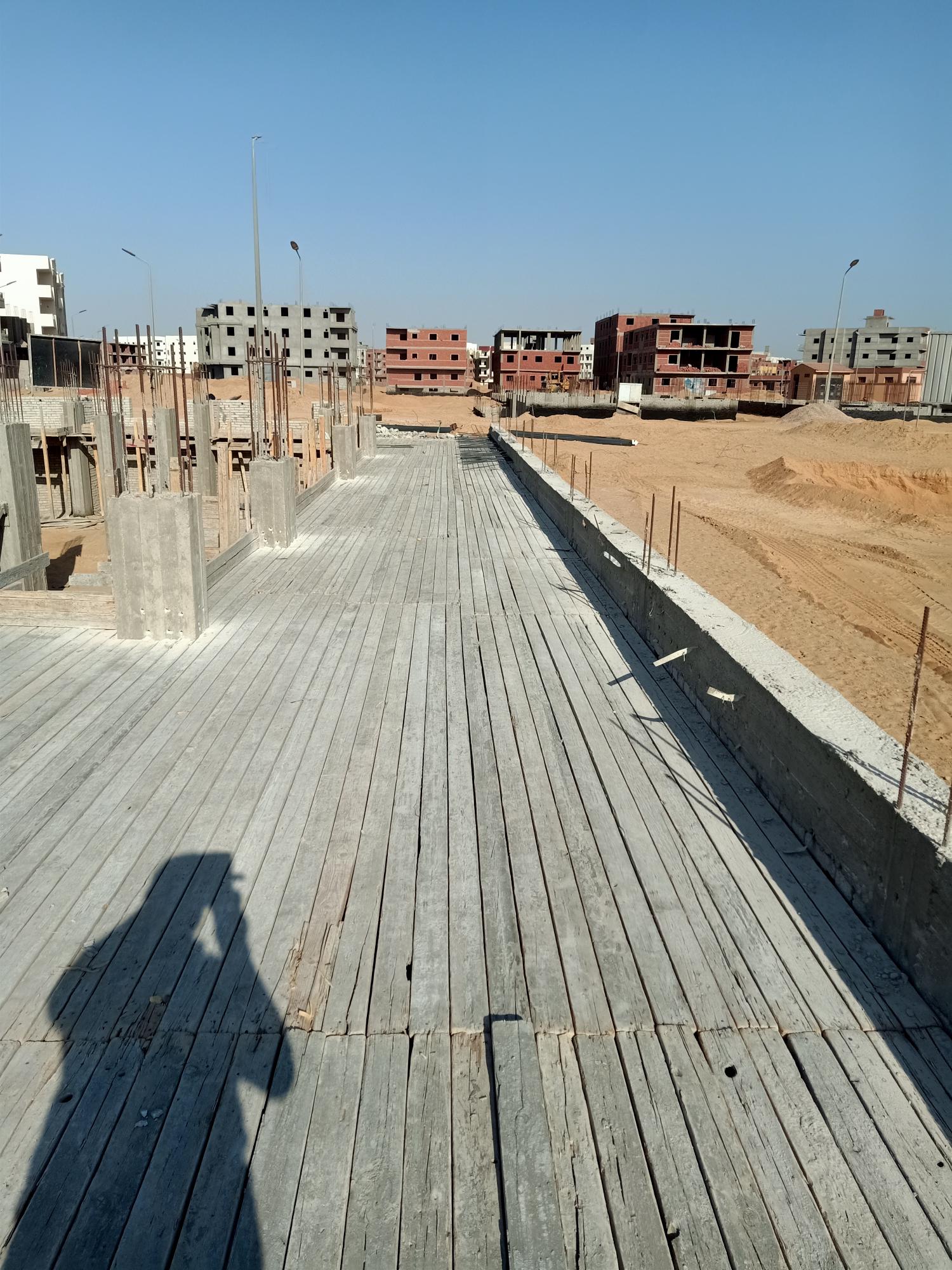

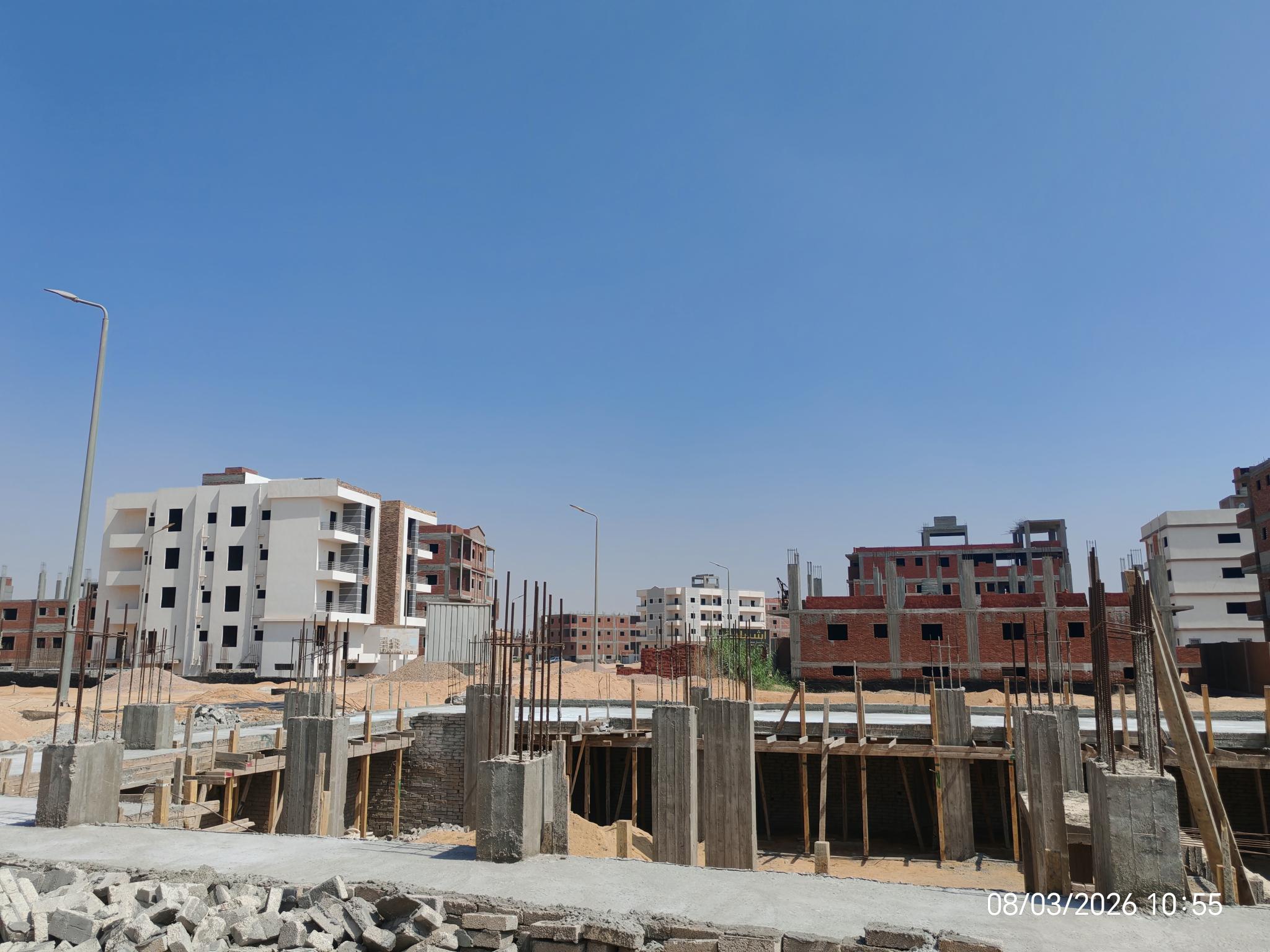

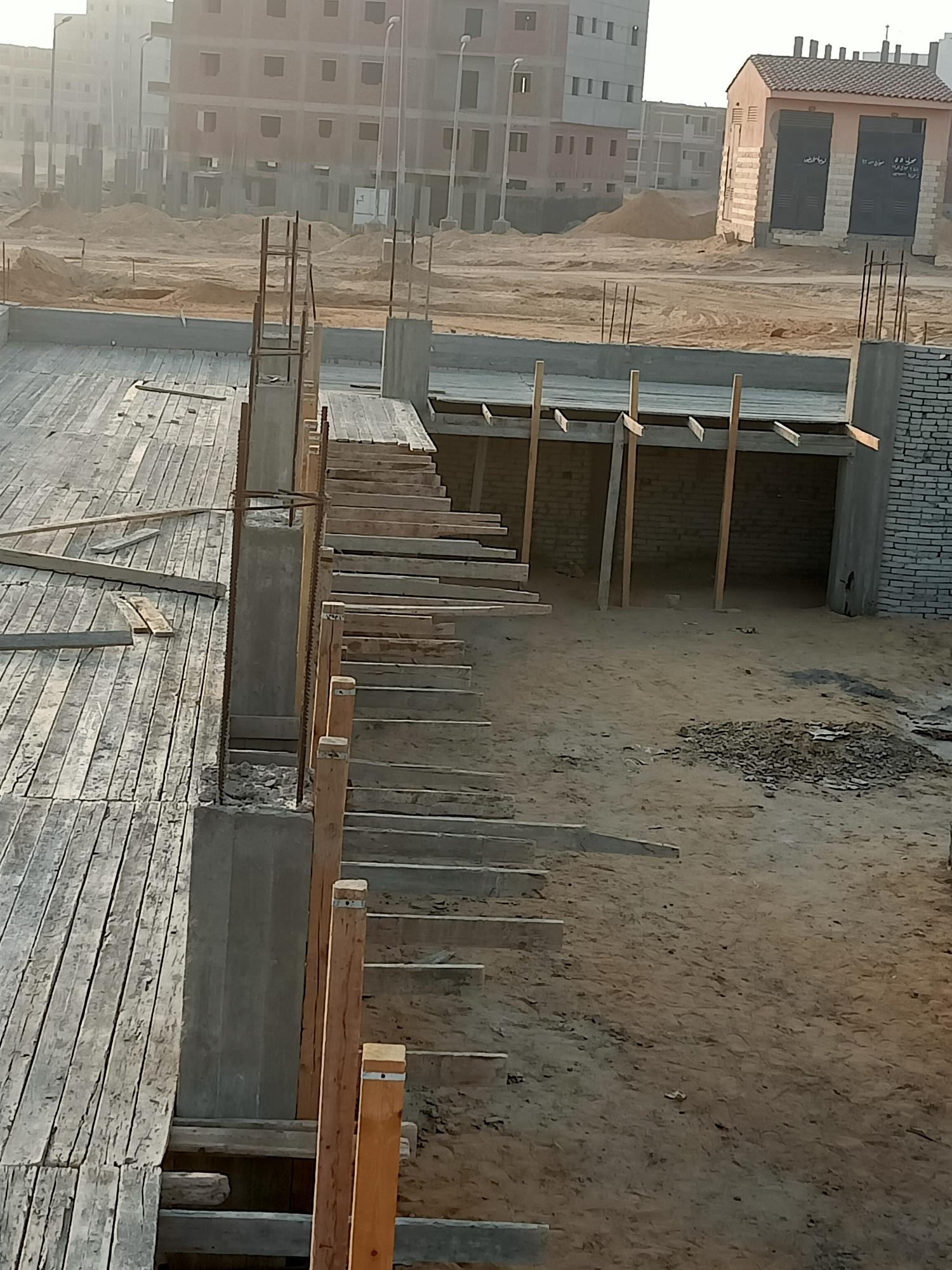

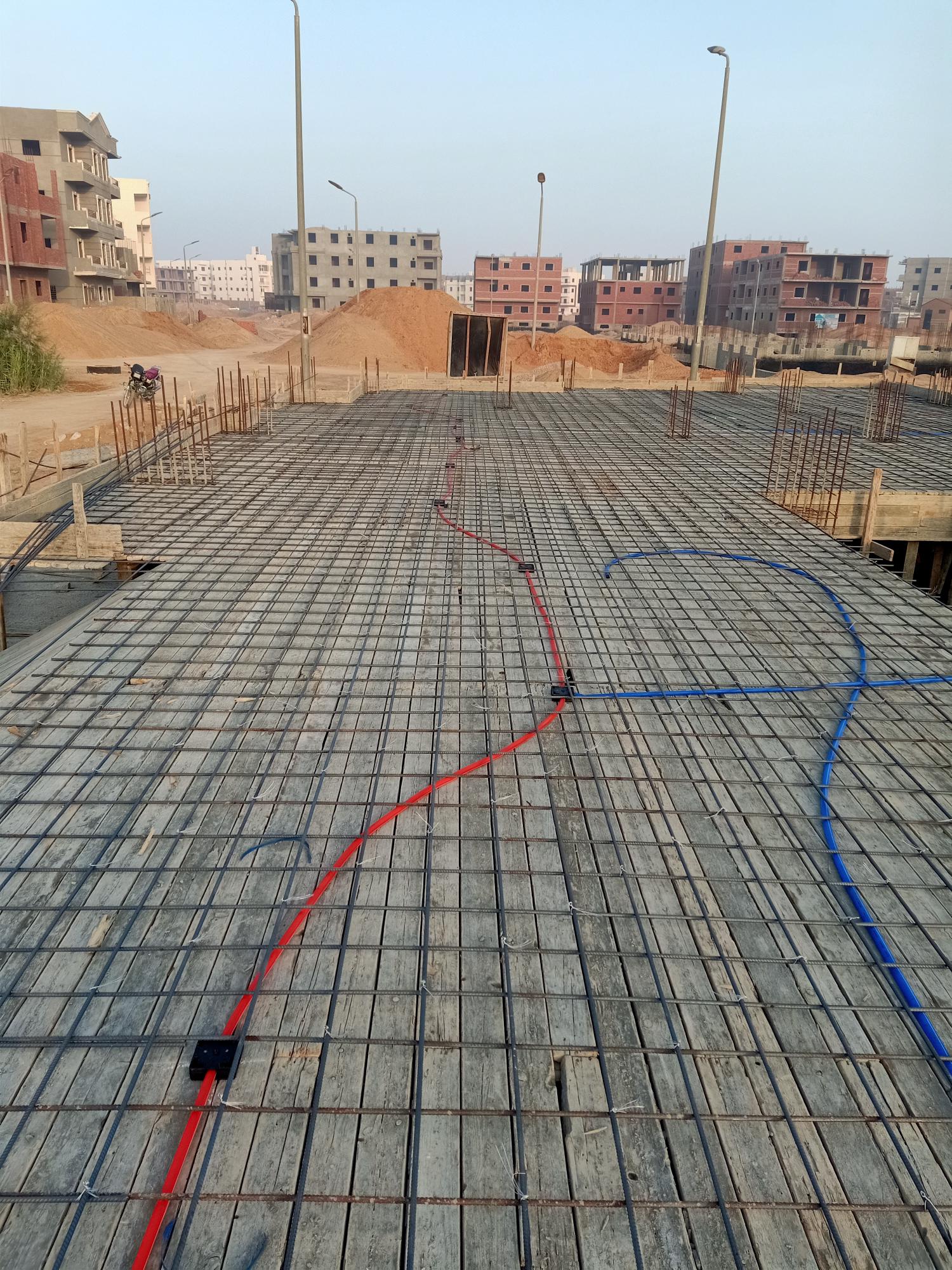

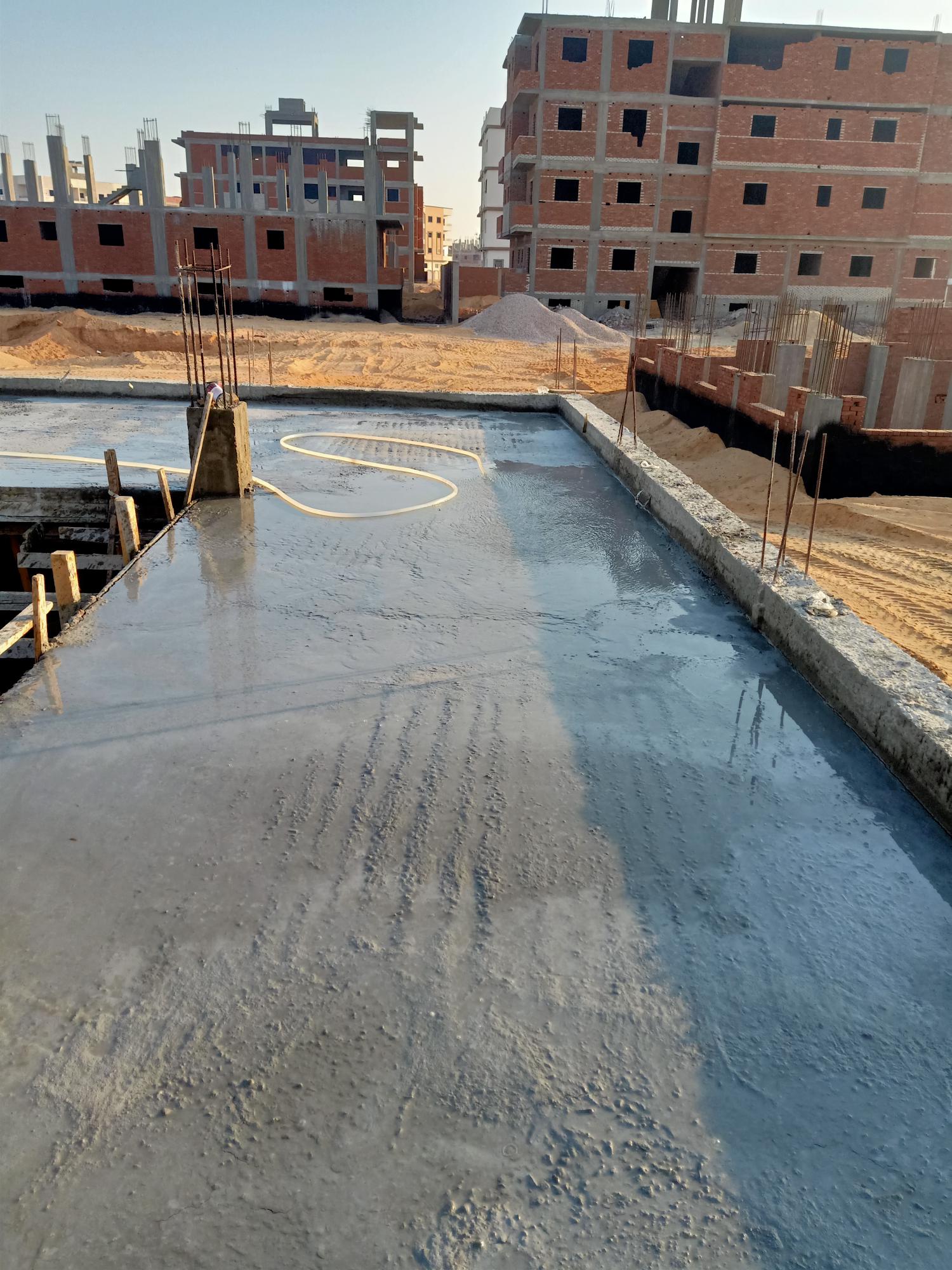

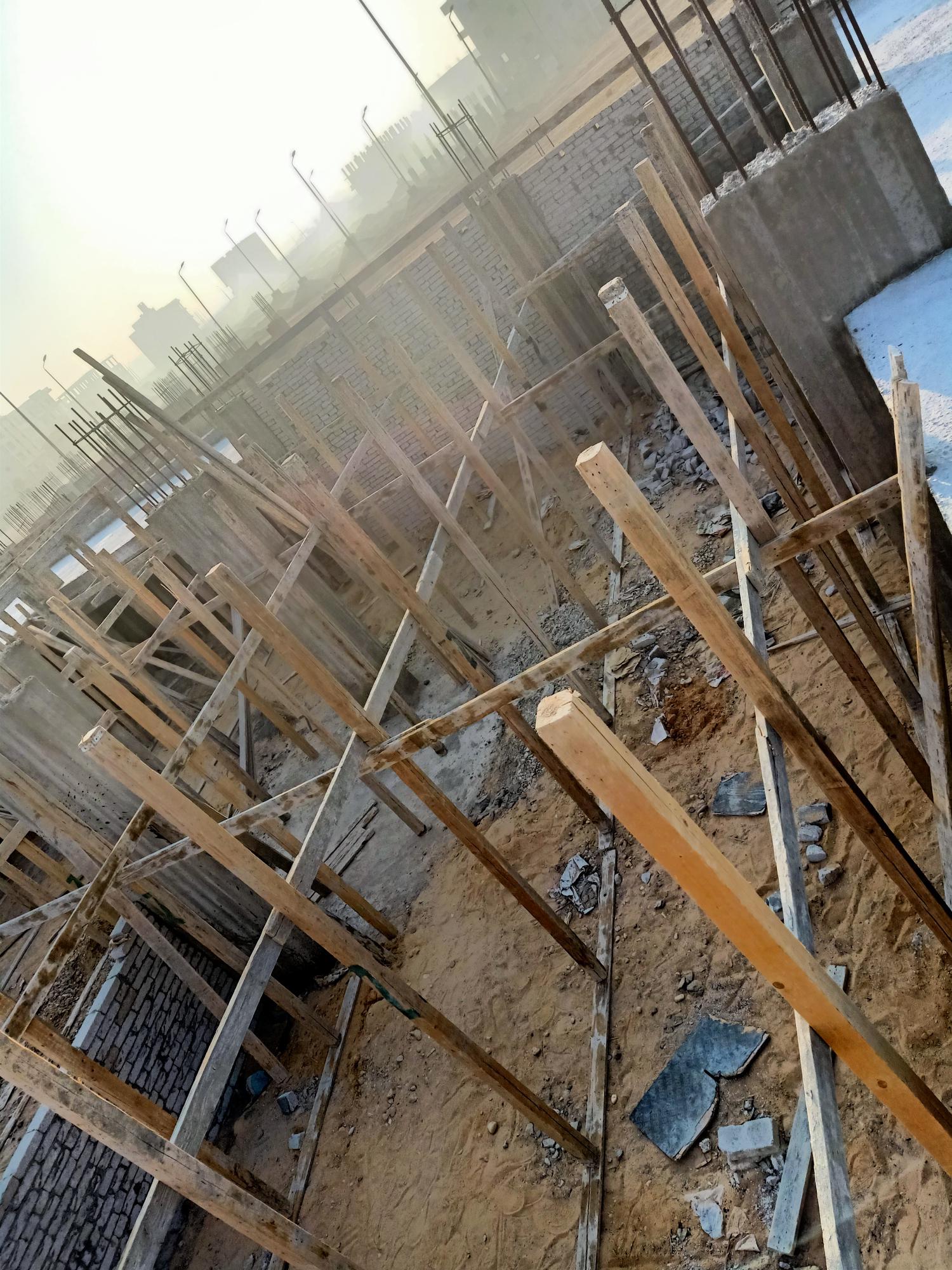

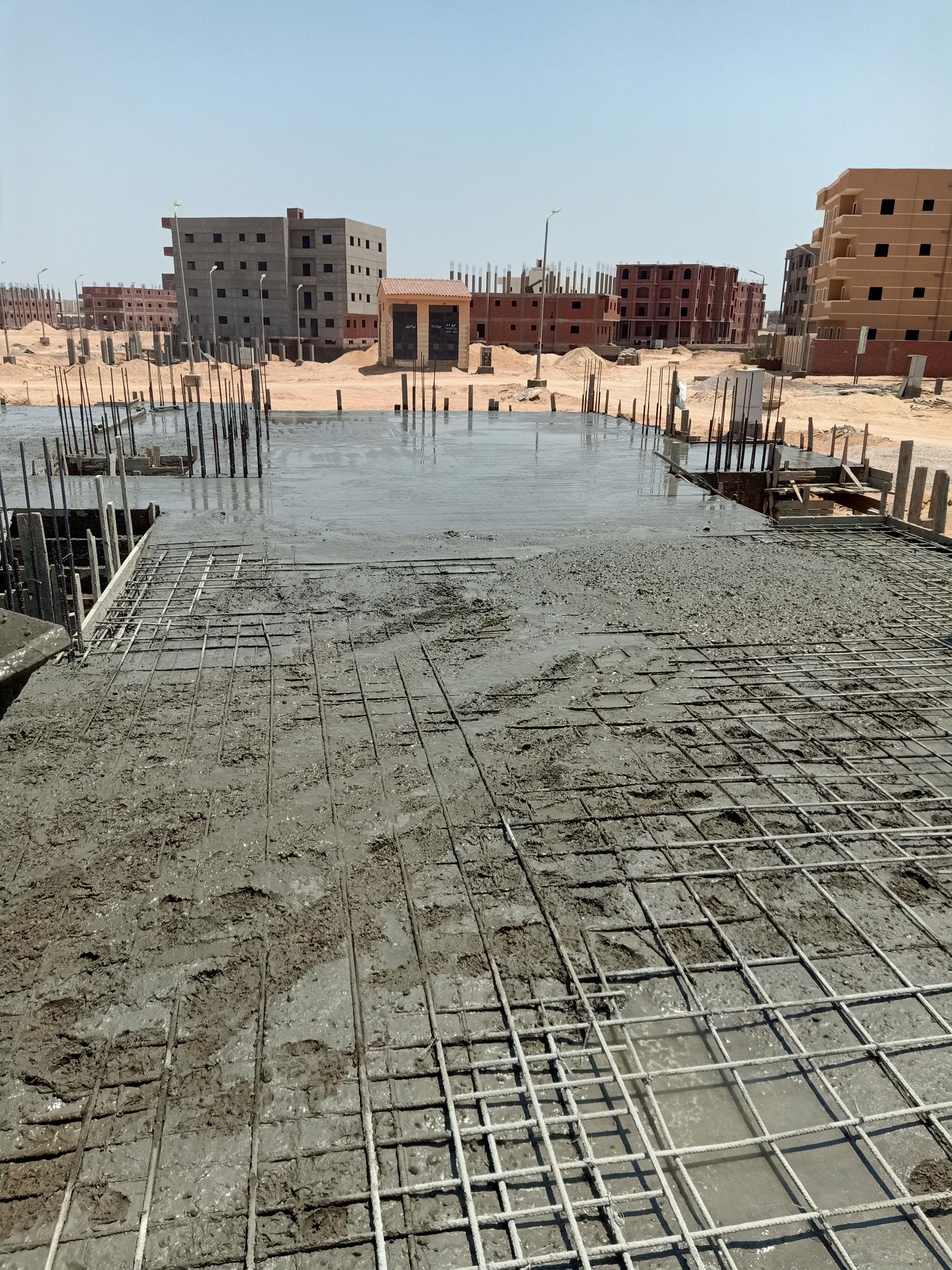

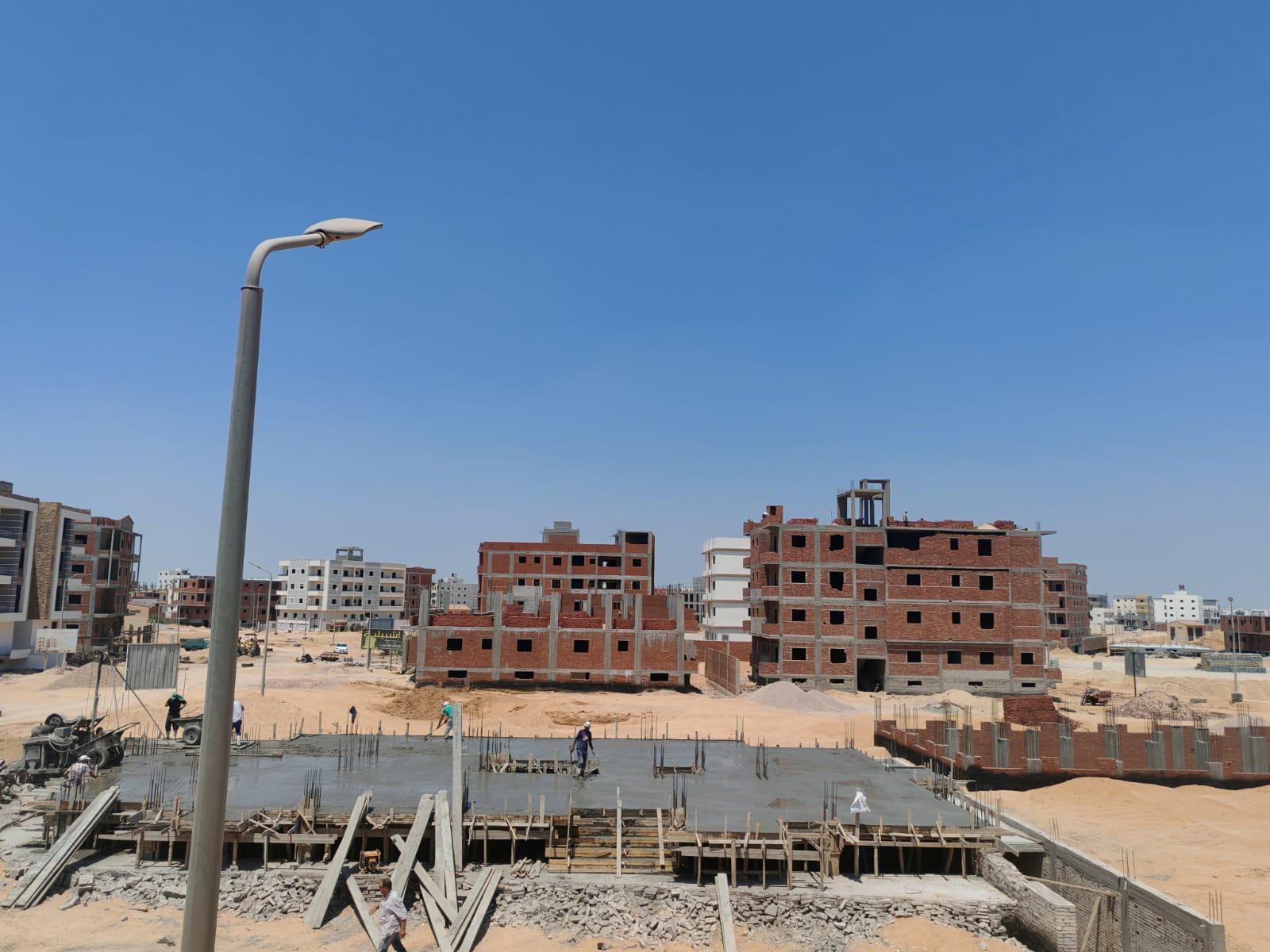

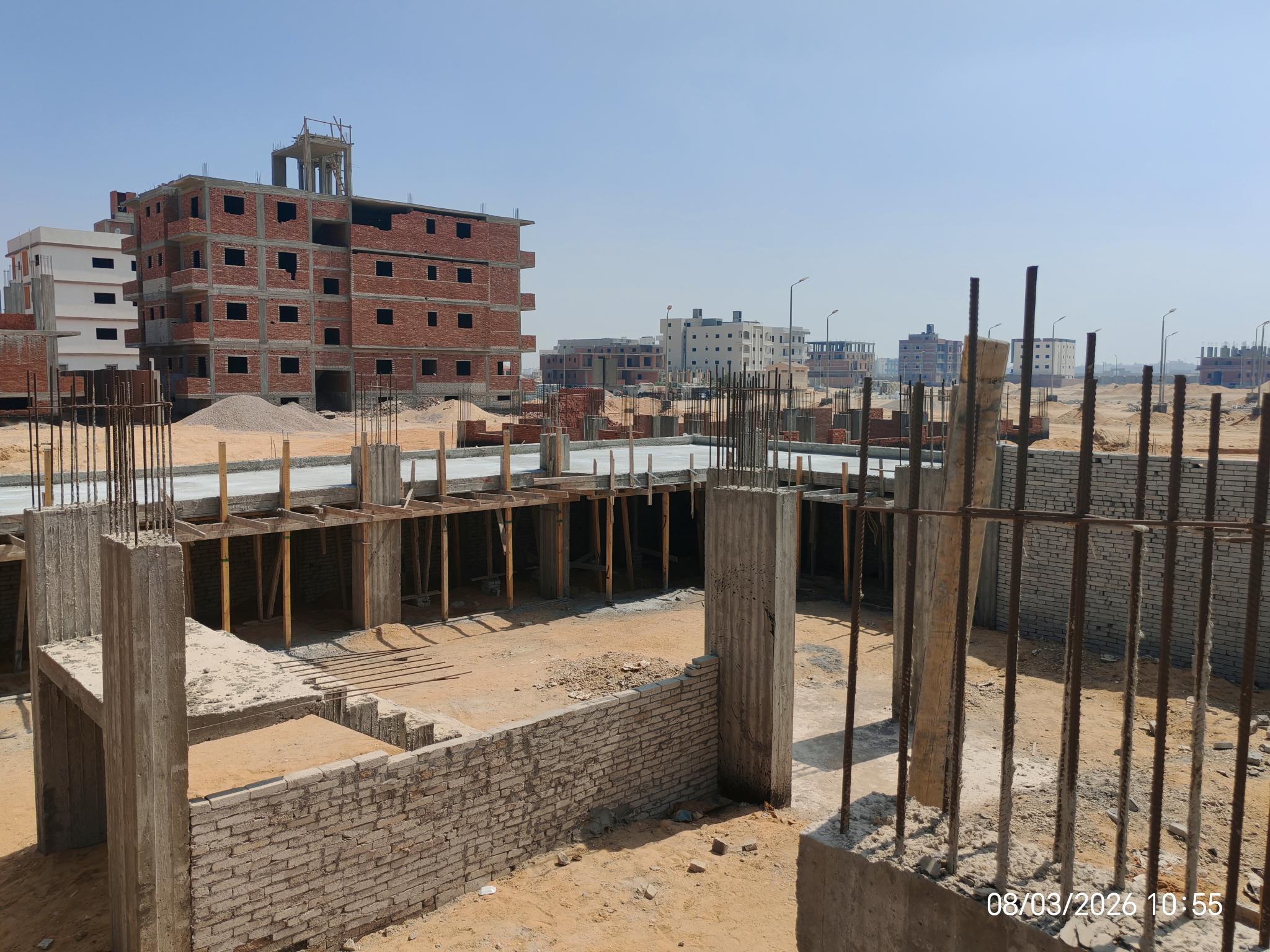

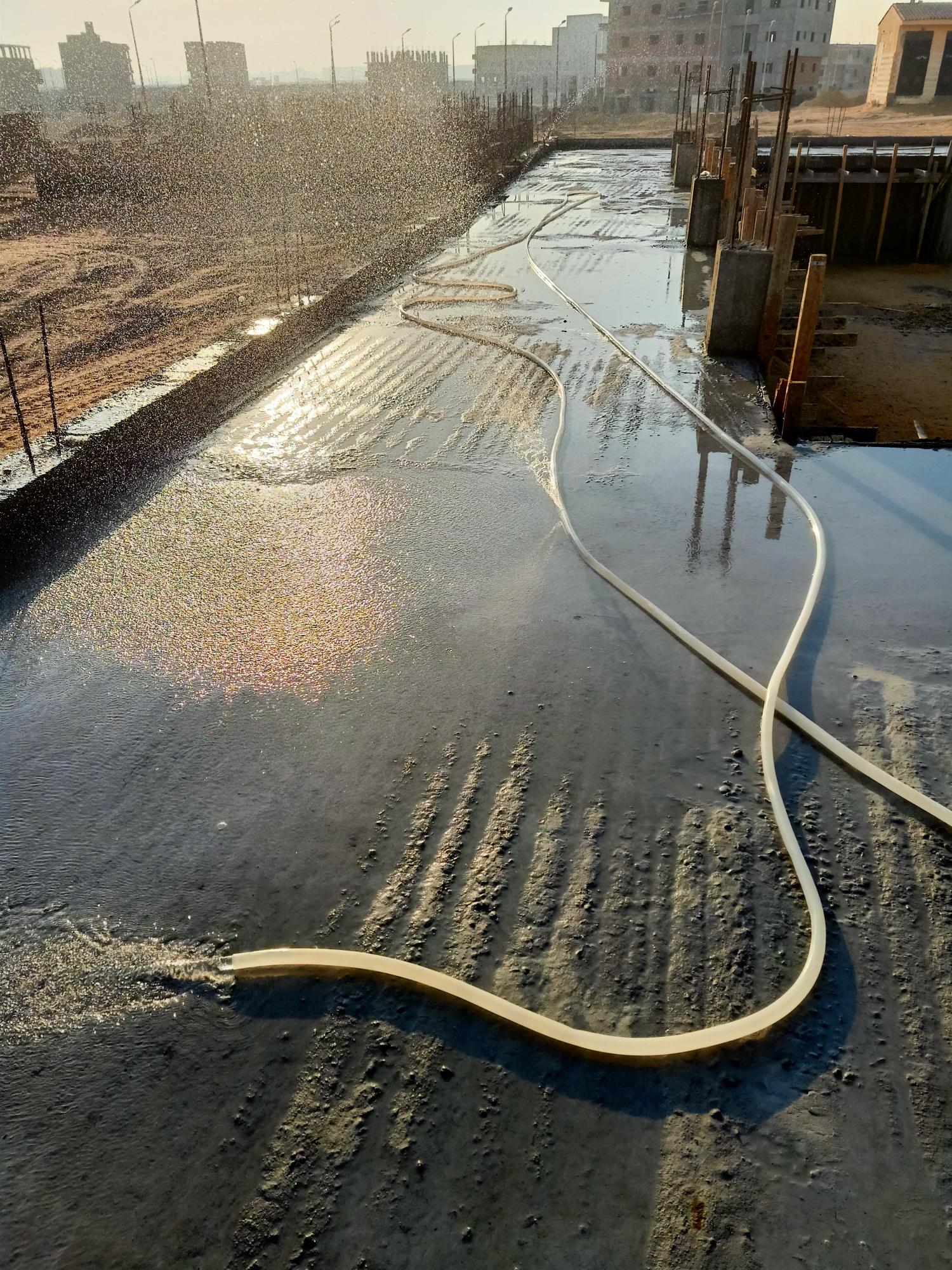

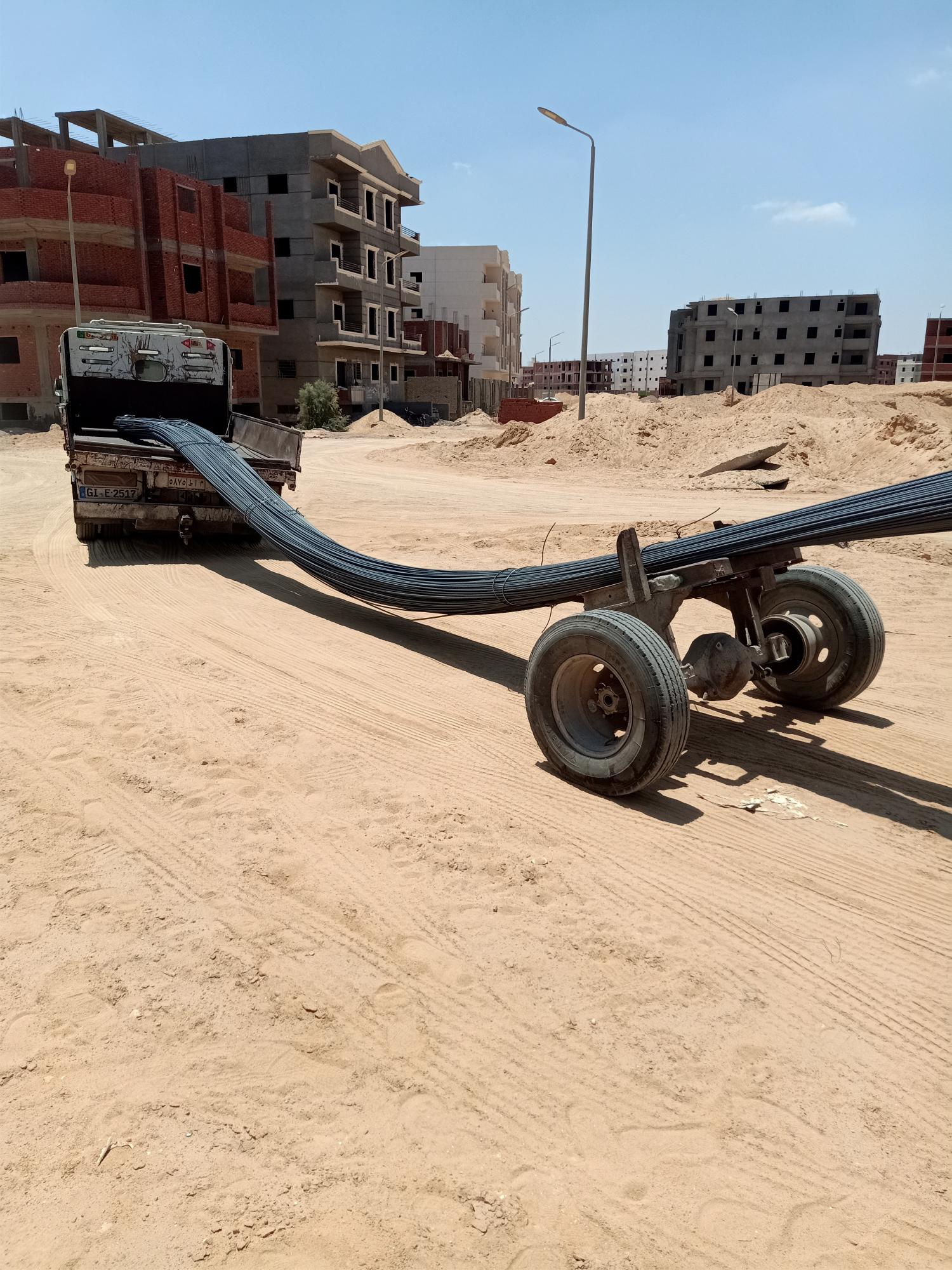

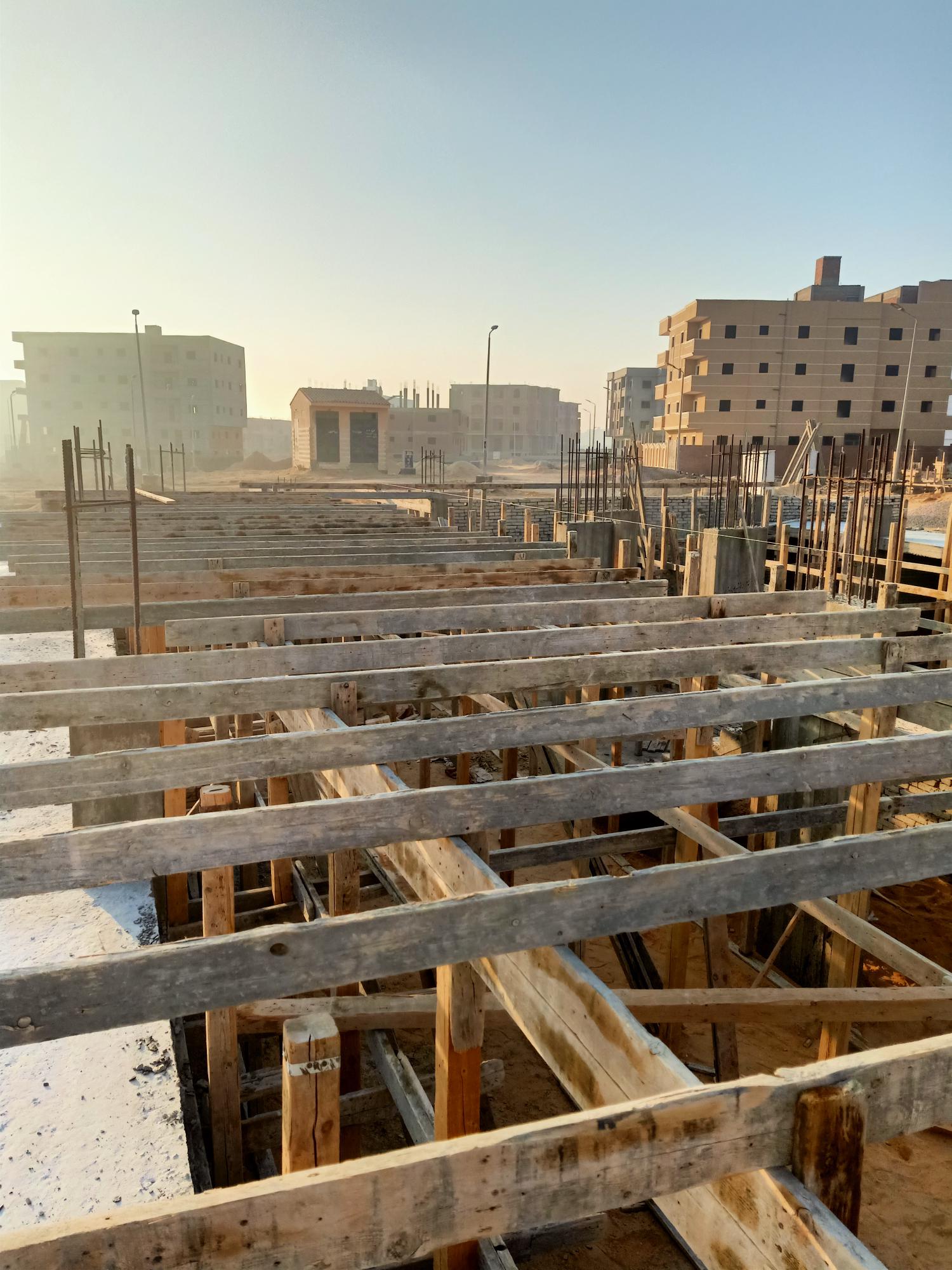

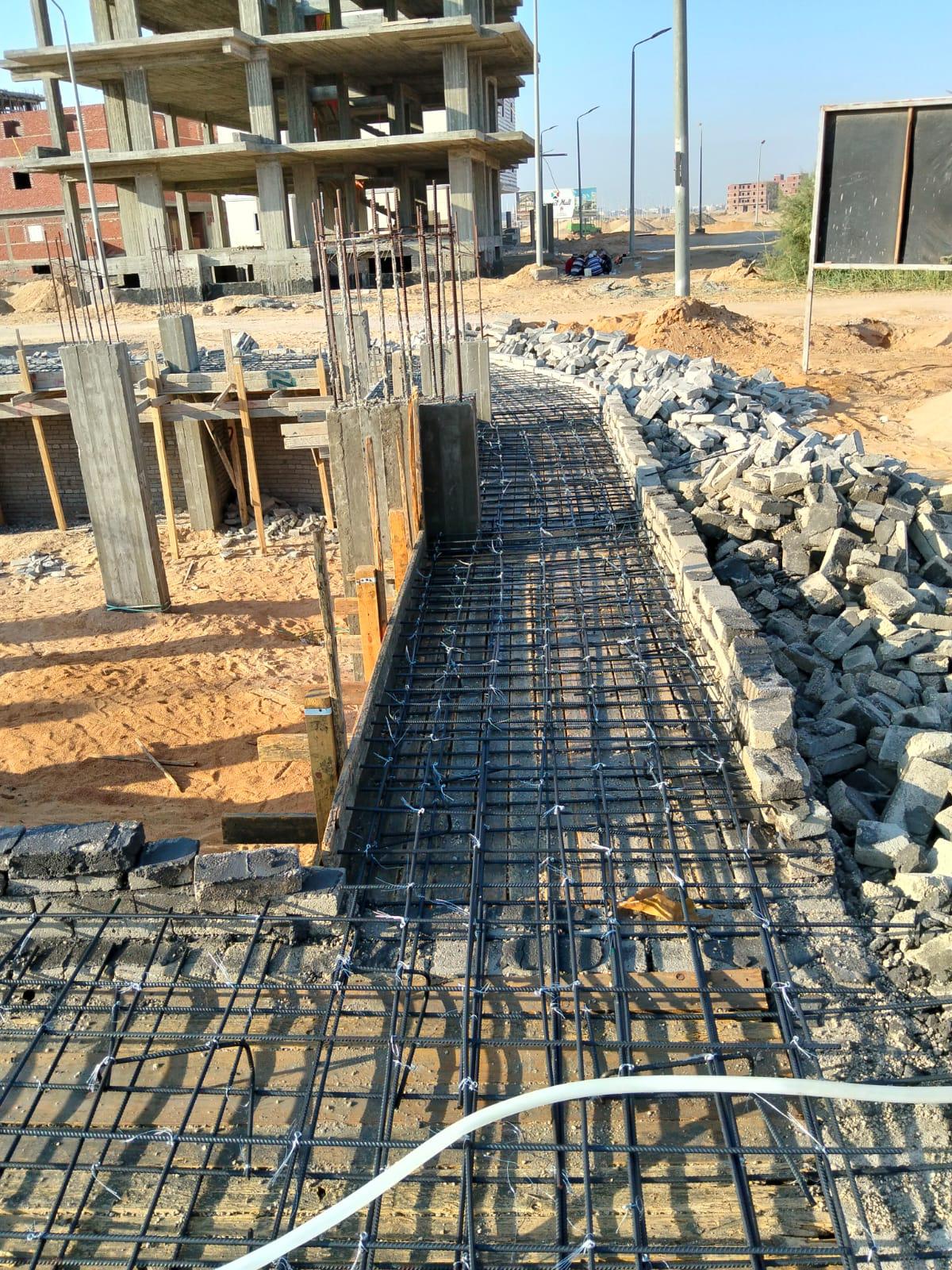

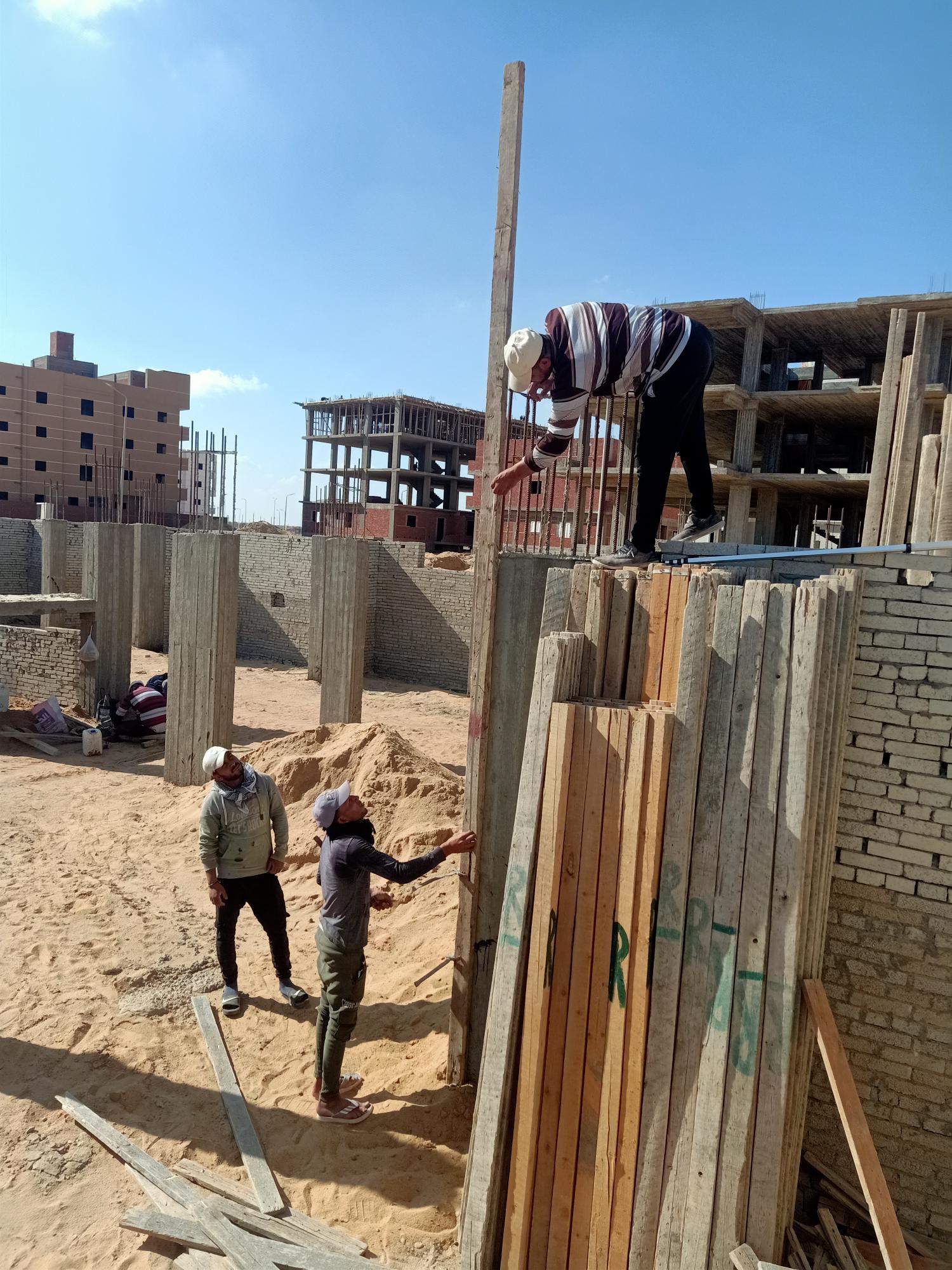

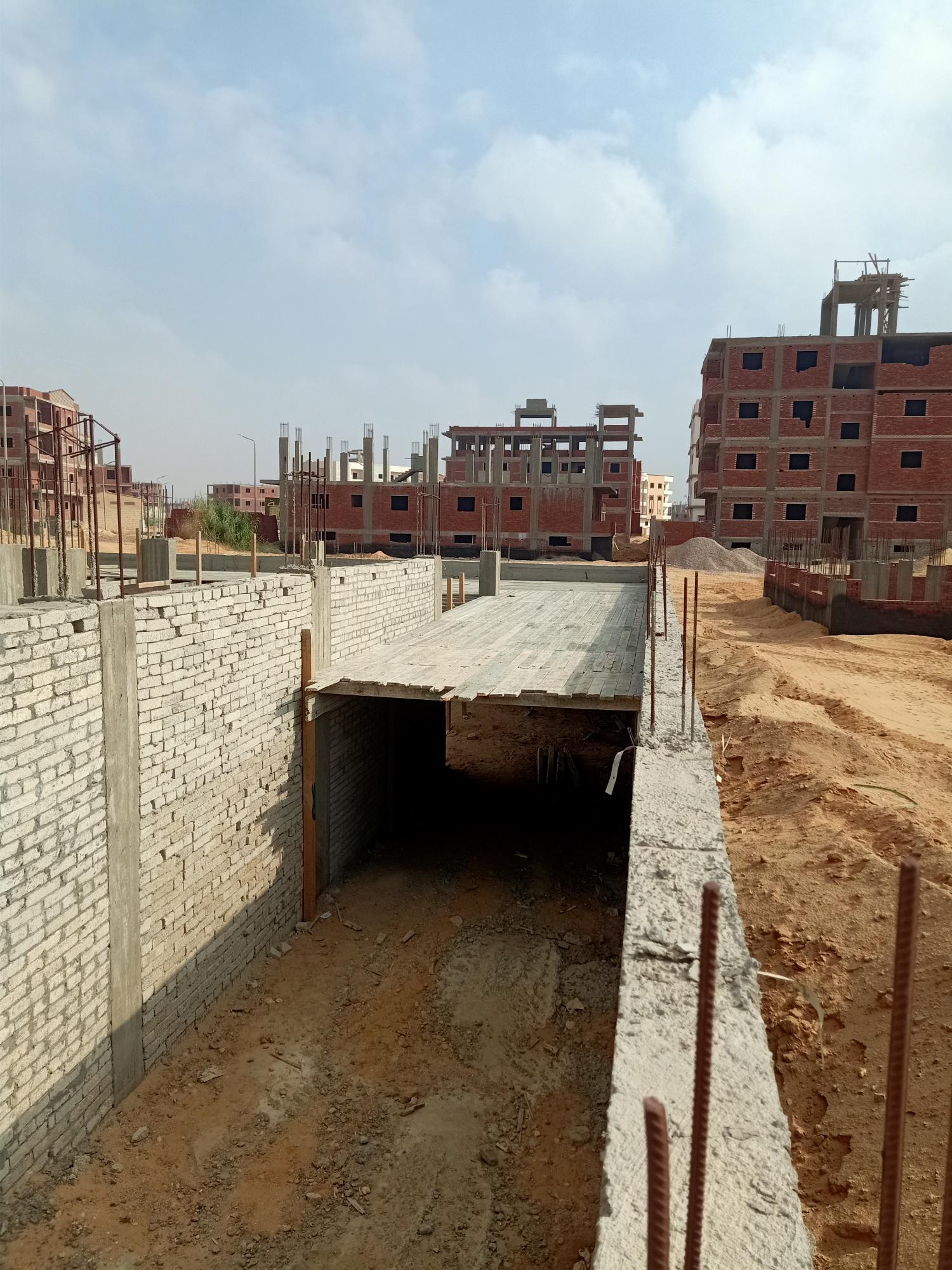

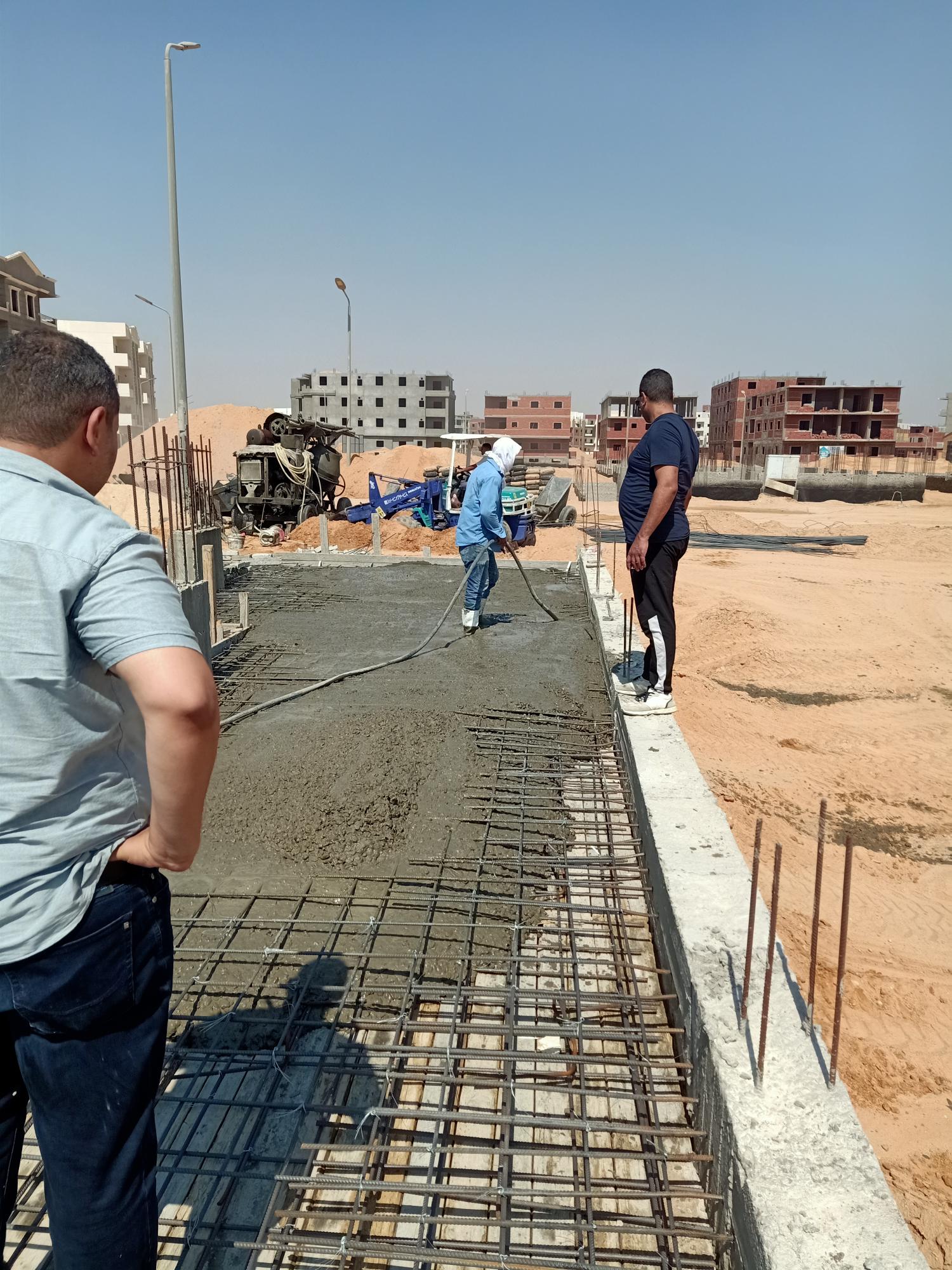

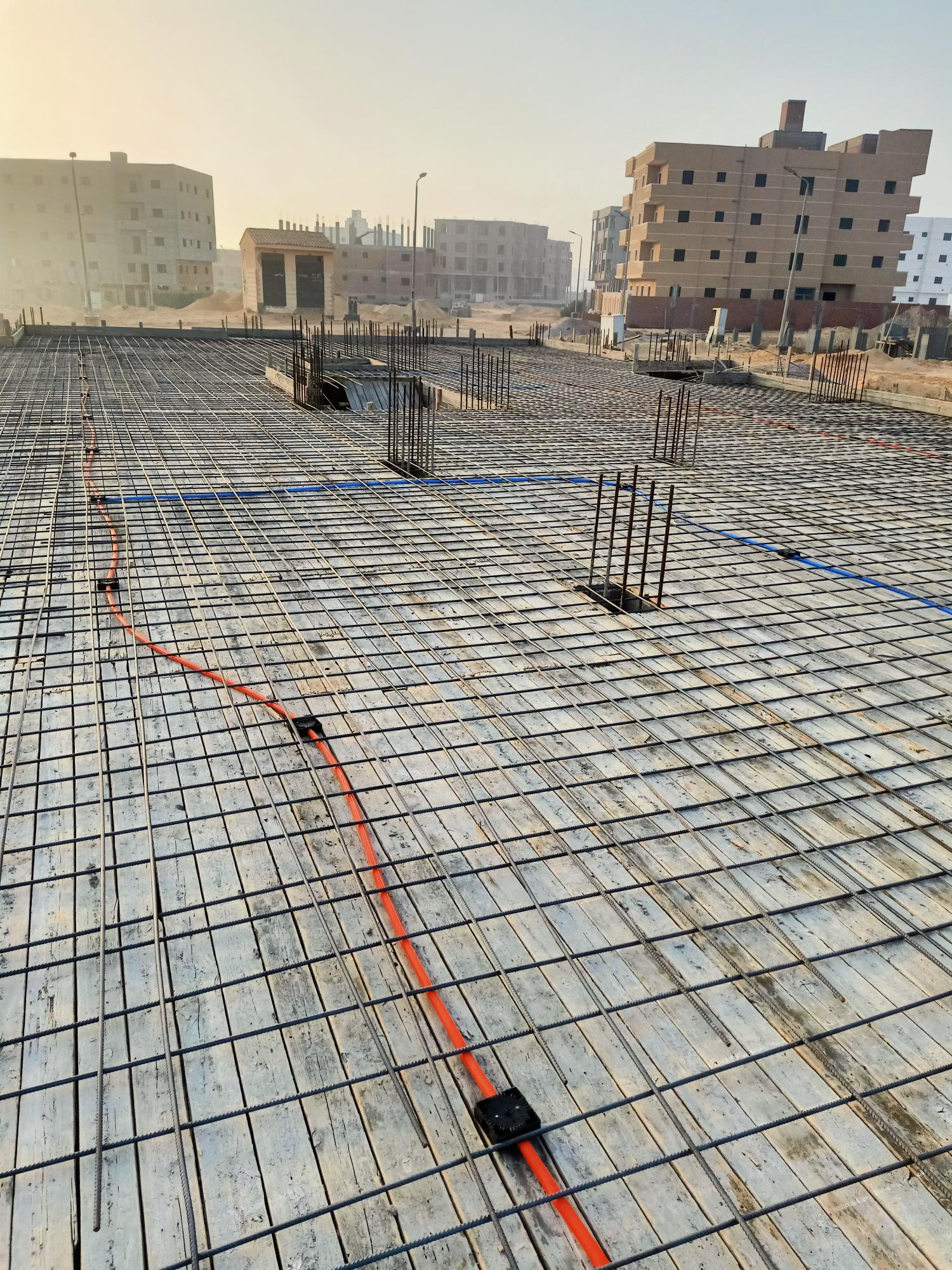

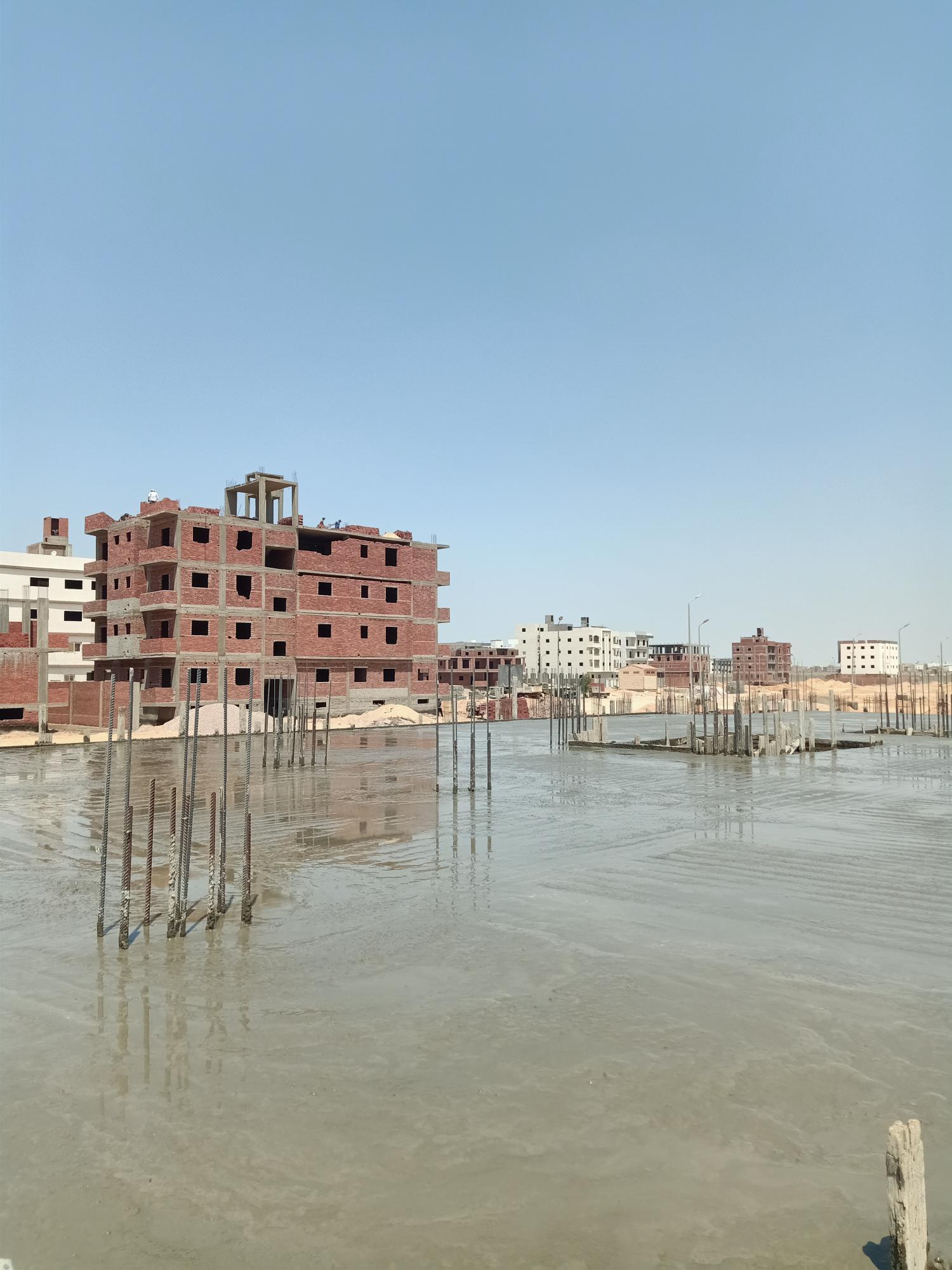

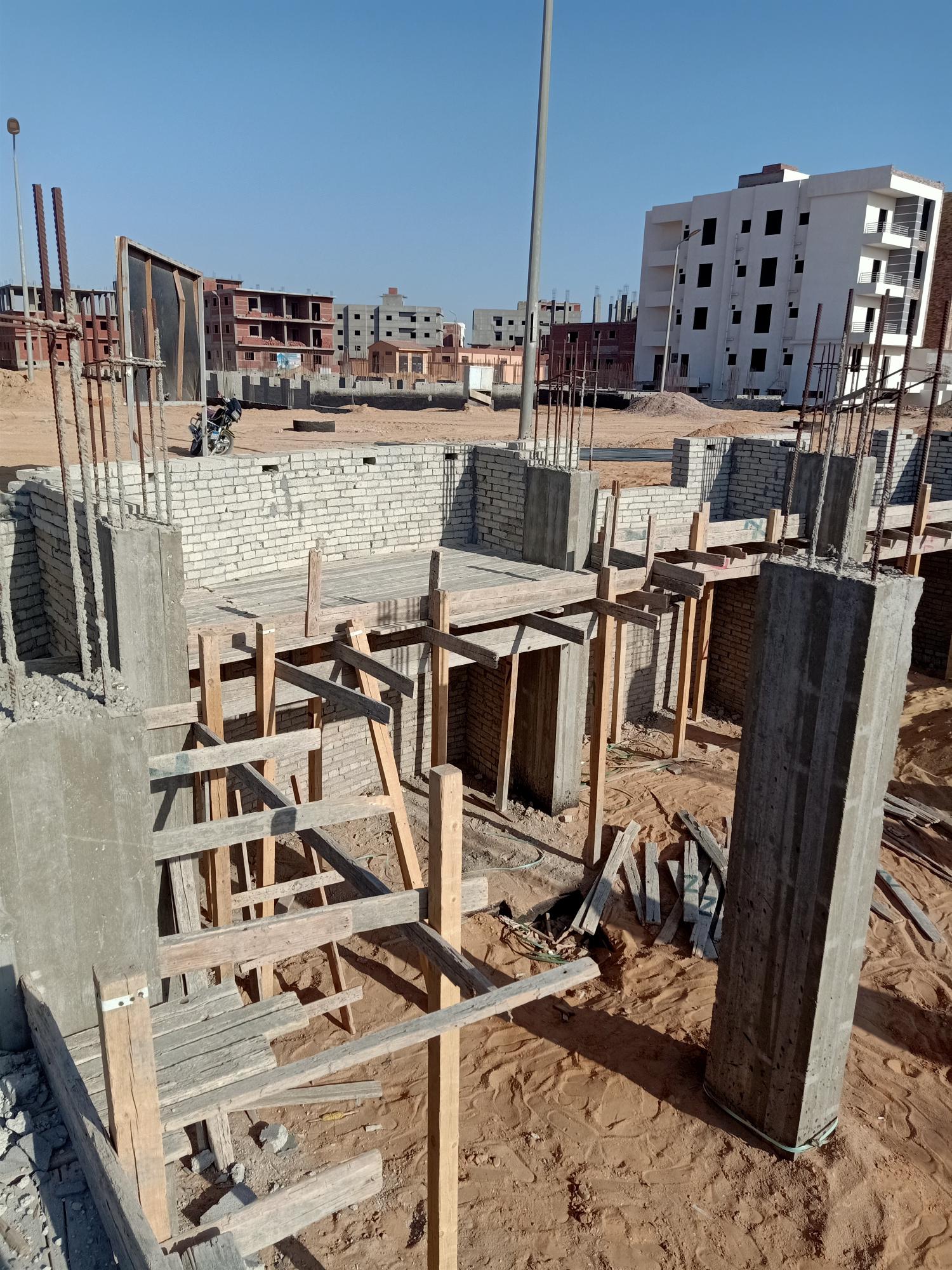

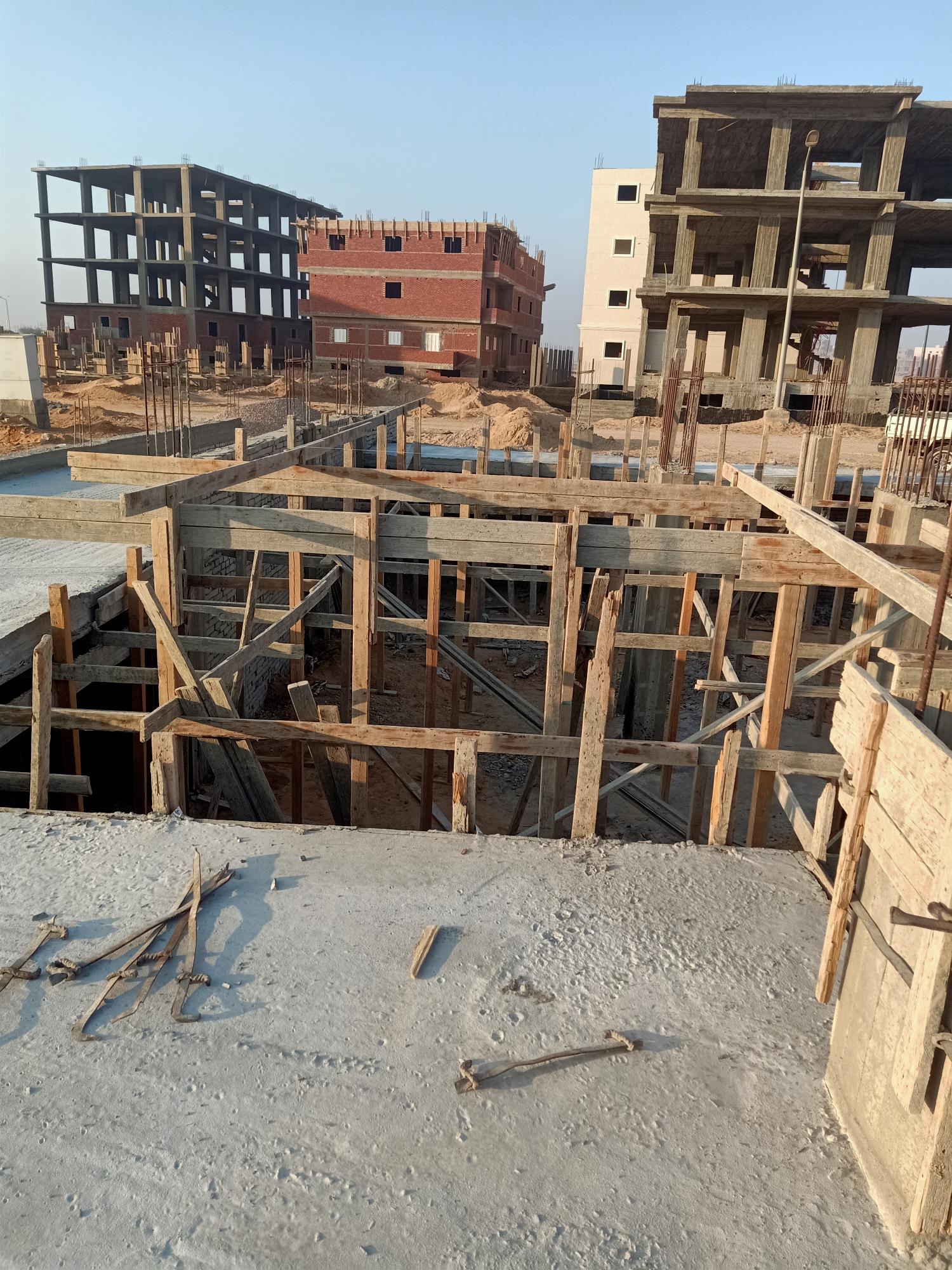

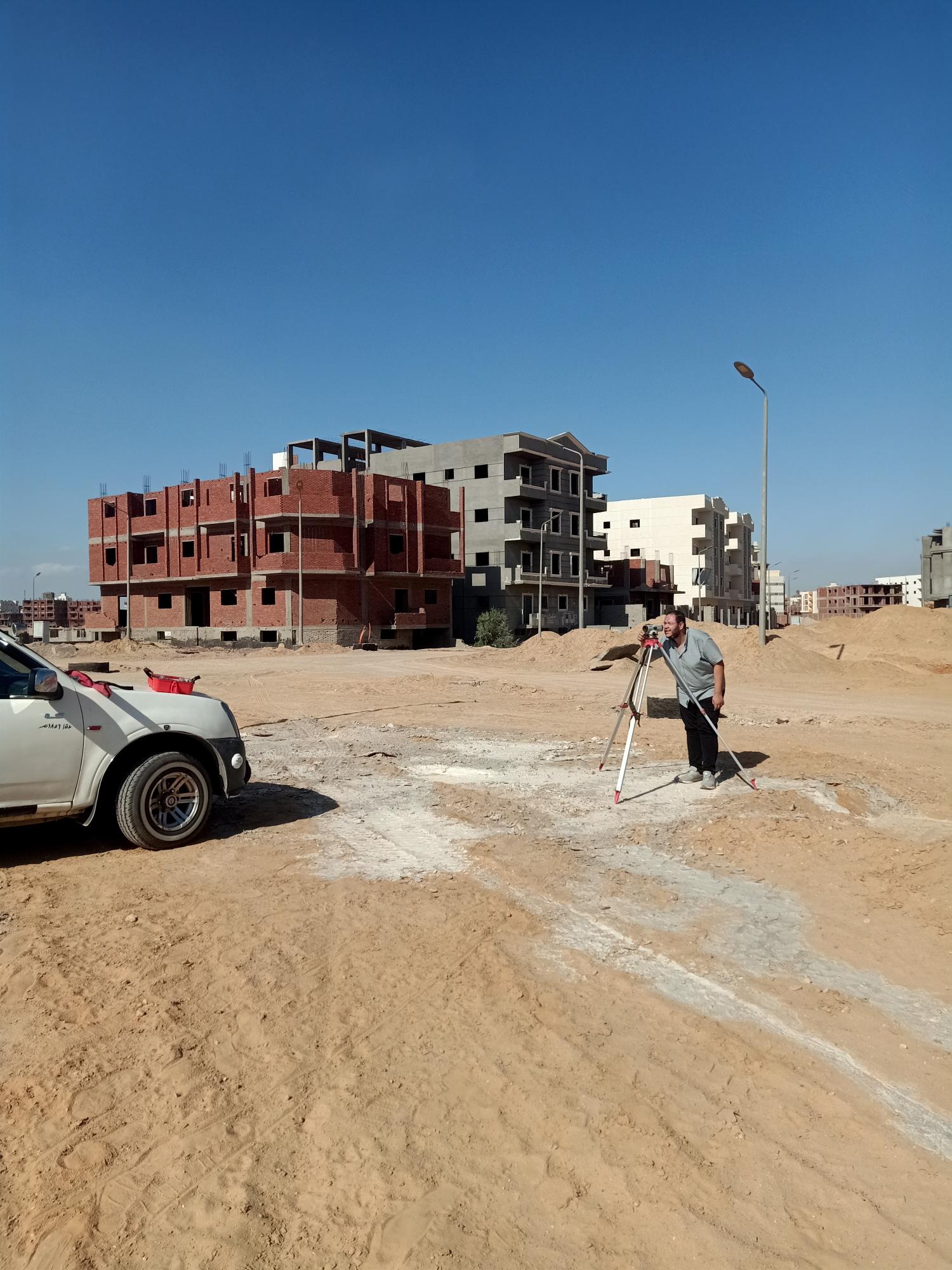

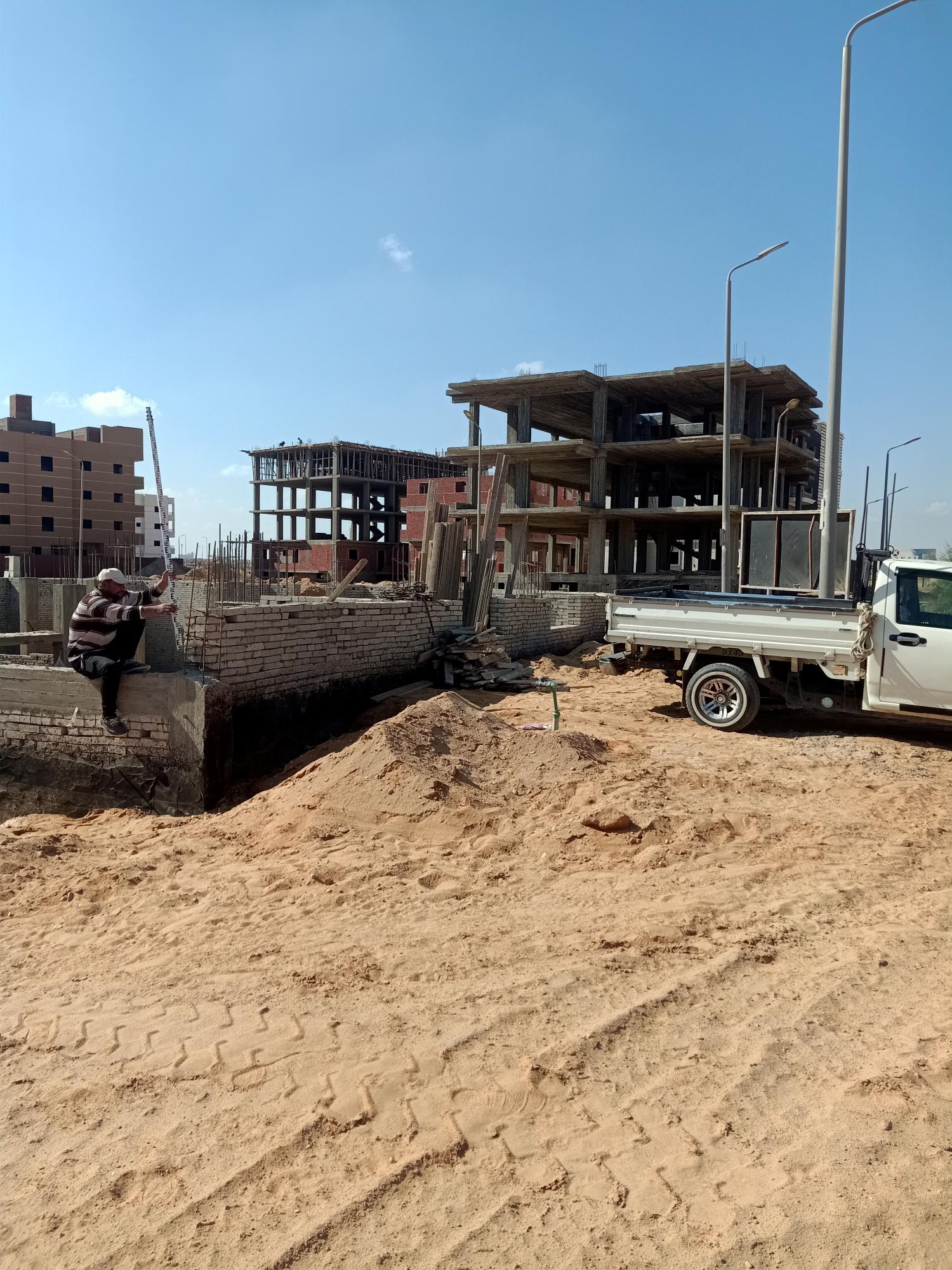

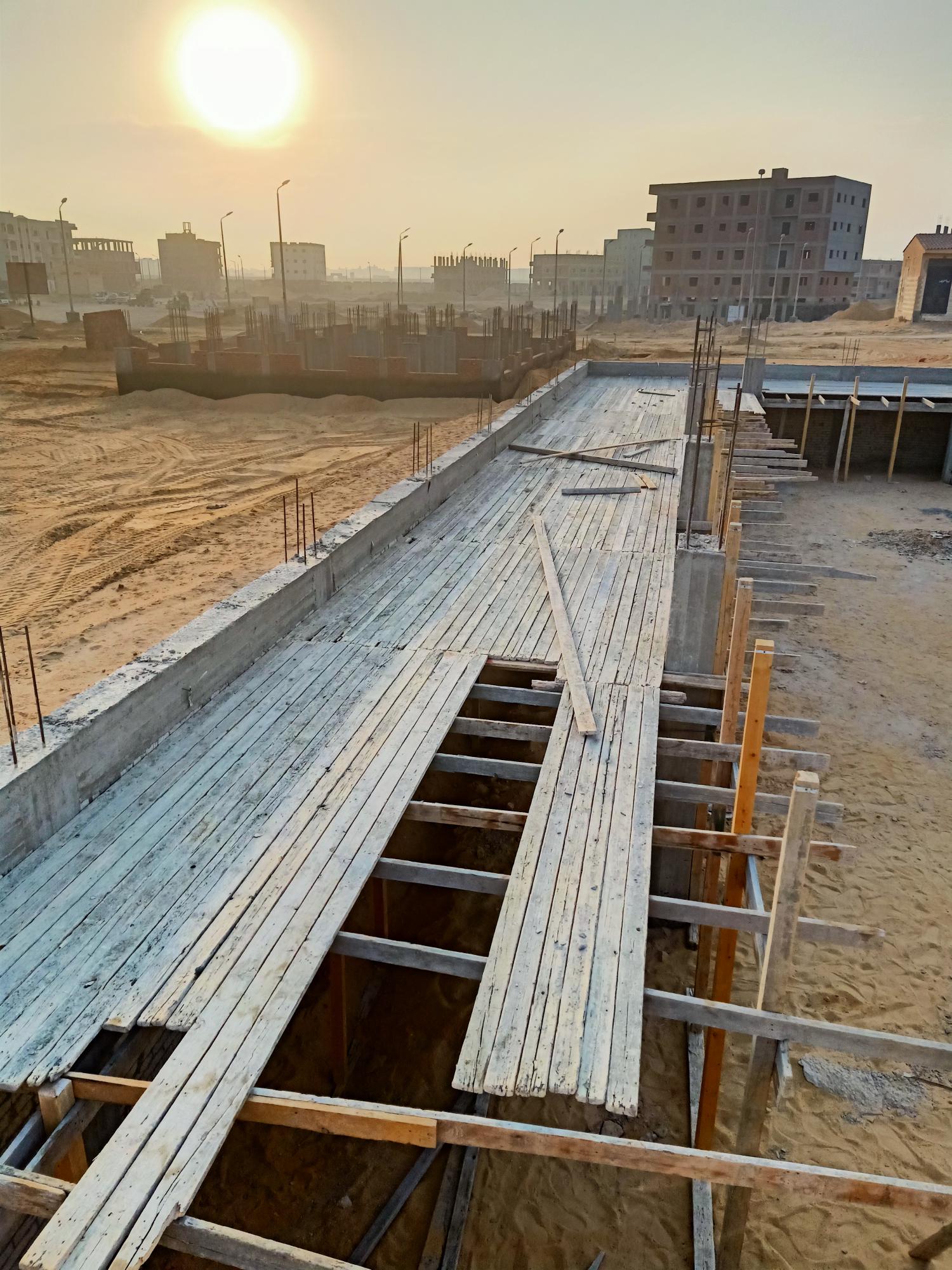

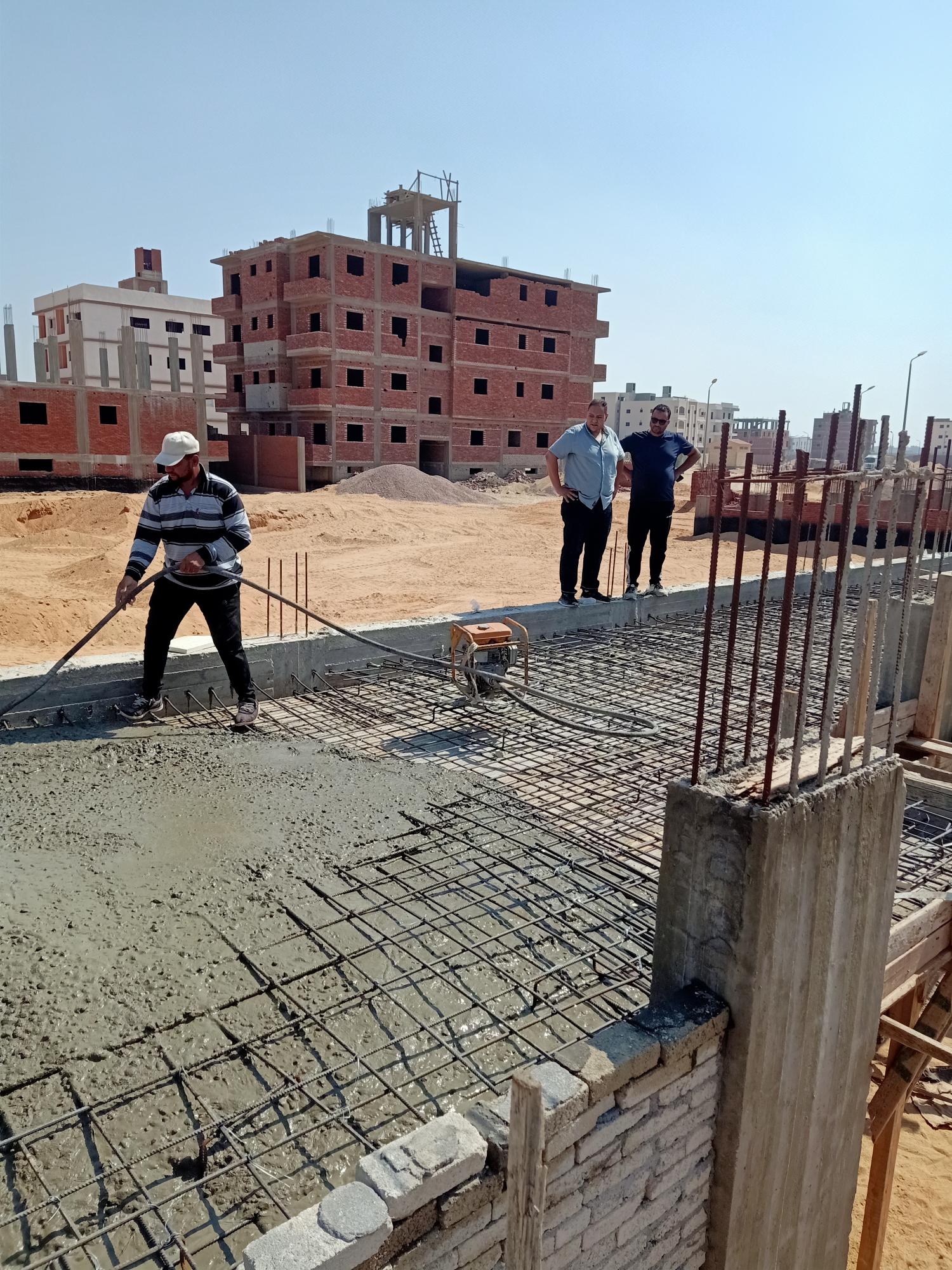

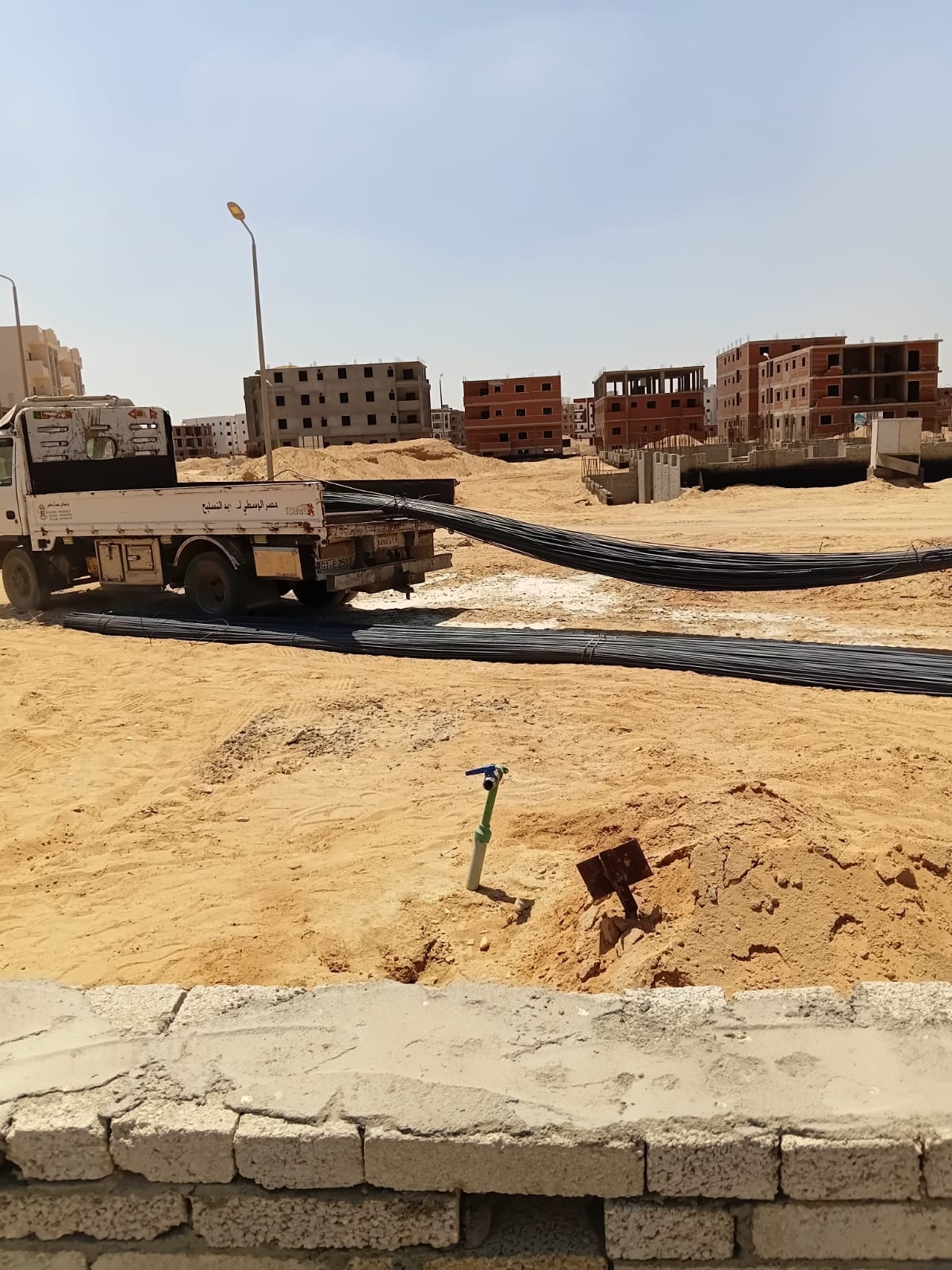

Basement slab
May 31, 2025
Ground floor columns
June 21, 2025
Ground floor slab
June 28, 2025
First floor columns
July 22, 2025
First floor slab
July 29, 2025
Second floor columns
August 19, 2025
Second floor slab
August 26, 2025
Submitting third-floor extension license
September 10, 2025

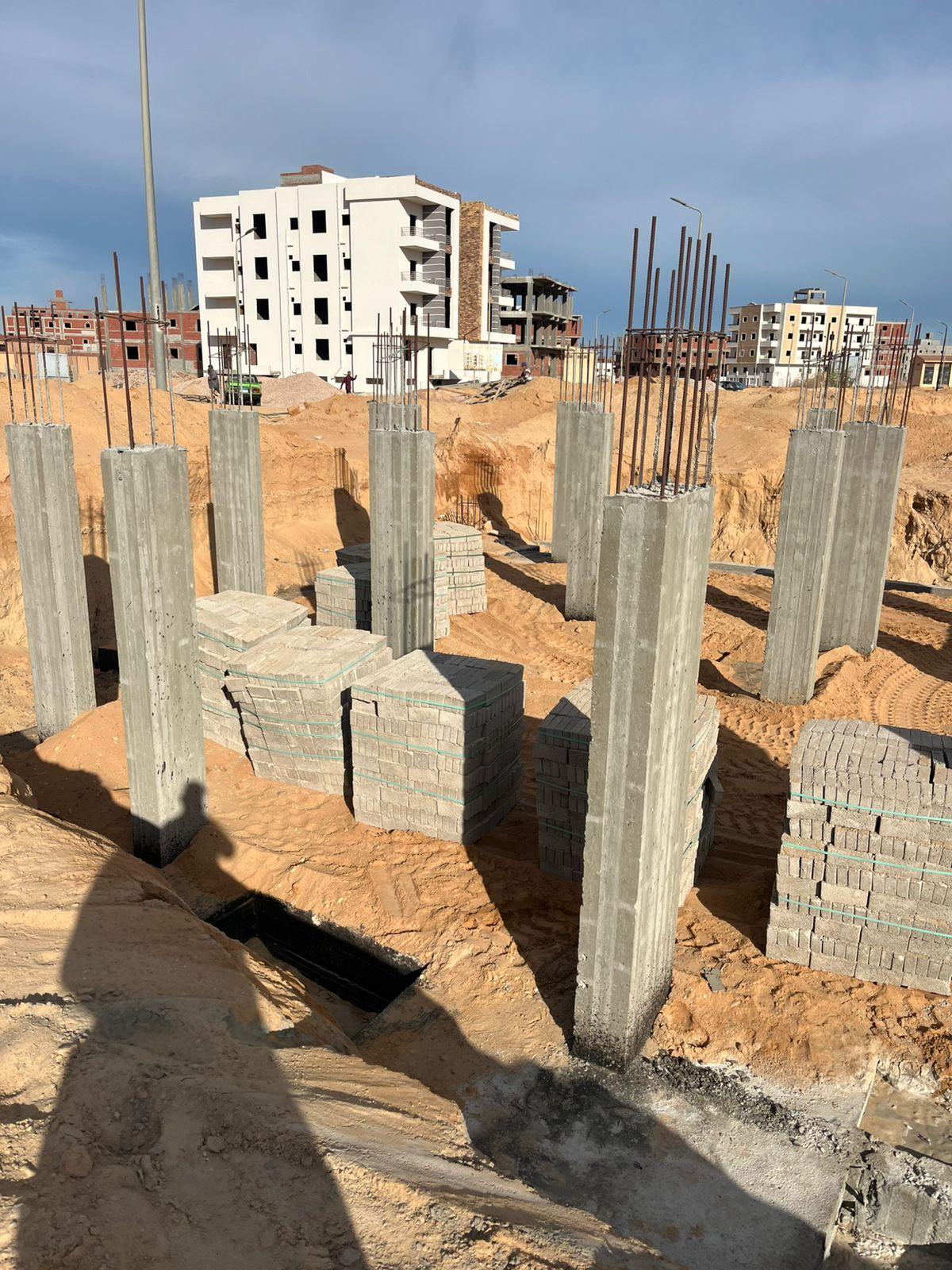

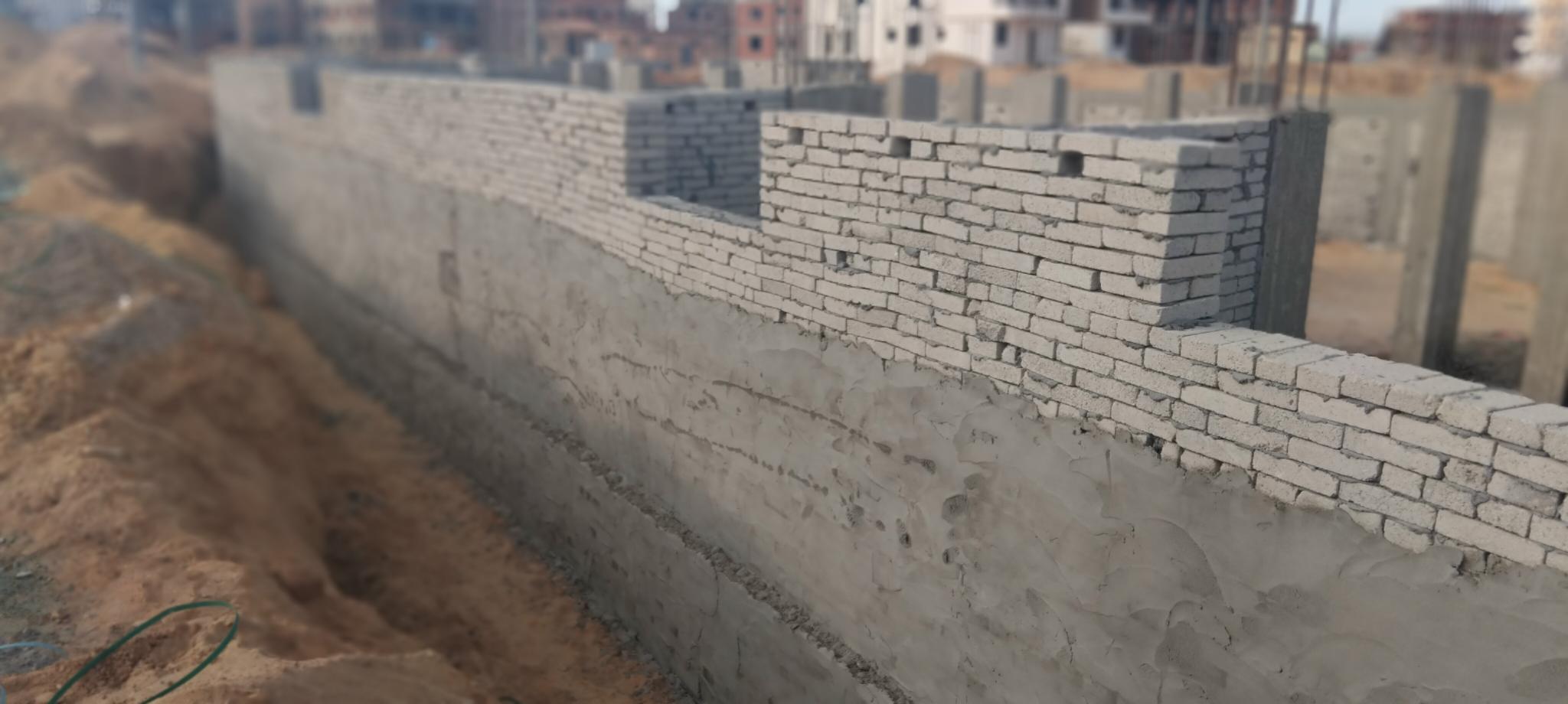

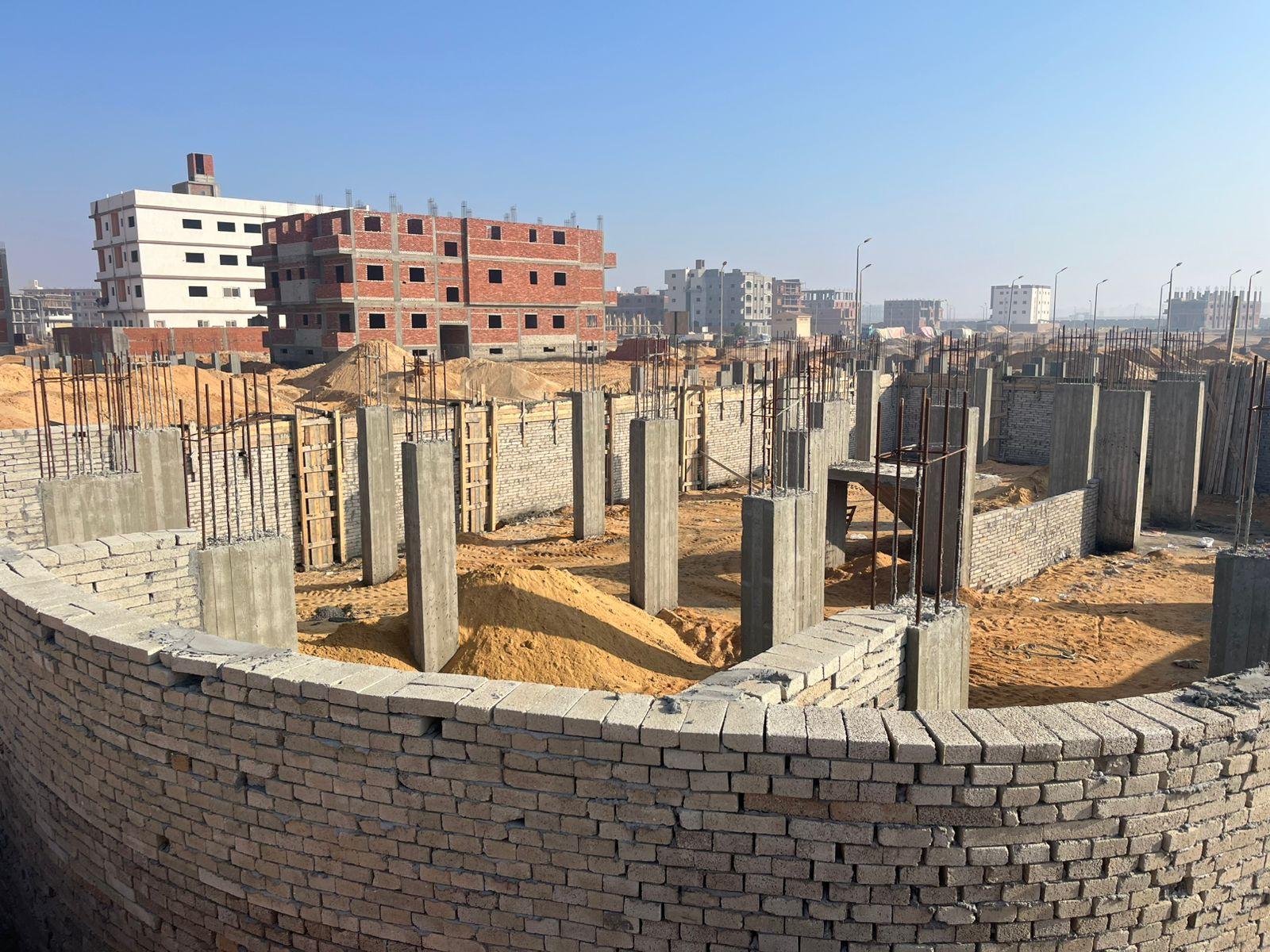

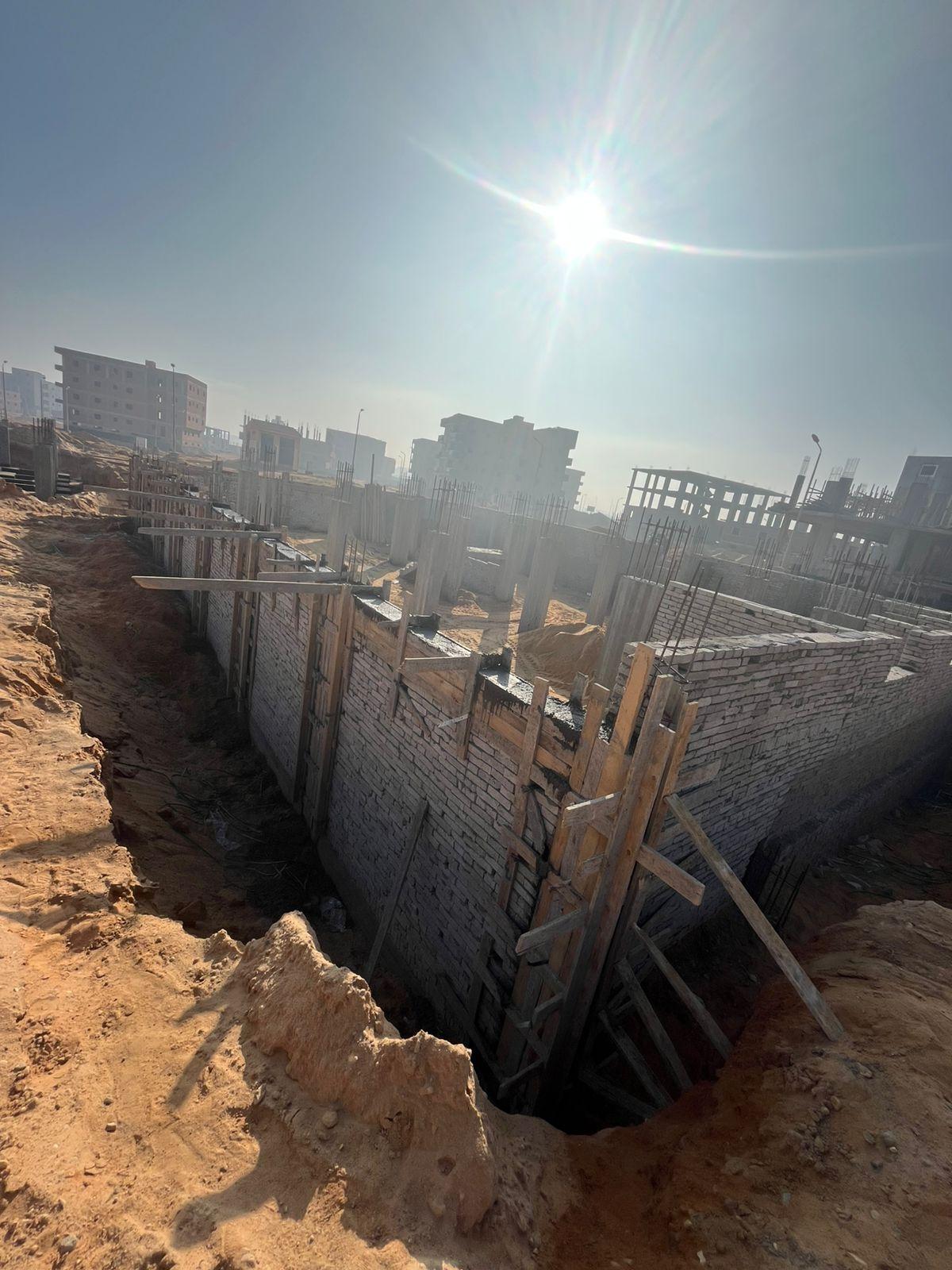

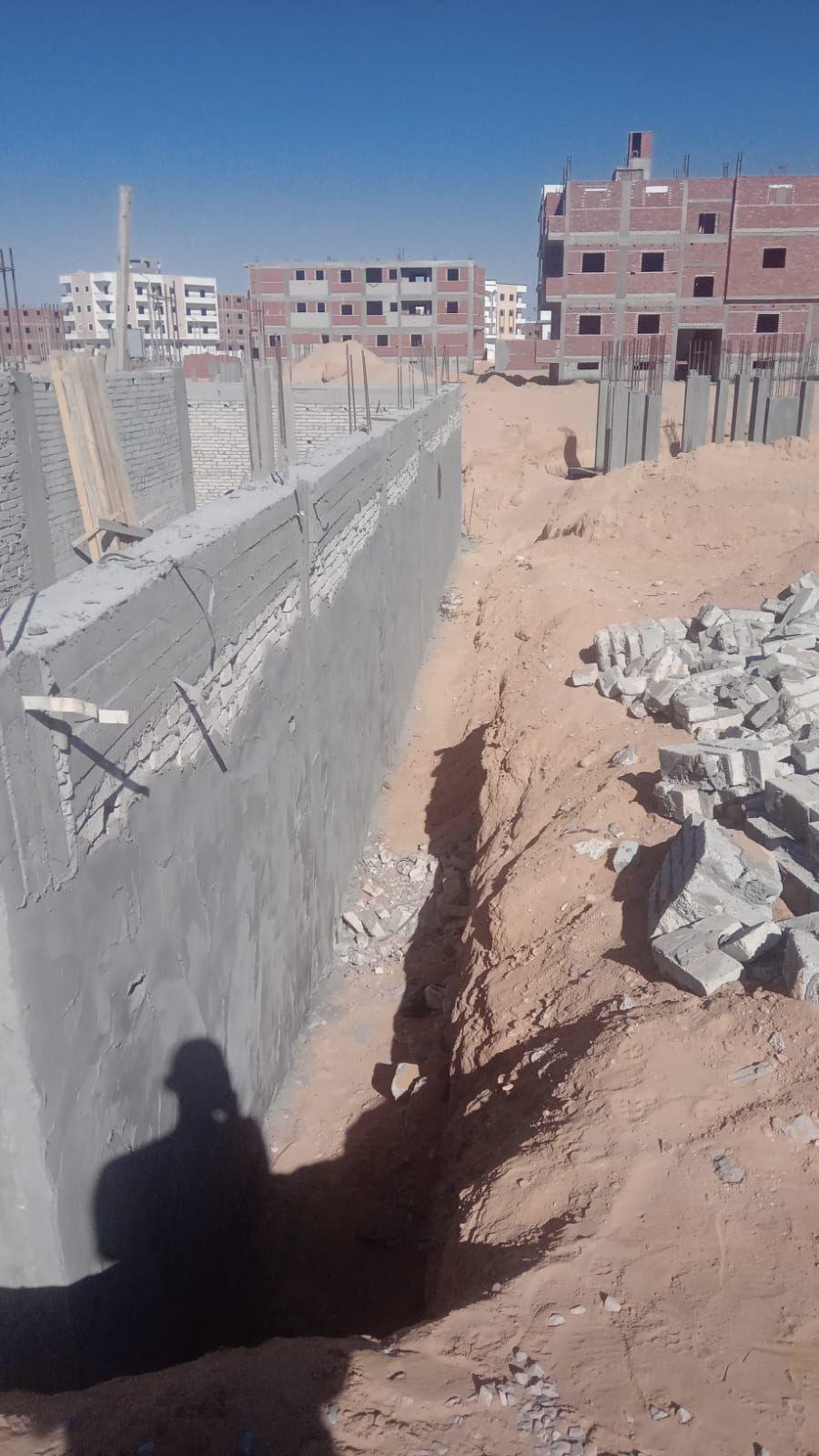

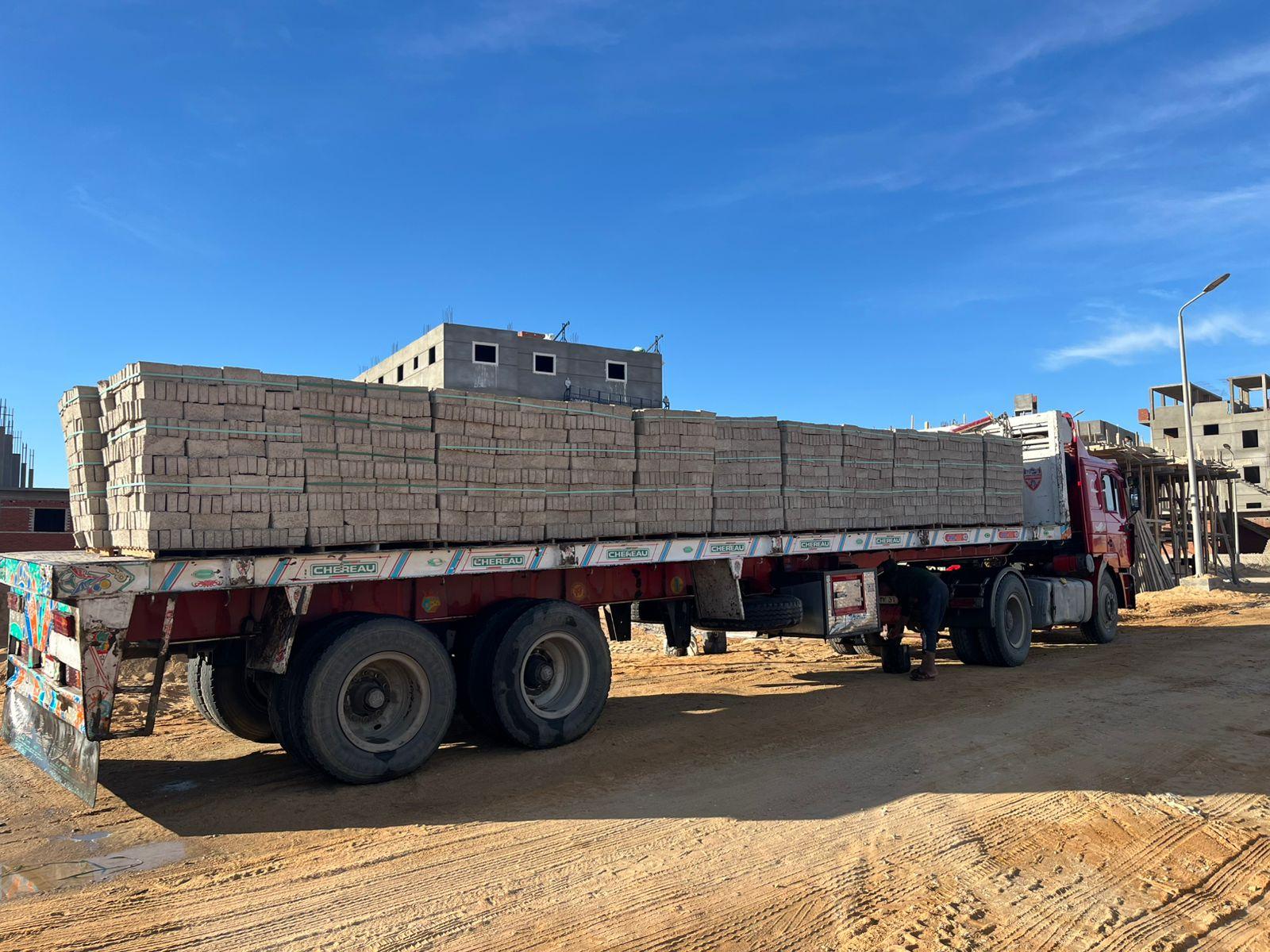

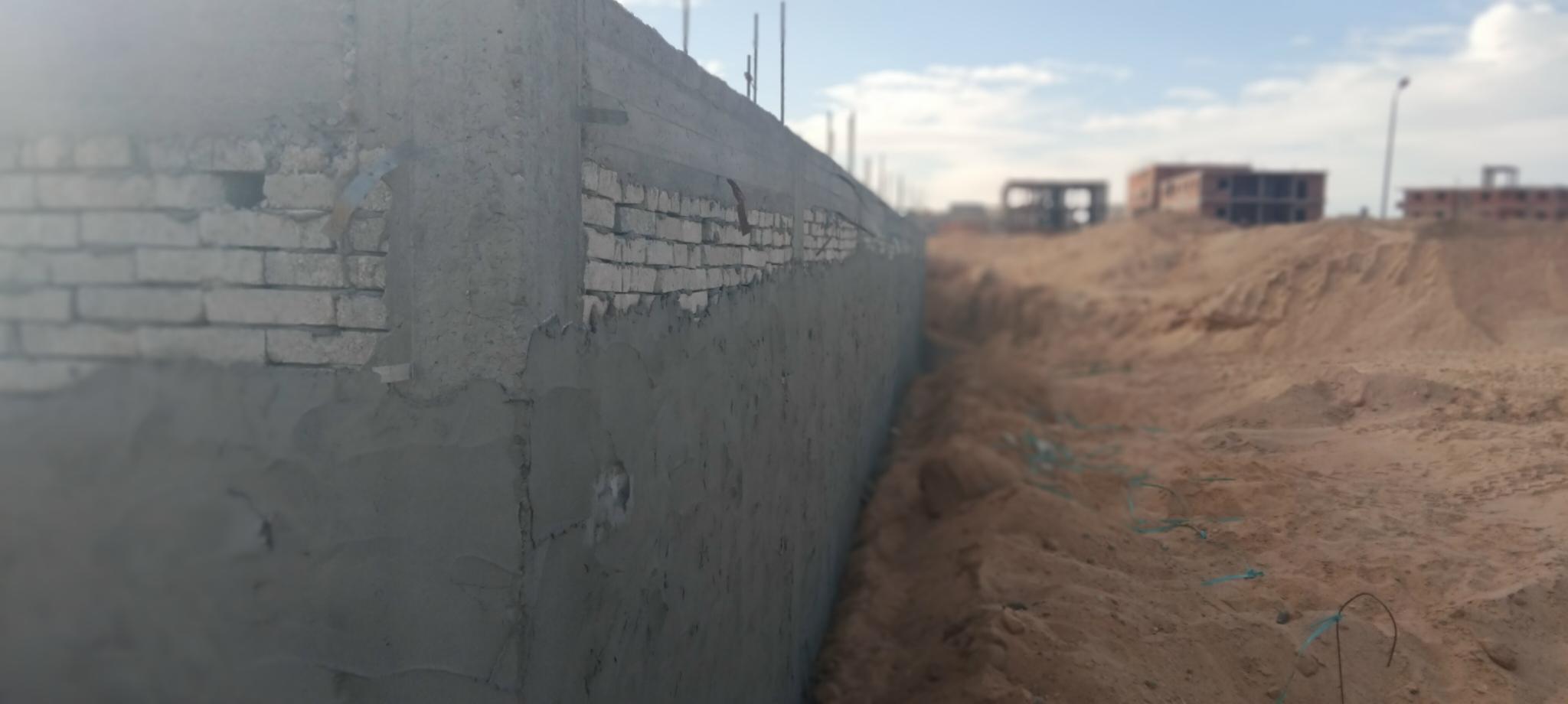

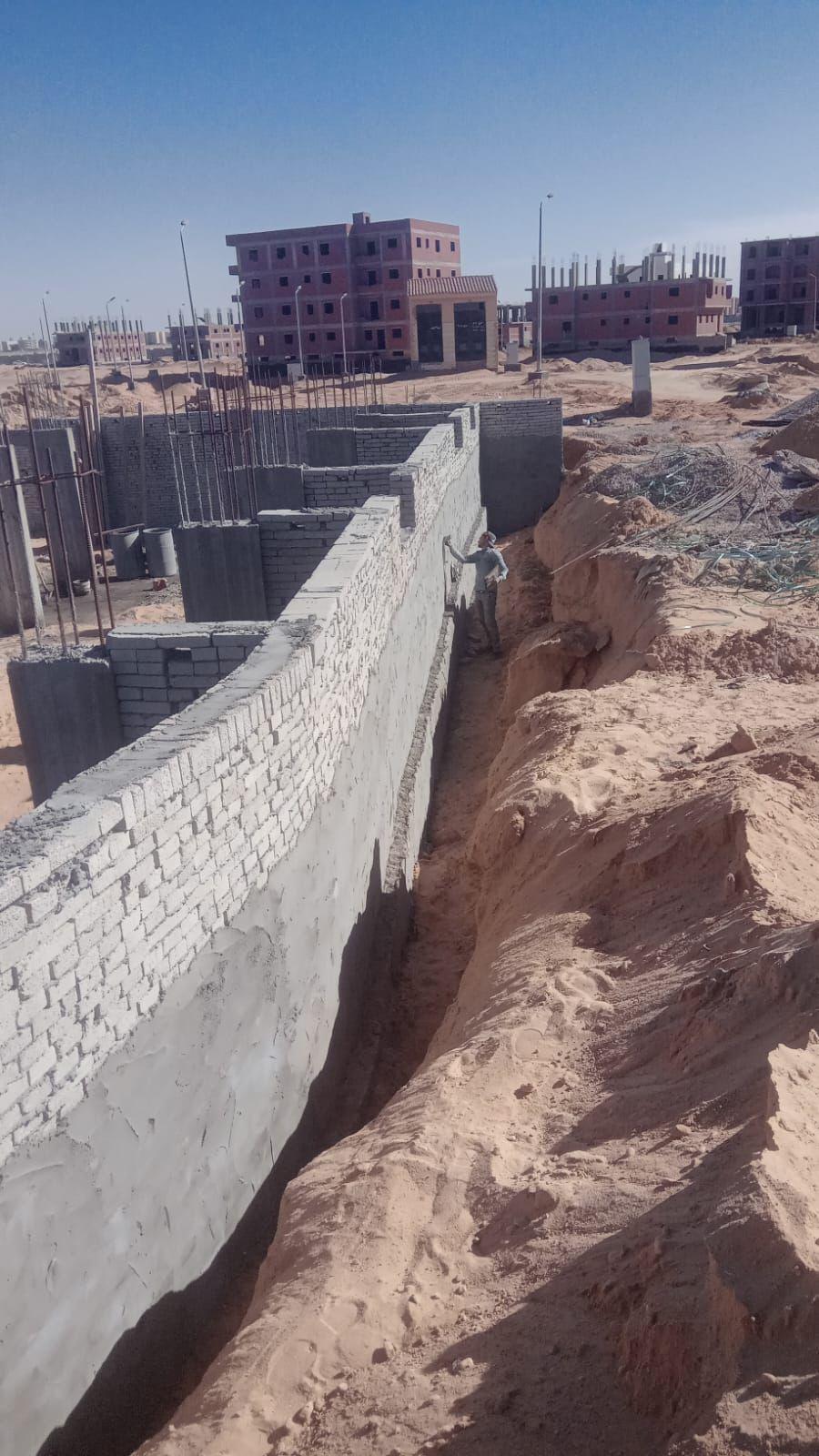

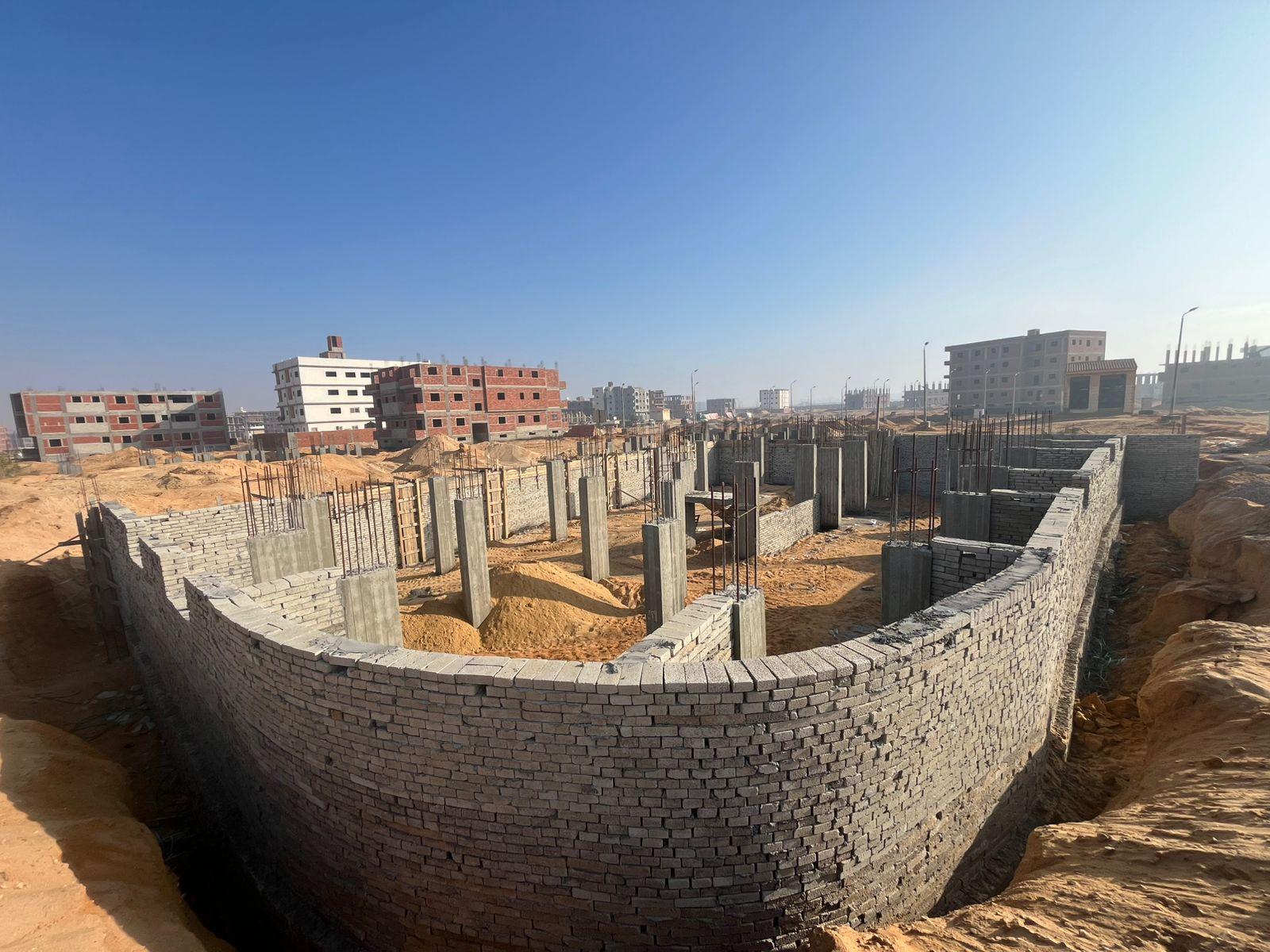

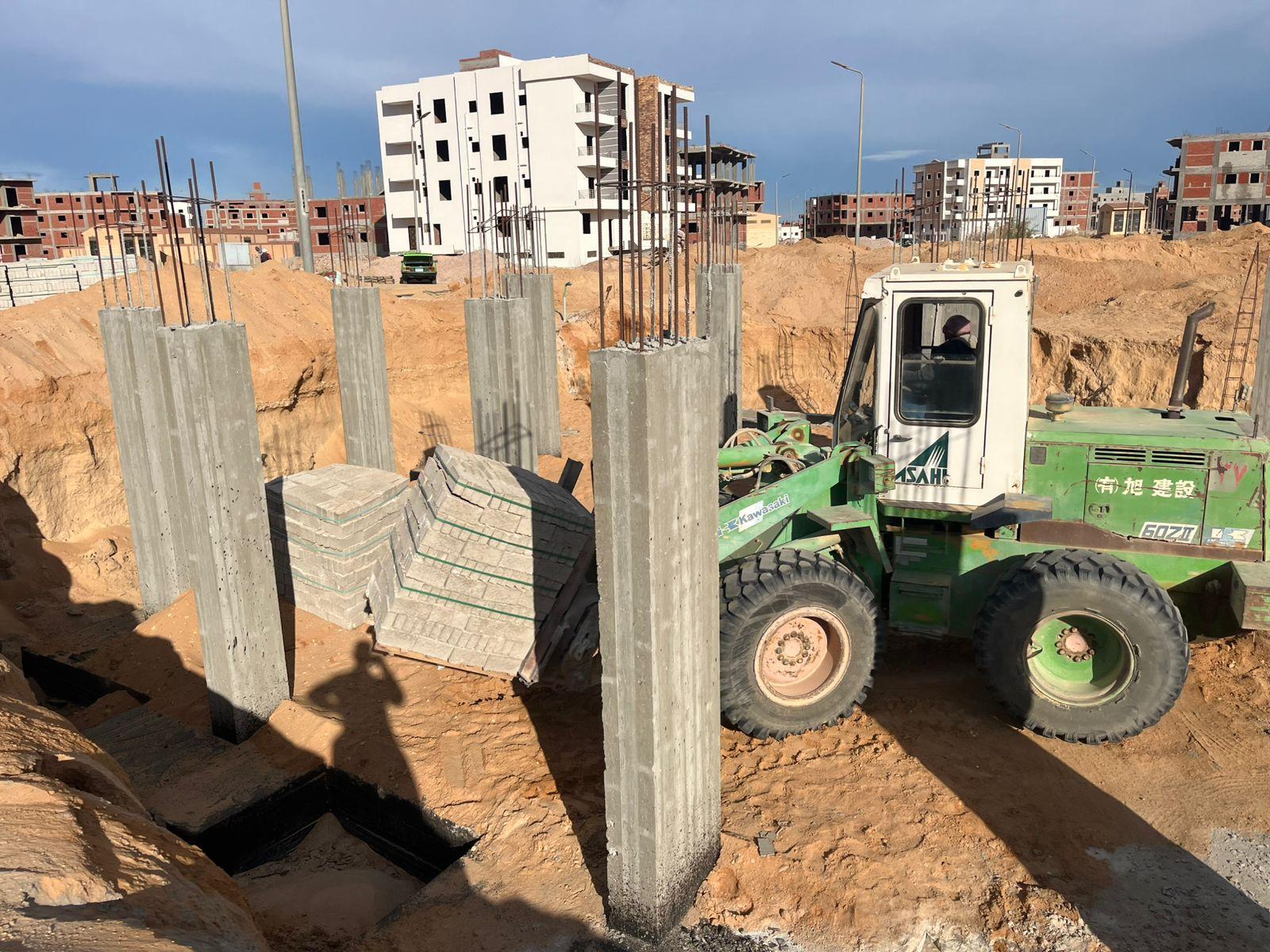

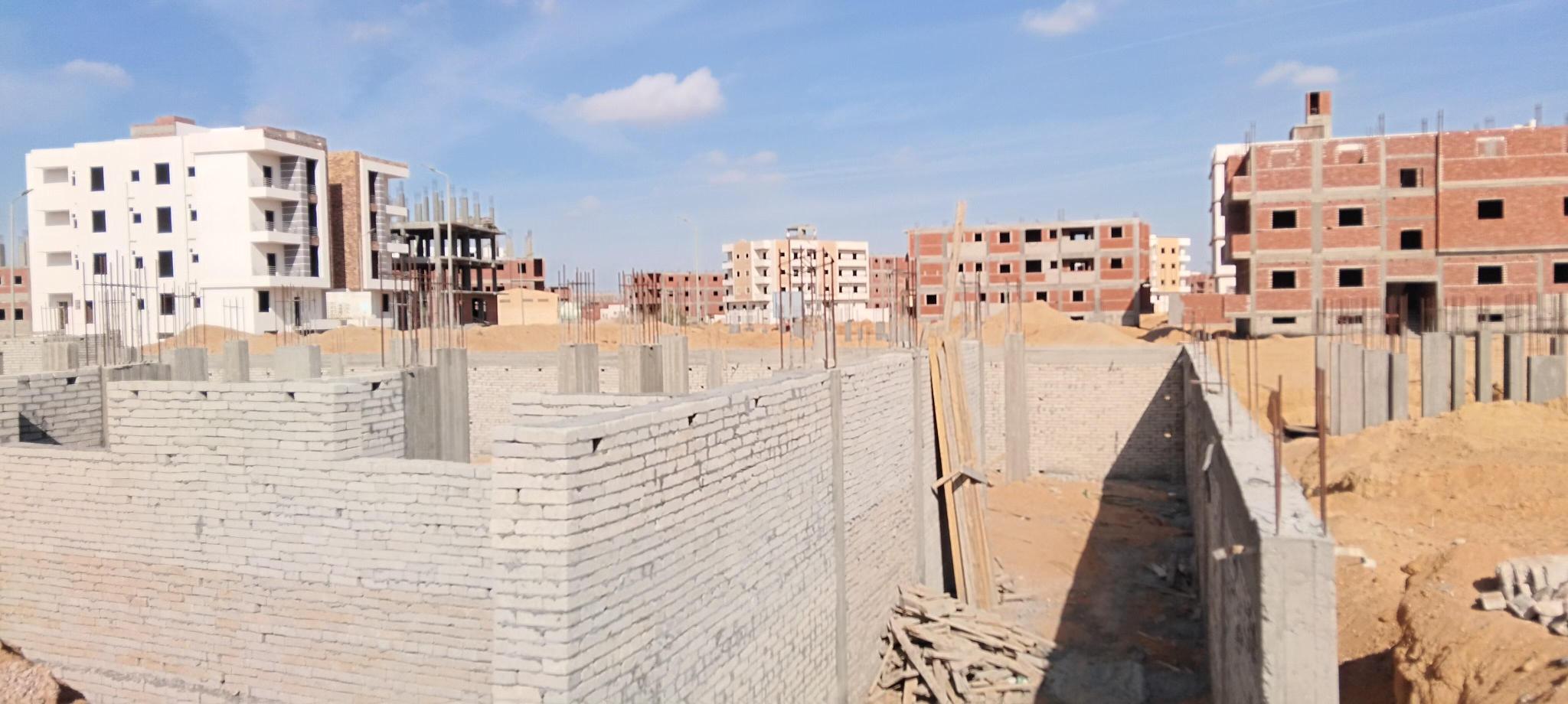

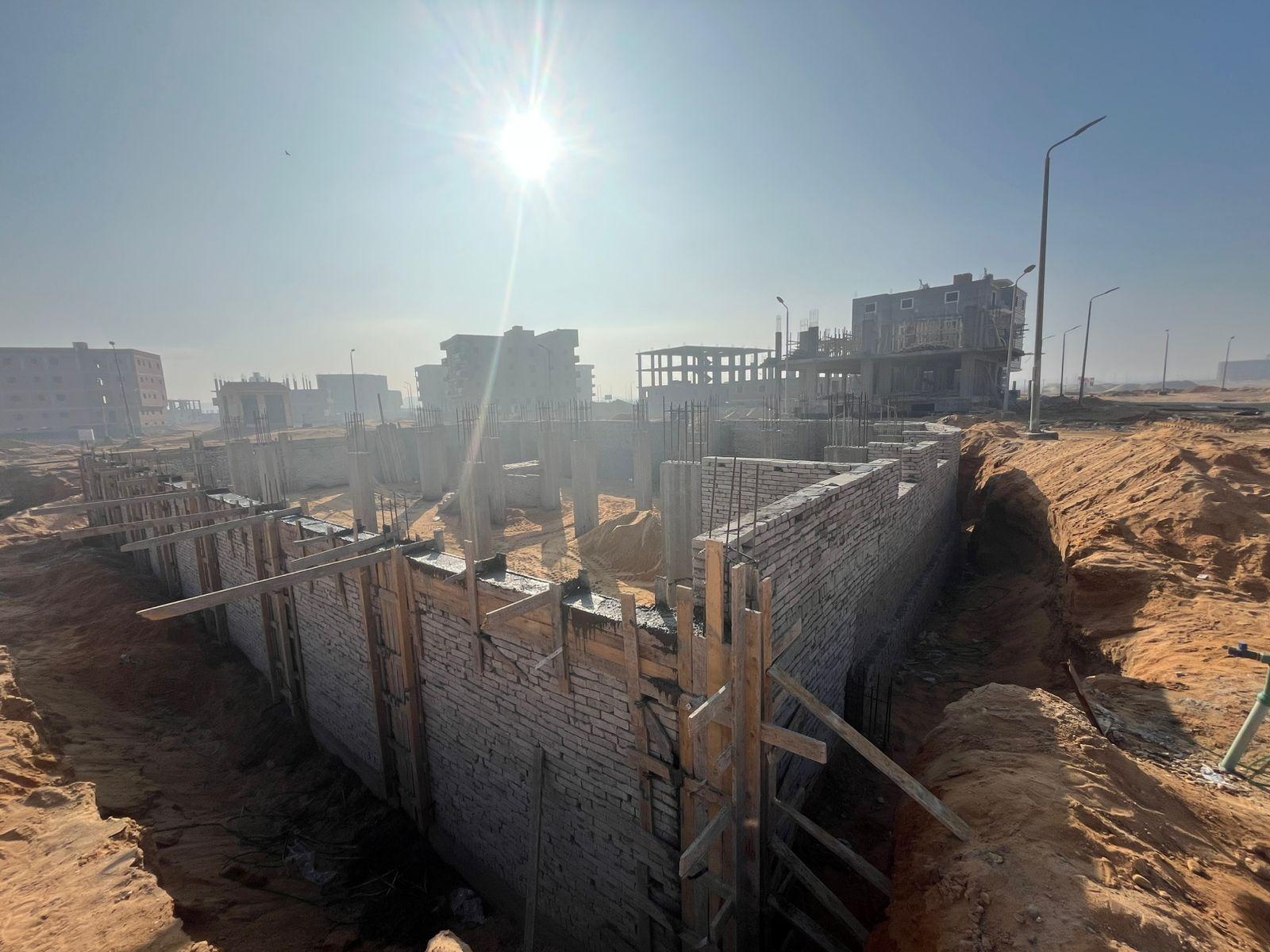

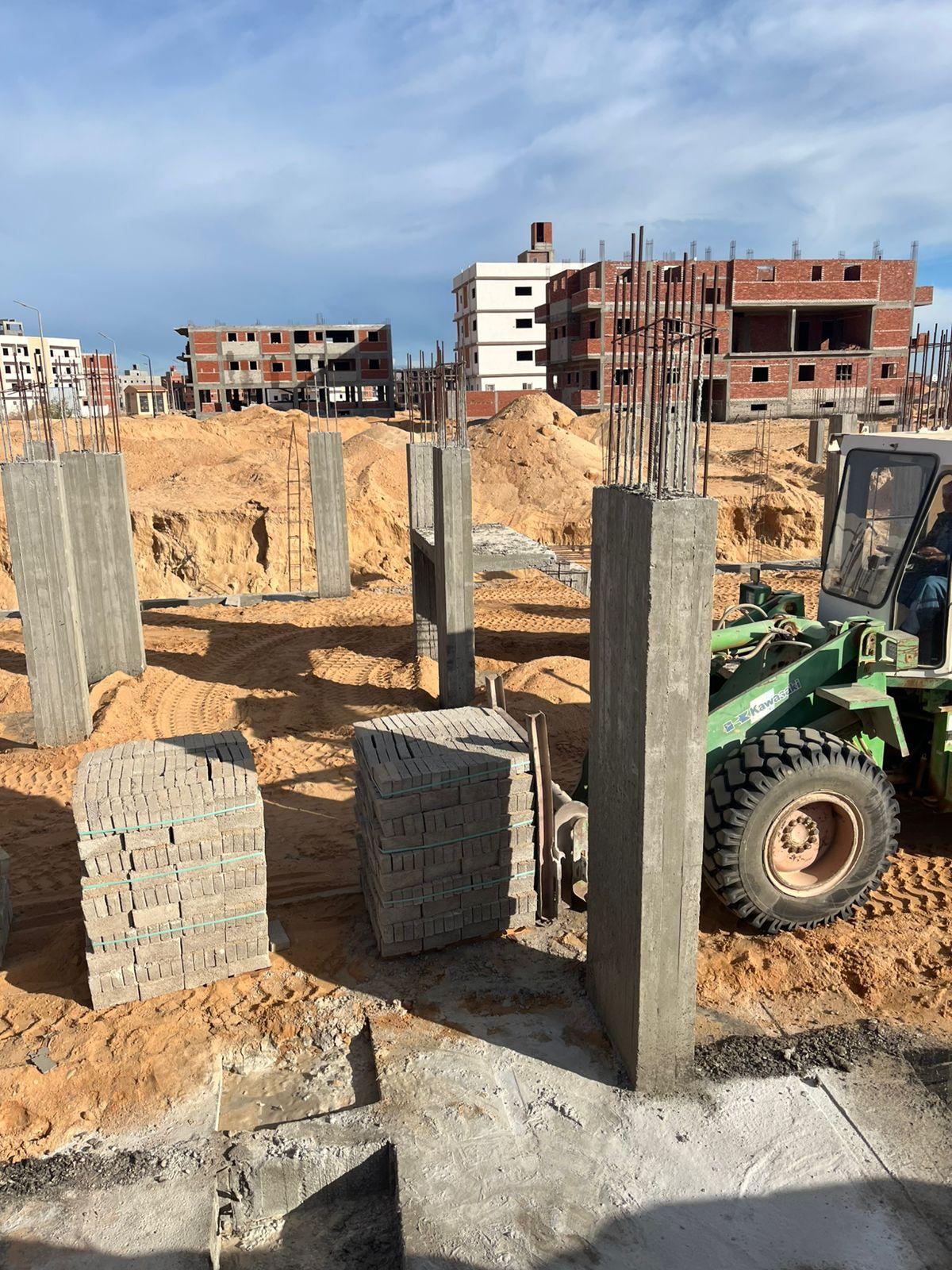

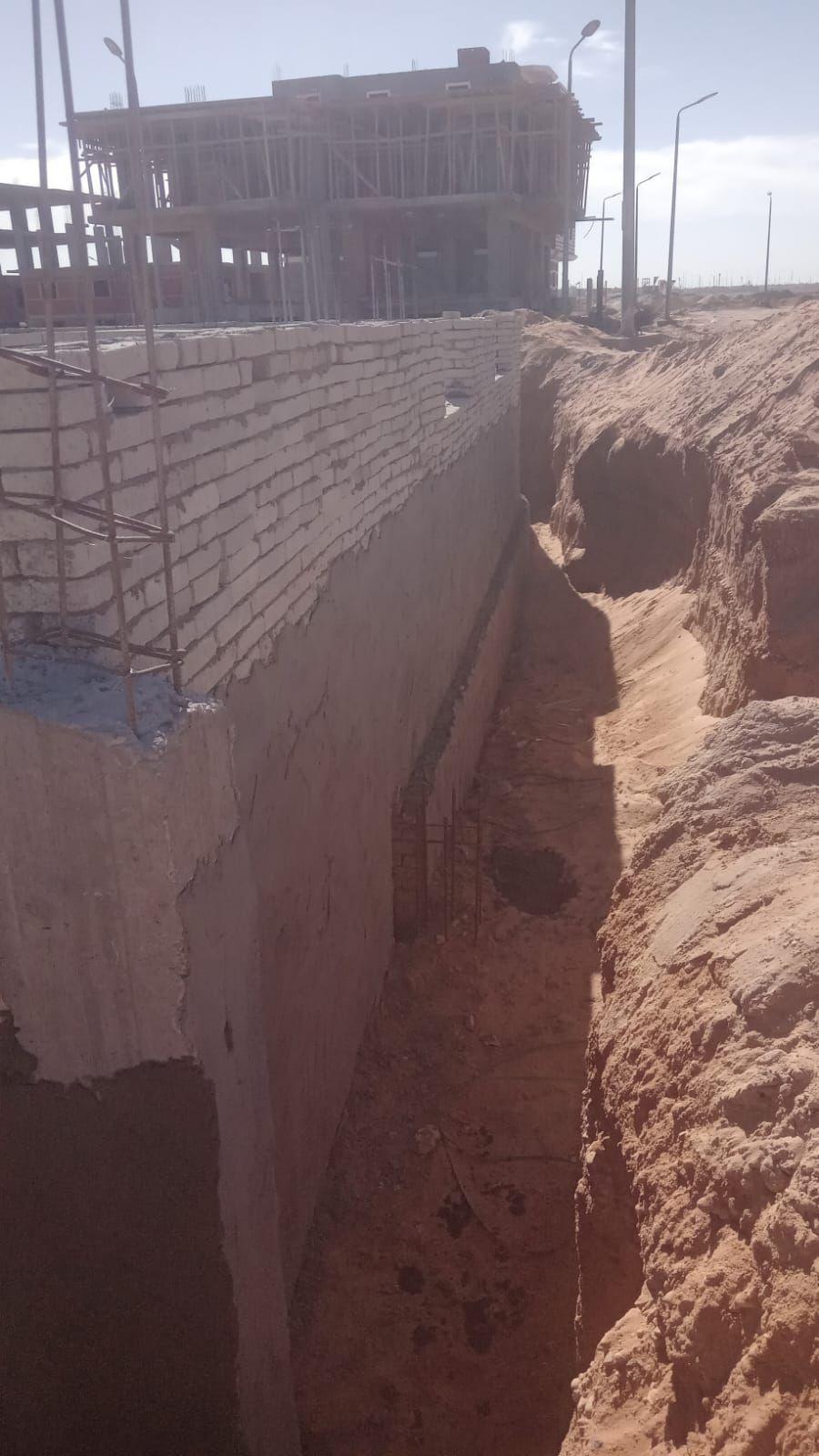

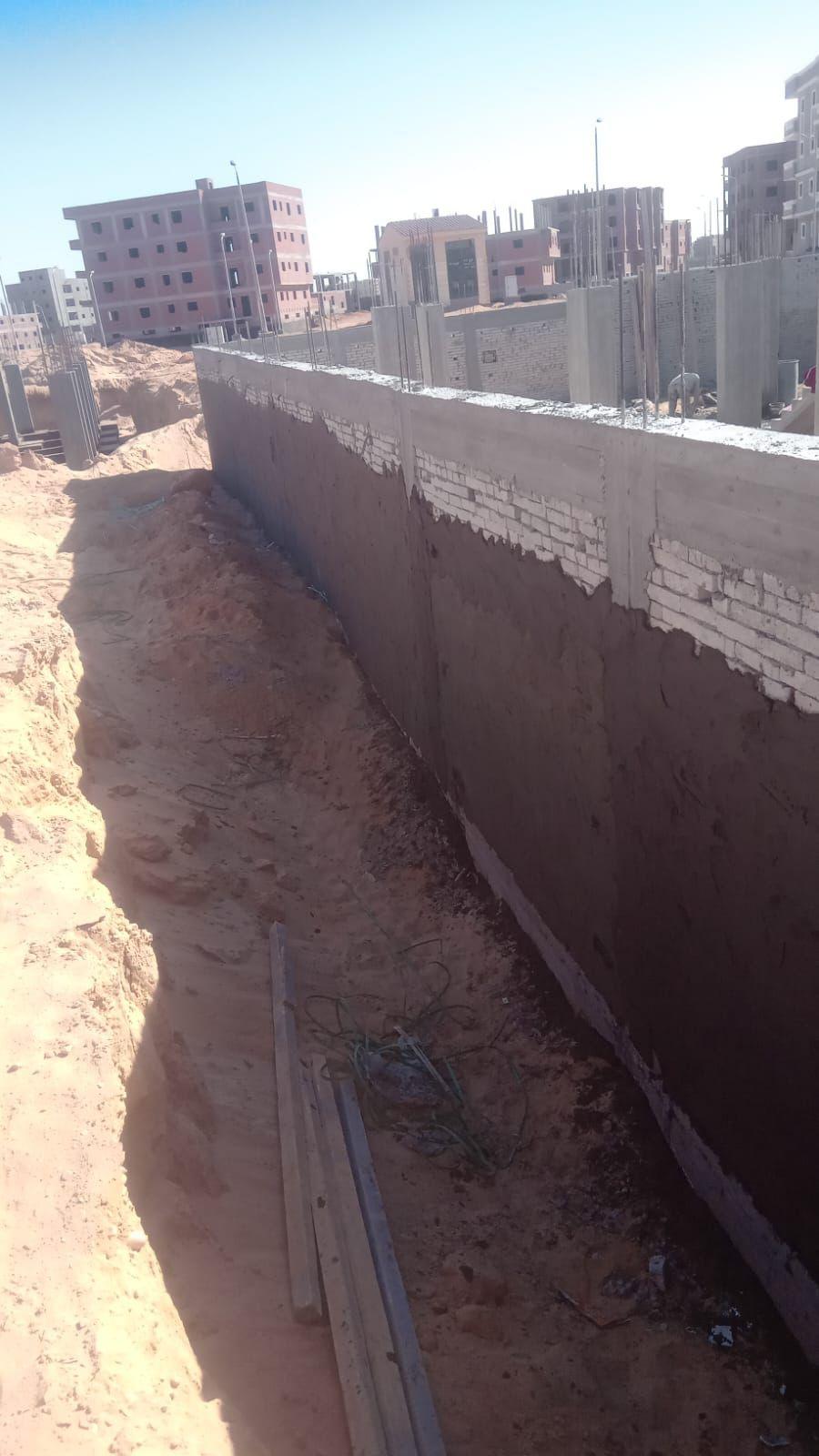

Basement walls
December 9, 2025
Receiving third-floor extension license
December 8, 2025
Third floor columns
December 9, 2025
Third floor slab
December 16, 2025

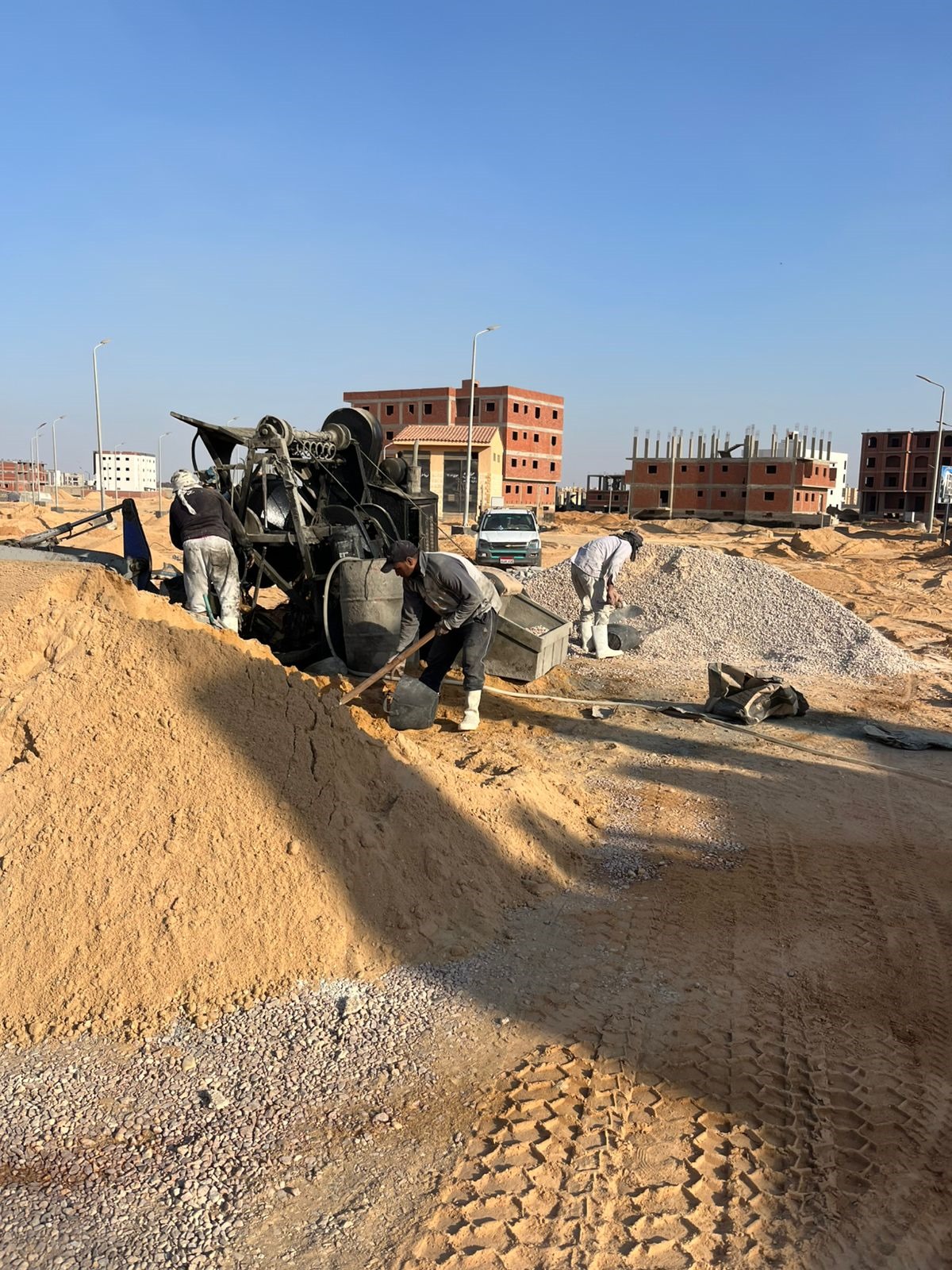

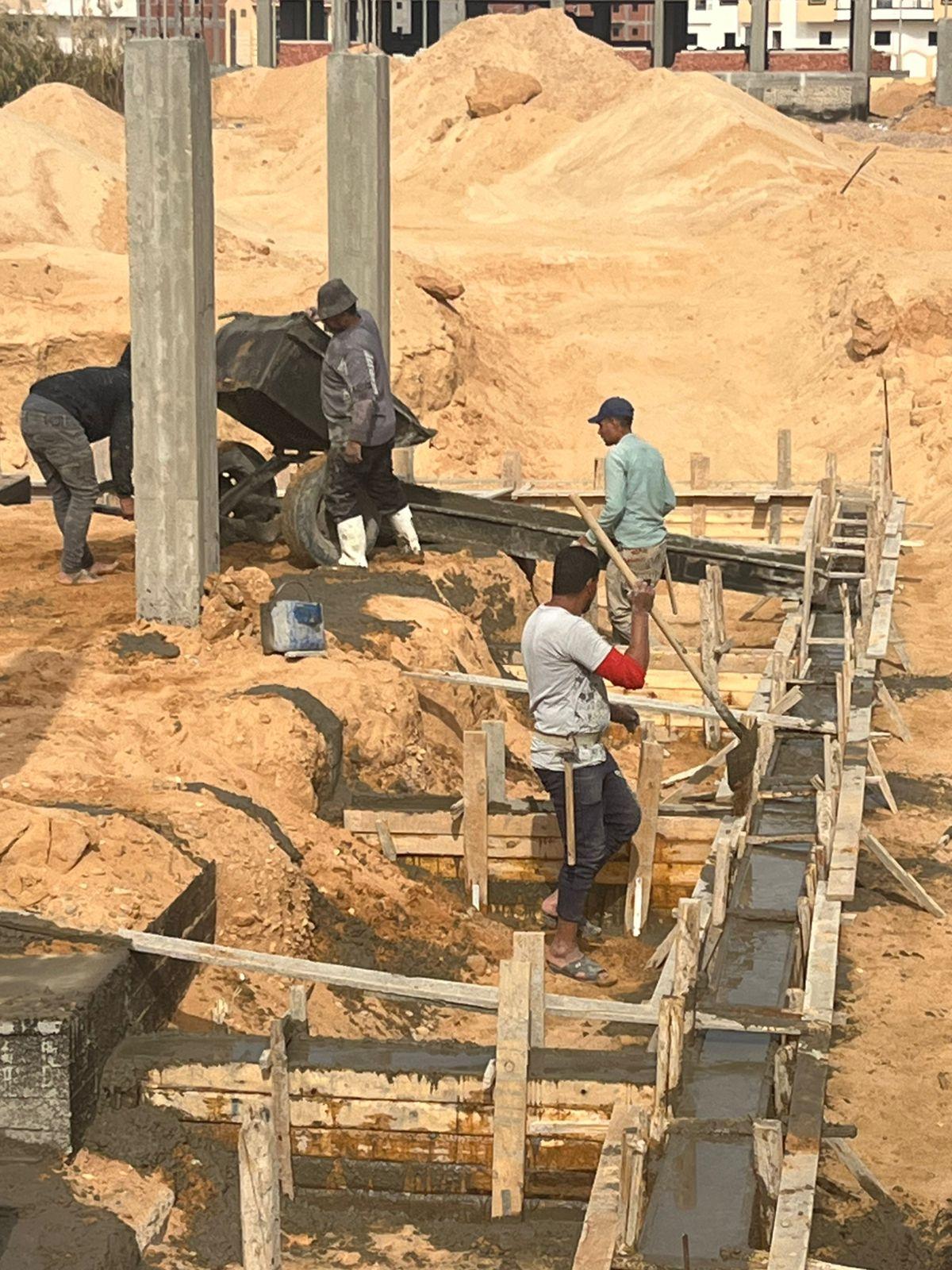

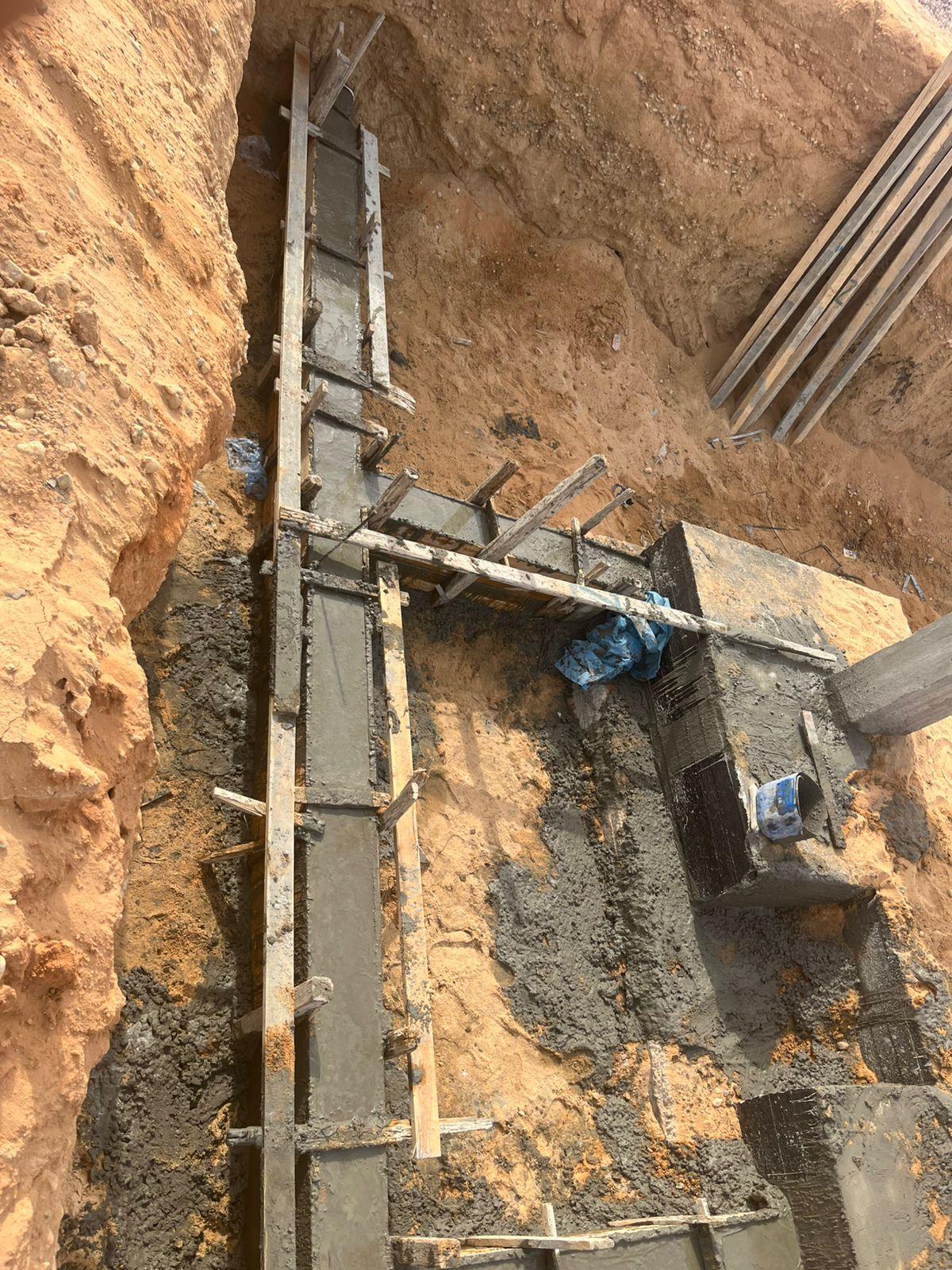

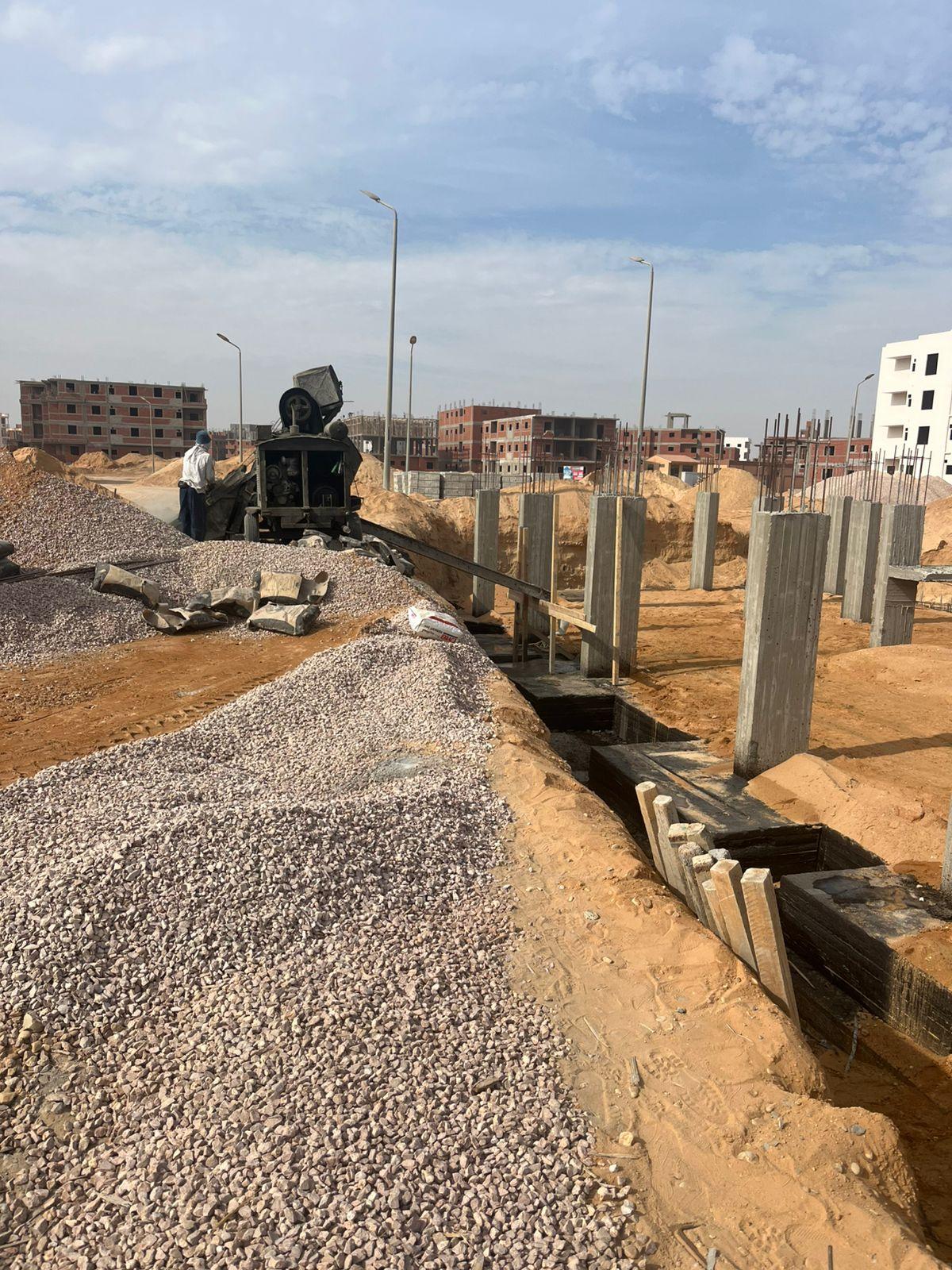

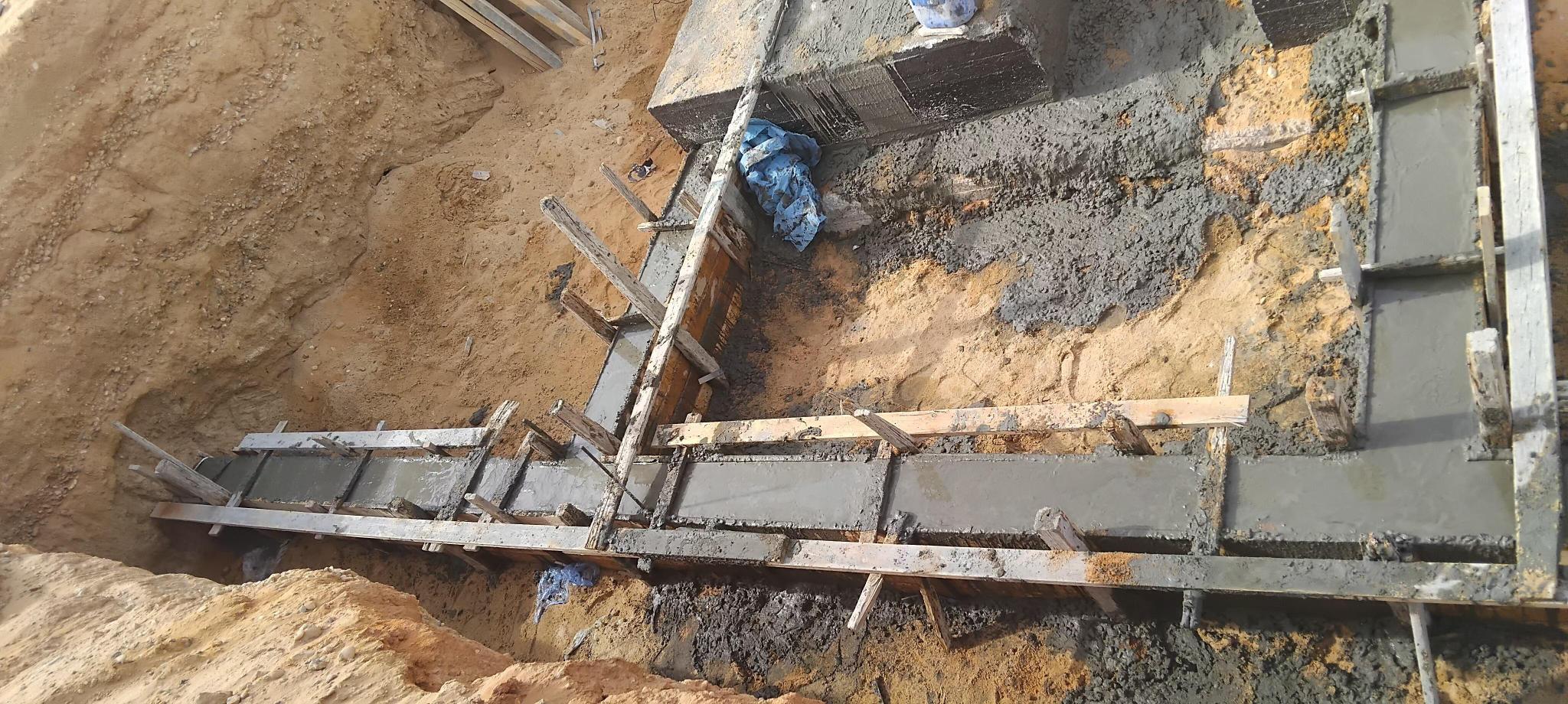

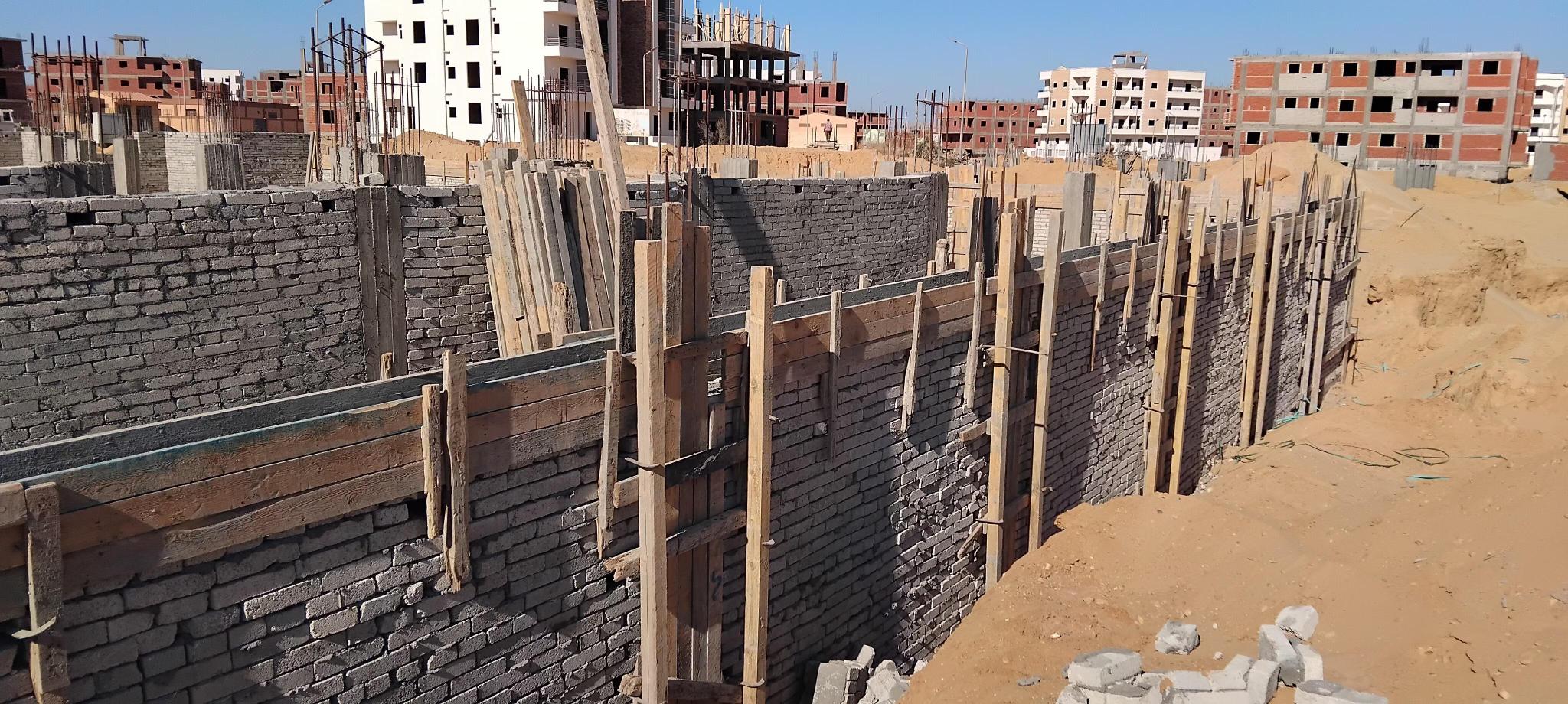

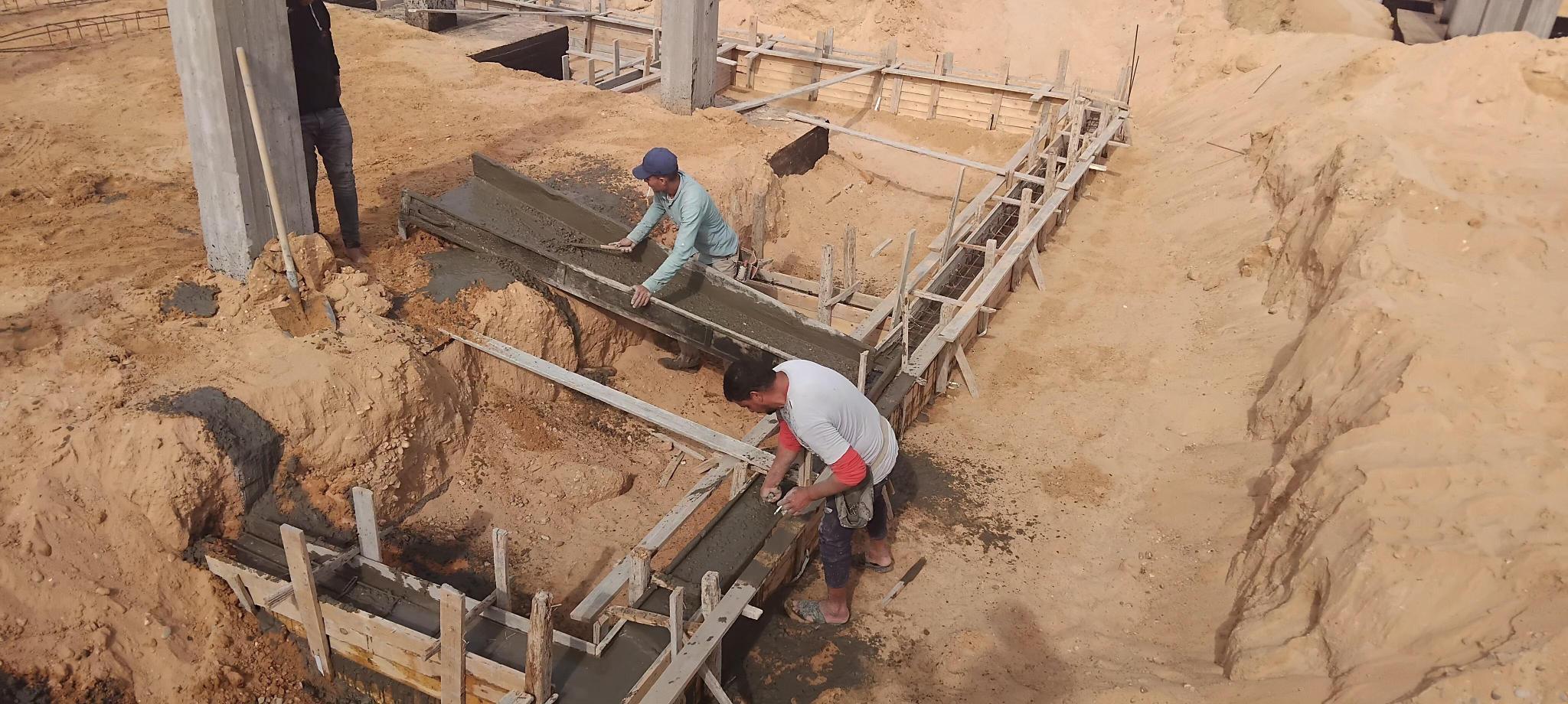

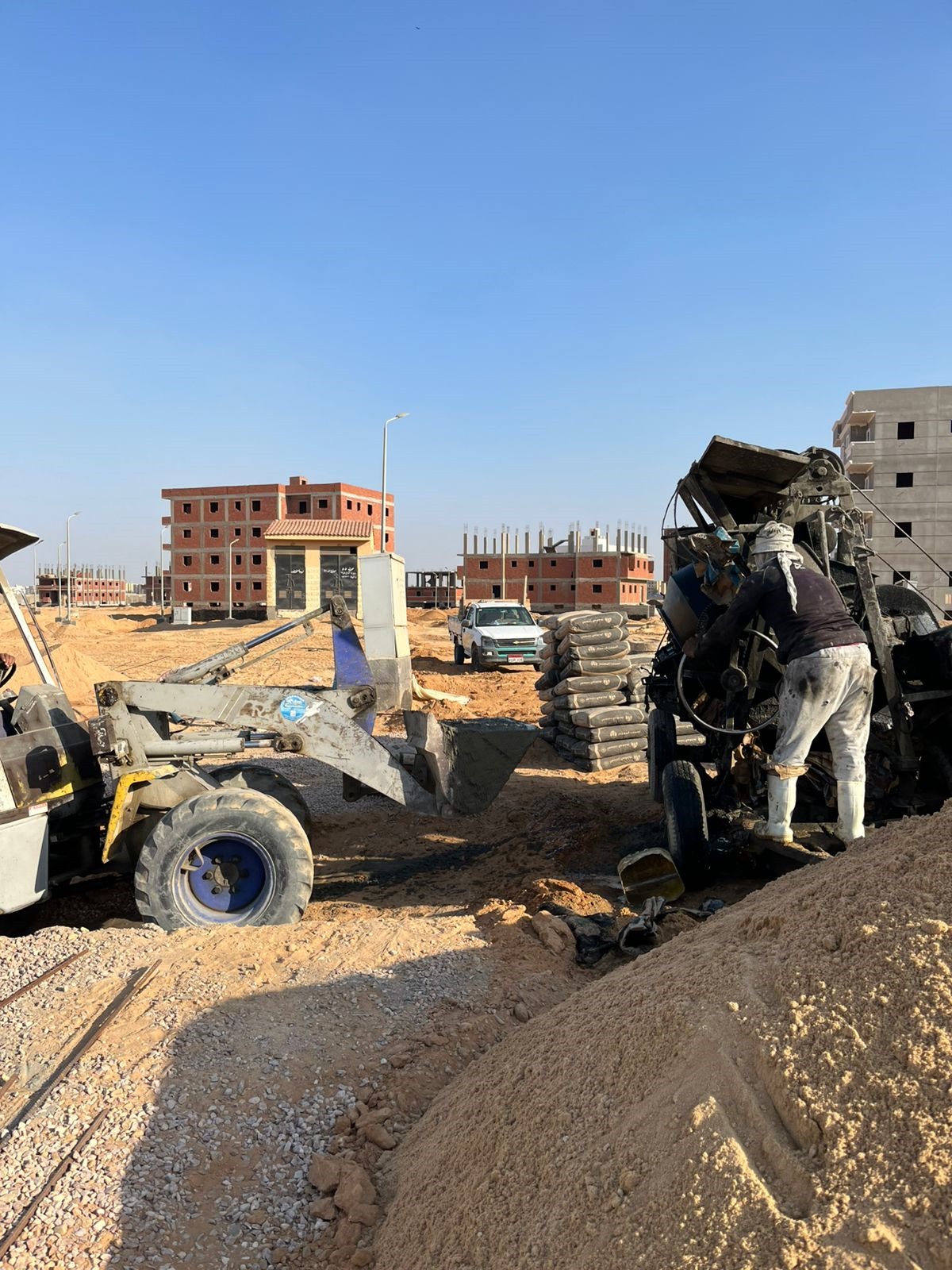

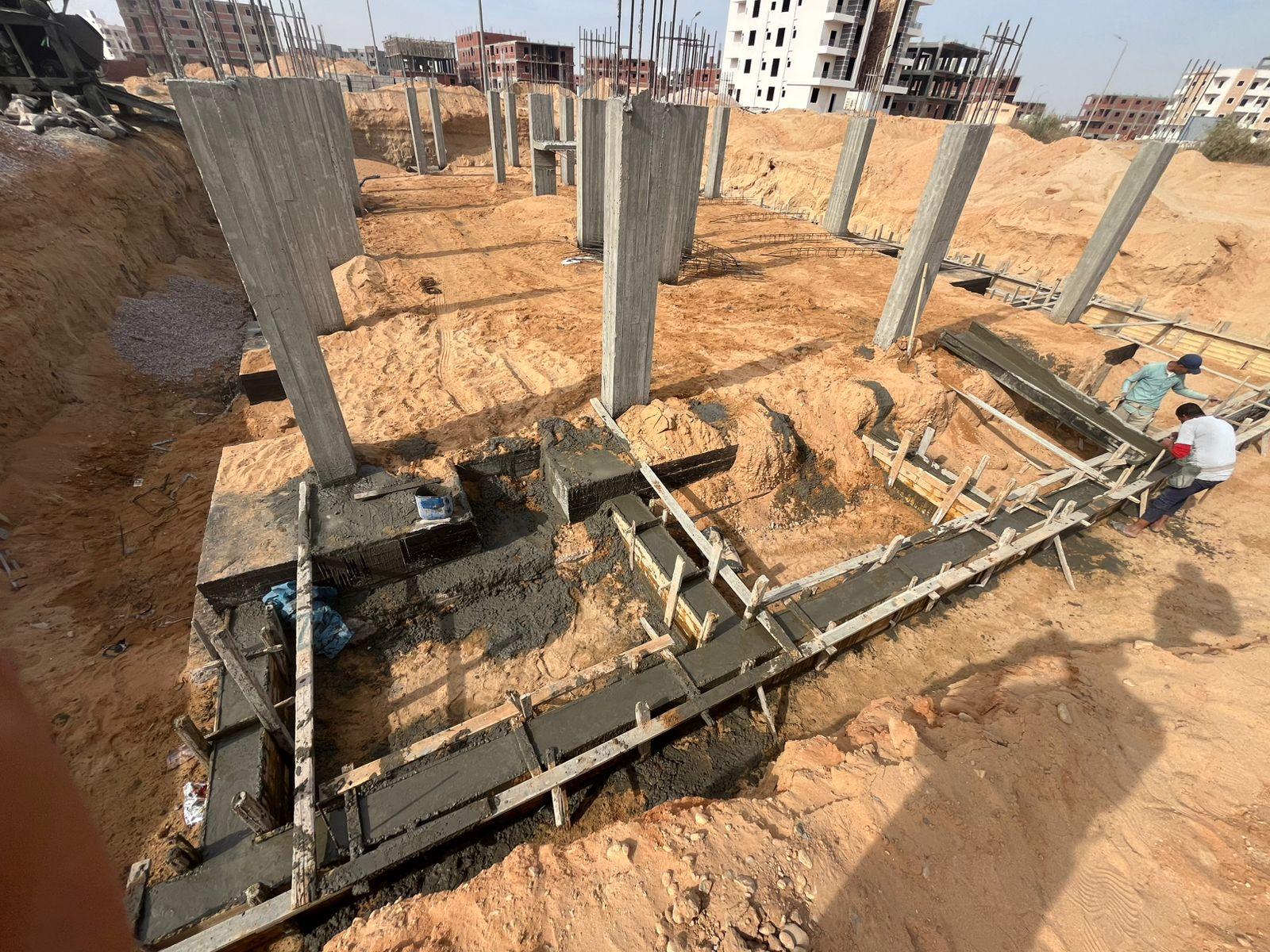

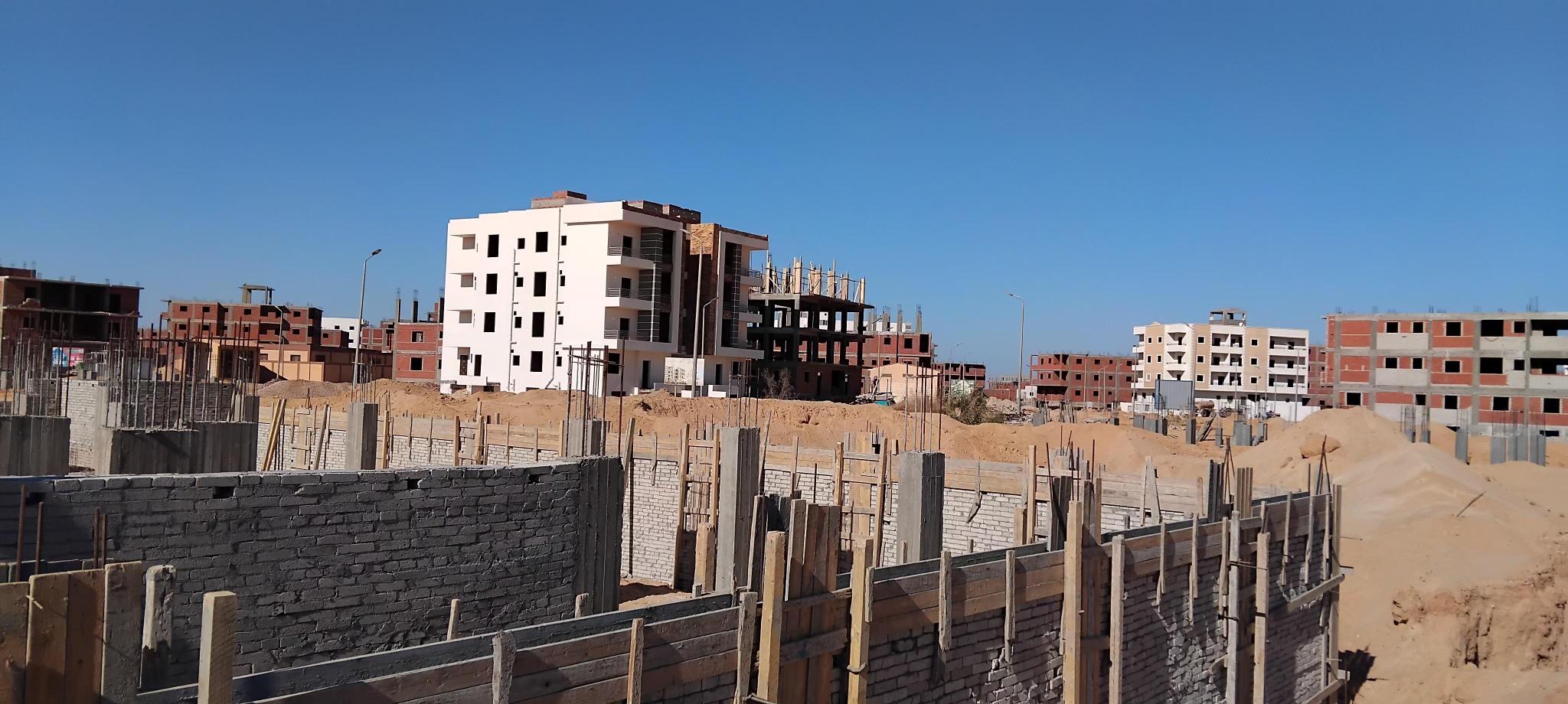

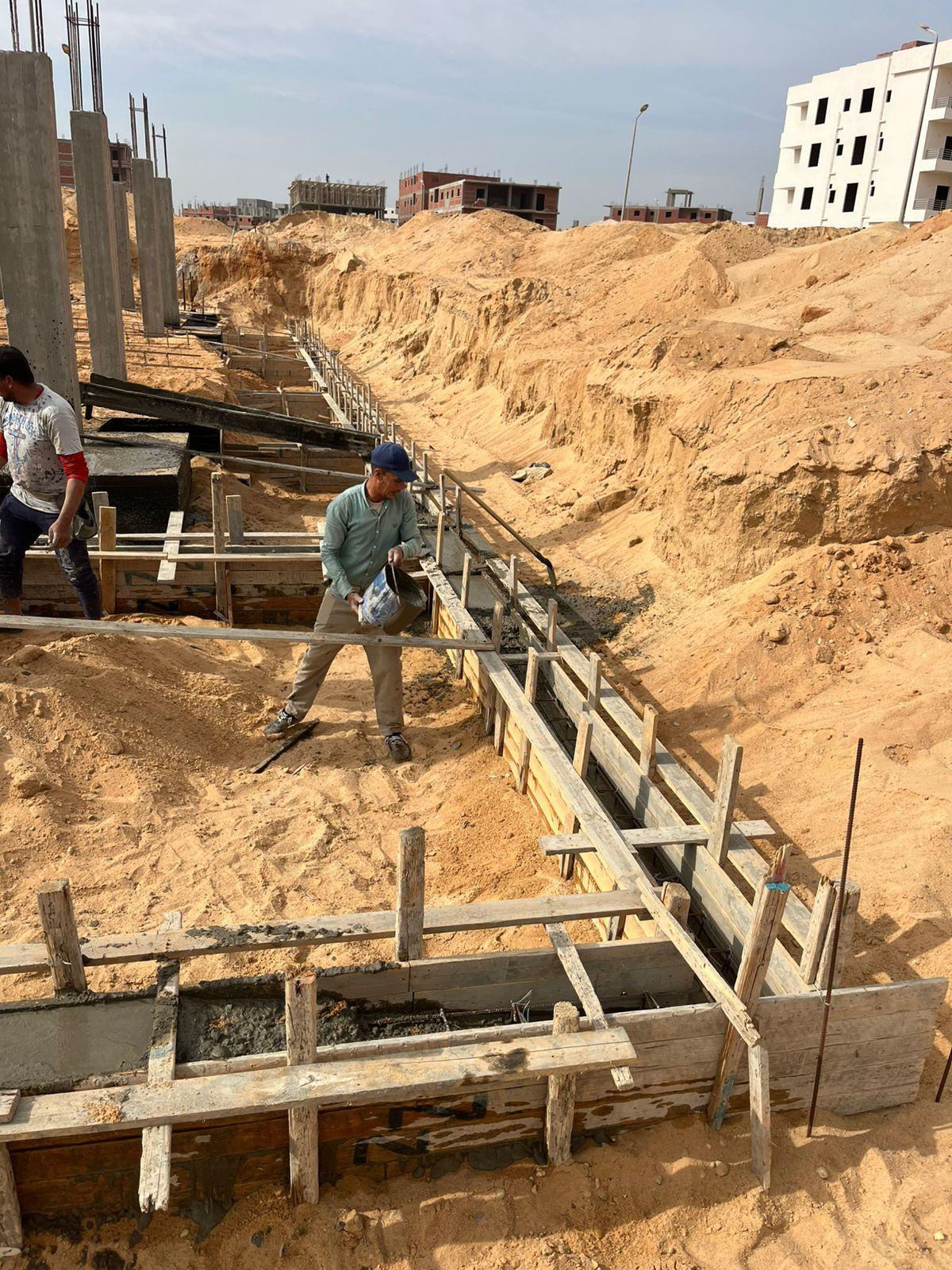

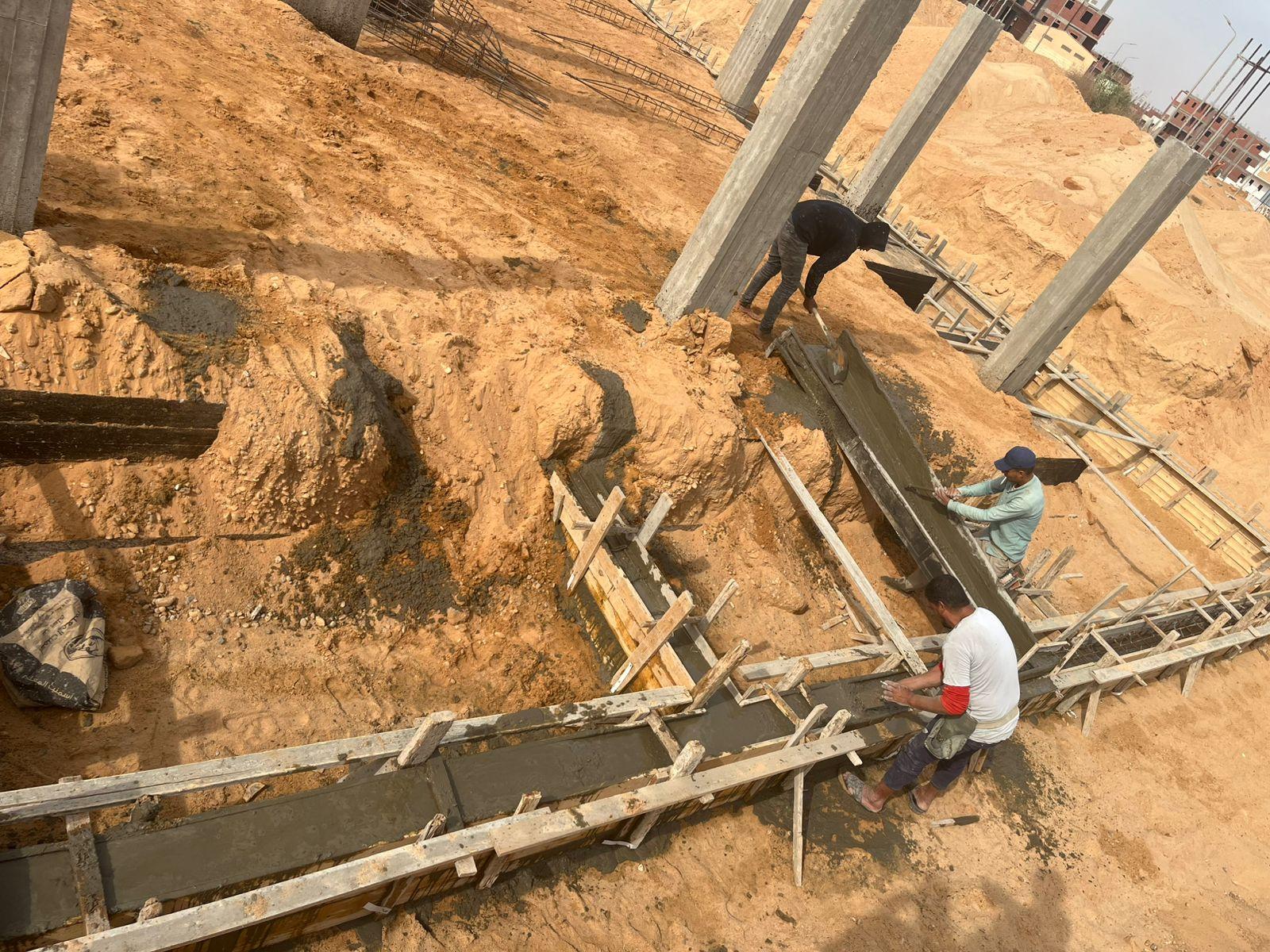

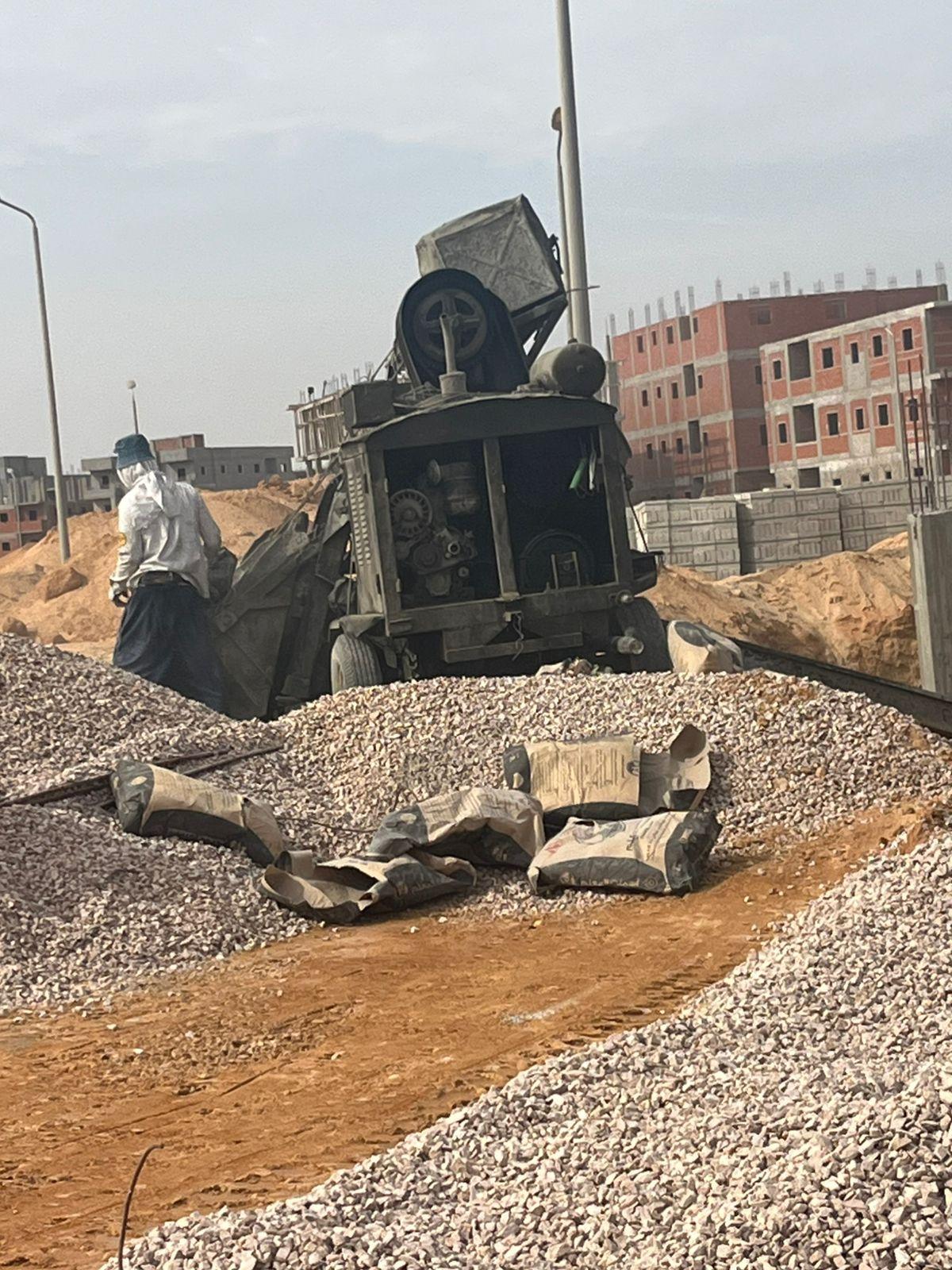

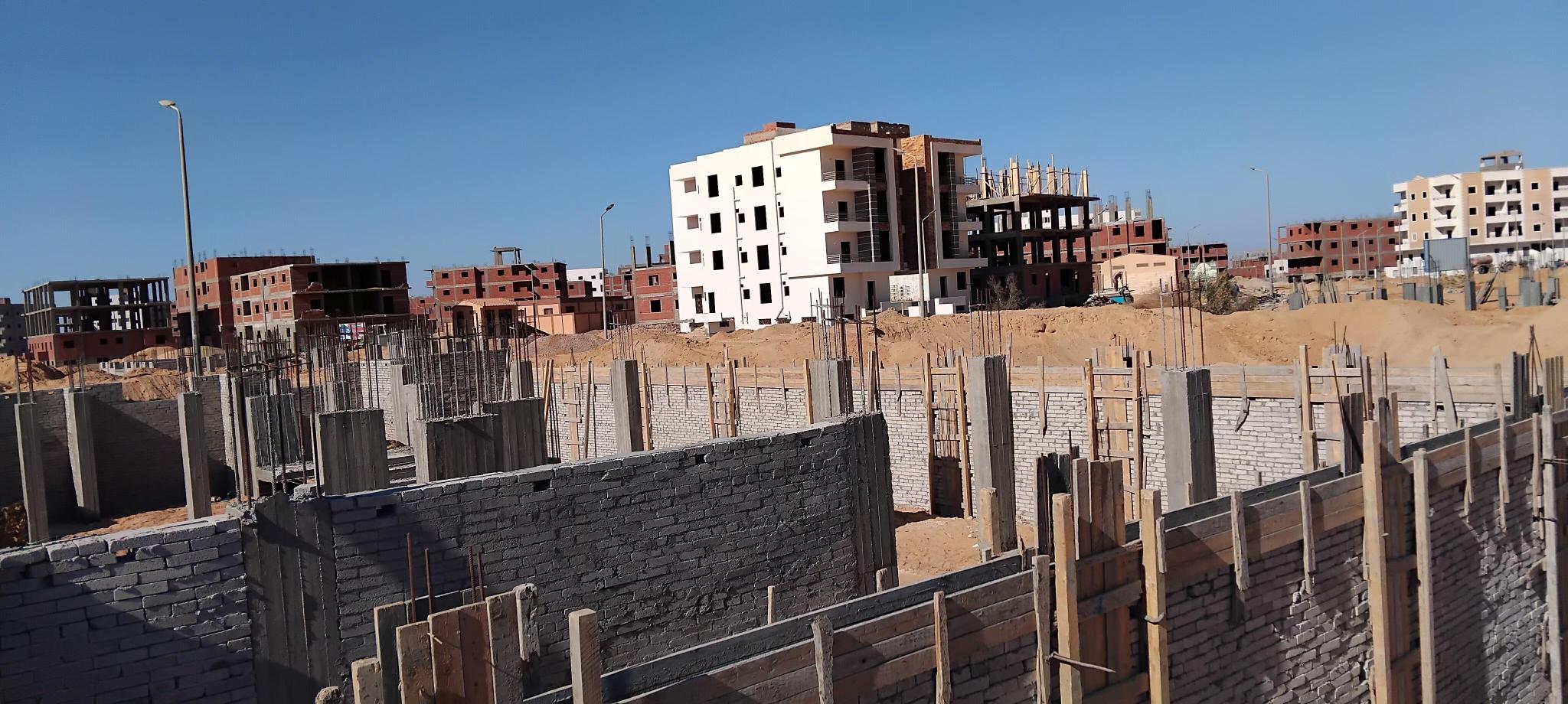

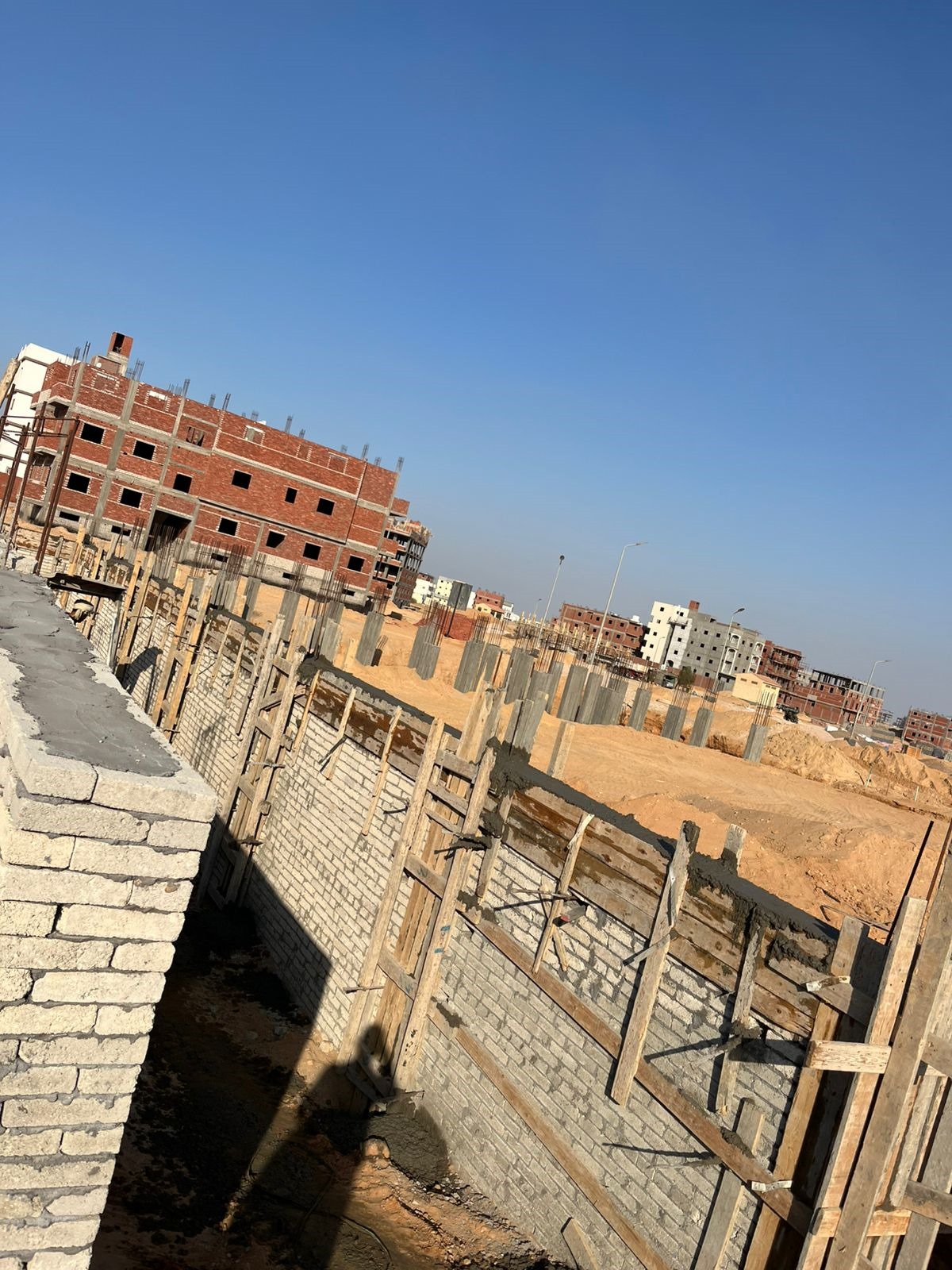

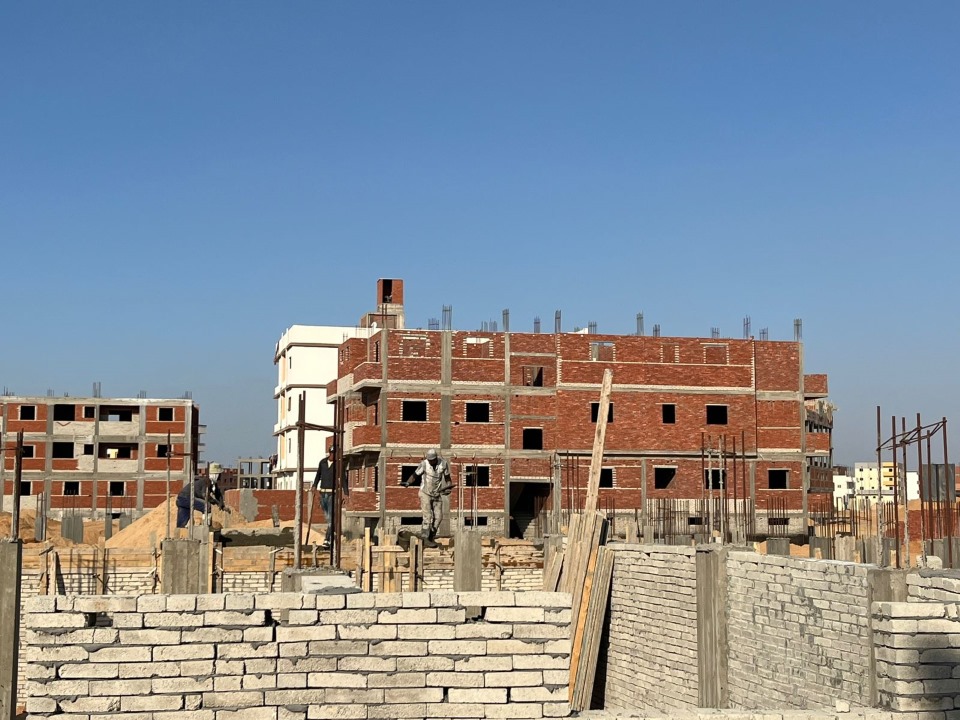

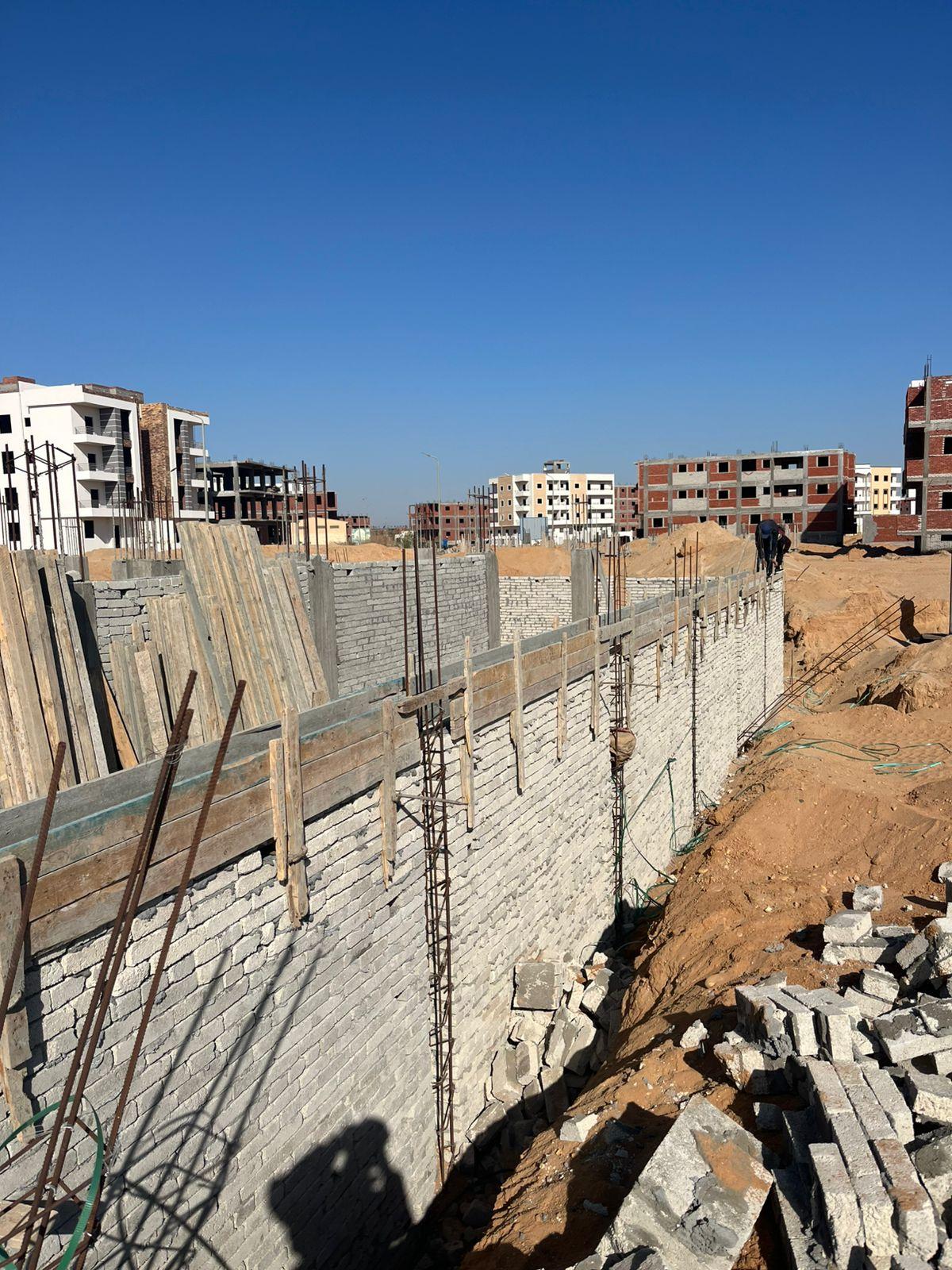

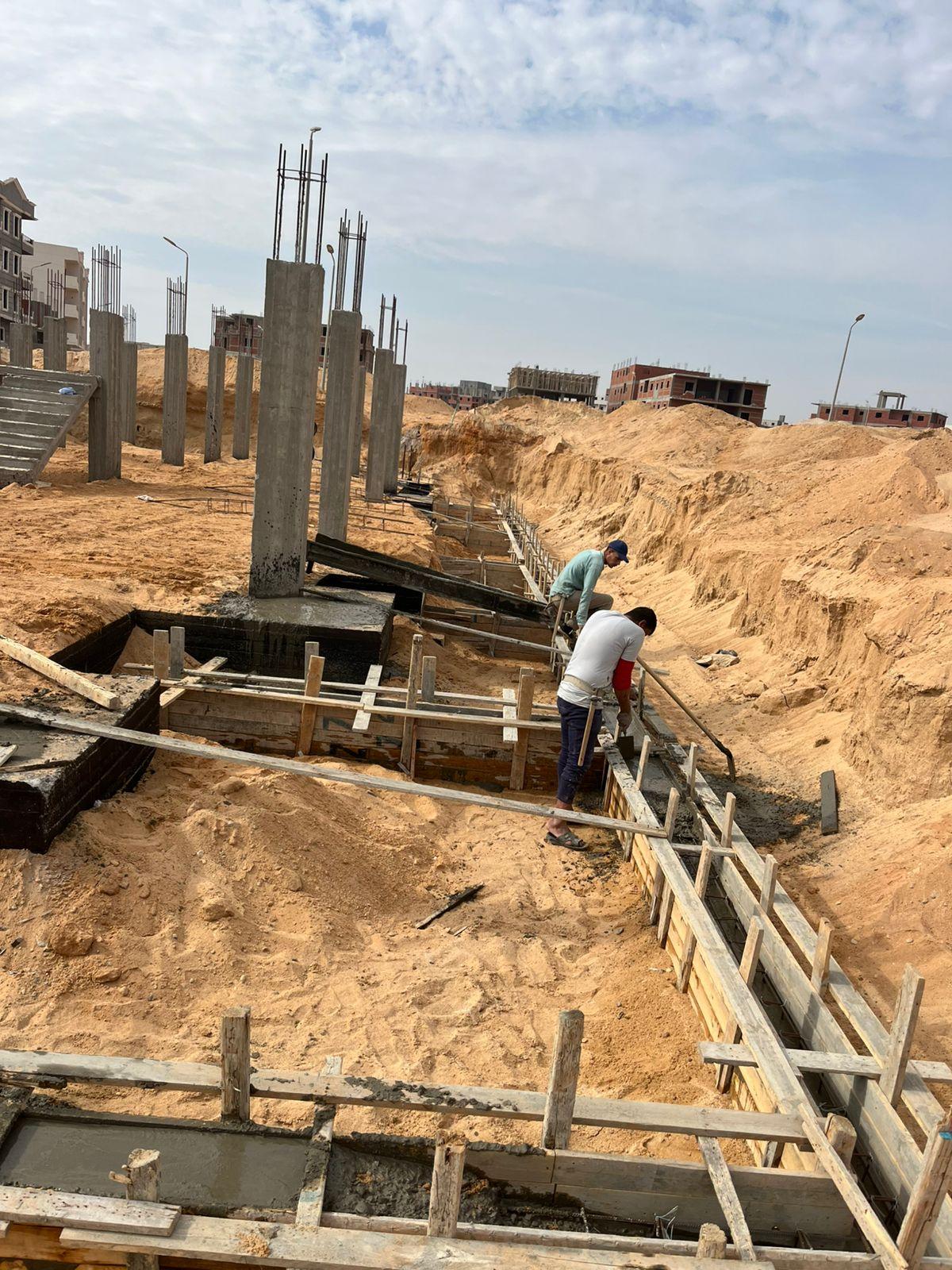

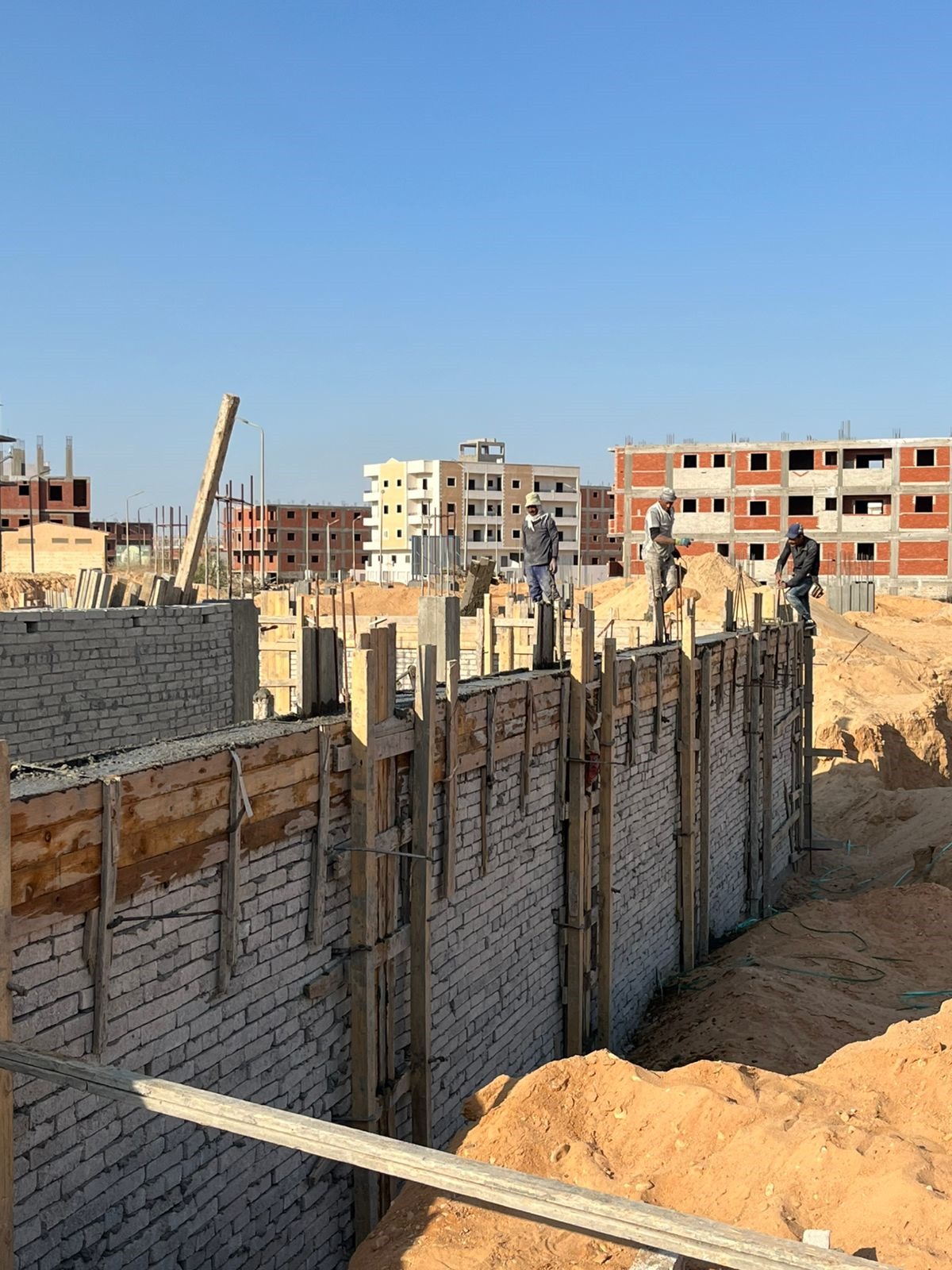

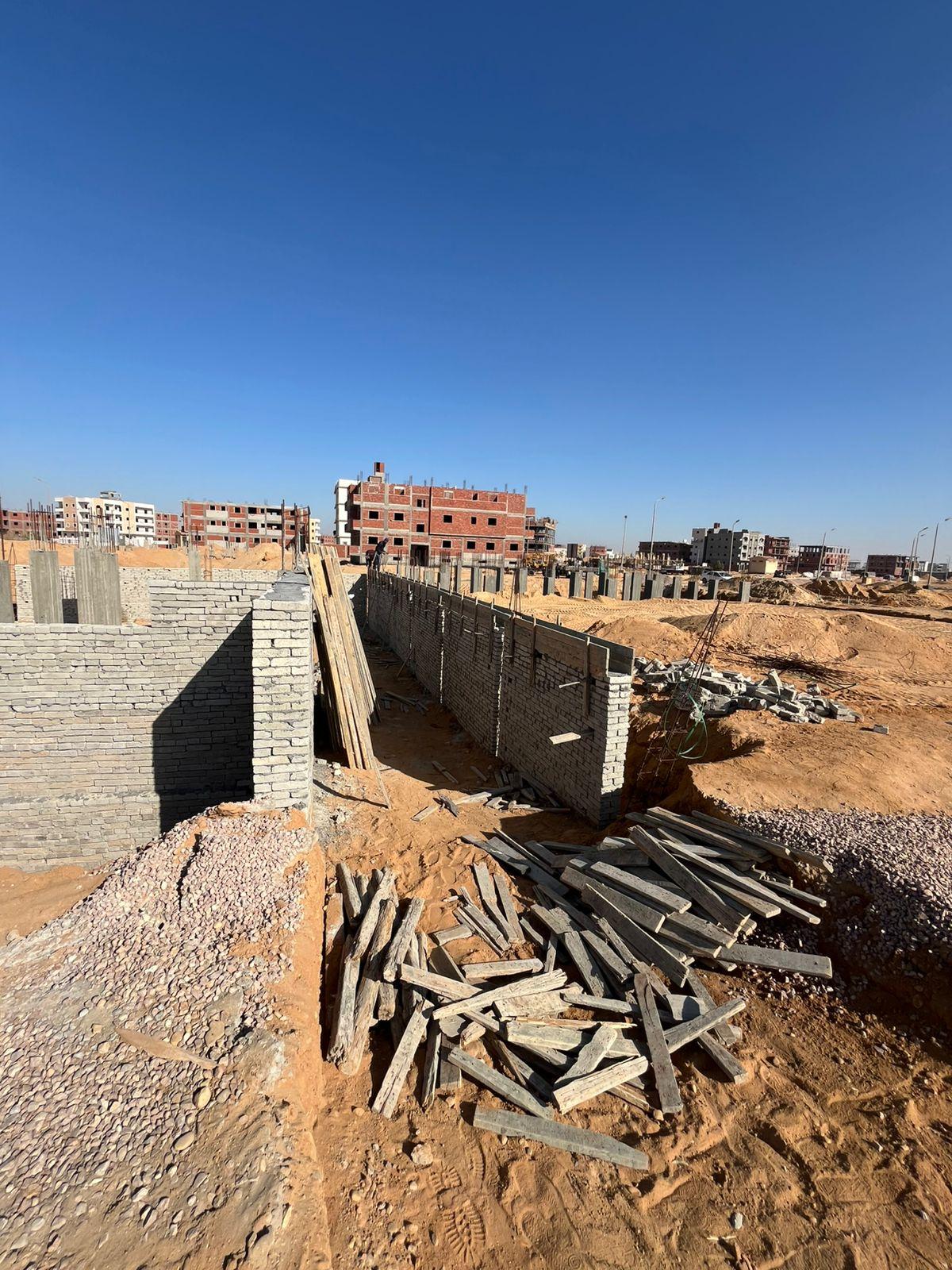

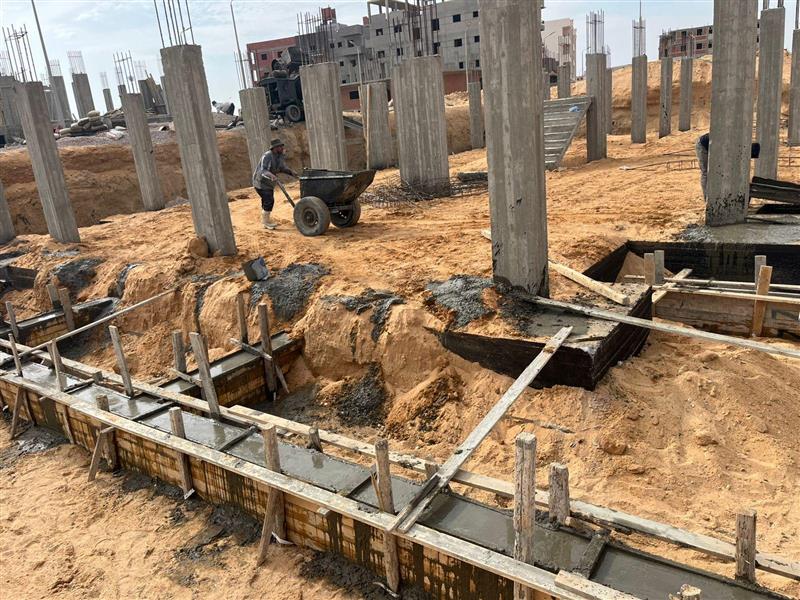

Fence columns
November 29, 2025
Roof extension license
December 31, 2025
Roof concrete works
March 31, 2026
Ground floor walls
May 8, 2026
First floor walls
May 18, 2026
Second floor walls
May 28, 2026
Third floor walls
June 7, 2026
Roof walls
June 17, 2026
Wooden door frames
June 27, 2026
Electrical final finishes
July 1, 2026
Plumbing main works
July 2, 2026
Plaster and putty
July 16, 2026
Marble works
September 13, 2026
Plumbing finishing
September 14, 2026
Aluminum & glass works (Krital)
September 14, 2026
Electrical finishing
September 29, 2026
Elevator
September 30, 2026
Swimming pool
October 14, 2026
Project handover to the authority
October 15, 2026
Utilities meter installation
October 16, 2026
