Project Details
Land Number
D54
Region
BaitWatan, 5th settlement
HOMEi Price
16,000.00 EGP
Neighbour Price
23,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 10% |
| 3 | During Construction | 10% |
| 4 | During Construction | 10% |
| 5 | During Construction | 5% |
| 6 | During Construction | 5% |
| 7 | During Construction | 5% |
| 8 | During Construction | 5% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
175 m²
Delivery
Unit Delivery Date
March 2028
Average Unit Price
2,207,250 EGP
Project Location
Map View
BaitWatan, 5th settlement
HOMEi Timeline

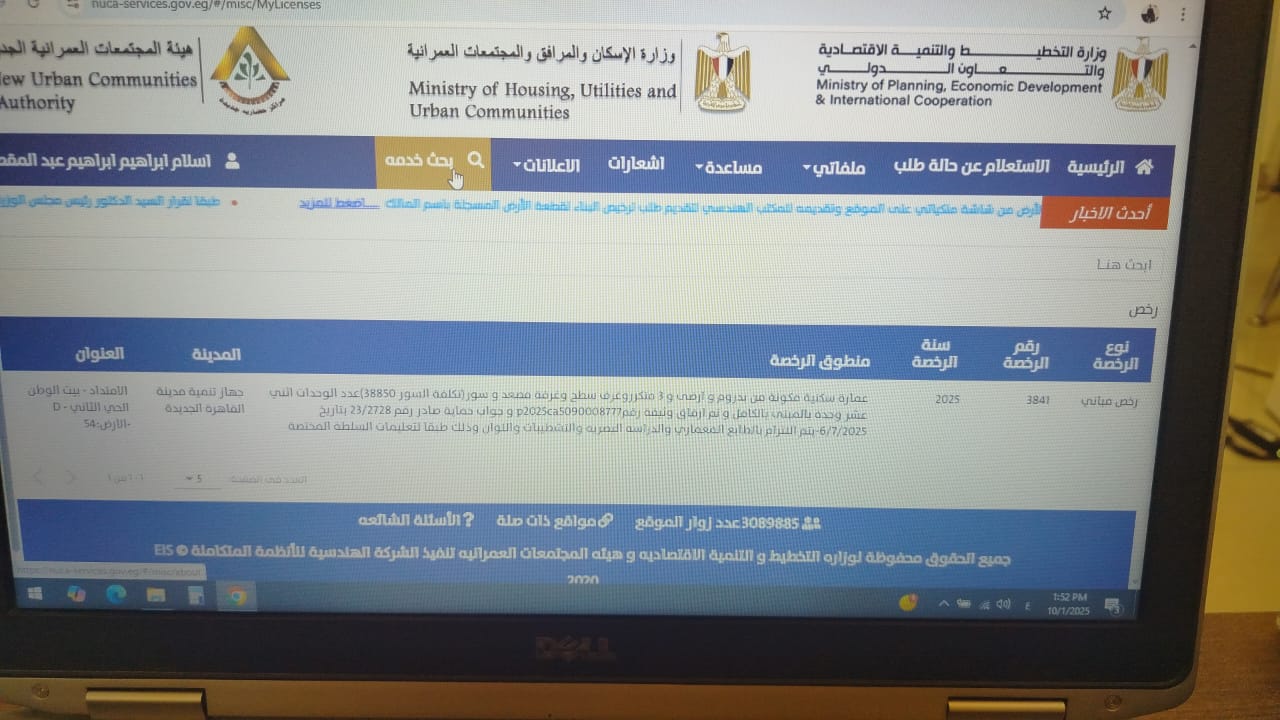

Receiving the license
October 1, 2025
License office contract
March 20, 2025
Excavation

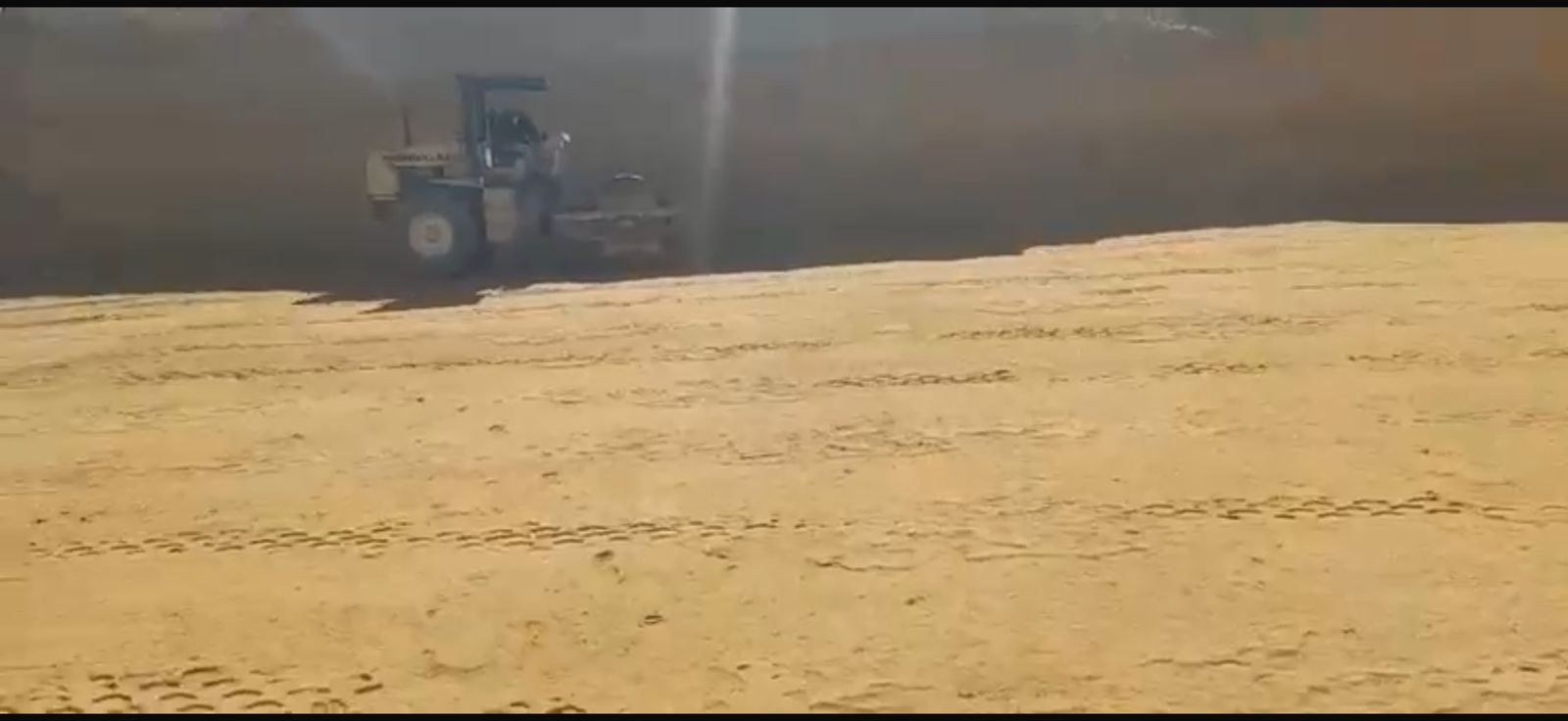

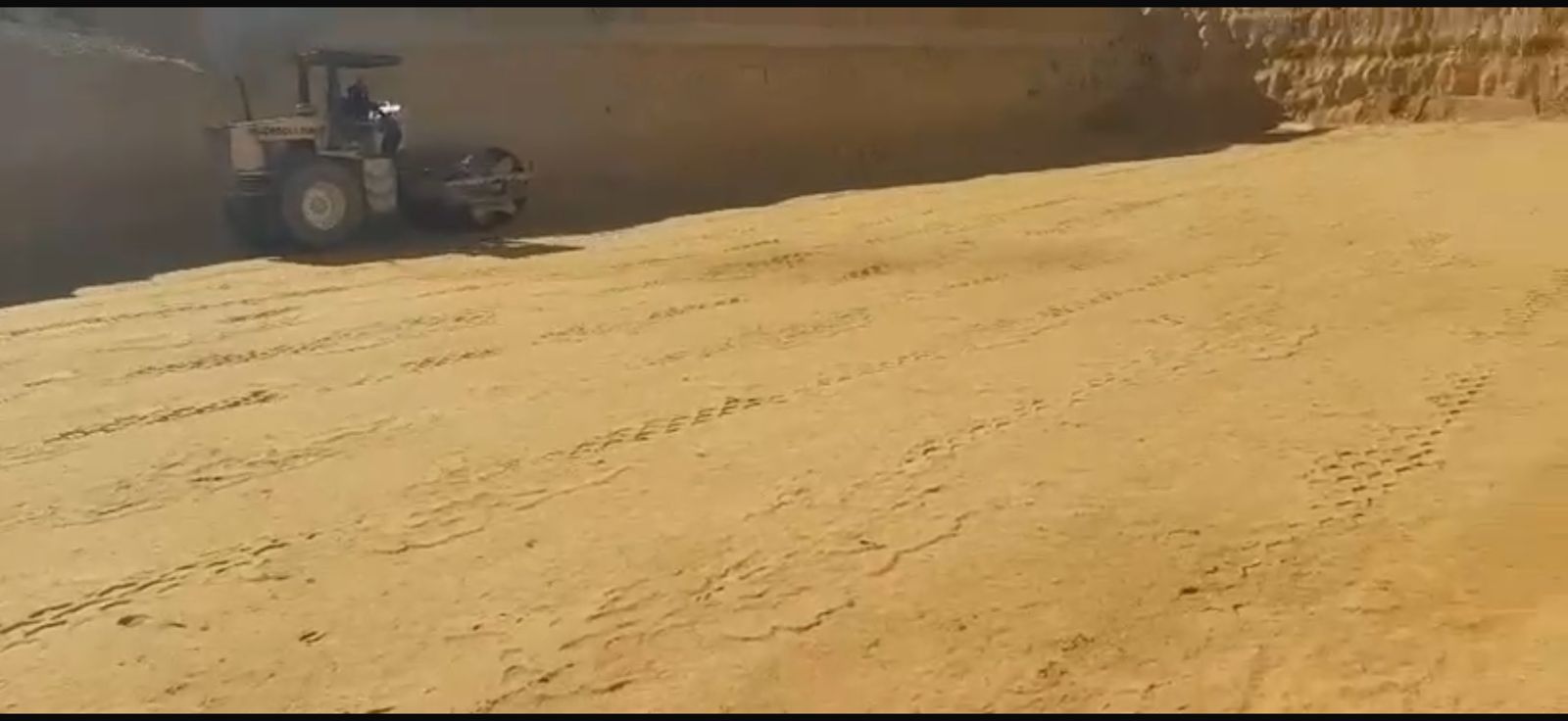

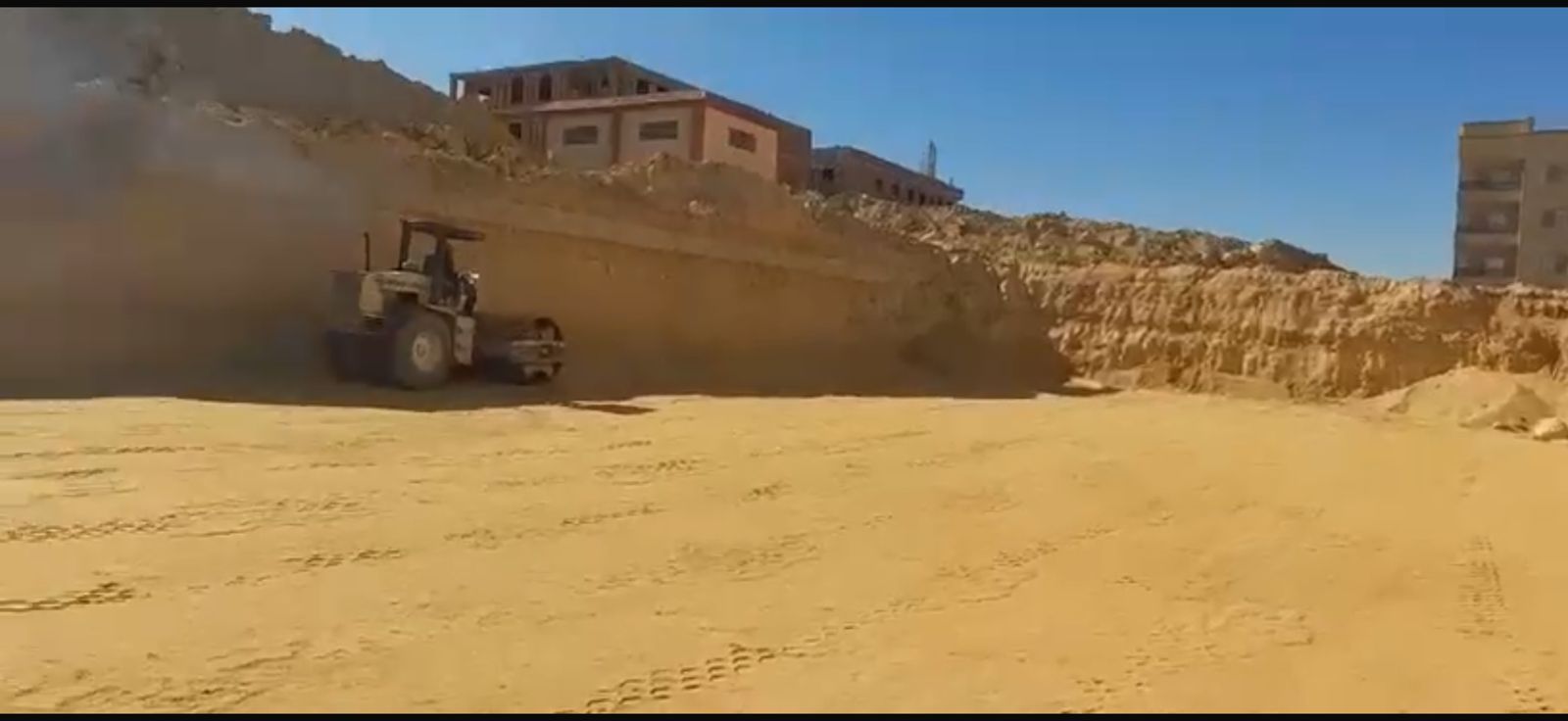

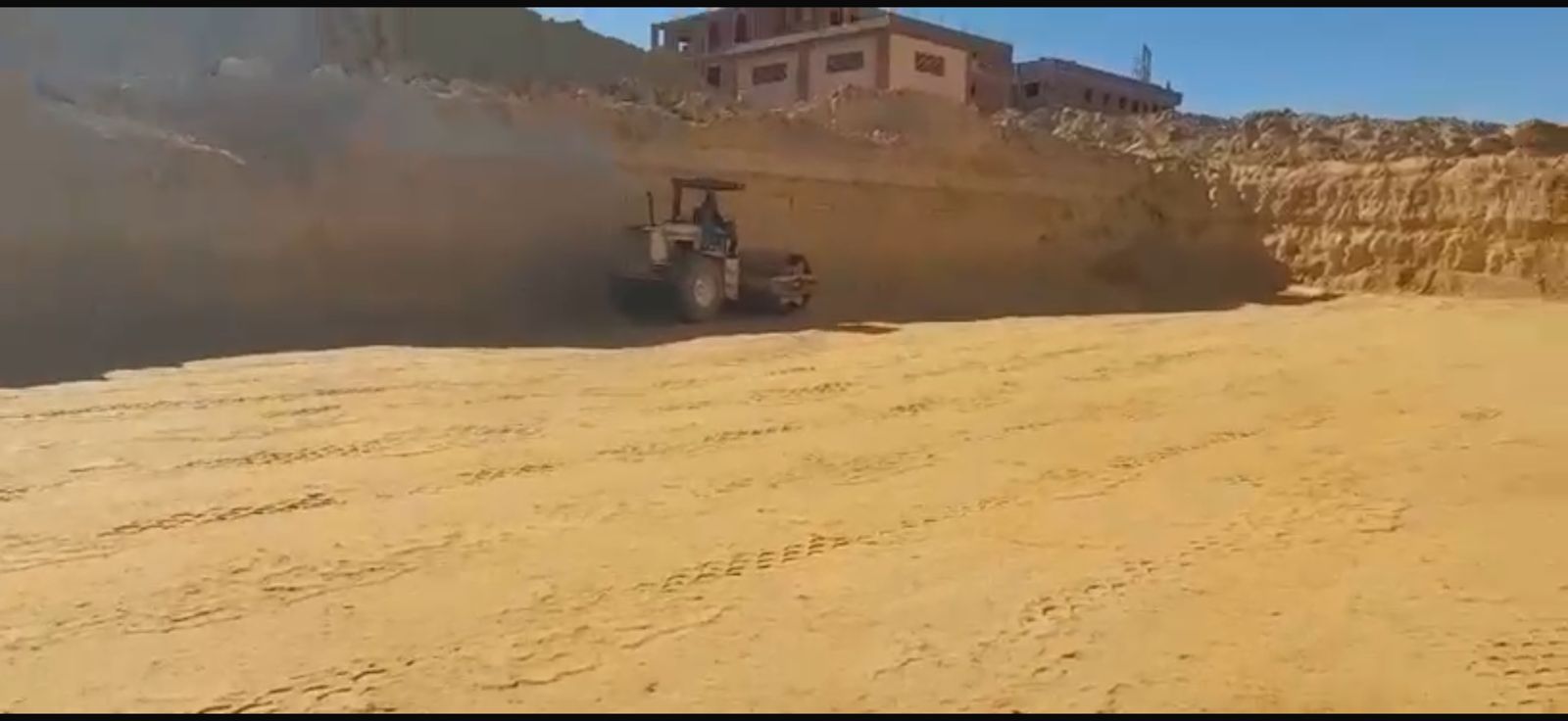

January 25, 2025
Excavation permit
October 25, 2025
Mining permit
October 30, 2025
Construction contract in progress
November 5, 2025
Construction contract signed
November 25, 2025

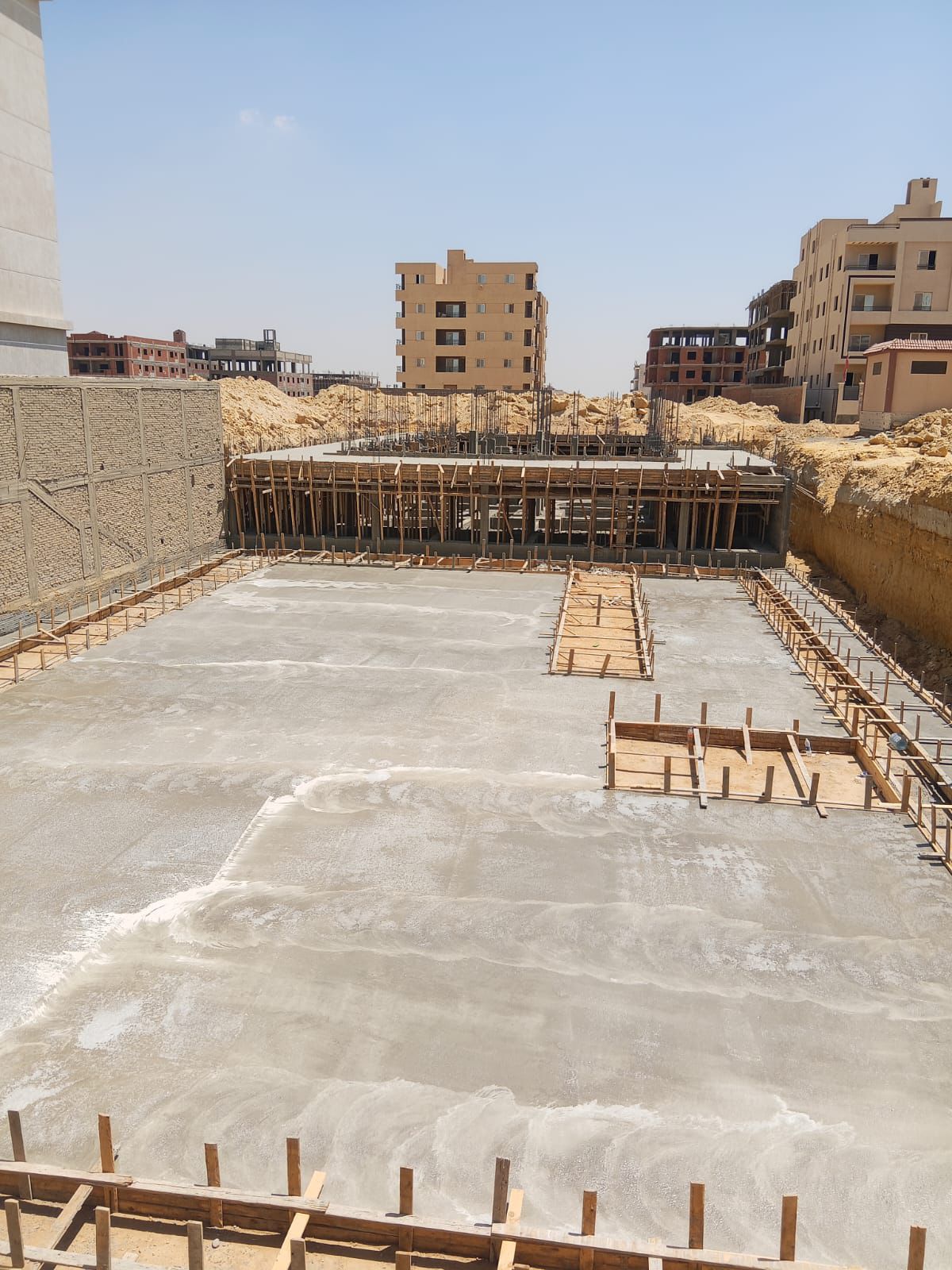

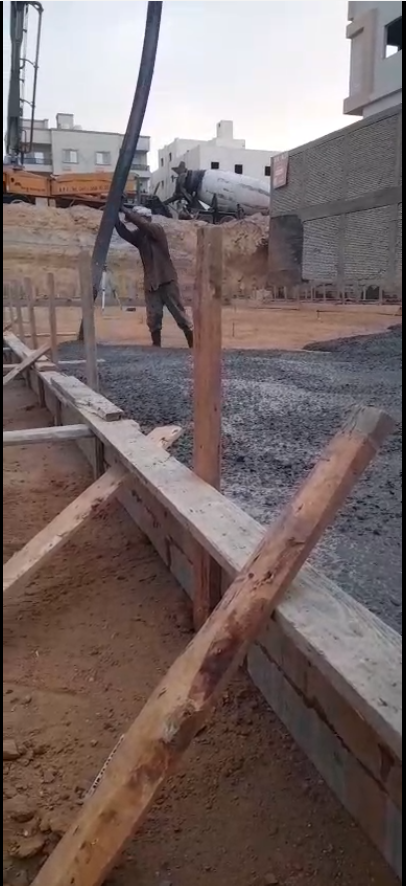

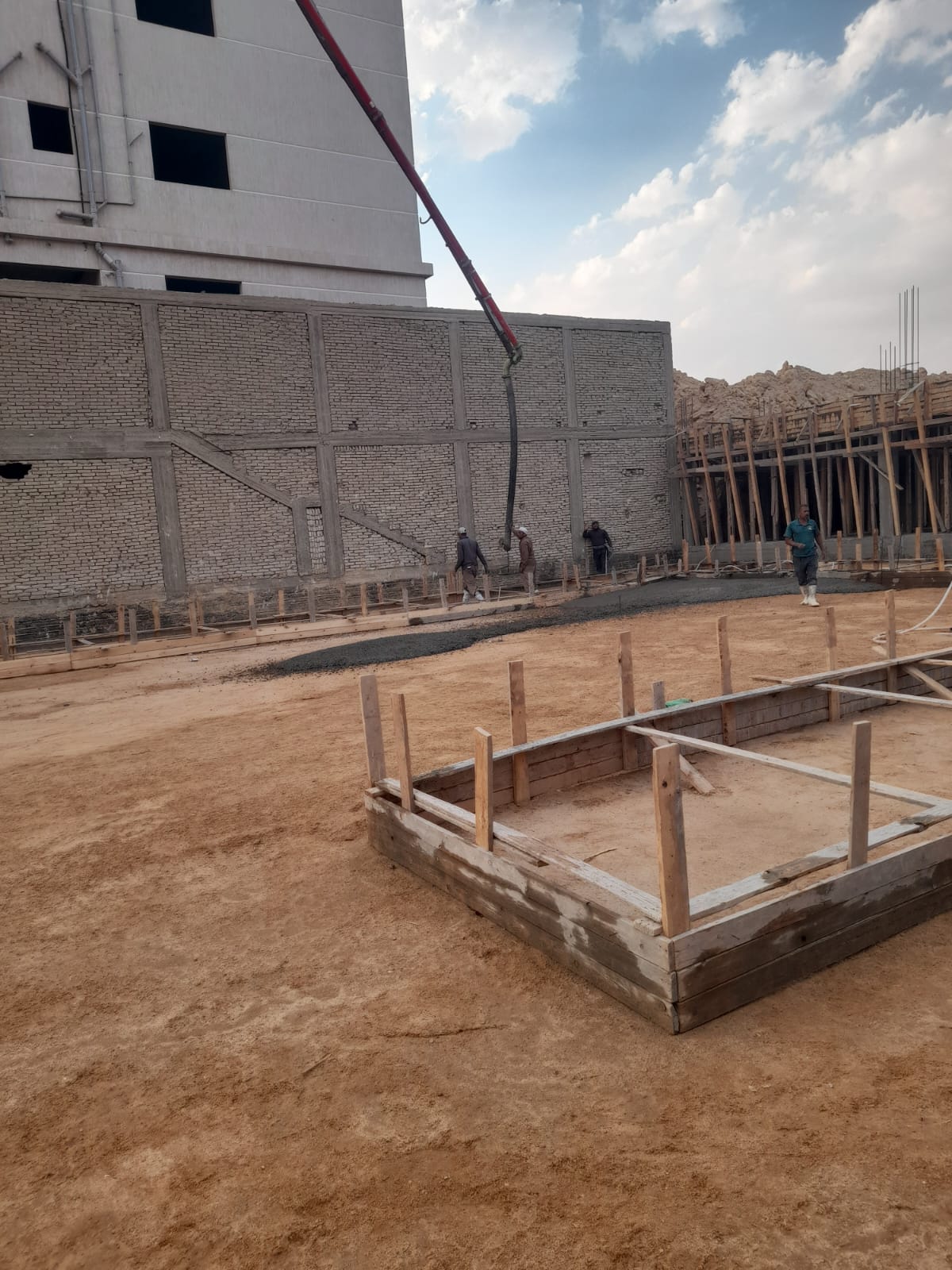

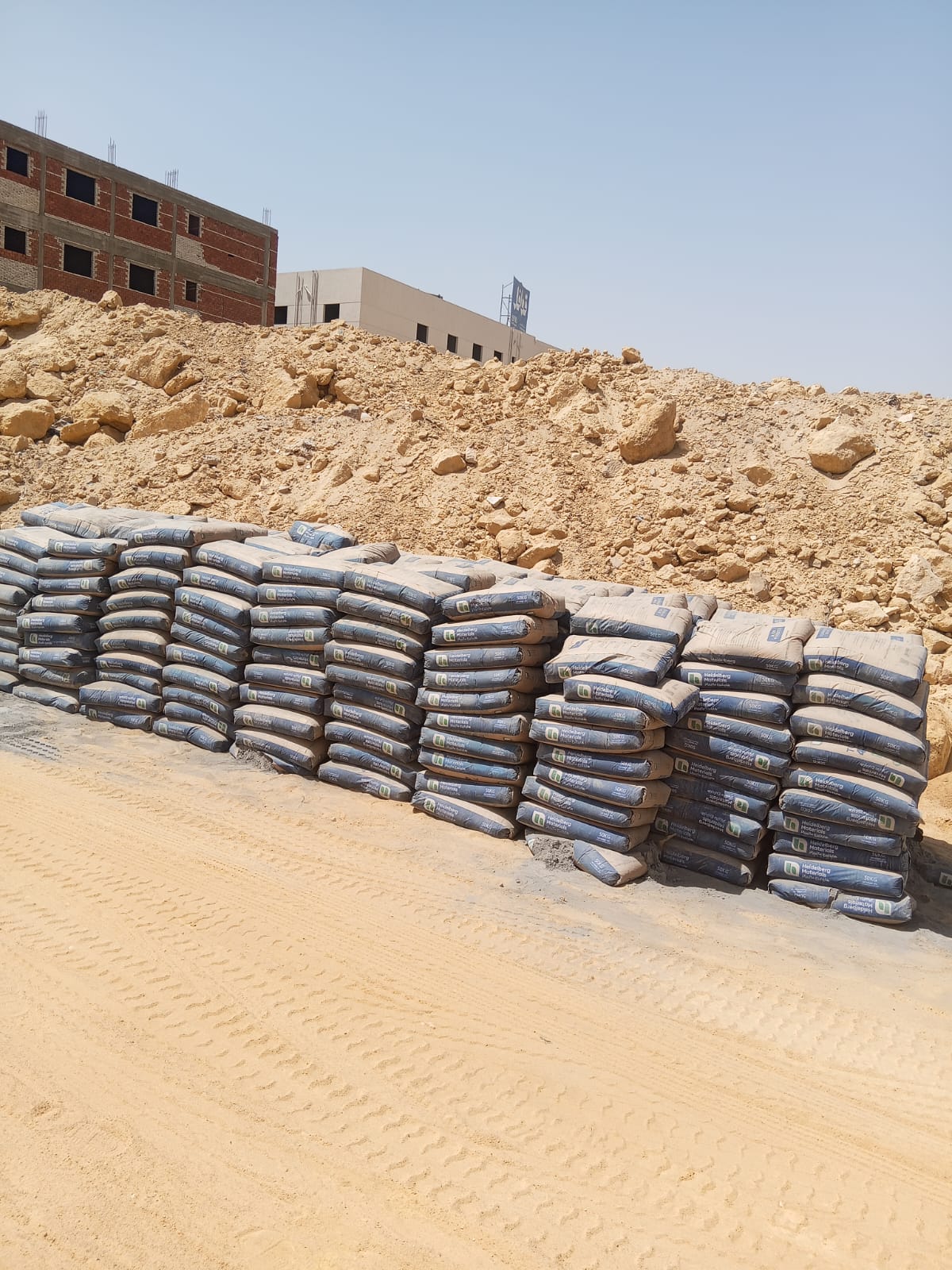

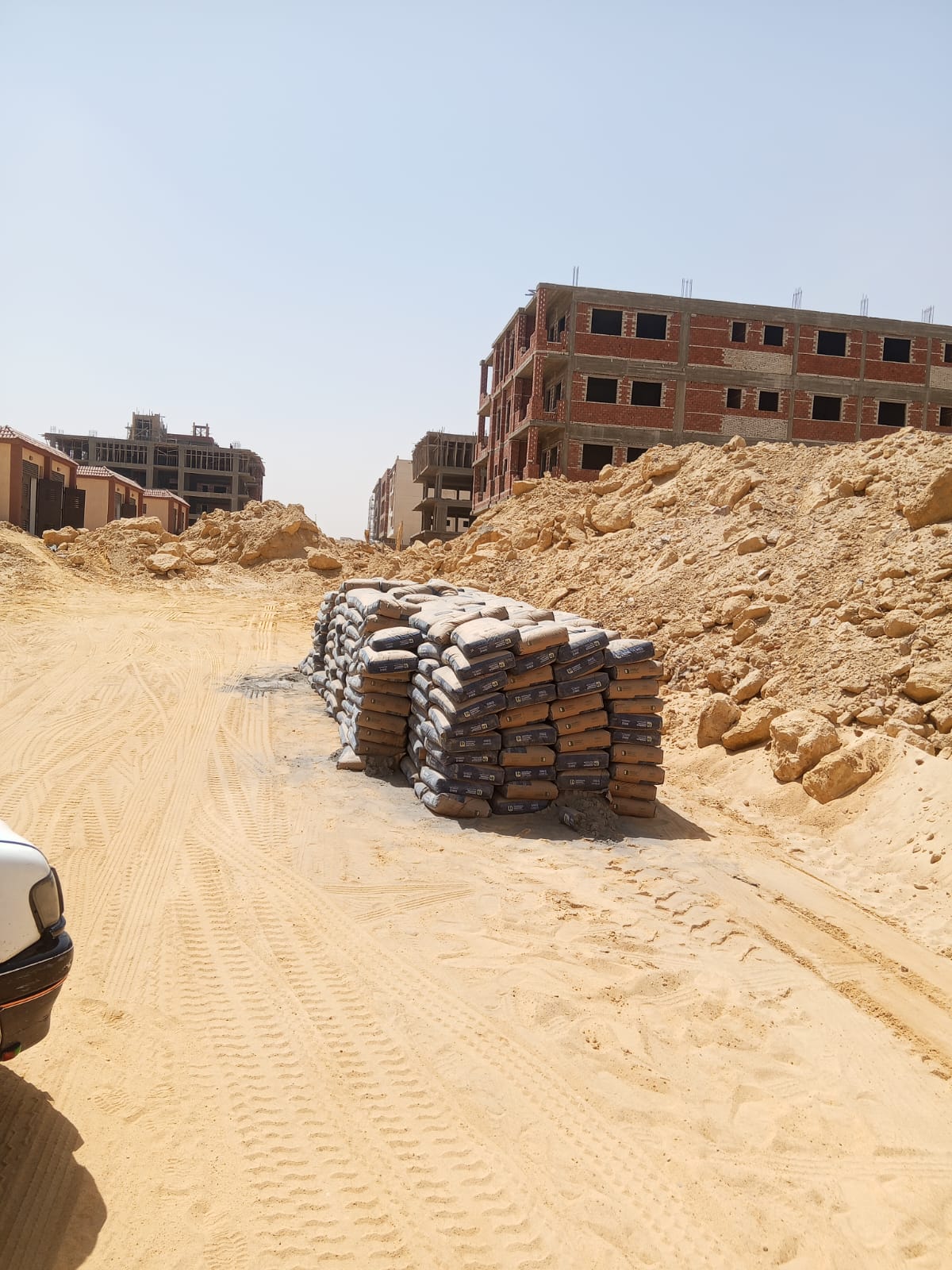

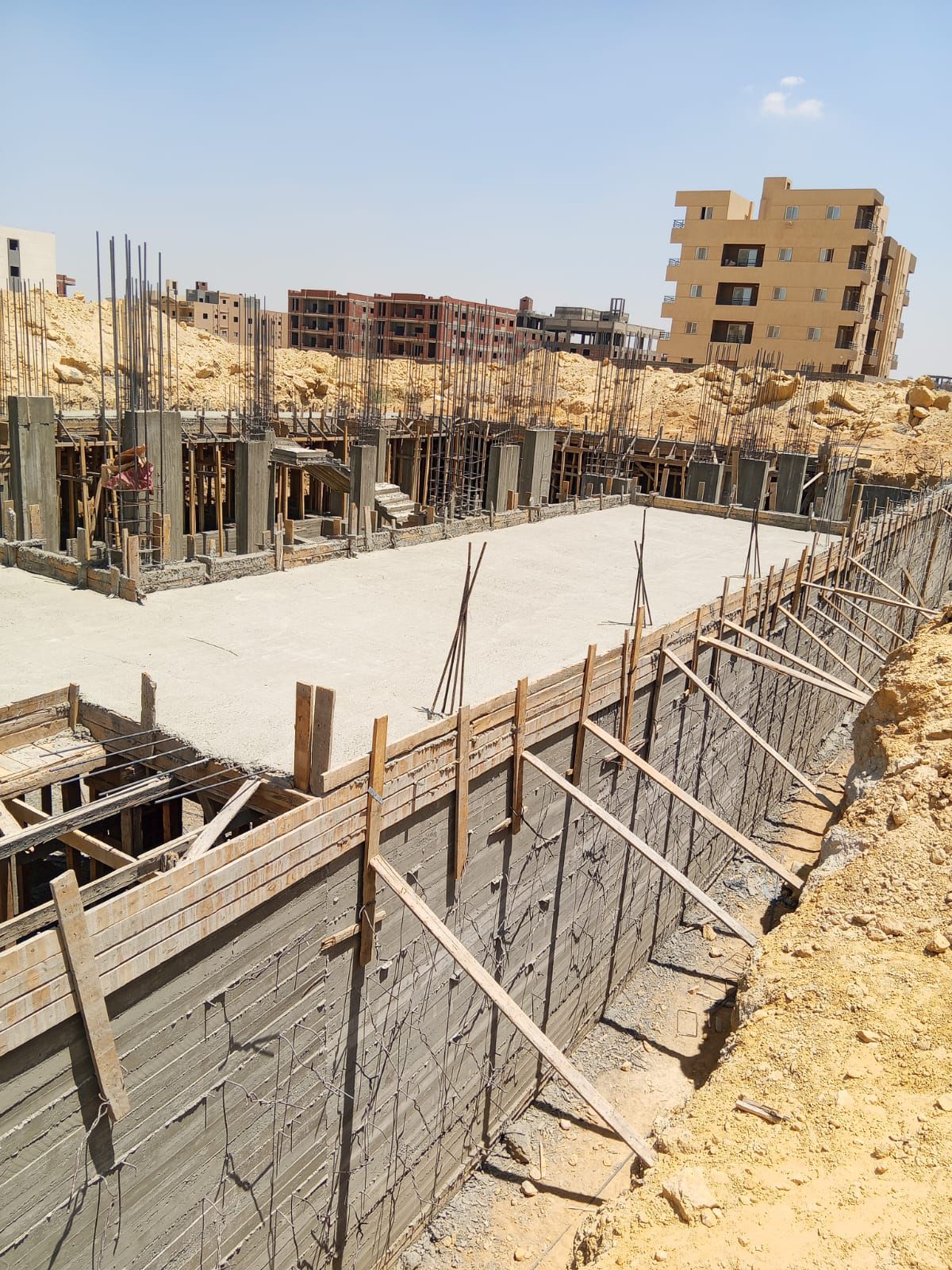

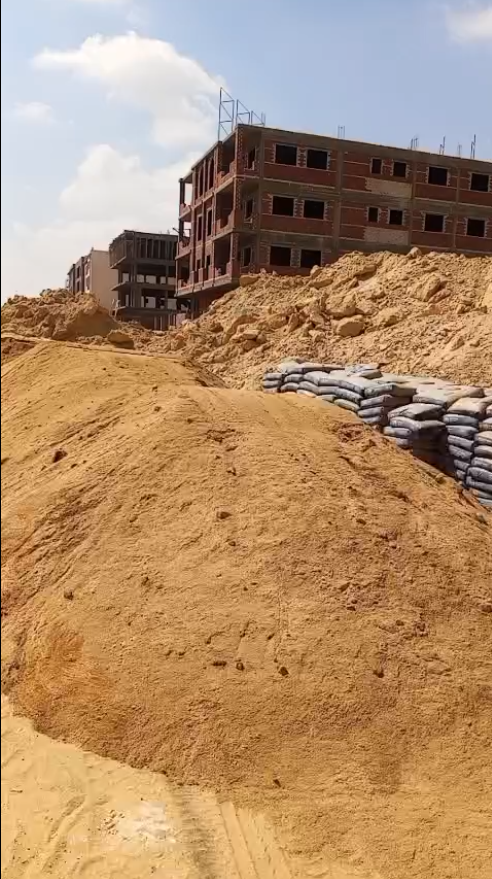

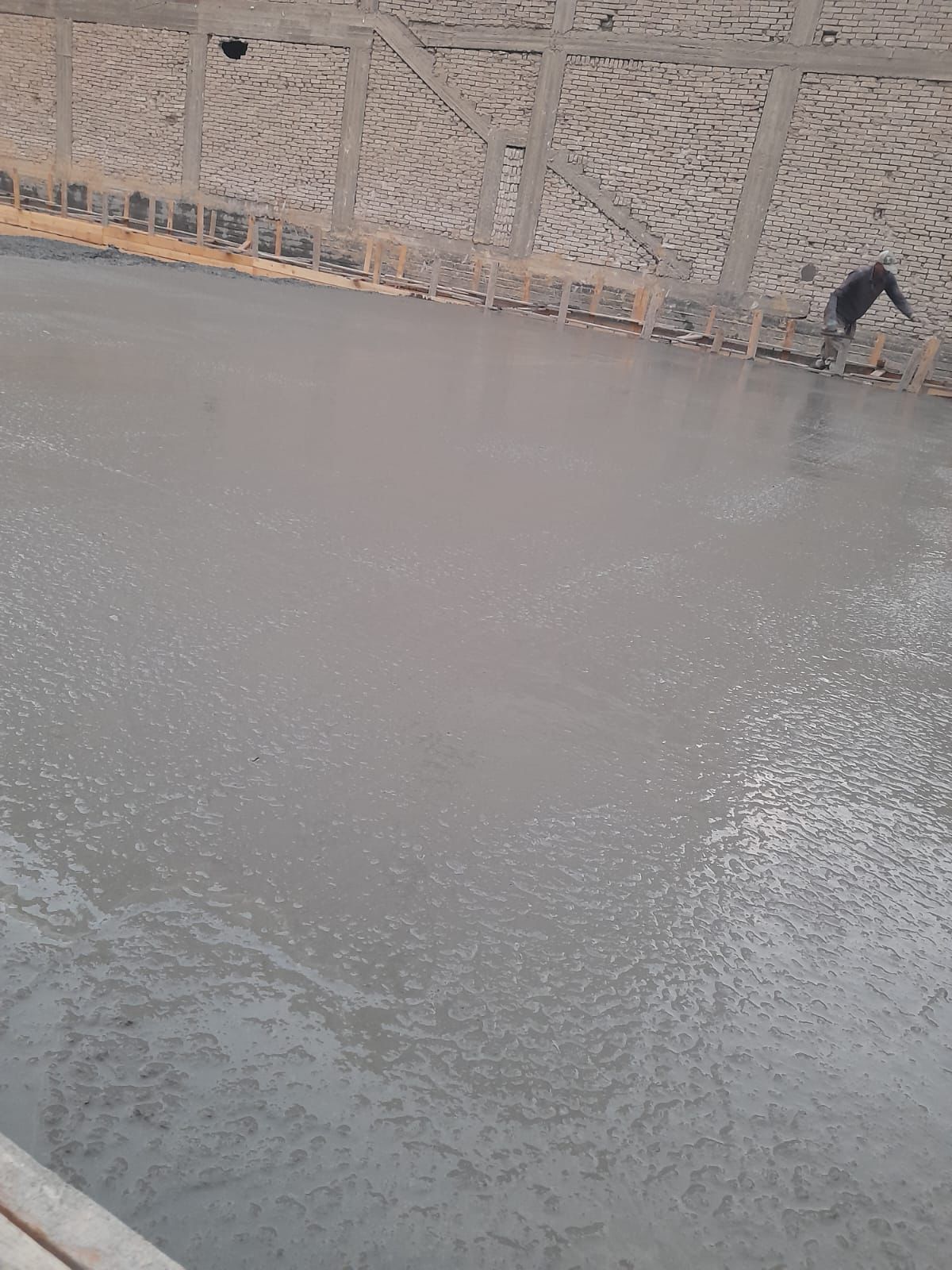

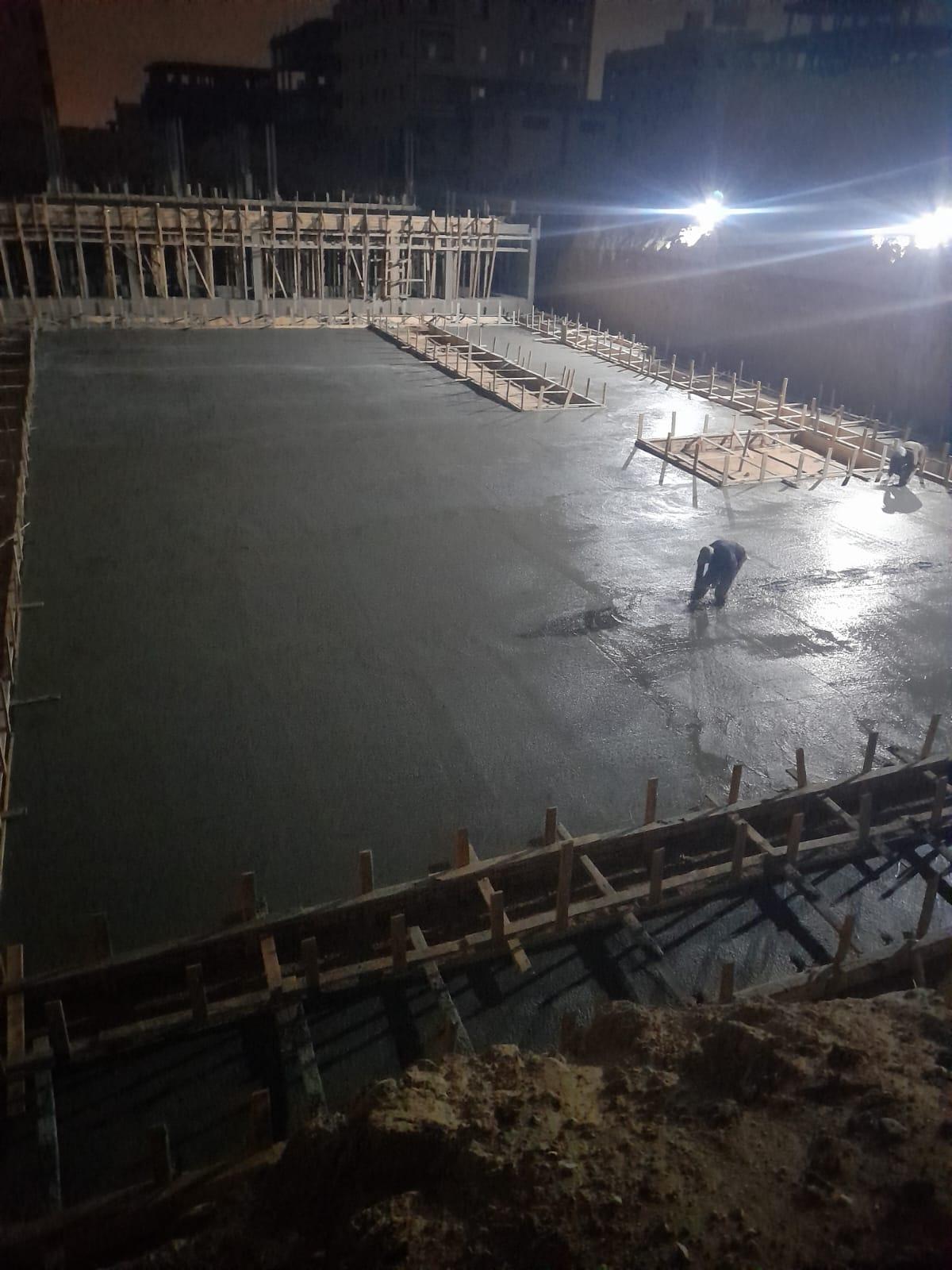

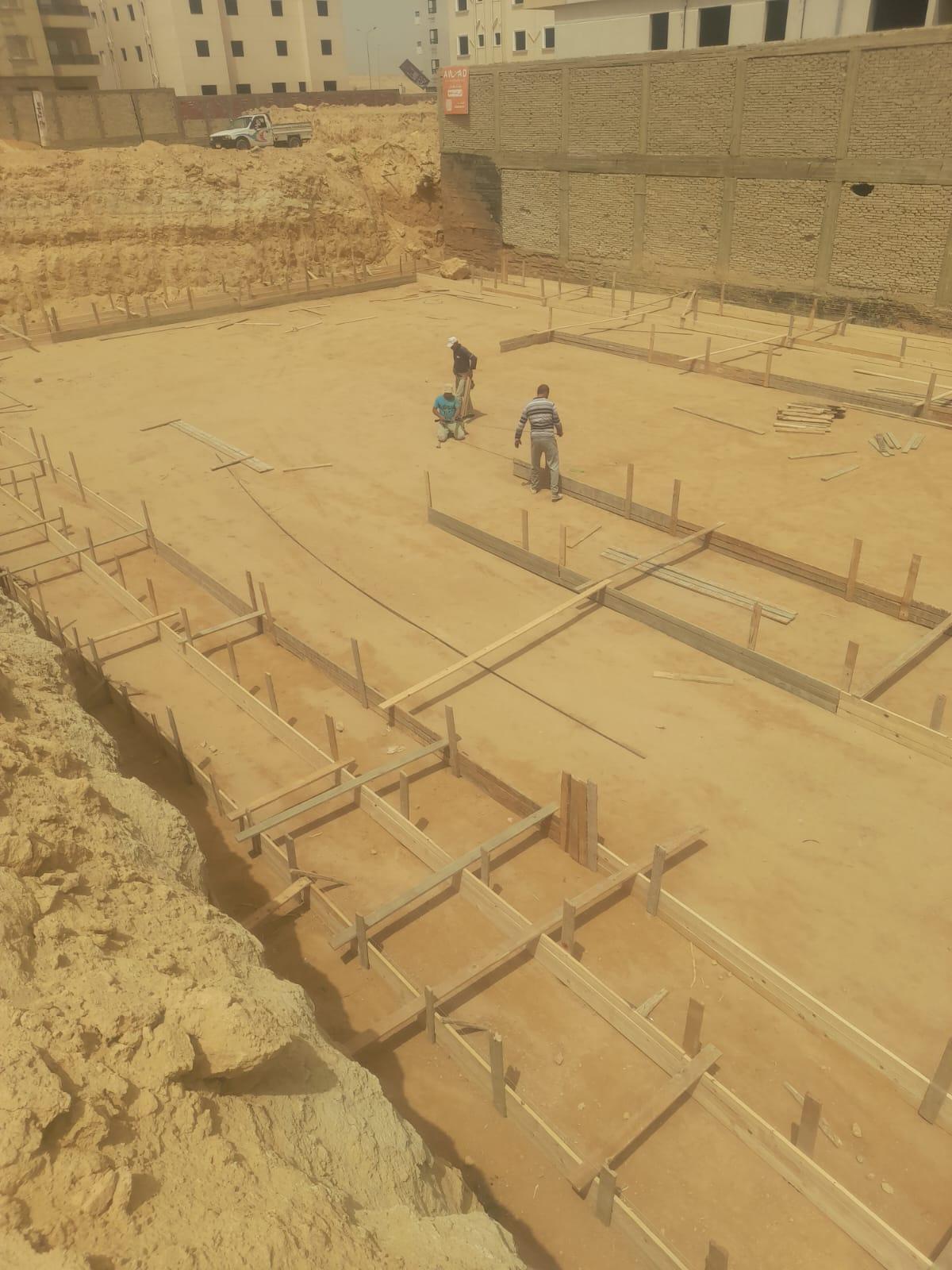

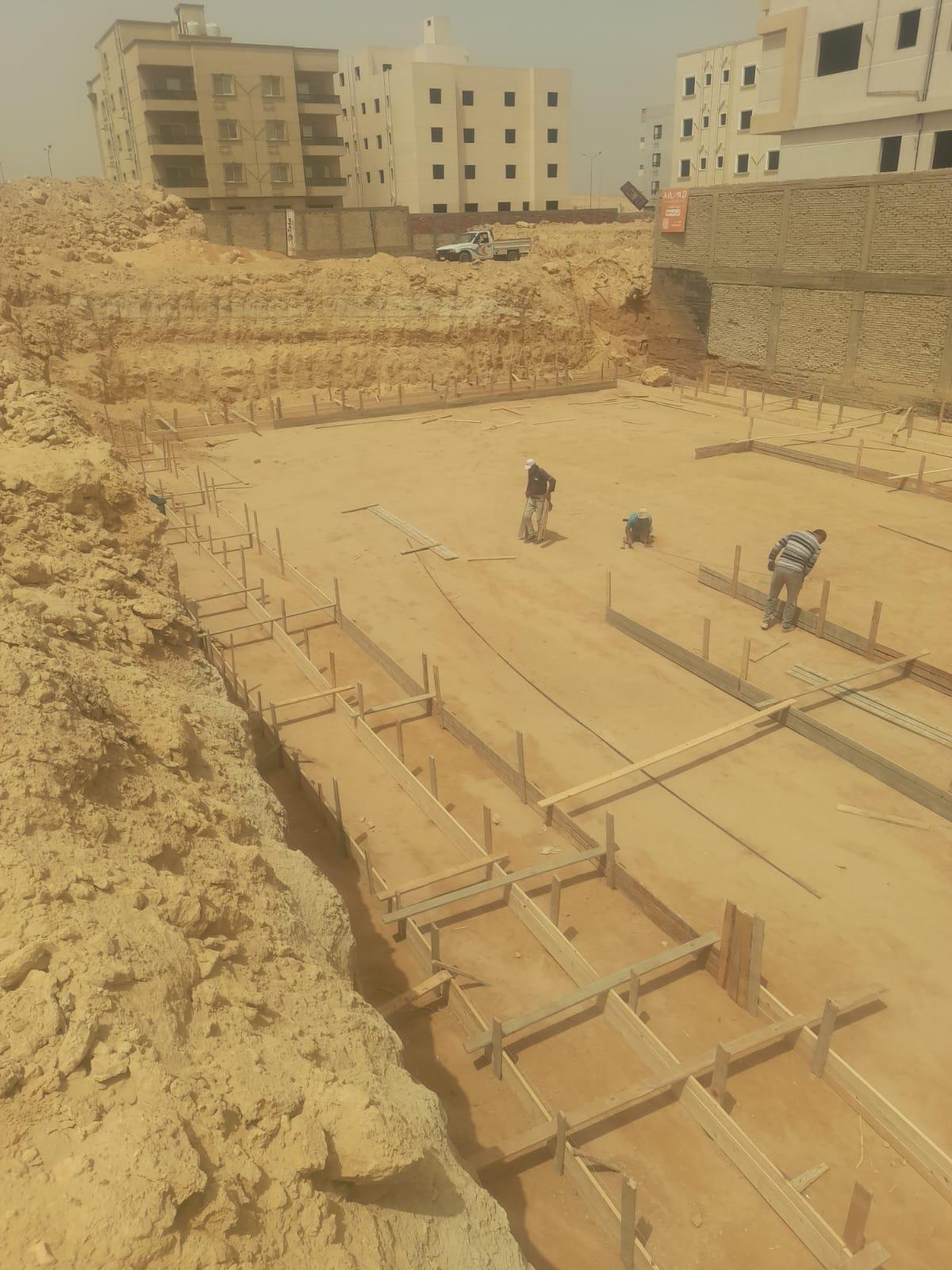

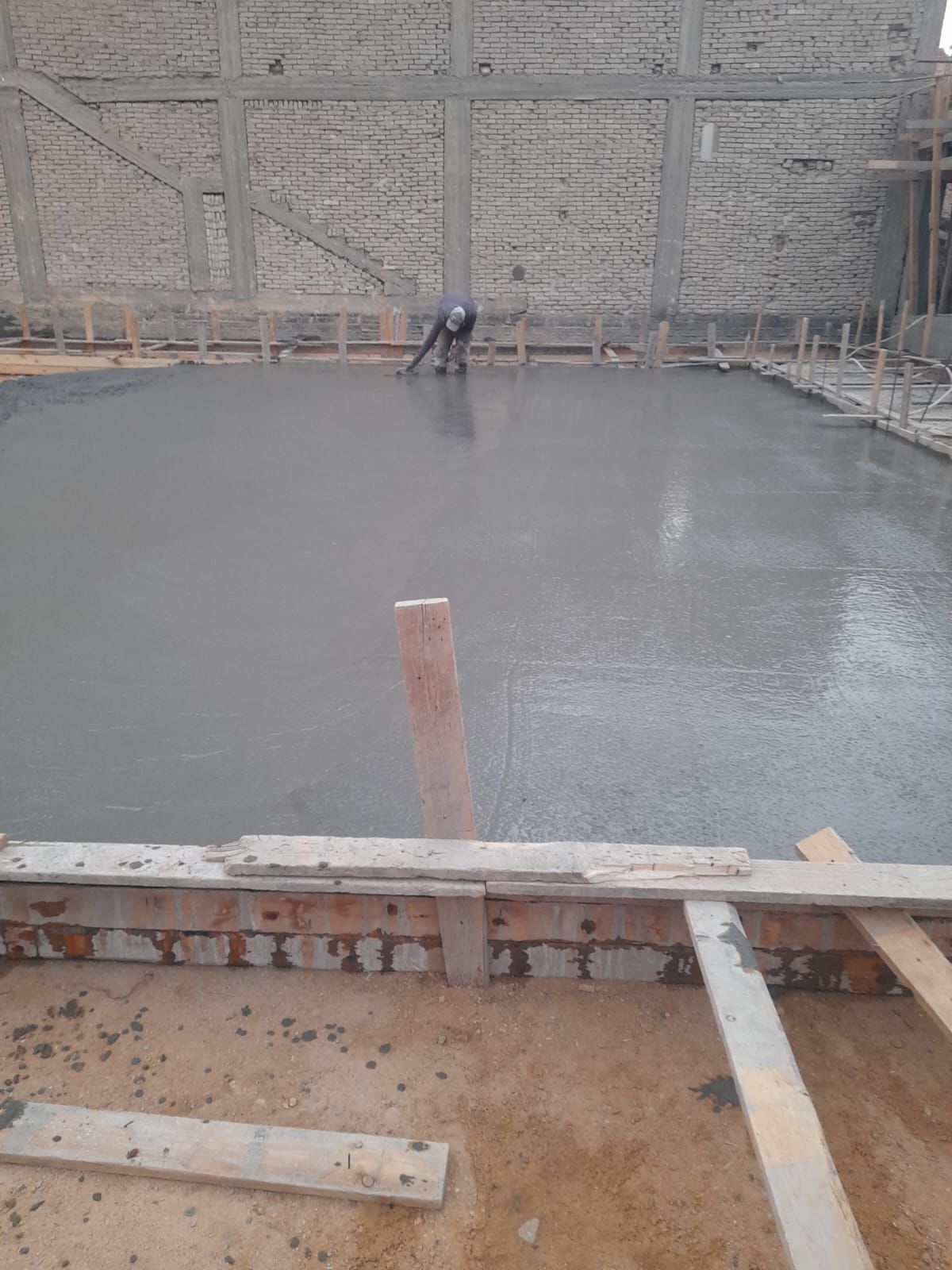

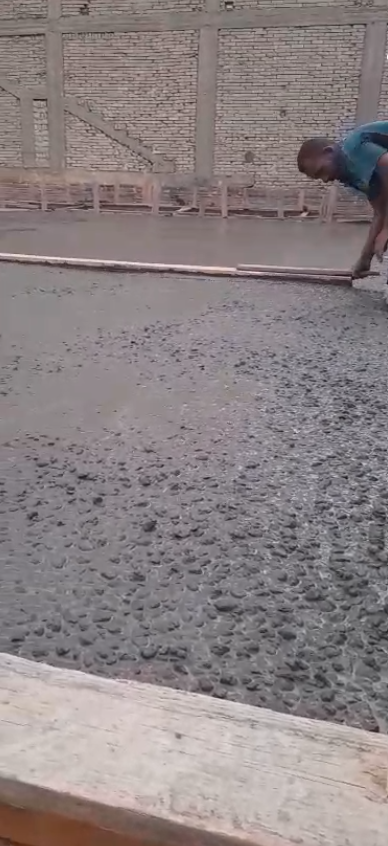

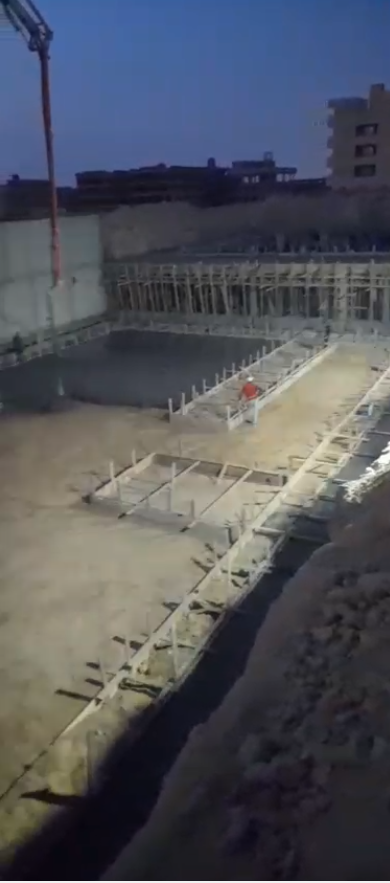

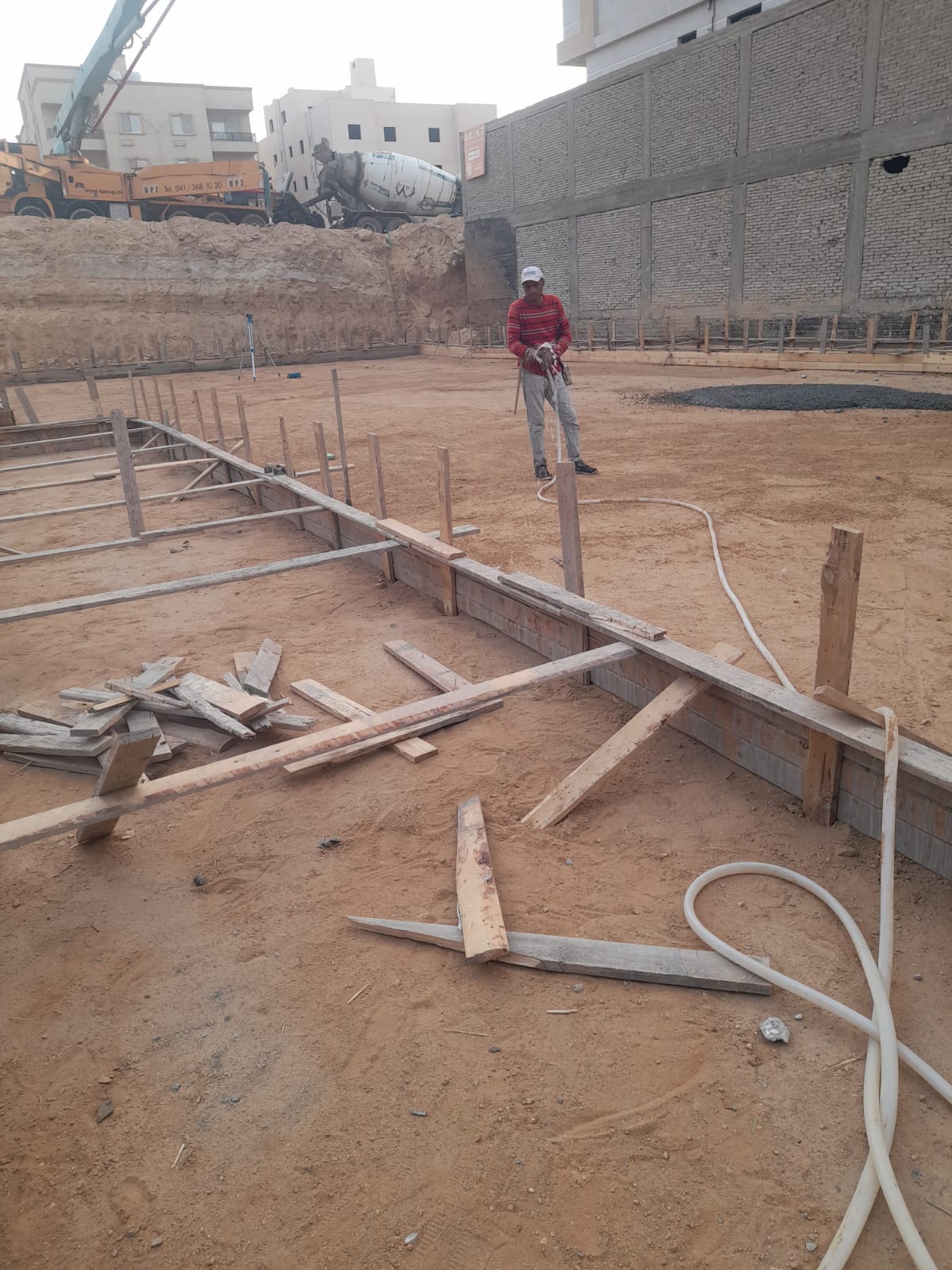

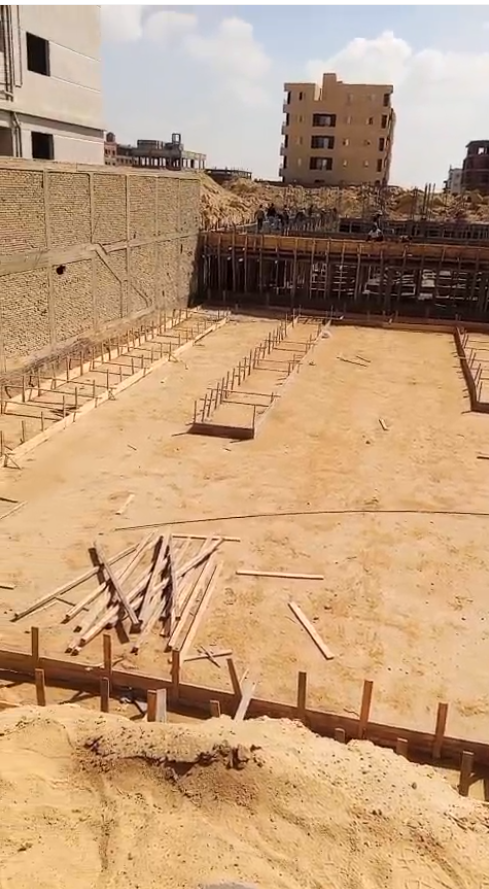

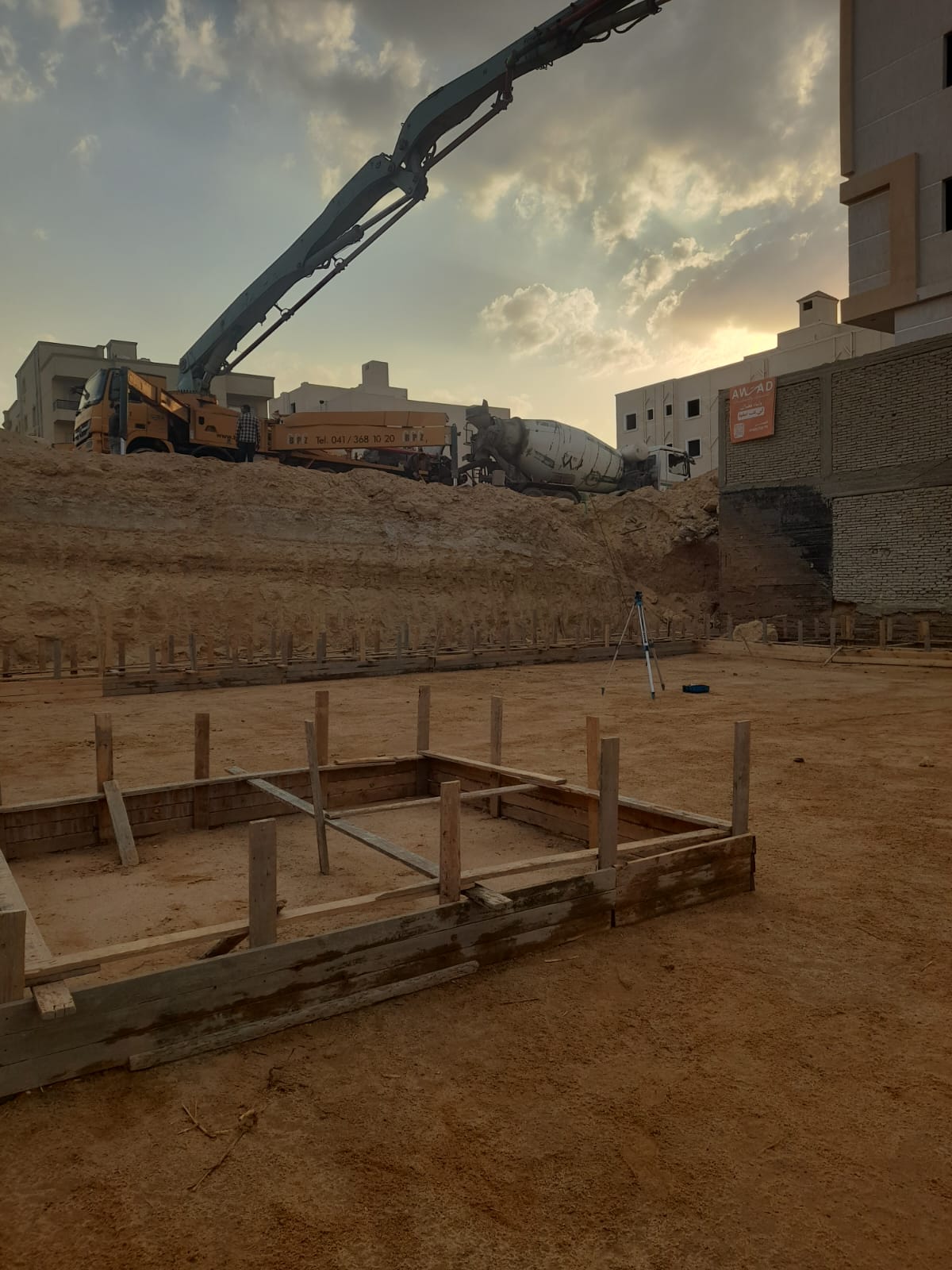

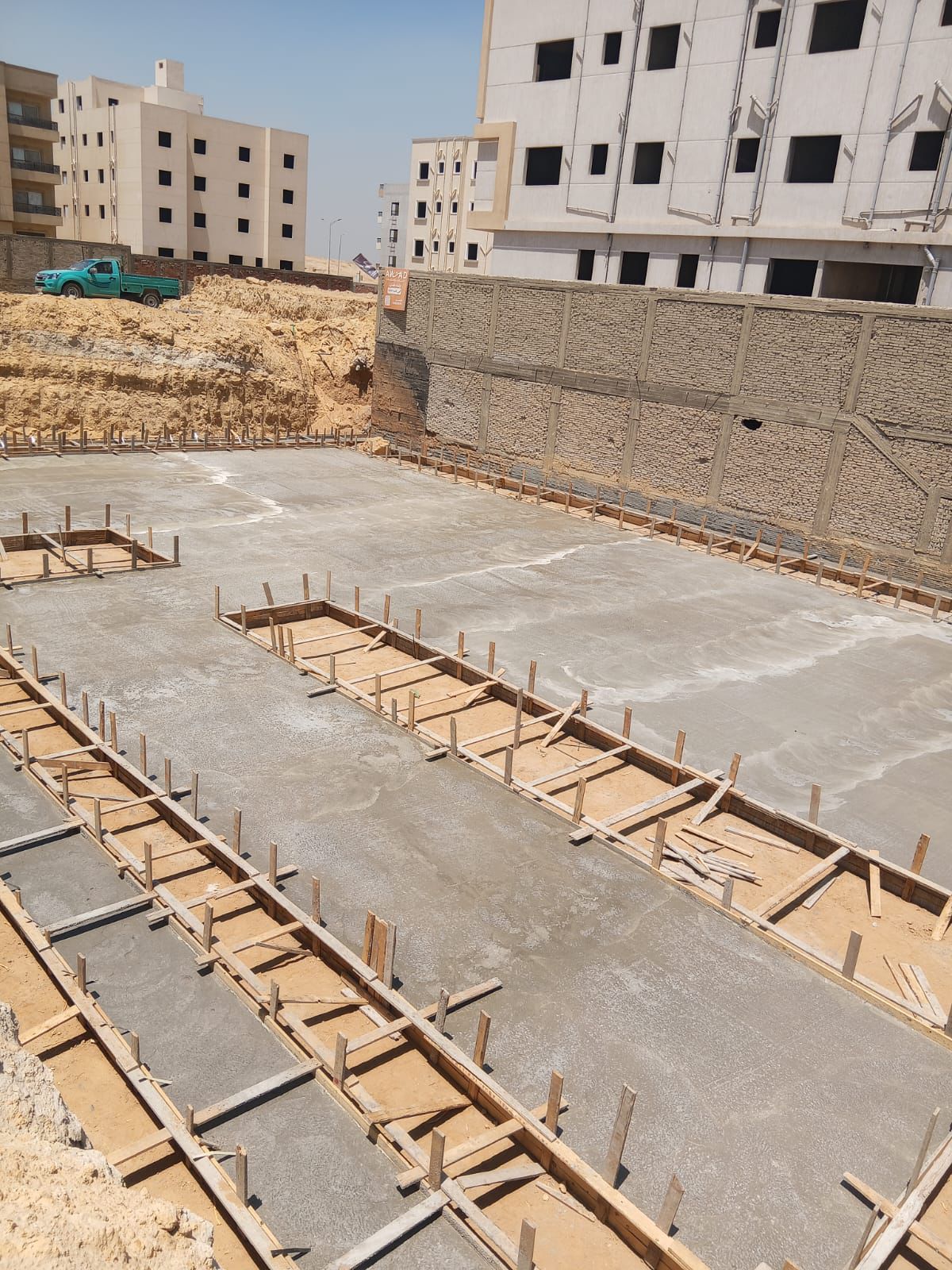

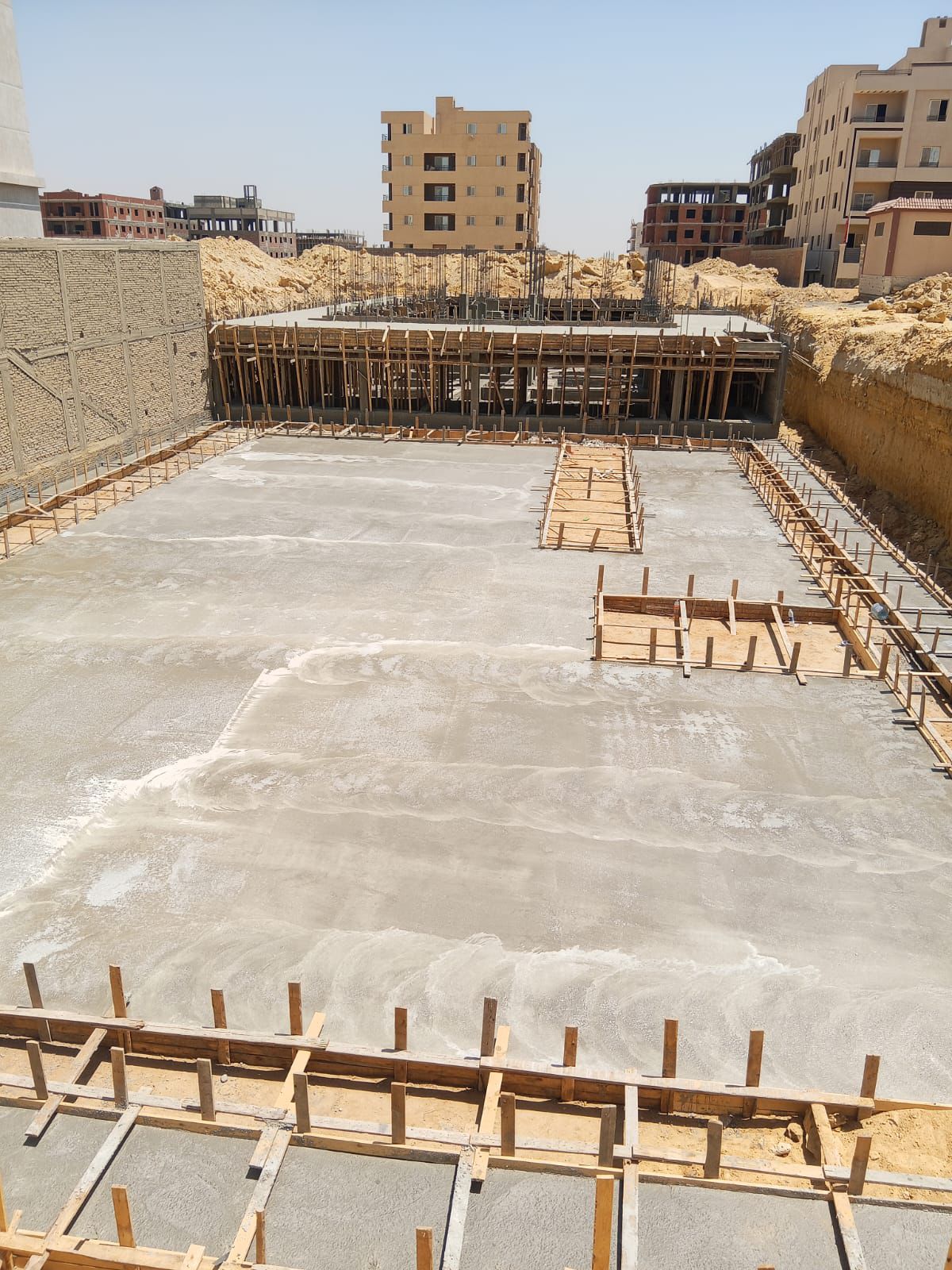

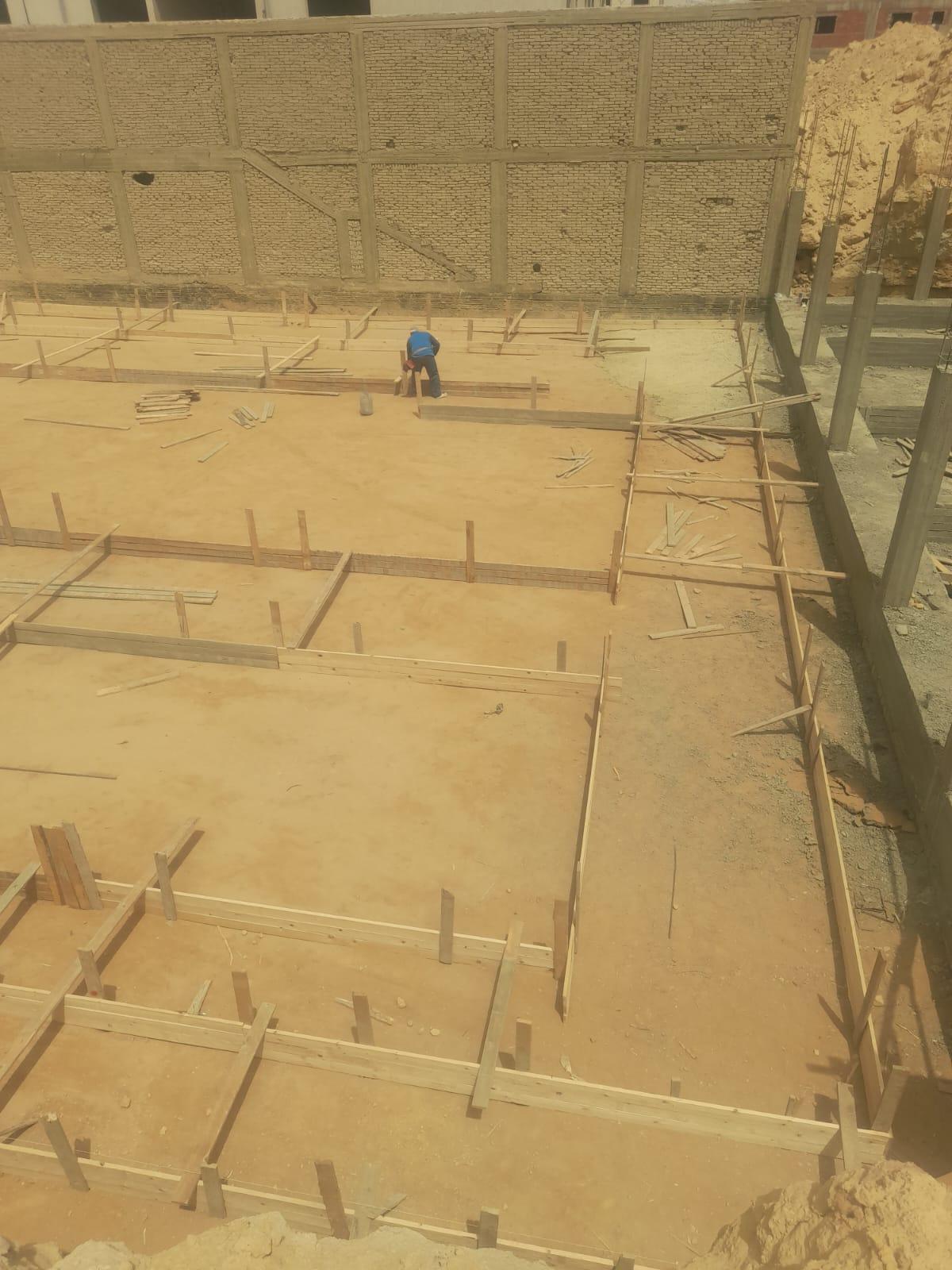

Plain foundations
December 31, 2025
Reinforced concrete
December 31, 2025
Basement columns
January 30, 2026
Basement slab
April 20, 2026
Ground floor columns
April 20, 2026
Ground floor slab
May 5, 2026
Footings insulation
June 4, 2026
Backfilling over footings
June 4, 2026
First floor columns
June 19, 2026
First floor slab
July 4, 2026
Second floor columns
August 3, 2026
Second floor slab
August 18, 2026
Receiving third-floor extension license
August 21, 2026
Third floor columns
September 17, 2026
Third floor slab
October 2, 2026
Roof extension license
October 4, 2026
Roof room columns
November 1, 2026
Roof room slab
November 16, 2026
Swimming pool
November 16, 2026
Basement walls
December 16, 2026
Ground floor walls
January 15, 2027
First floor walls
February 9, 2027
Second floor walls
March 6, 2027
Third floor walls
March 31, 2027
Roof walls
April 25, 2027
Wooden door frames
May 20, 2027
Plumbing main works
June 19, 2027
Electrical main works
July 19, 2027
Plaster and putty
August 8, 2027
Marble works
October 7, 2027
Electrical finishing
October 27, 2027
Aluminum & glass works (Krital)
October 27, 2027
Elevator
November 11, 2027
Plumbing finishing
November 11, 2027
Project handover to the authority
January 1, 2028
Utilities meter installation
March 1, 2028
