Project Details
Land Number
J177
Region
BaitWatan, 5th settlement
HOMEi Price
18,500.00 EGP
Neighbour Price
23,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 10% |
| 3 | During Construction | 10% |
| 4 | During Construction | 10% |
| 5 | During Construction | 5% |
| 6 | During Construction | 5% |
| 7 | During Construction | 5% |
| 8 | During Construction | 5% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
216 m²
Delivery
Unit Delivery Date
October 2027
Average Unit Price
2,598,750 EGP
Project Location
Map View
BaitWatan, 5th settlement
HOMEi Timeline
License office contract
September 25, 2025
Submitting the license
October 15, 2025
Mining permit
October 23, 2025
Receiving the license
October 25, 2025

Excavation permit
November 5, 2025
Construction contract in progress
November 23, 2025
Construction contract signed
November 23, 2025

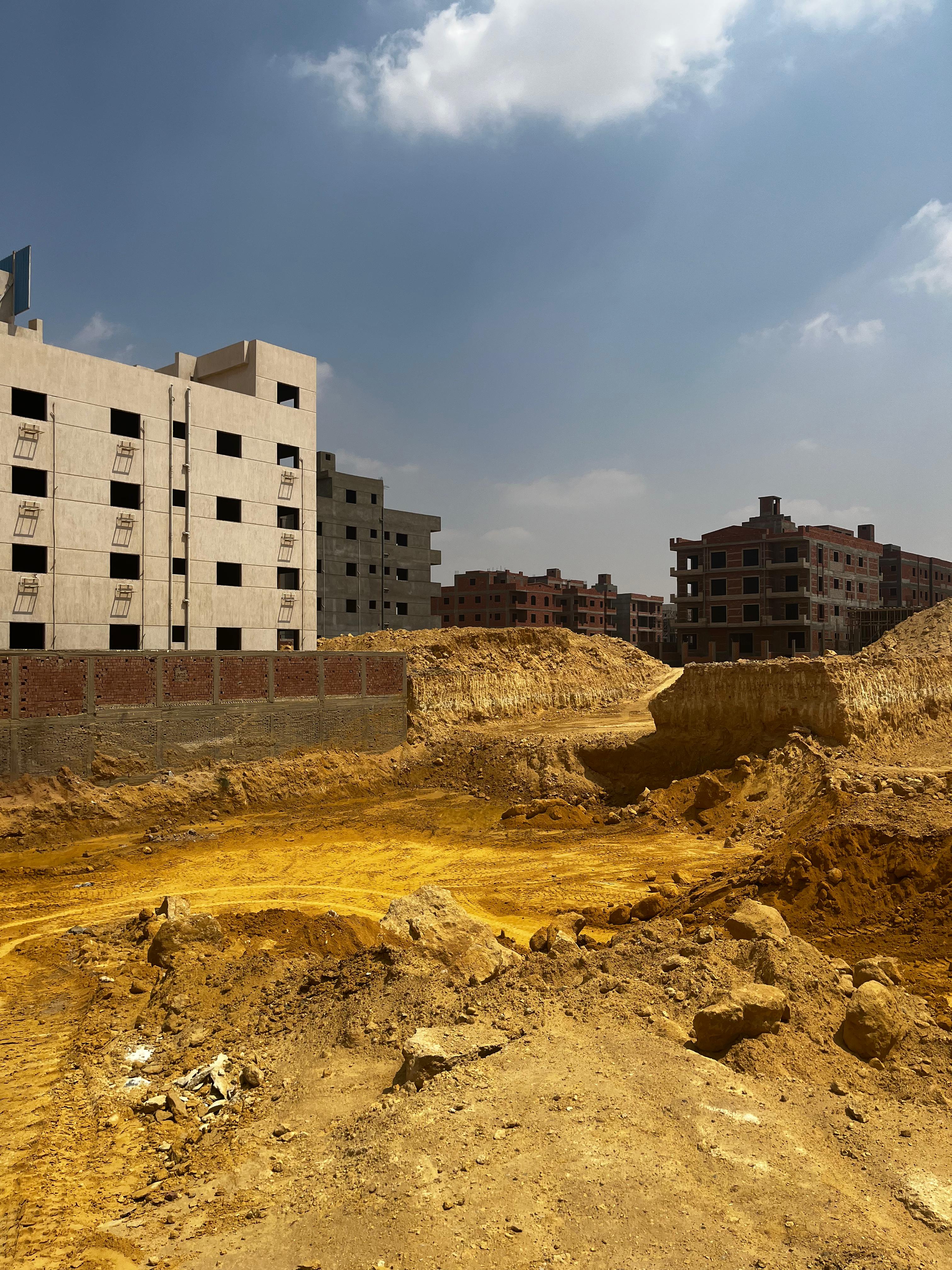

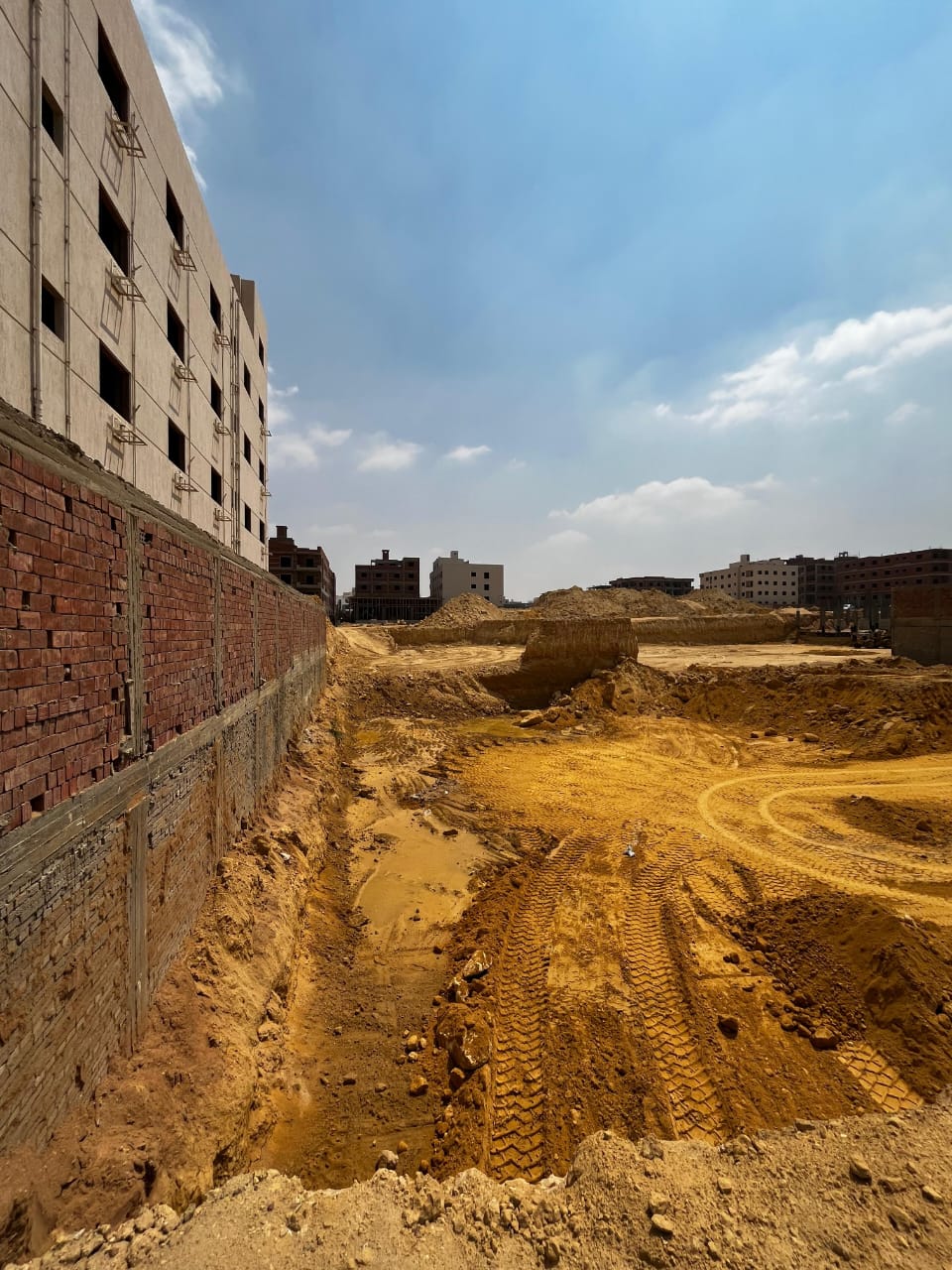

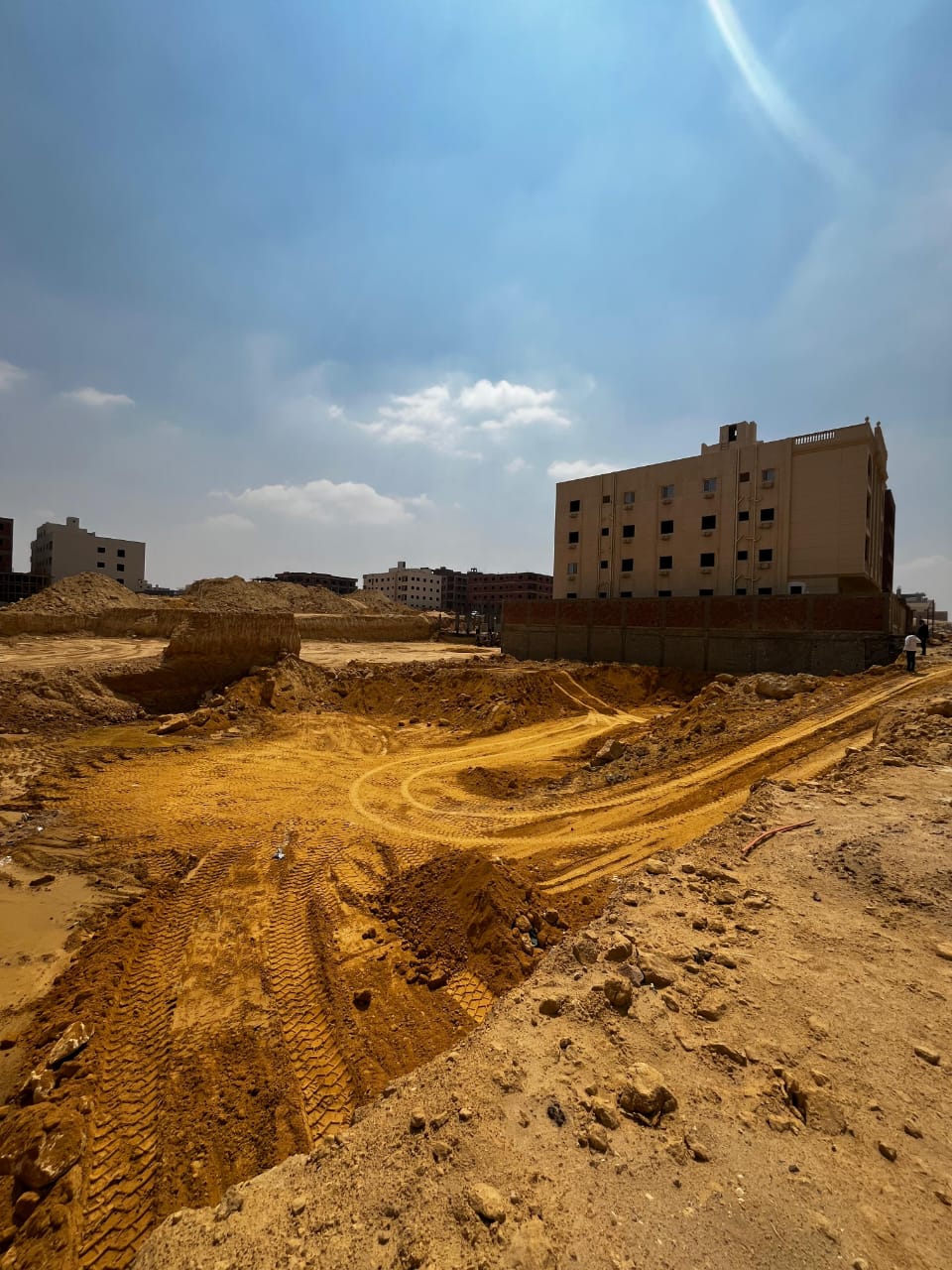

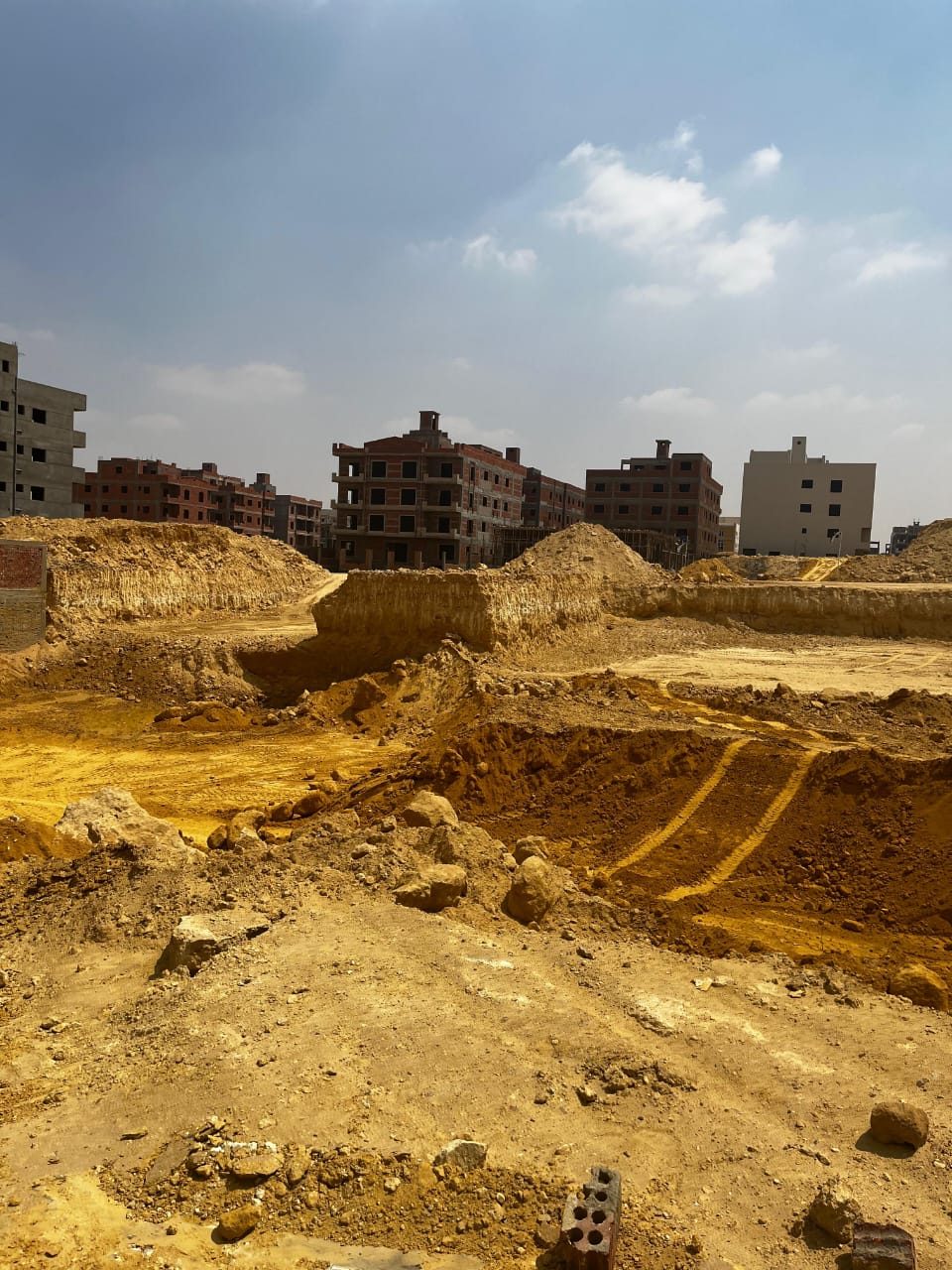

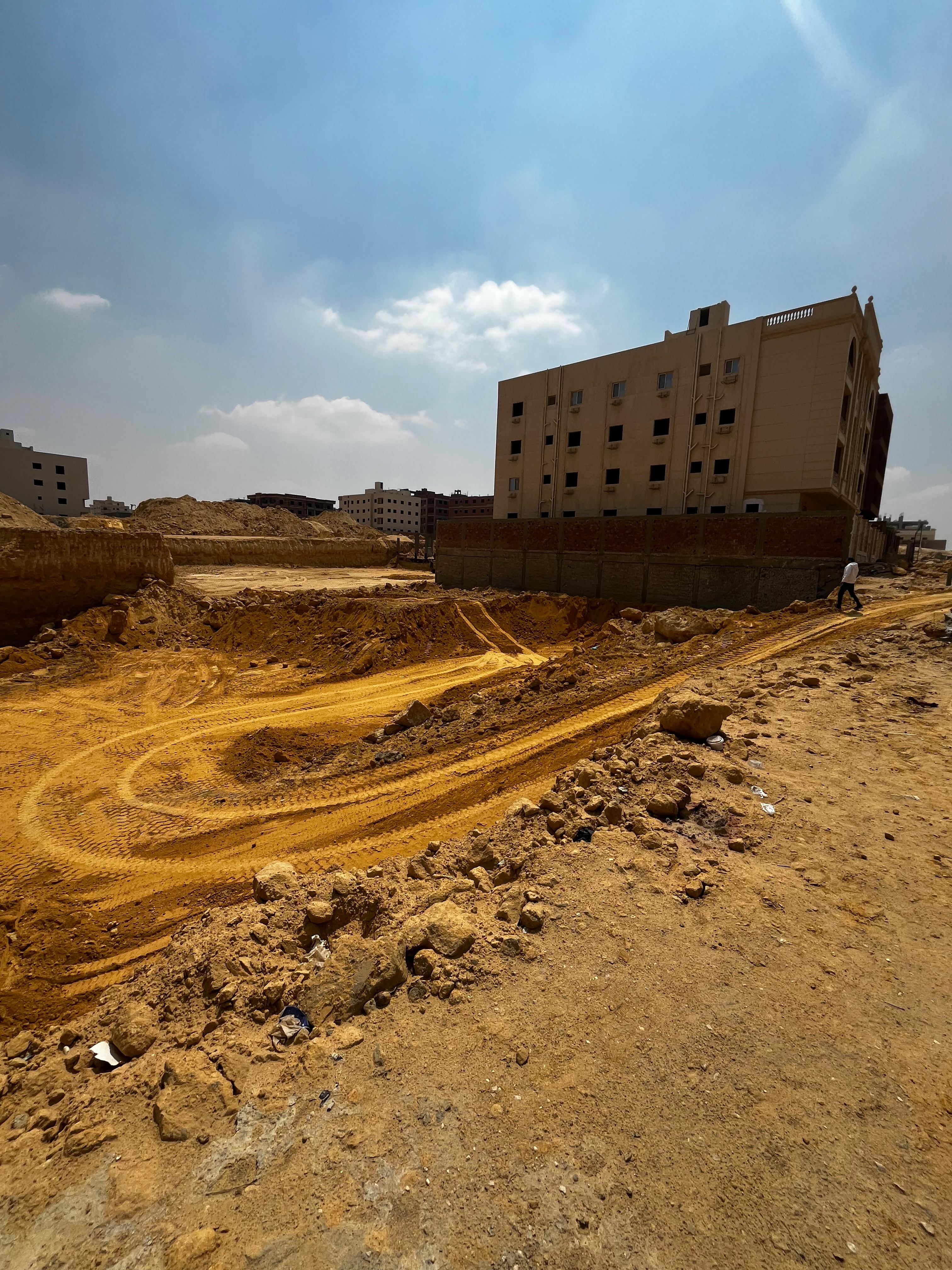

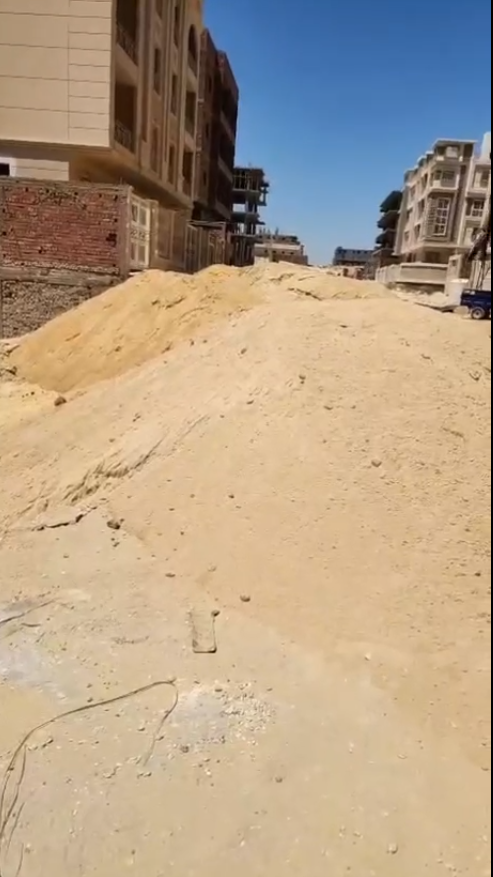

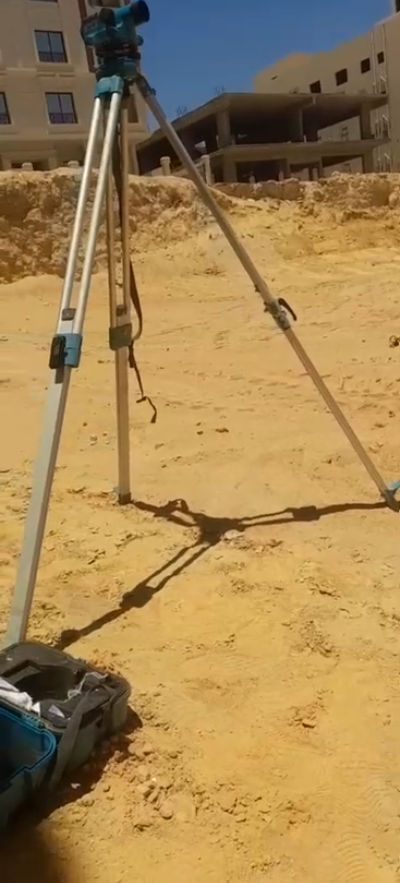

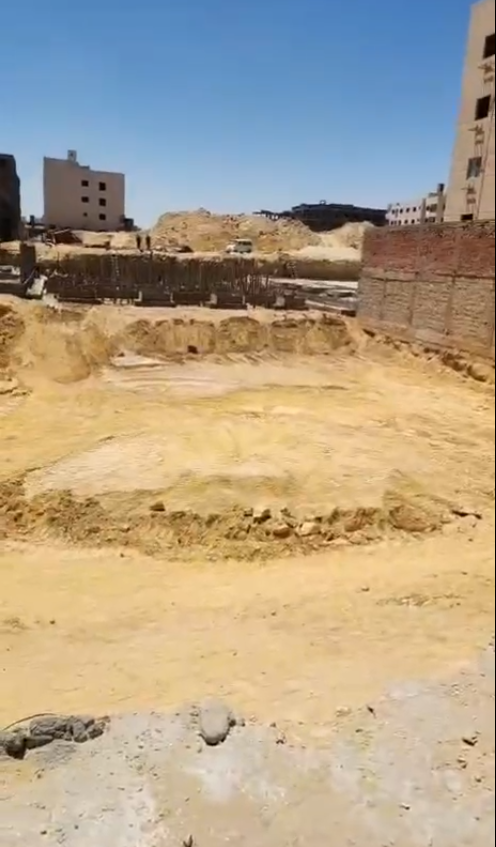

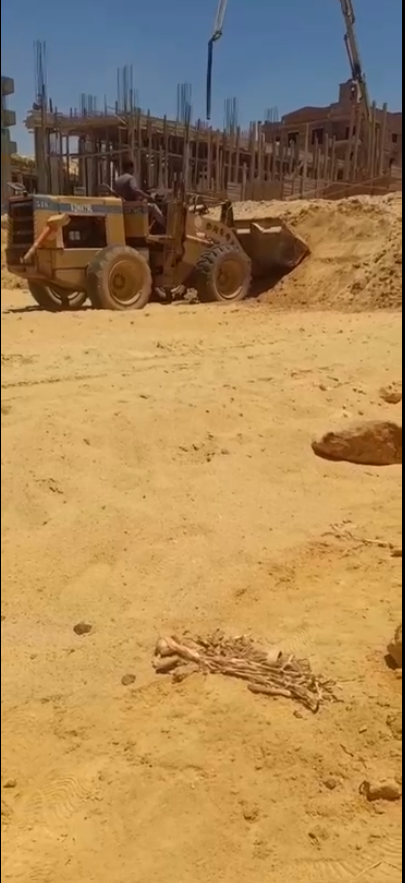

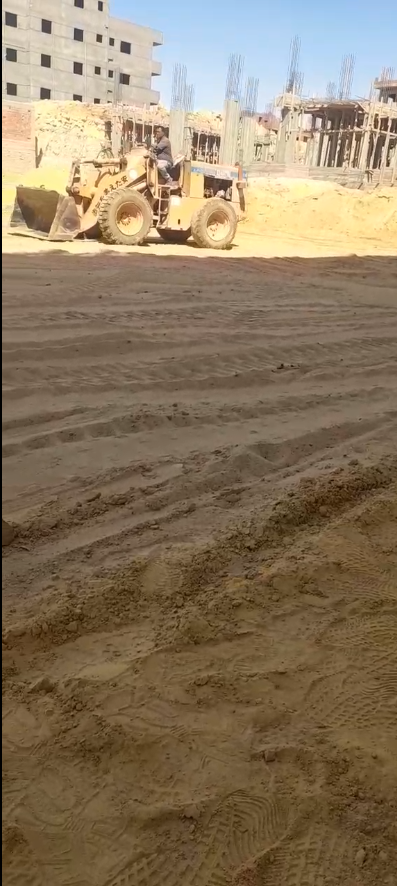

Excavation
November 24, 2025

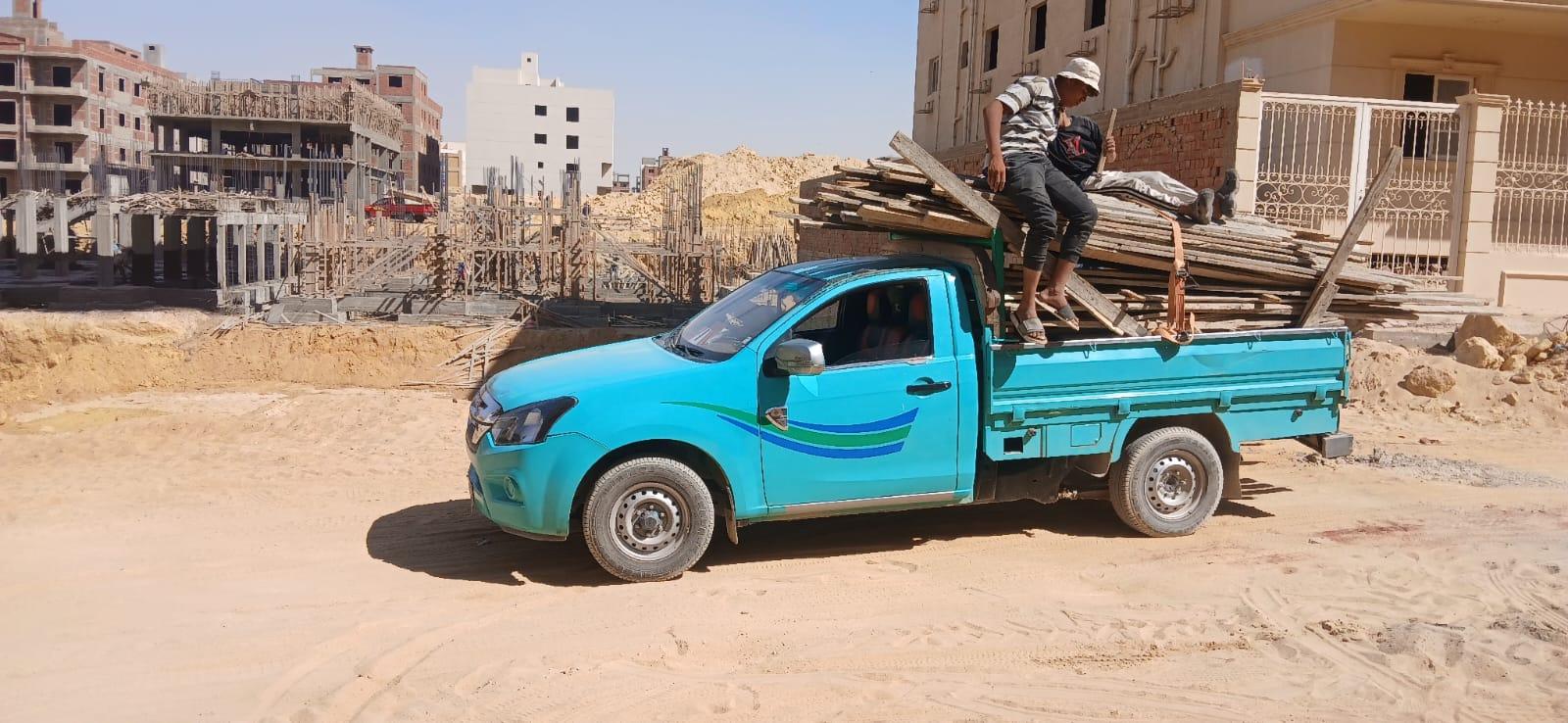

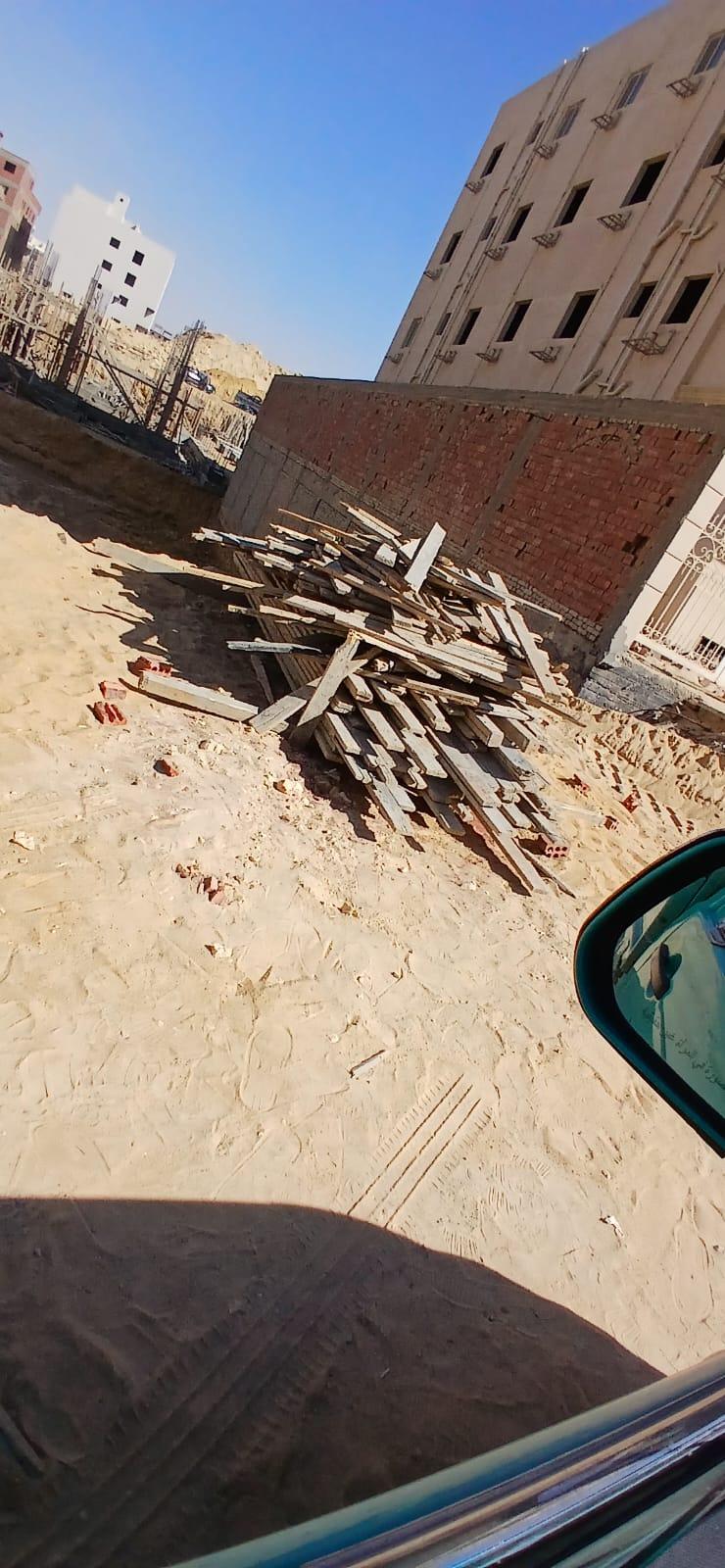

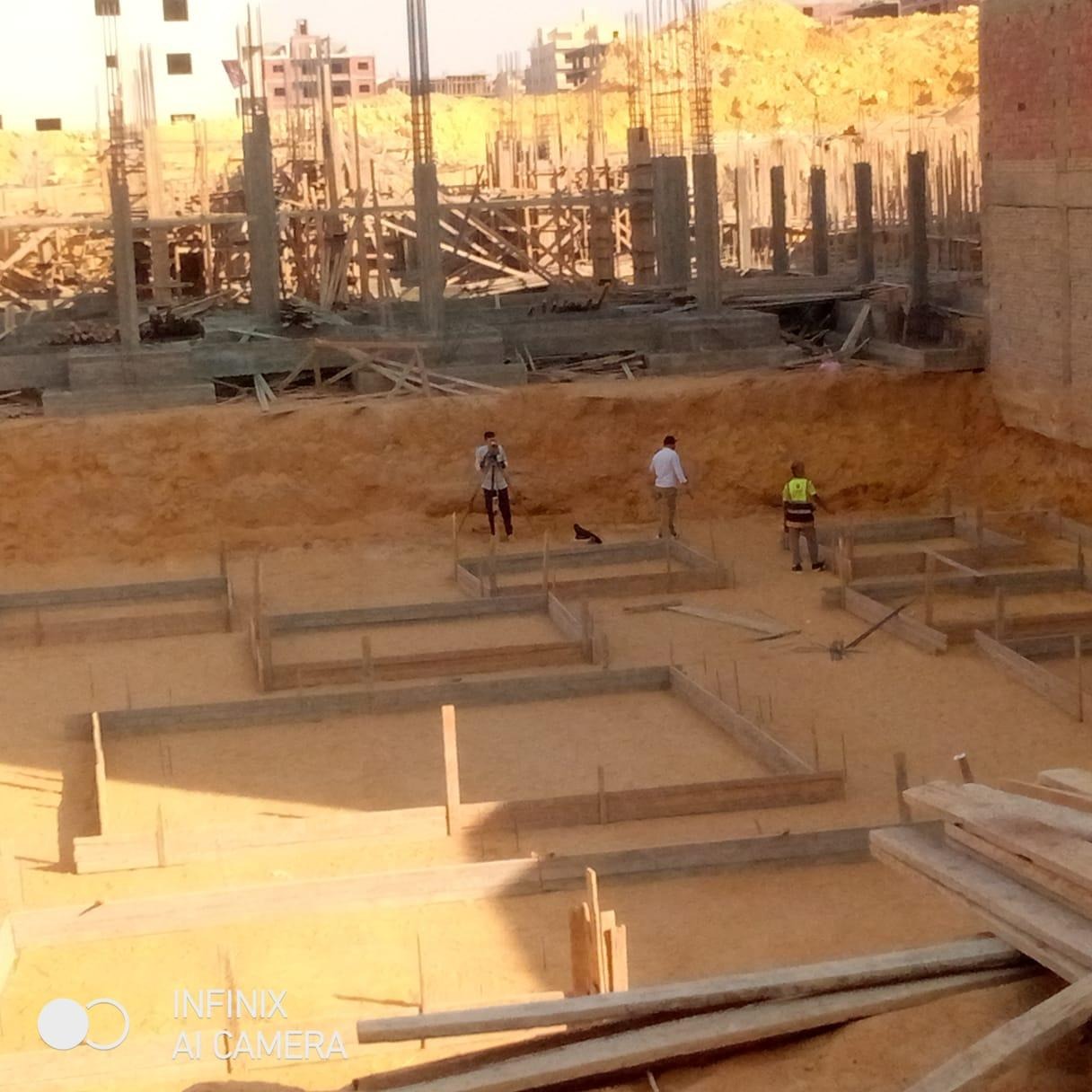

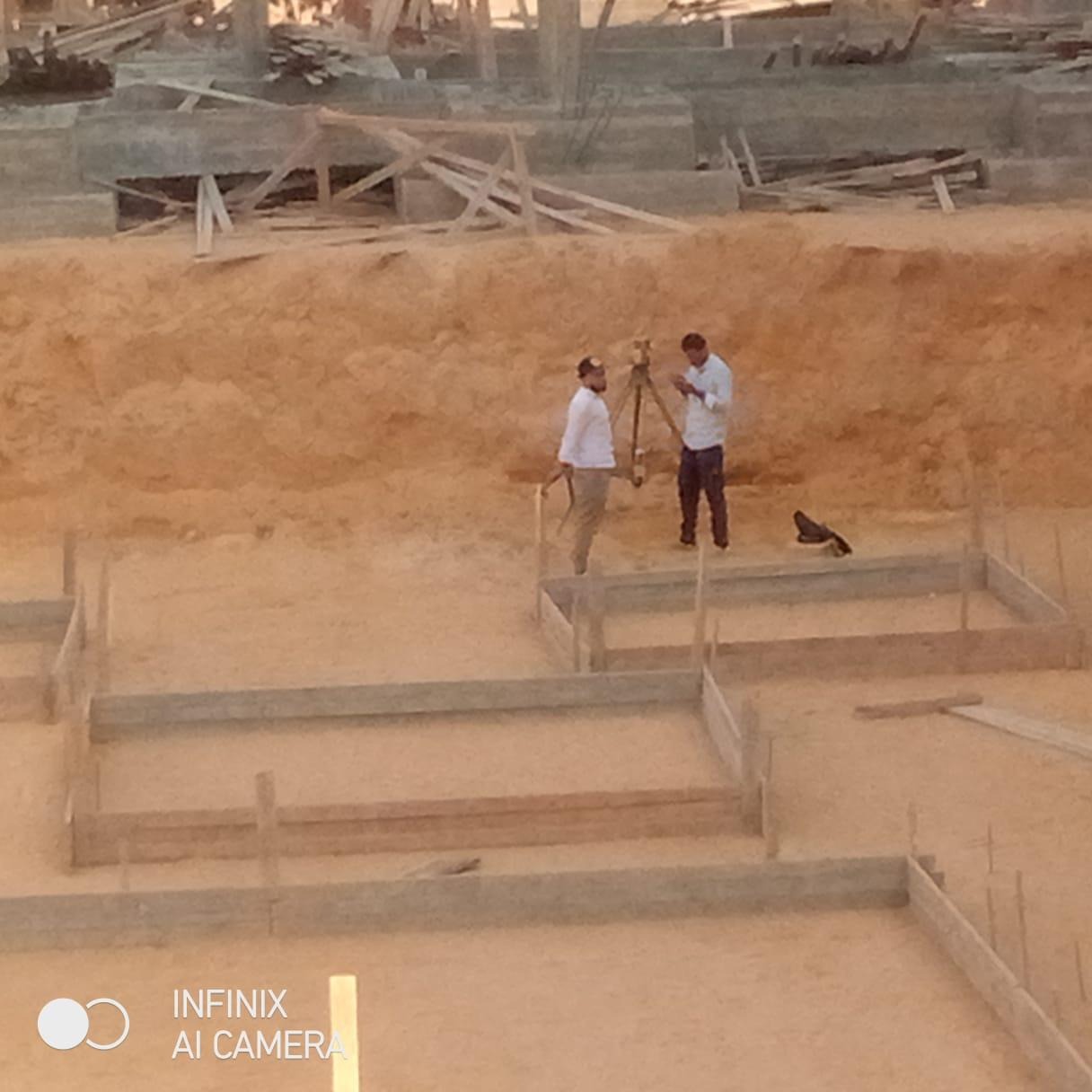

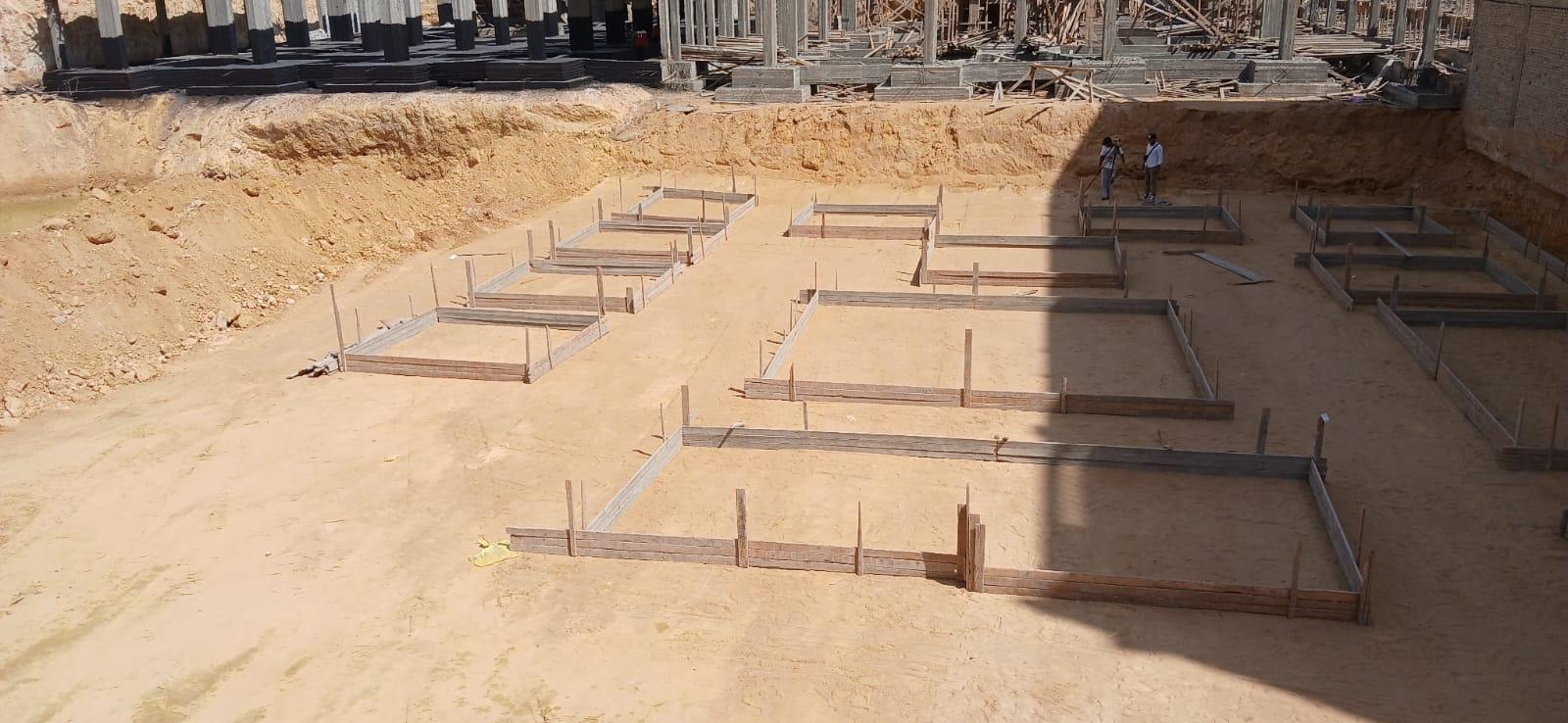

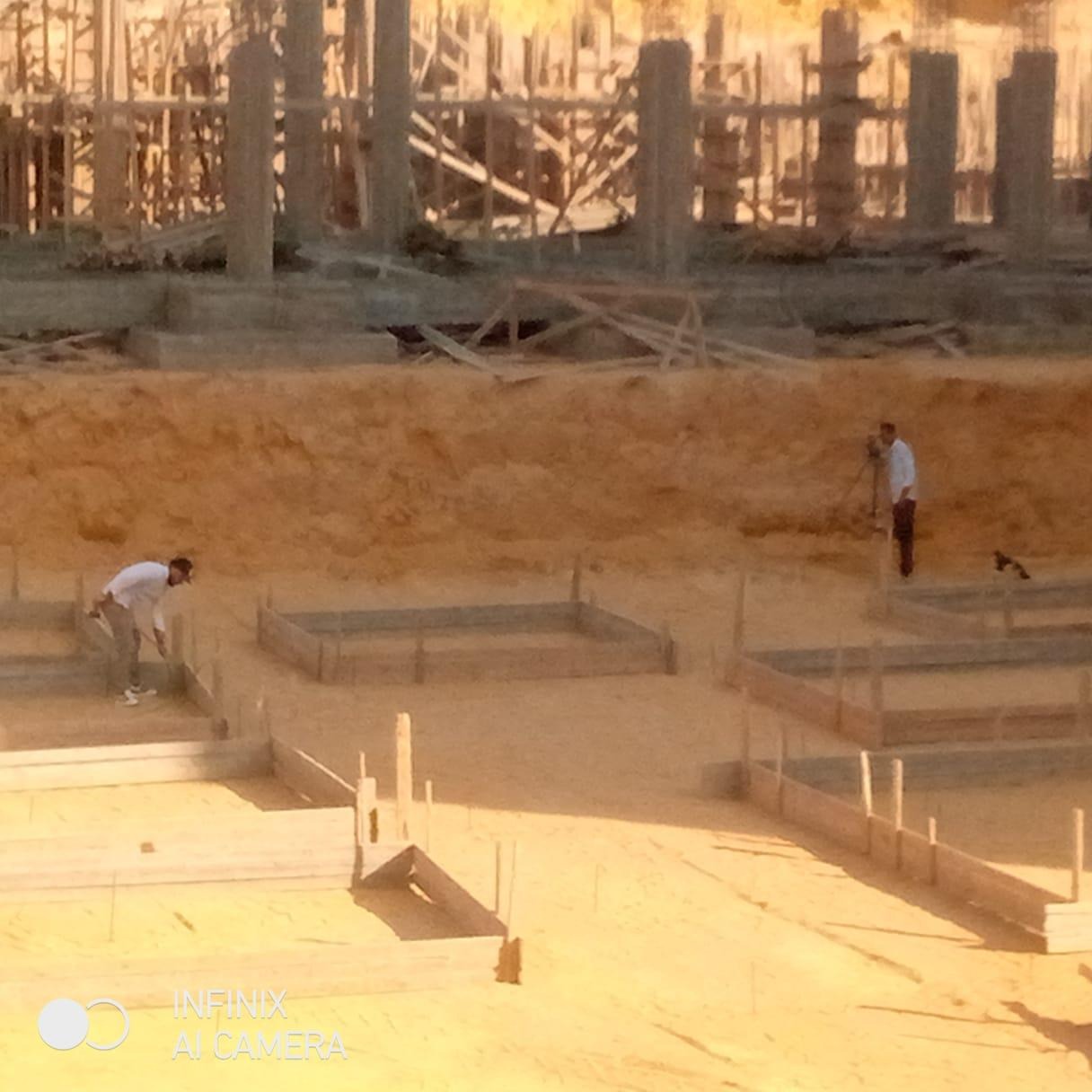

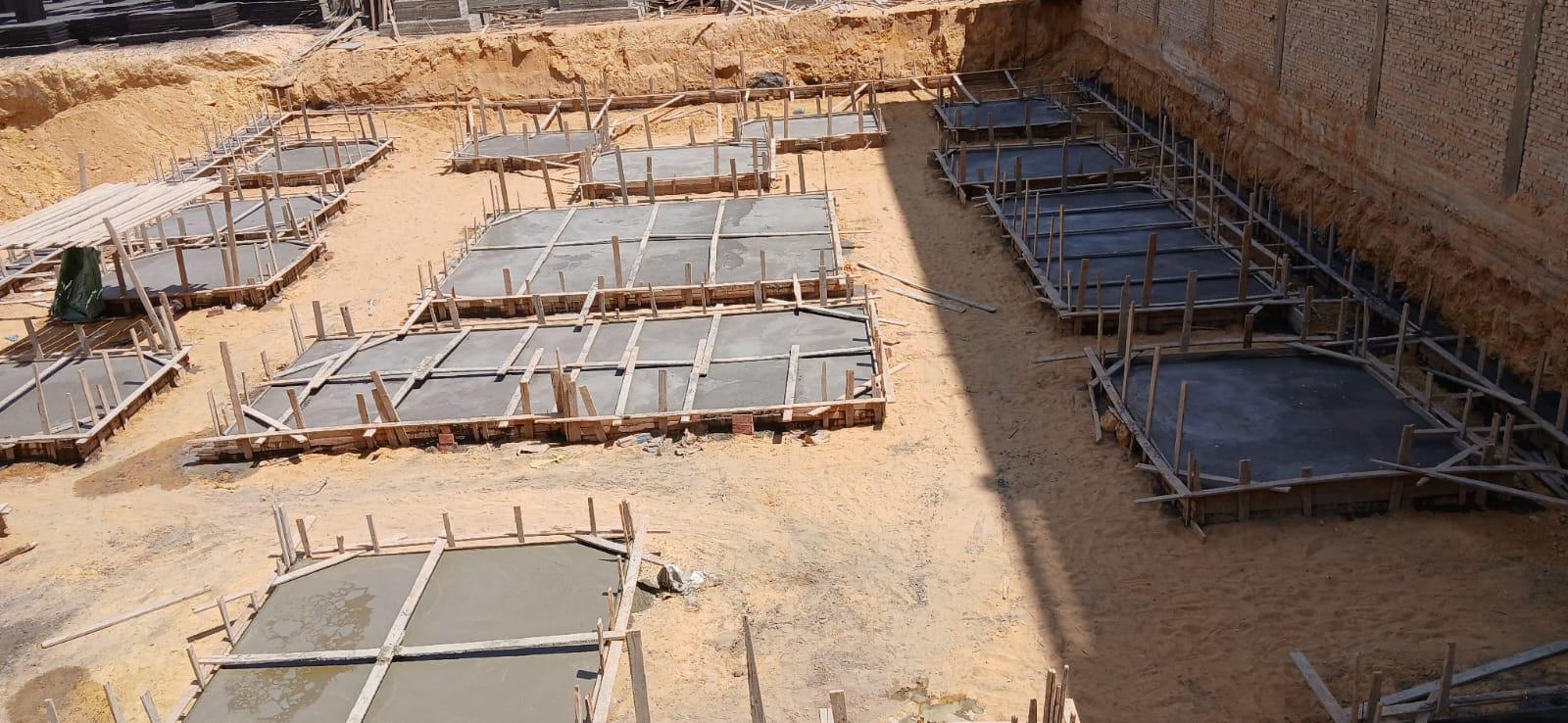

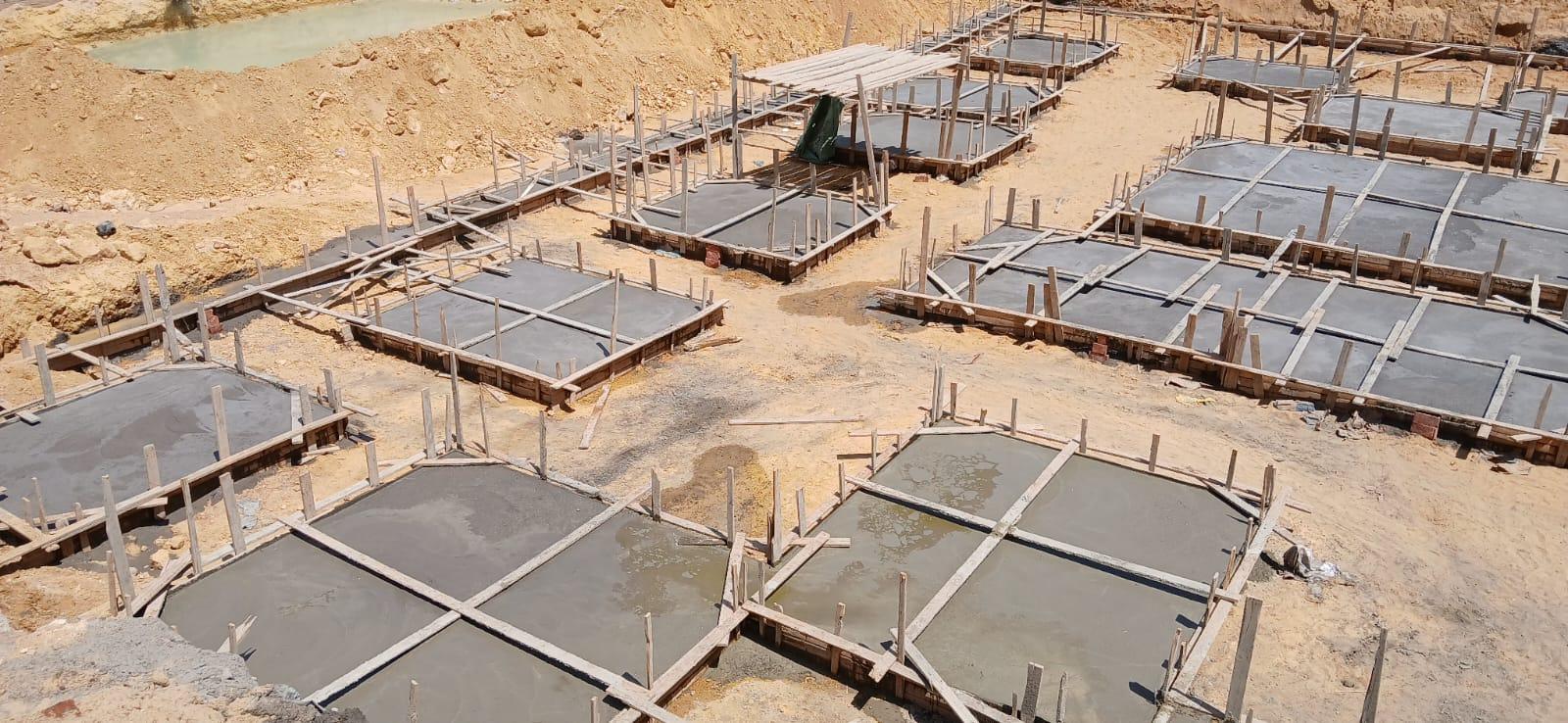

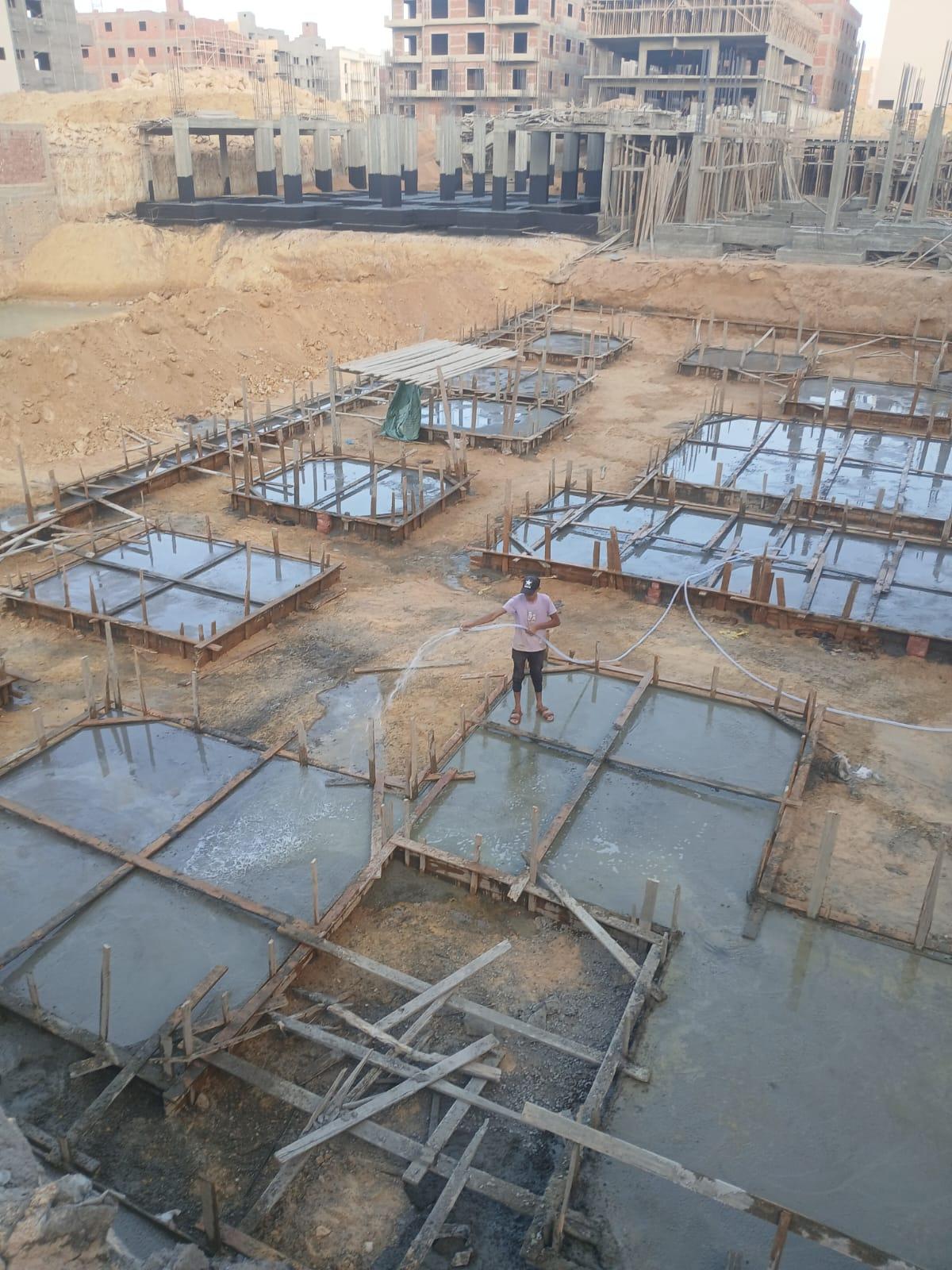

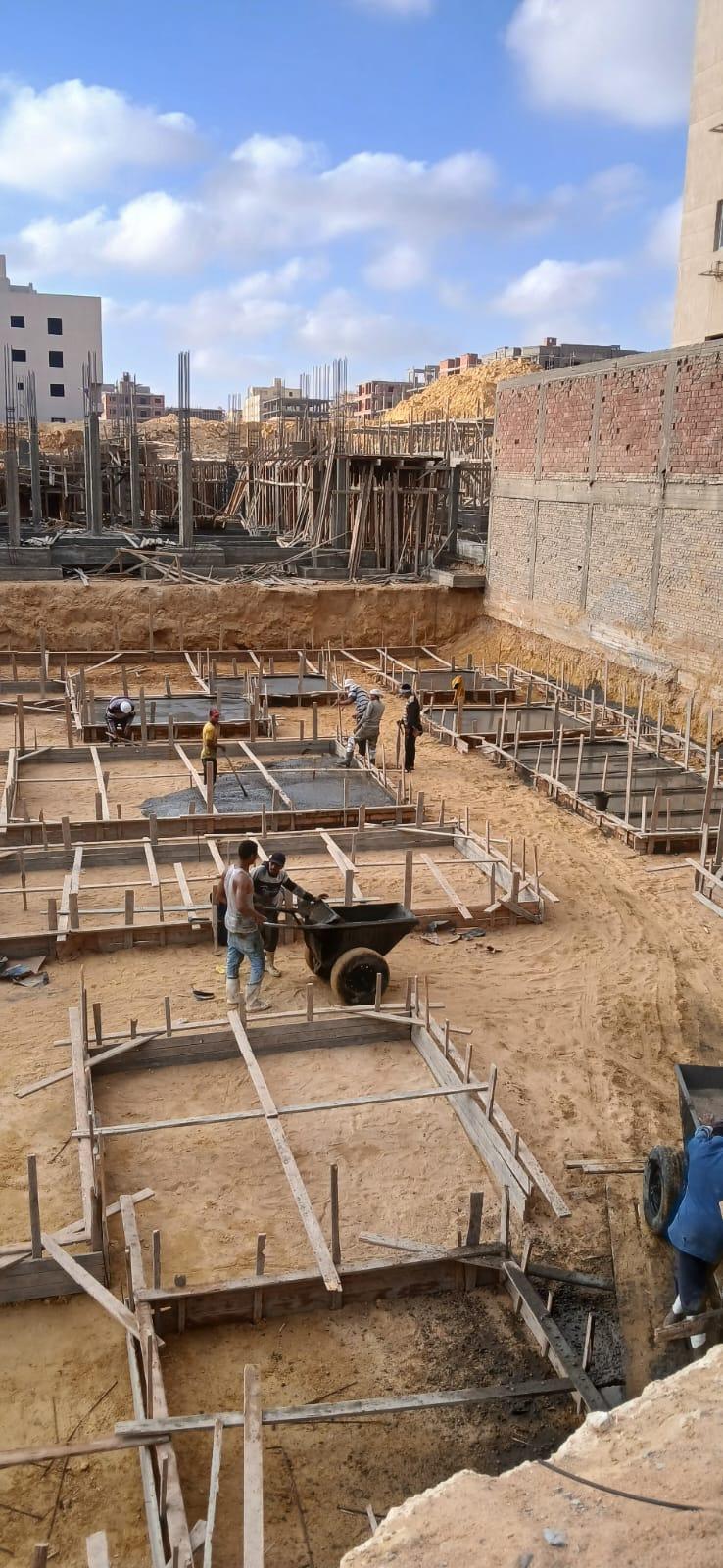

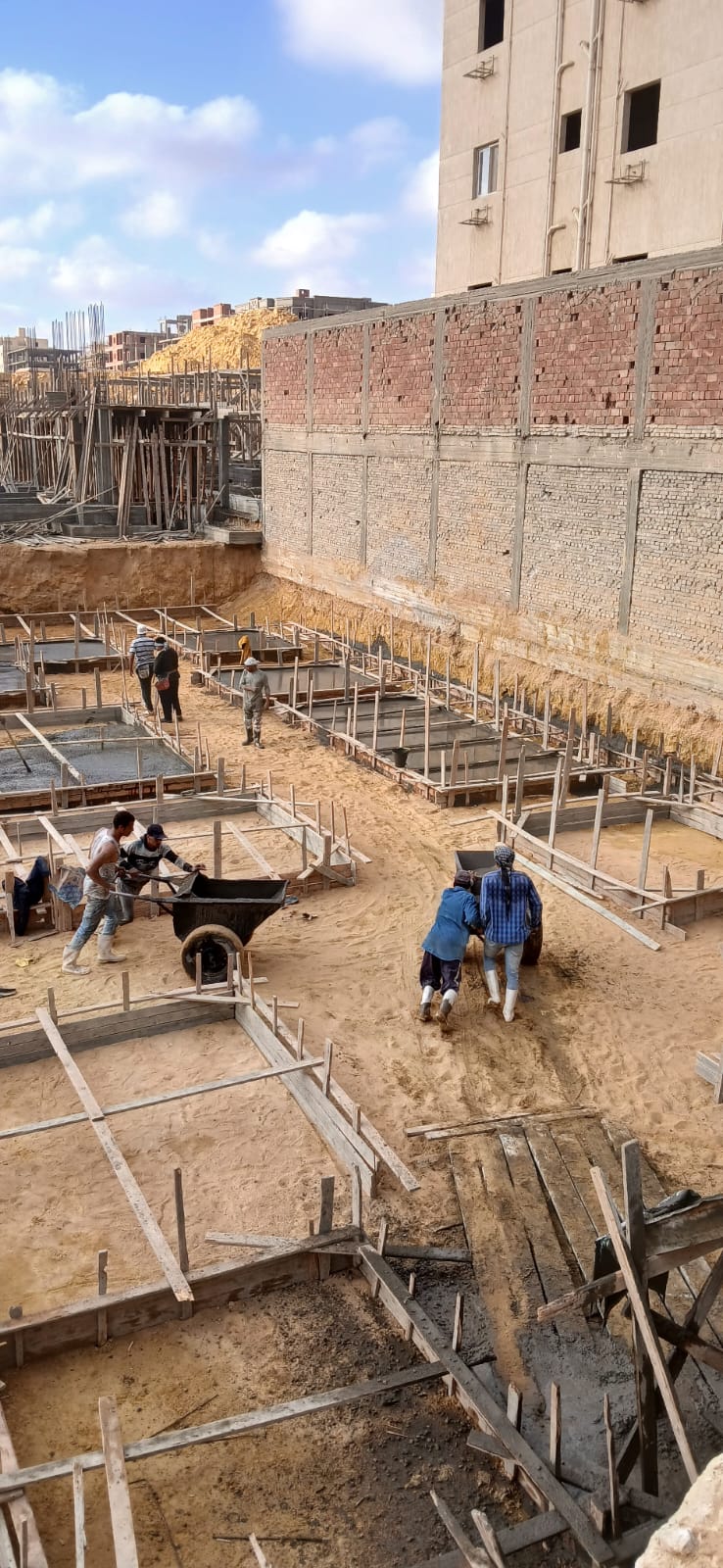

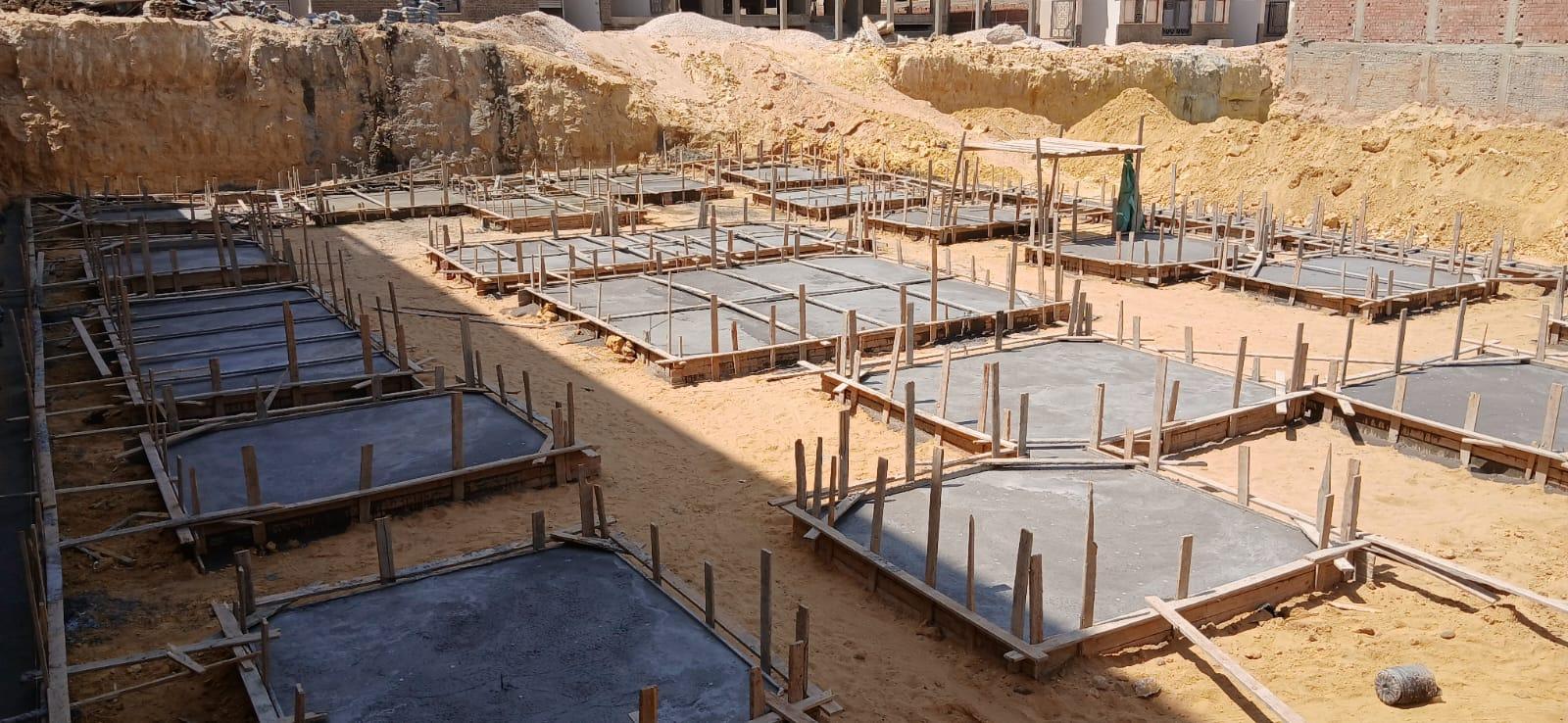

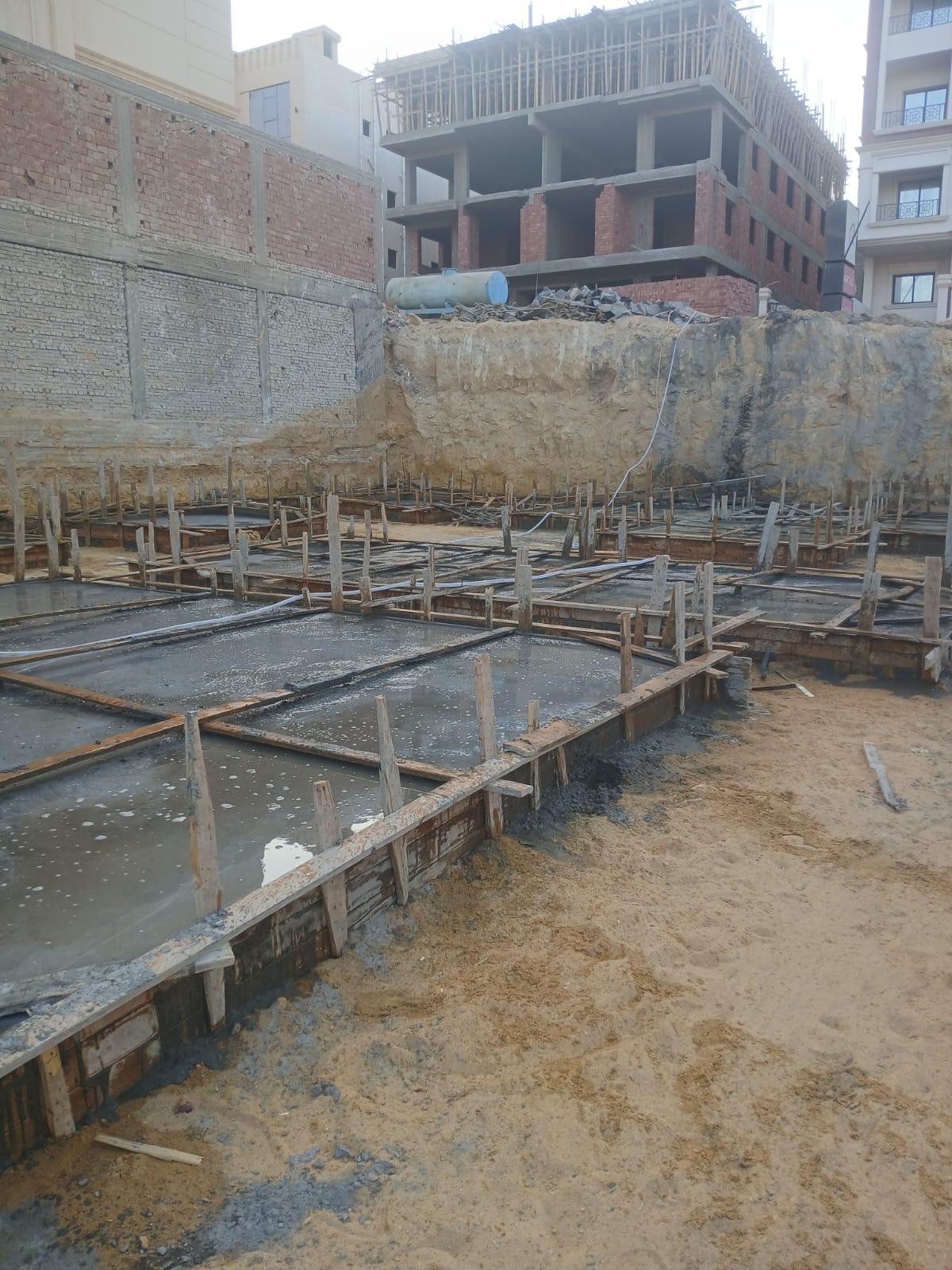

Plain foundations
January 23, 2026

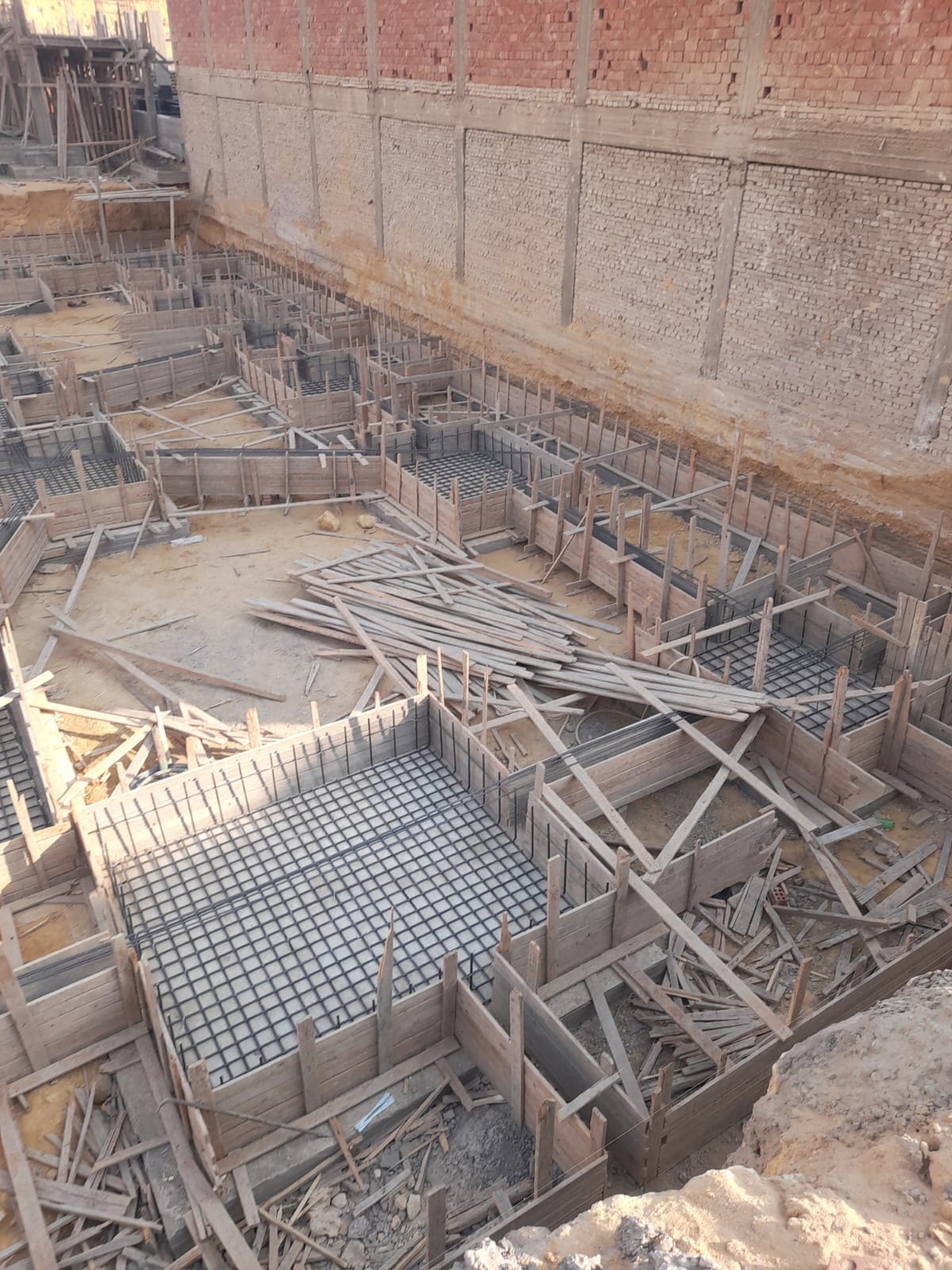

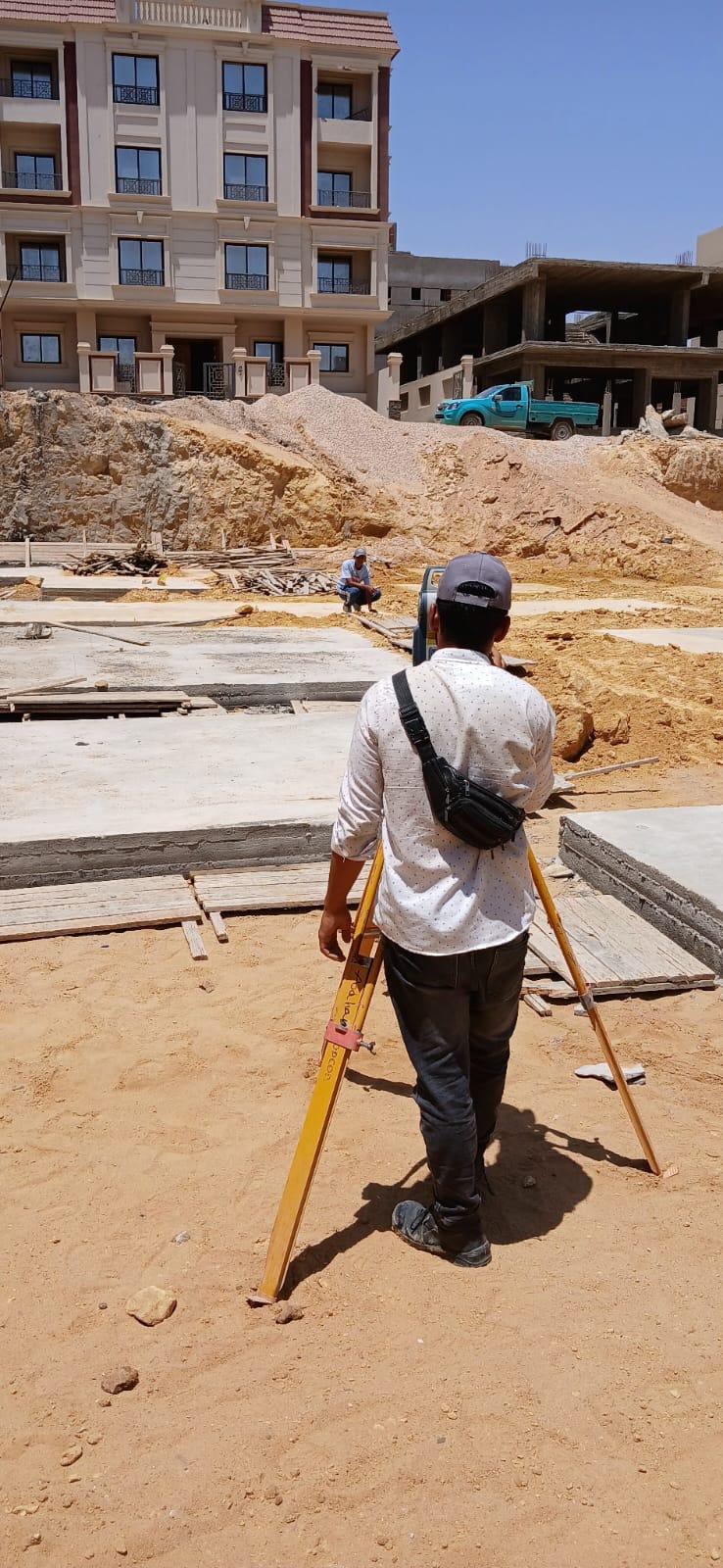

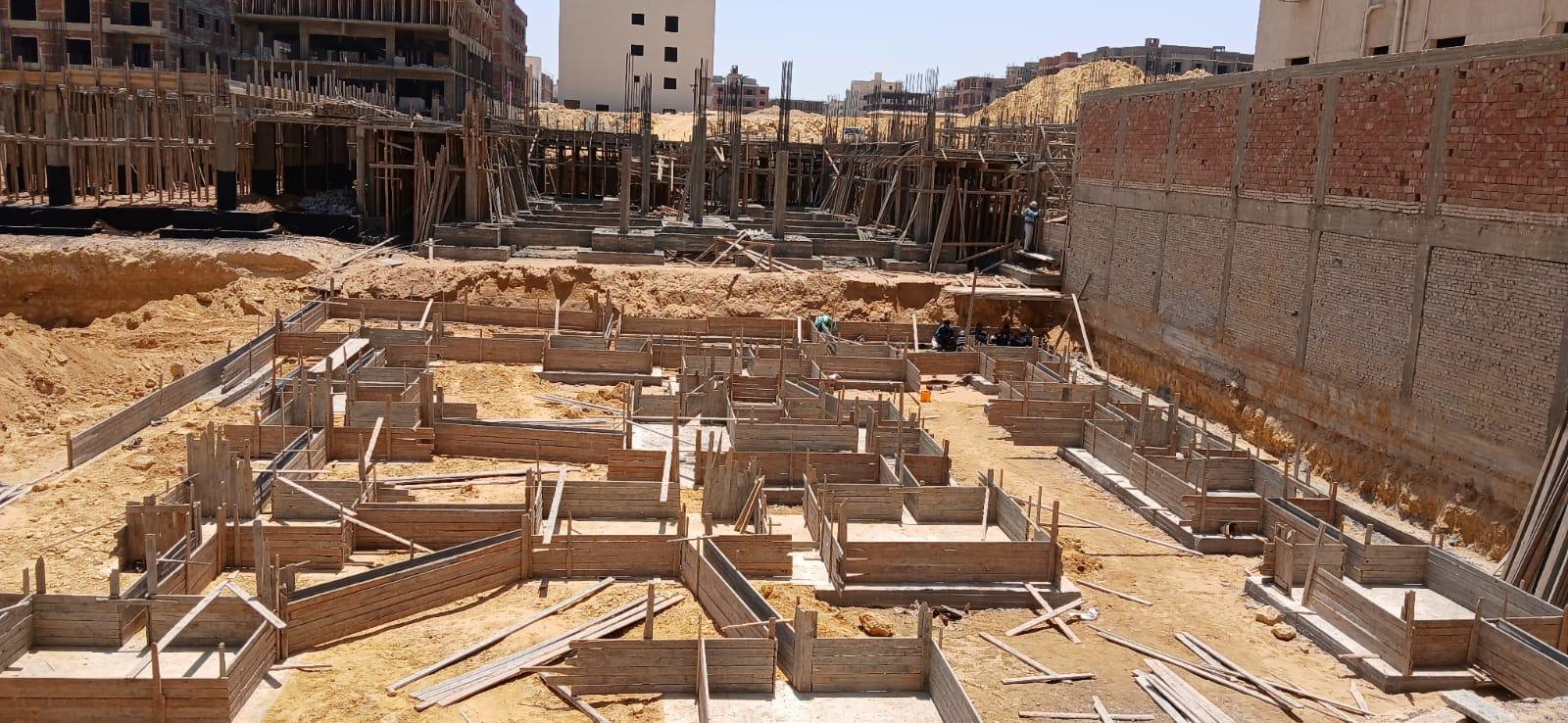

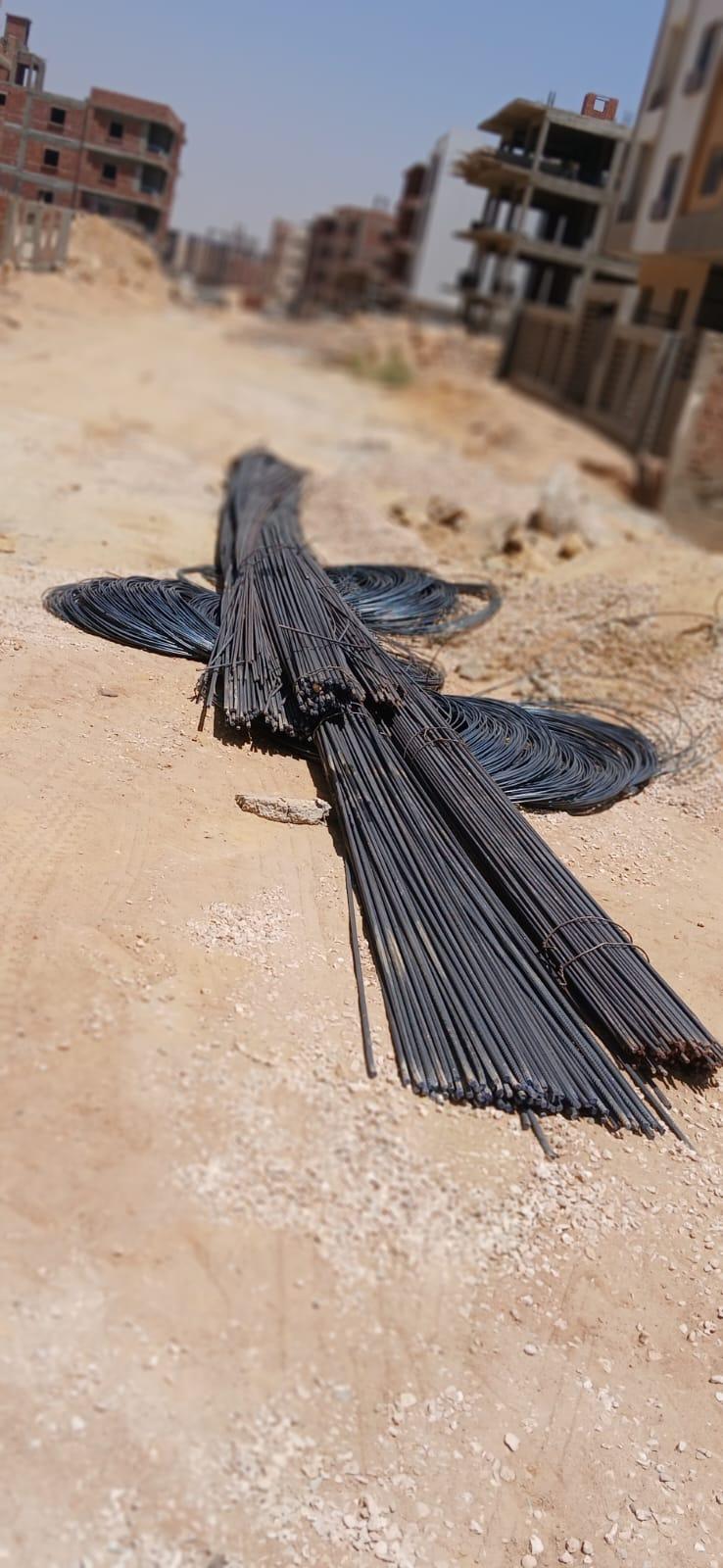

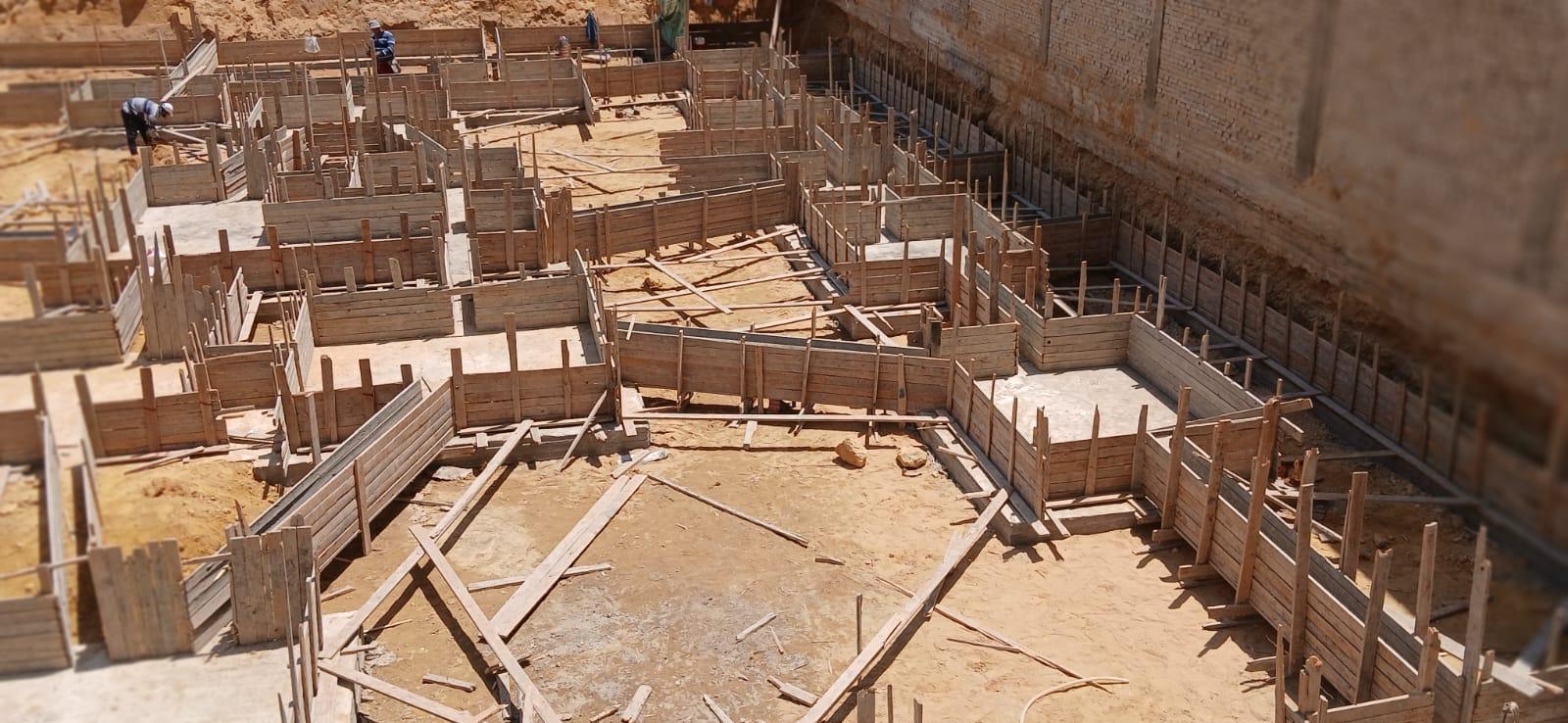

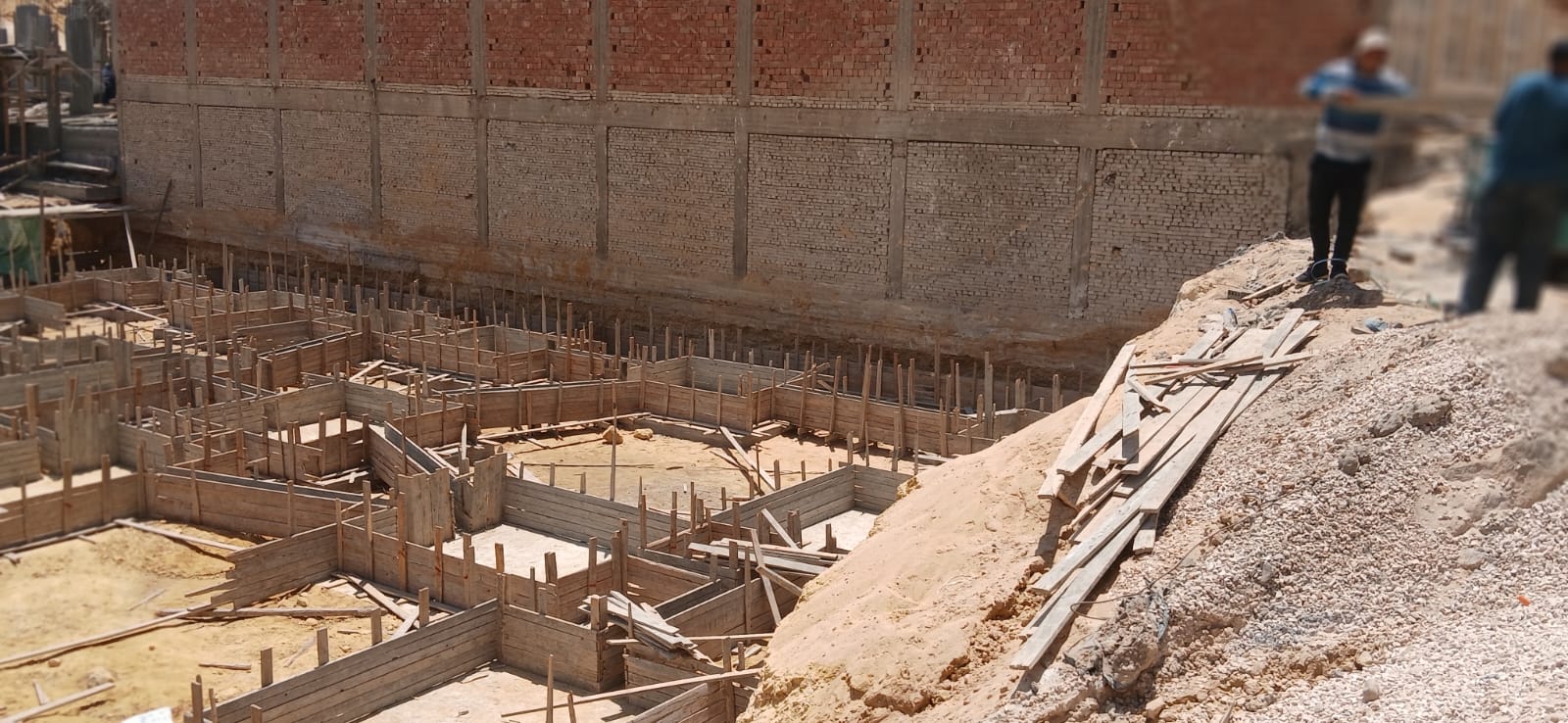

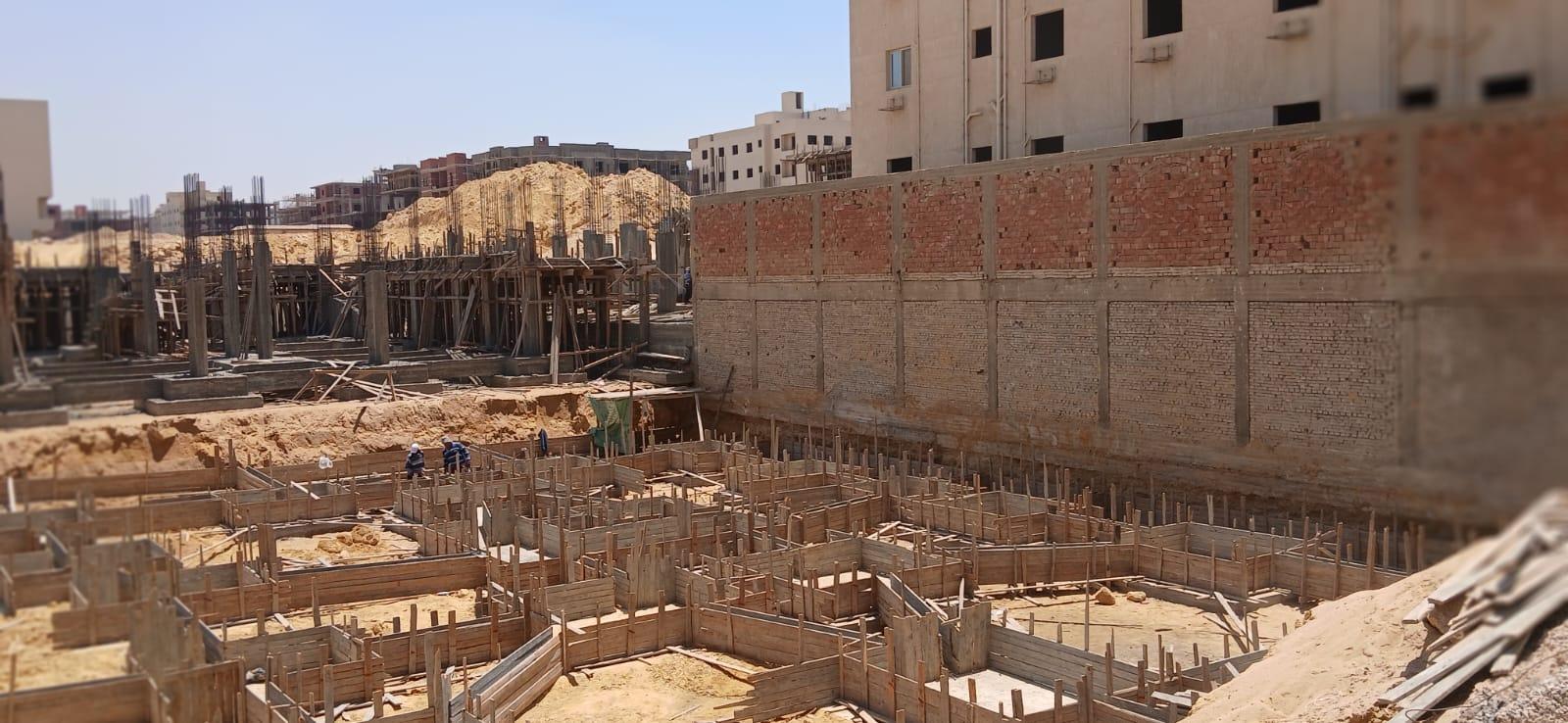

Reinforced foundations
January 23, 2026

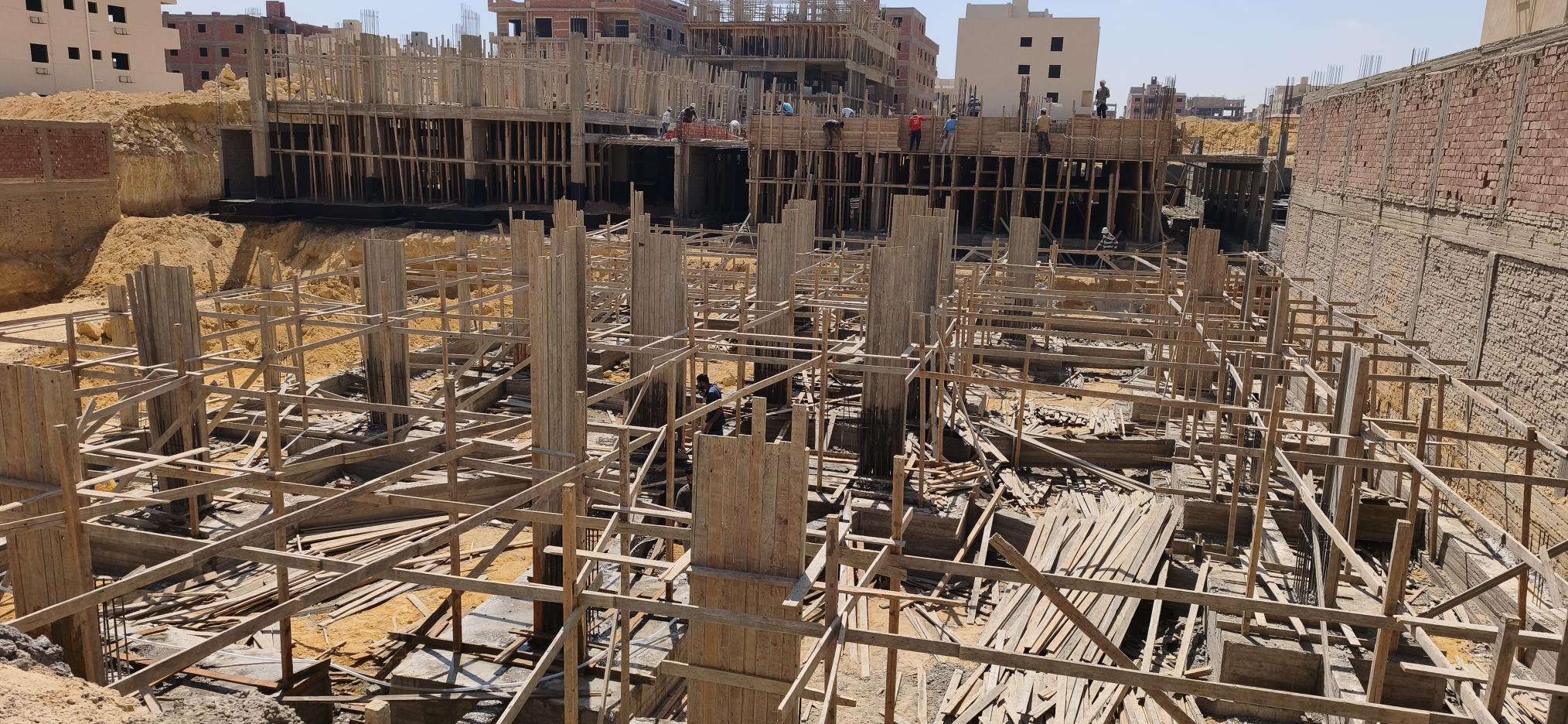

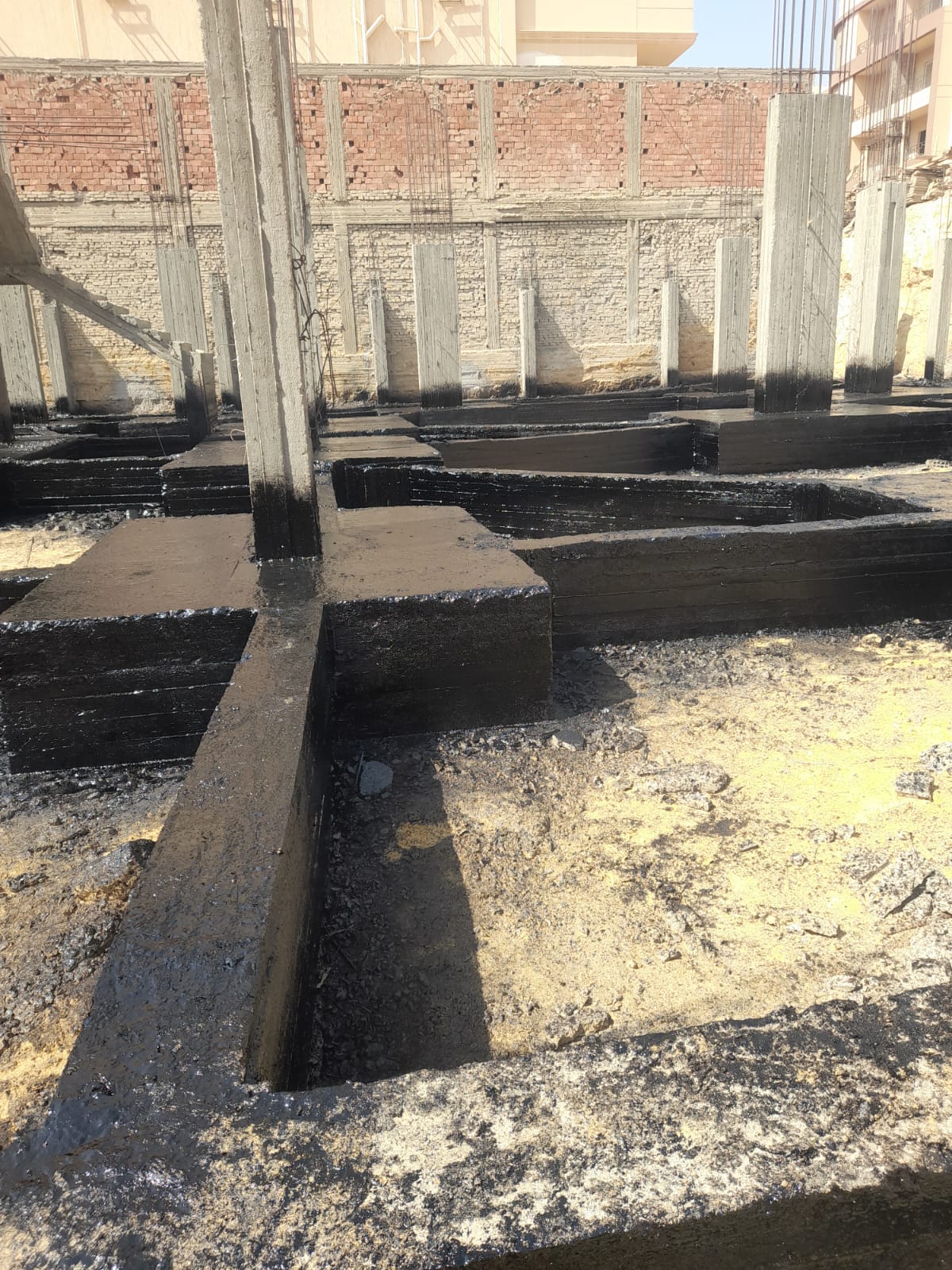

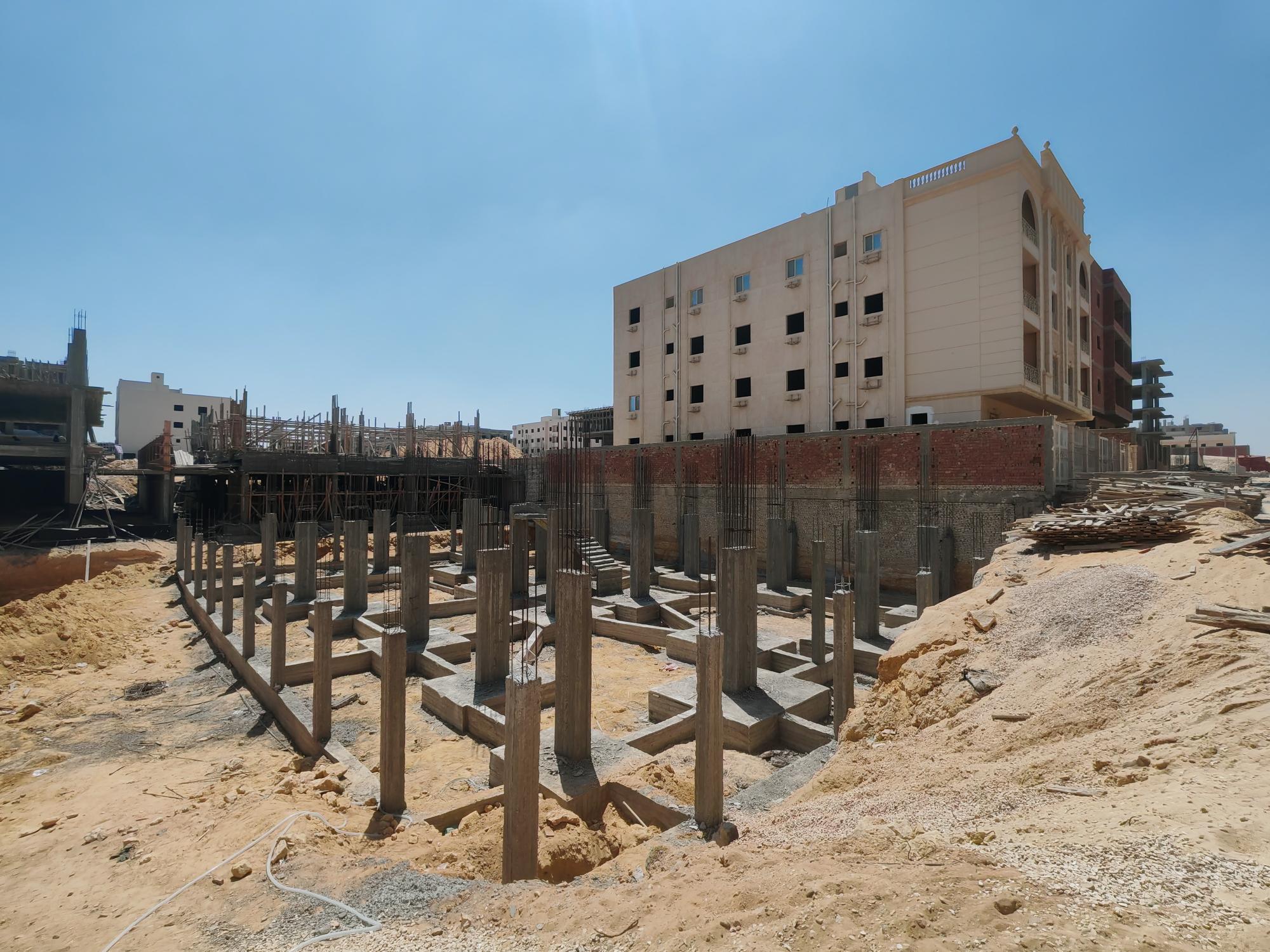

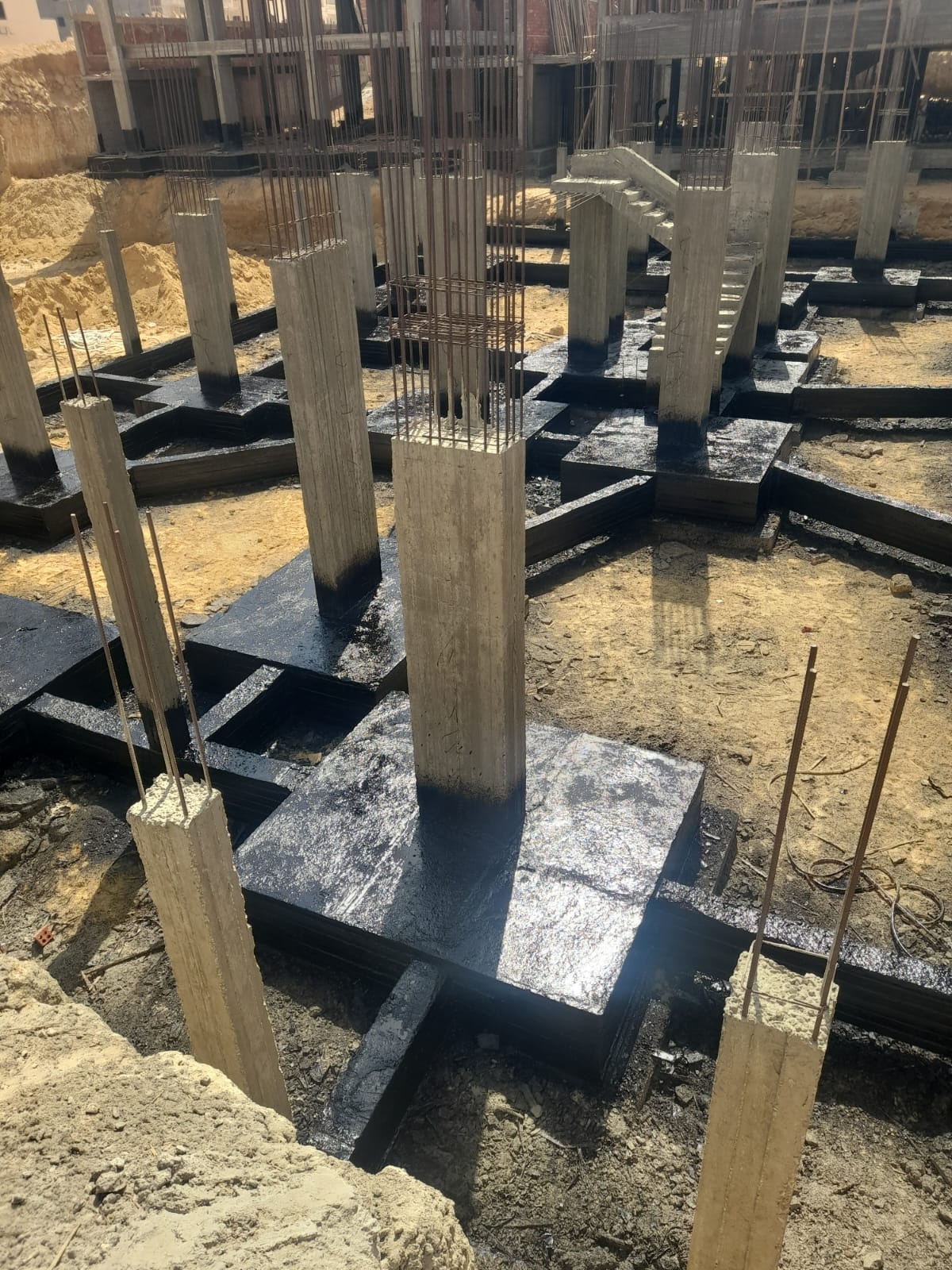

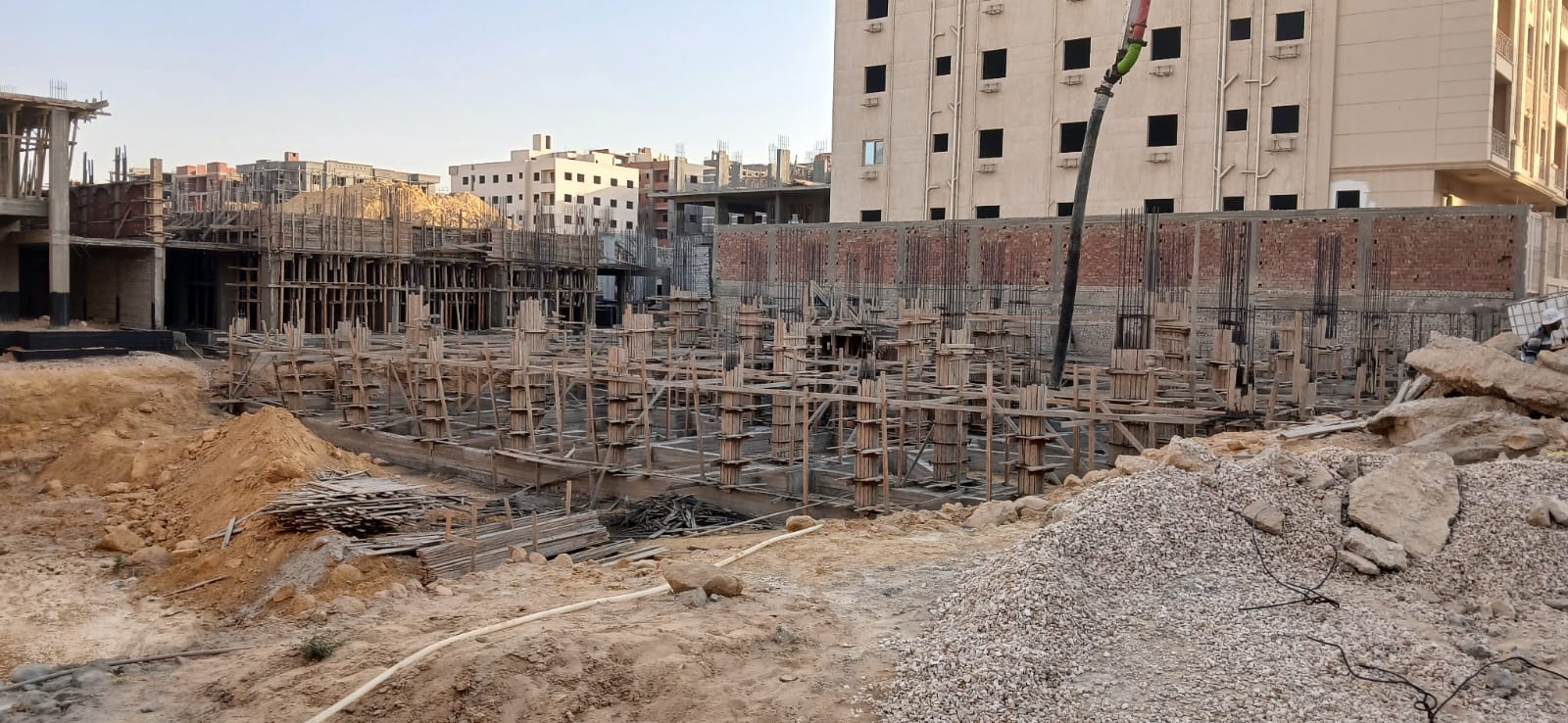

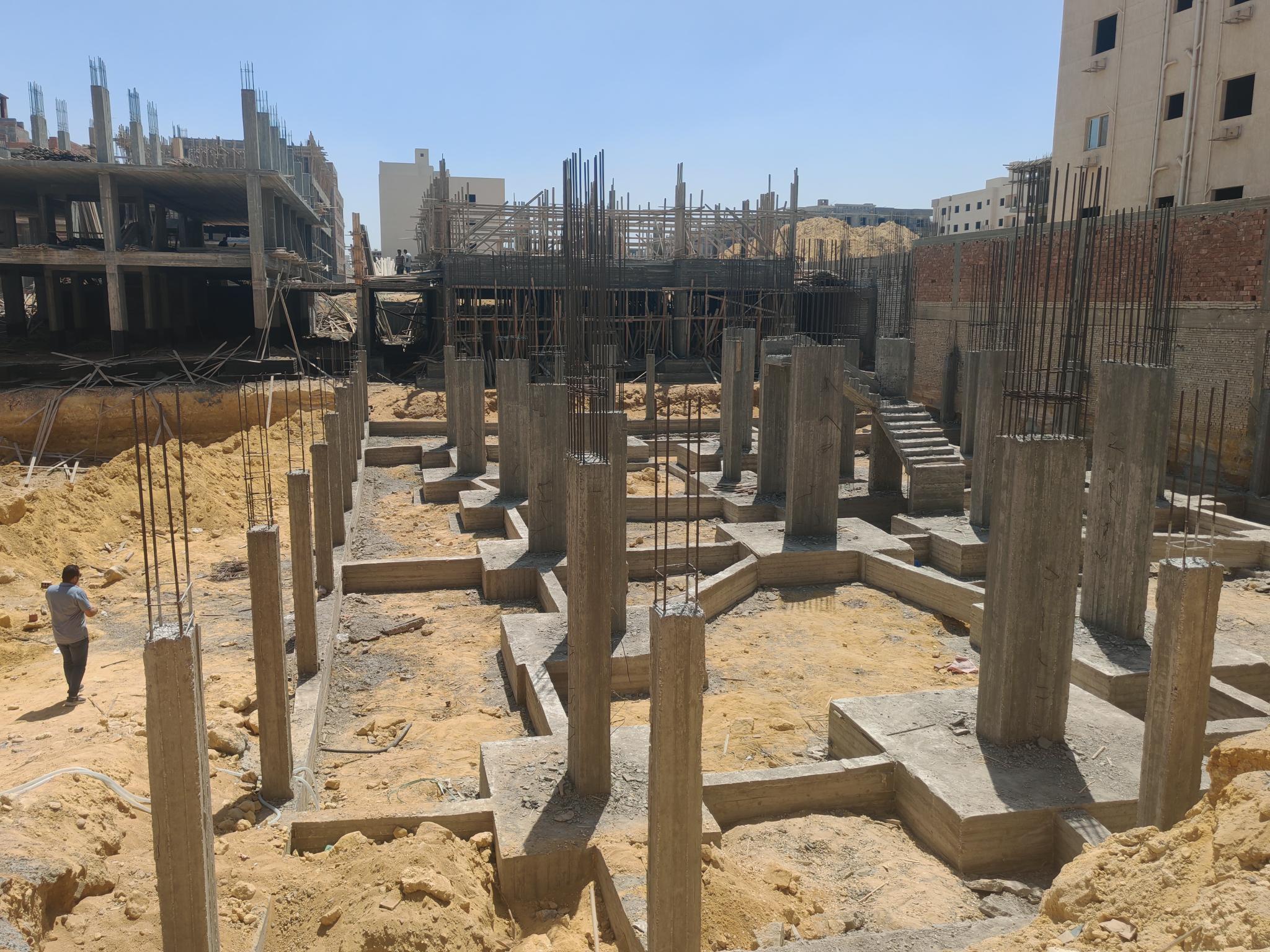

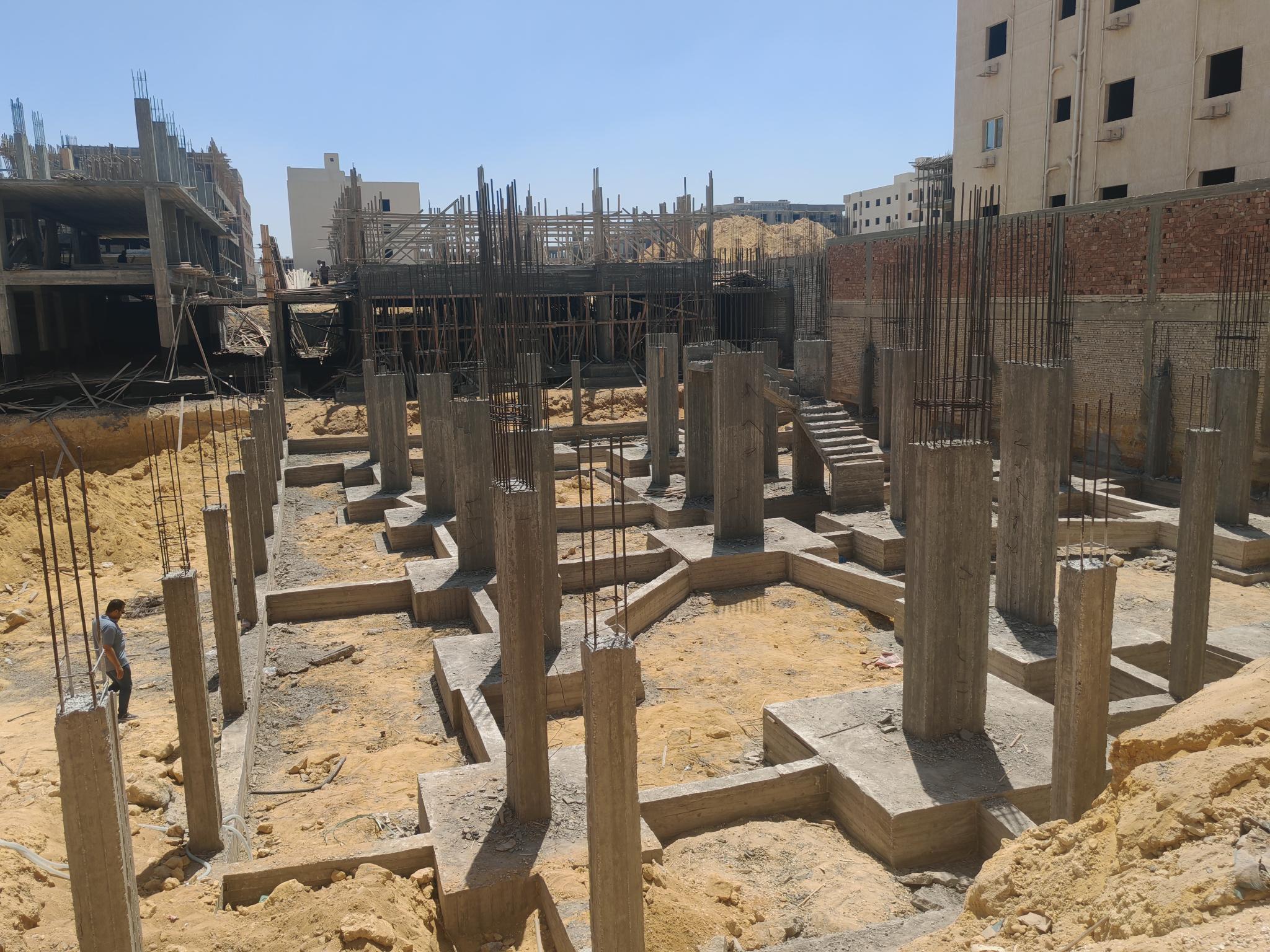

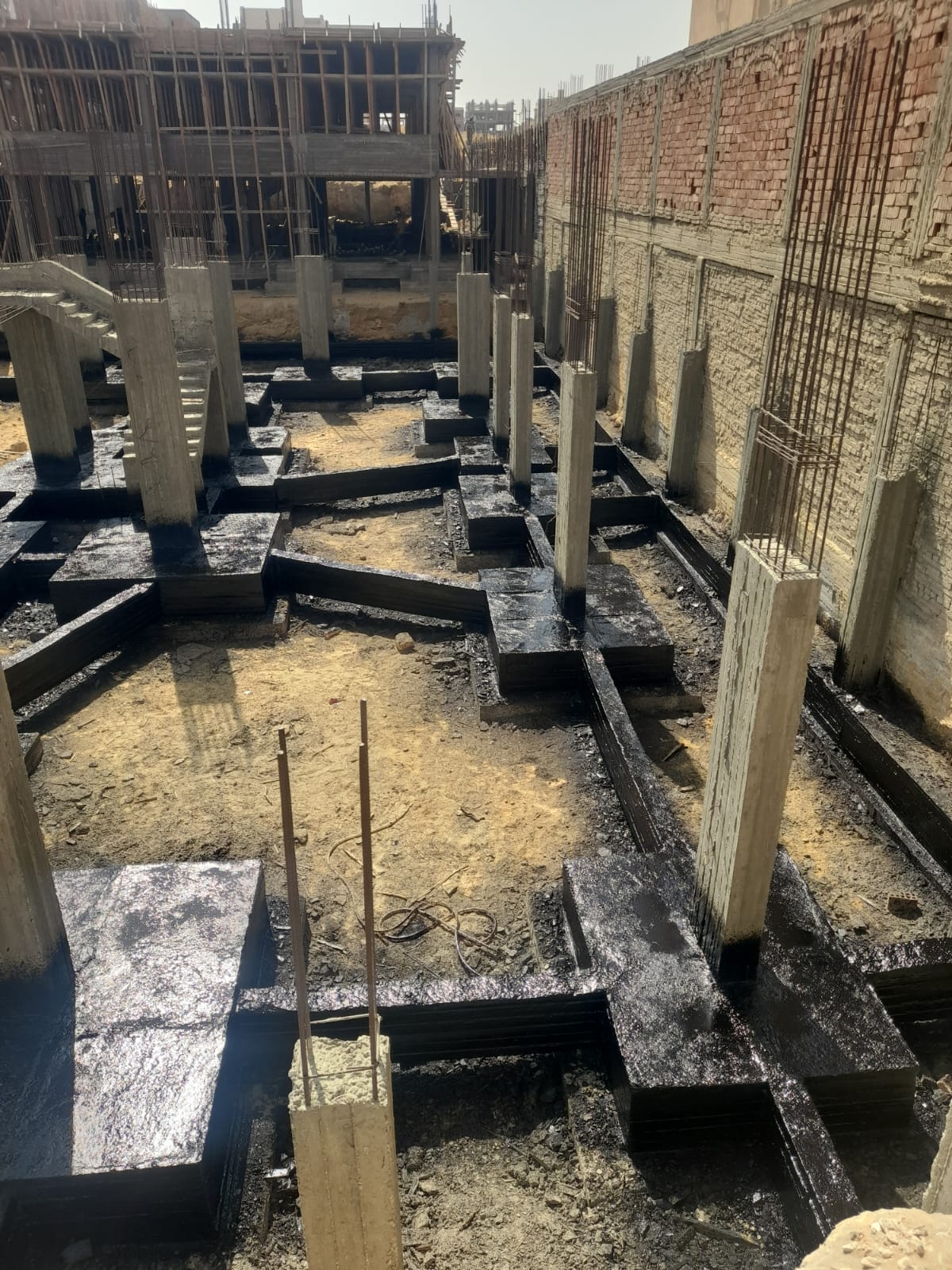

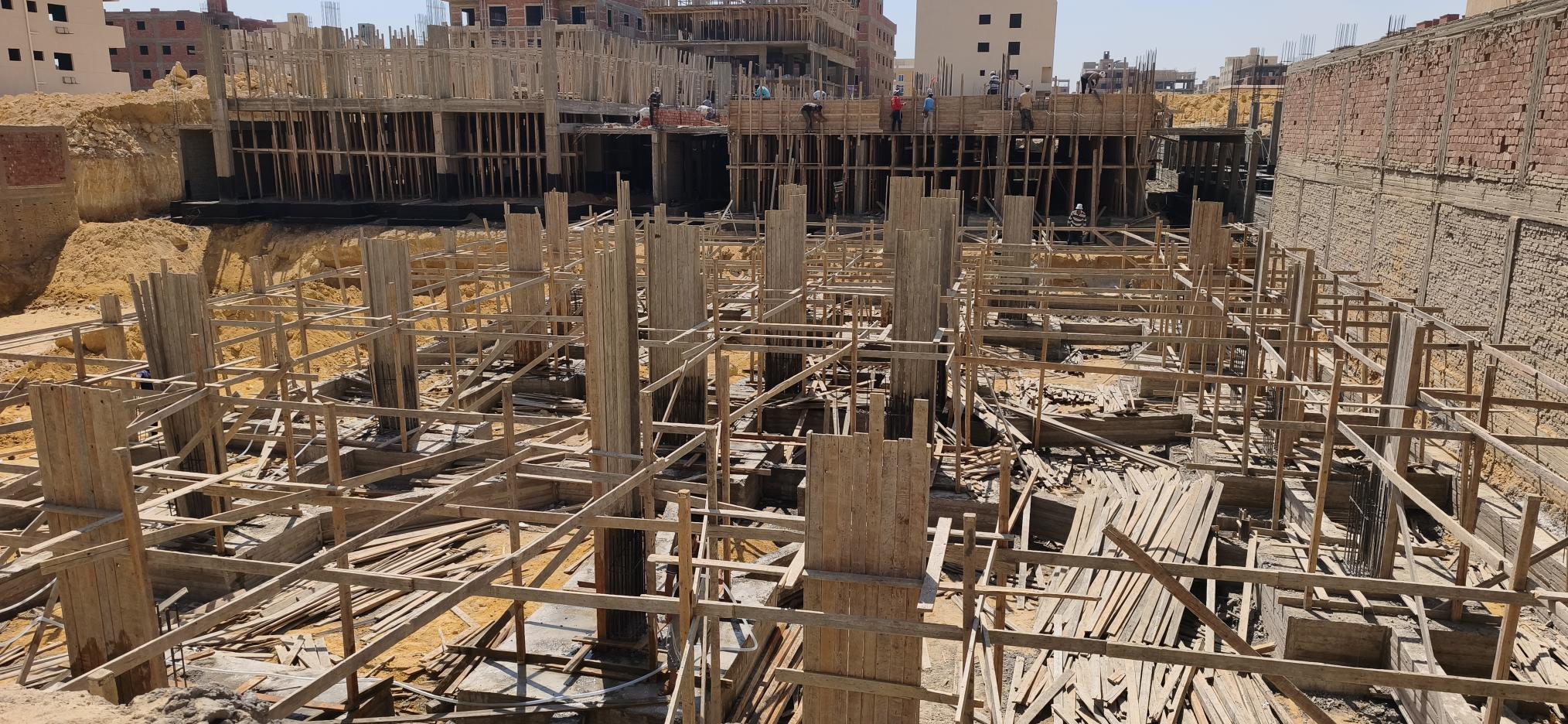

Basement columns
February 22, 2026
Basement slab
April 8, 2026
Ground floor columns
May 8, 2026
Ground floor slab
May 23, 2026
Footings insulation
June 21, 2026
Backfilling around foundations
June 22, 2026
First floor columns
July 2, 2026
First floor slab
July 17, 2026
Second floor columns
August 16, 2026
Second floor slab
August 31, 2026
Submitting third-floor extension license
September 1, 2026
Third floor columns
September 30, 2026
Third floor slab
October 15, 2026
Roof extension license
October 16, 2026
Roof concrete works
November 14, 2026
Fence columns
November 29, 2026
Basement walls
December 29, 2026
Ground floor walls
January 18, 2027
First floor walls
February 7, 2027
Second floor walls
February 27, 2027
Third floor walls
March 19, 2027
Roof walls
April 8, 2027
Wooden door frames
April 23, 2027
Plumbing main works
May 8, 2027
Electrical final finishes
May 23, 2027
Plaster and putty
June 7, 2027
Plumbing finishing
September 20, 2027
Electrical finishing
September 21, 2027
Marble finishing
September 22, 2027
Aluminum & glass works (Krital)
September 22, 2027
Elevator
September 23, 2027
Project handover to the authority
September 24, 2027
Utilities meter installation
October 1, 2027
